140 likes | 296 Views
Technical Infrastructure Monitoring (TIM) and CCC. TS Workshop May 4, 2004 P. Sollander, M. Batz – TS/CSE. Outline. Introduction to TIM Architecture Redundancy and availability Integrating TIM in CCC Project status and planning Conclusion. Introduction to TIM.
E N D
Technical Infrastructure Monitoring (TIM)andCCC TS Workshop May 4, 2004 P. Sollander, M. Batz – TS/CSE
Outline • Introduction to TIM • Architecture • Redundancy and availability • Integrating TIM in CCC • Project status and planning • Conclusion P. Sollander, M. Batz TS/CSE

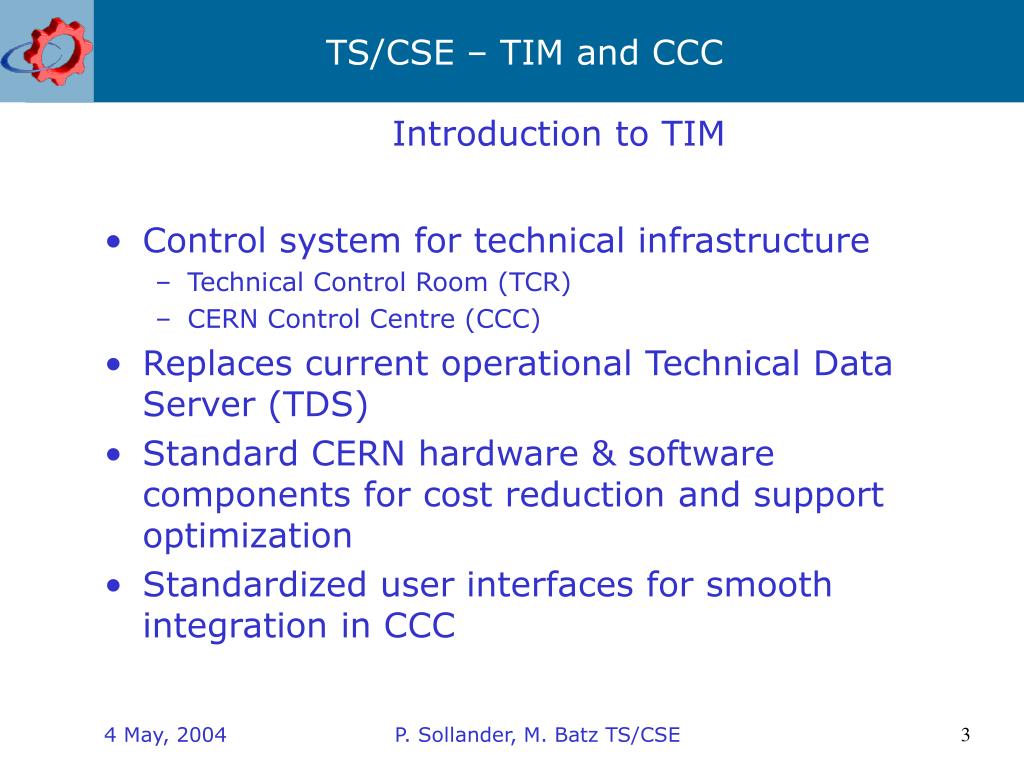

Introduction to TIM • Control system for technical infrastructure • Technical Control Room (TCR) • CERN Control Centre (CCC) • Replaces current operational Technical Data Server (TDS) • Standard CERN hardware & software components for cost reduction and support optimization • Standardized user interfaces for smooth integration in CCC P. Sollander, M. Batz TS/CSE
2006 1971 1991 1994 2003 P. Sollander, M. Batz TS/CSE

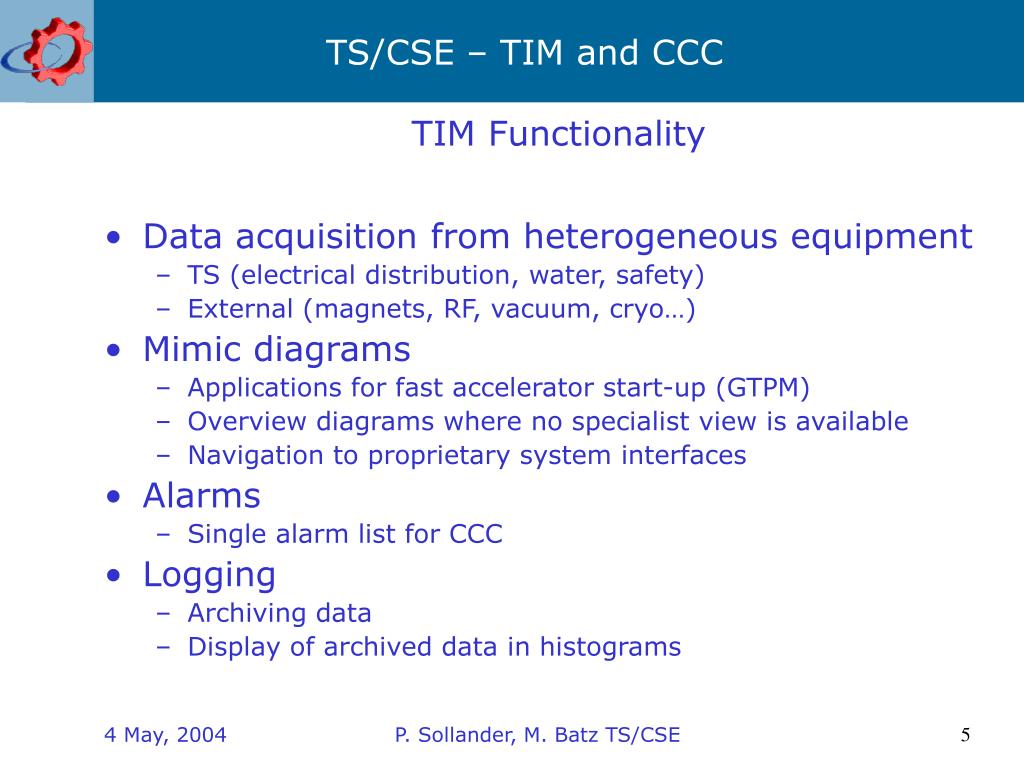

TIM Functionality • Data acquisition from heterogeneous equipment • TS (electrical distribution, water, safety) • External (magnets, RF, vacuum, cryo…) • Mimic diagrams • Applications for fast accelerator start-up (GTPM) • Overview diagrams where no specialist view is available • Navigation to proprietary system interfaces • Alarms • Single alarm list for CCC • Logging • Archiving data • Display of archived data in histograms P. Sollander, M. Batz TS/CSE
TIM Software Architecture Alarm system Logging TIM mimics Ext. client Scada mimics DIP Data Processing http Logging DB Conf. DB DIP/ TIM DIP PLC Ext. source Scada x 60 x 20 P. Sollander, M. Batz TS/CSE
TIM Hardware Architecture CERN VPN Home users Office users CERN General Network Gateway TCR/CCC consoles Database cluster File server cluster Data processing cluster Technical Network Data acquisition PLC x 60 Scada x 20 P. Sollander, M. Batz TS/CSE

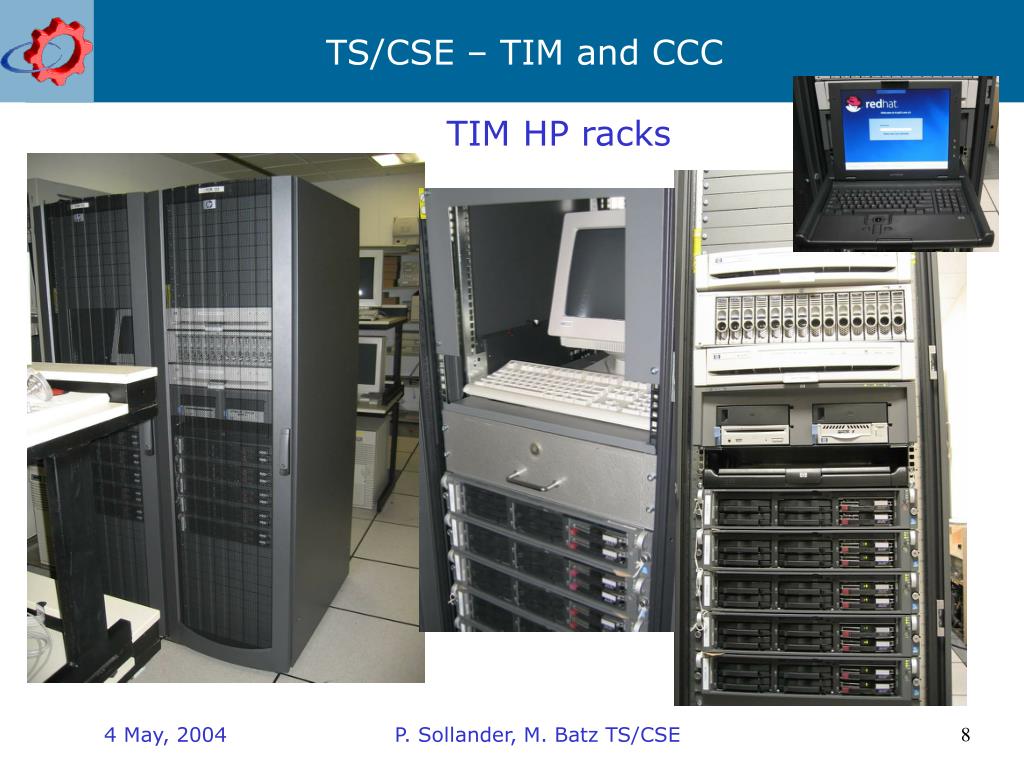

TIM HP racks P. Sollander, M. Batz TS/CSE

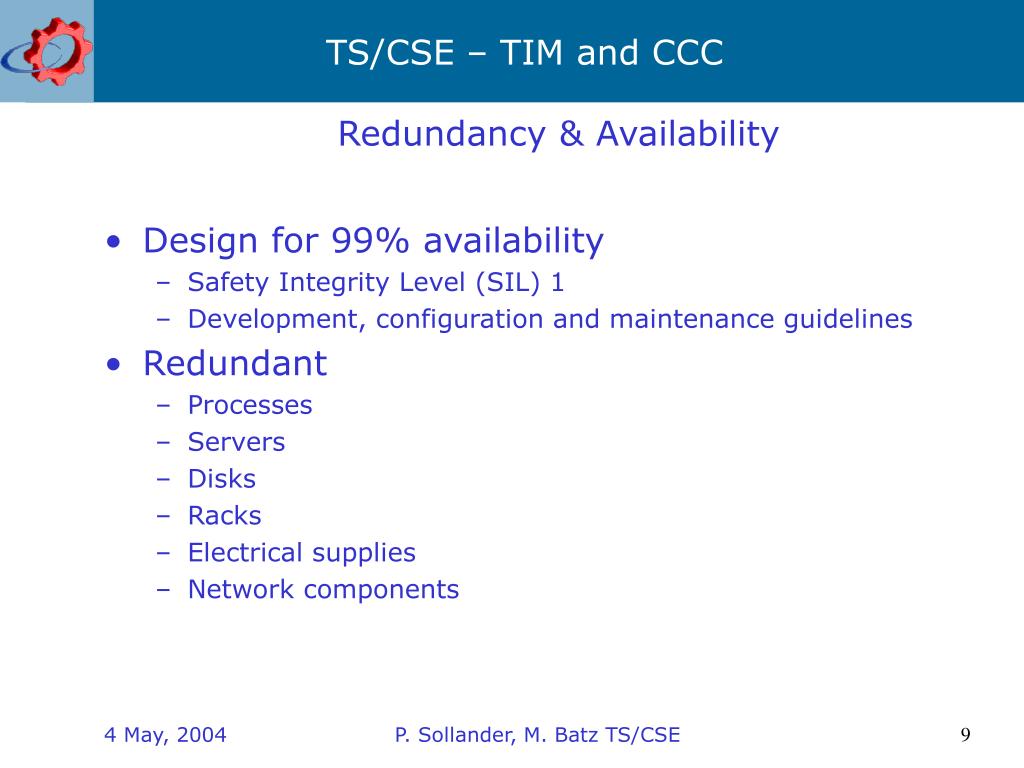

Redundancy & Availability • Design for 99% availability • Safety Integrity Level (SIL) 1 • Development, configuration and maintenance guidelines • Redundant • Processes • Servers • Disks • Racks • Electrical supplies • Network components P. Sollander, M. Batz TS/CSE

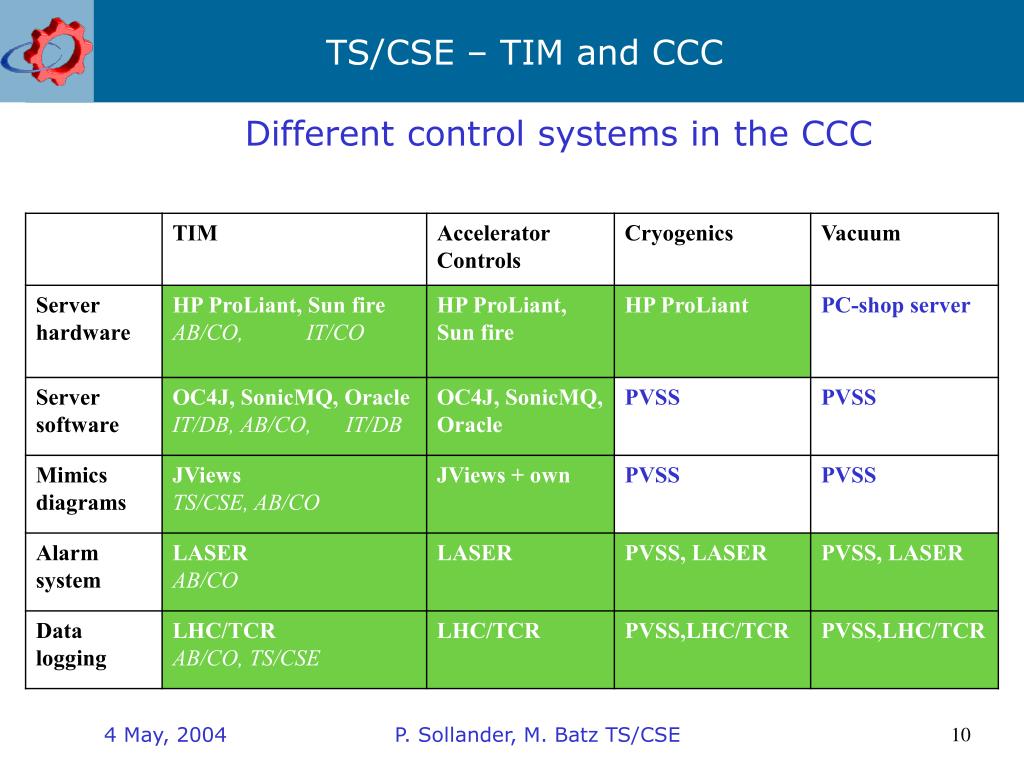

Different control systems in the CCC P. Sollander, M. Batz TS/CSE
Standardized mimic diagrams • The future CCC operators will use many user interfaces • A standardization is absolutely necessary! • Scada Application Support Group (SASG) • Mandate to unify CERN user interface standards • Layout, colours, symbols, navigation, … • Includes, TCR, PCR, vacuum and cryo people • PCR white book • Being written • A compilation of all PCR operator requirements for their control room (including user interfaces) • No collaboration with TCR and cryo operators (yet!?) P. Sollander, M. Batz TS/CSE

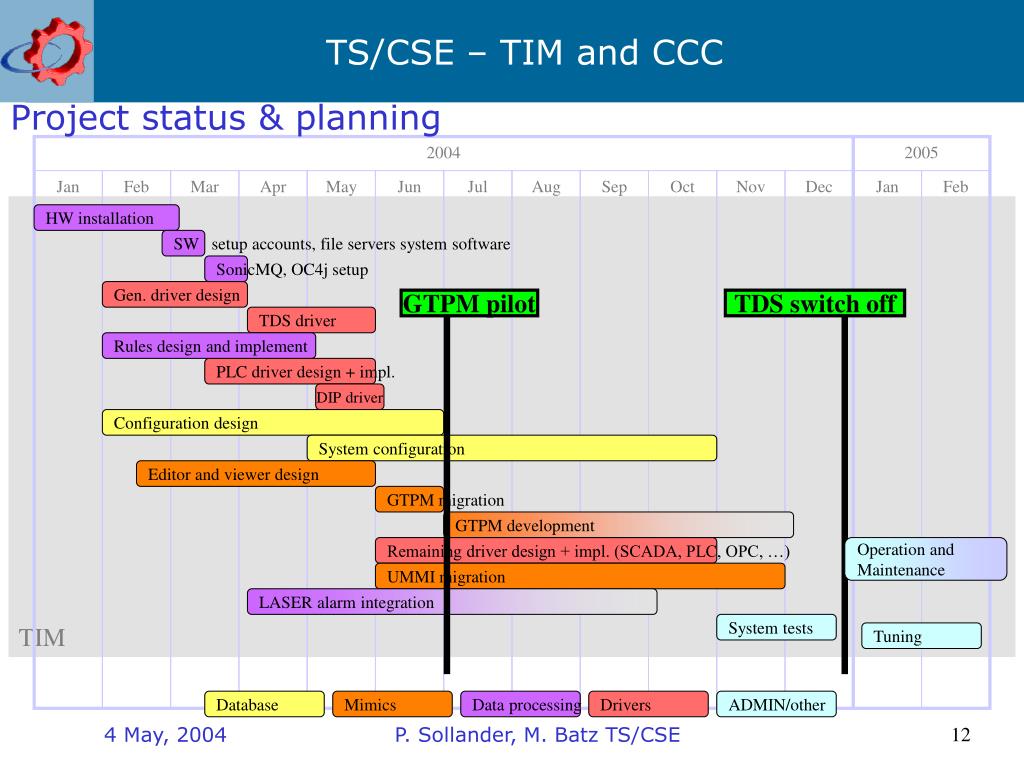

2004 2005 Jan Feb Mar Apr May Jun Jul Aug Sep Oct Nov Dec Jan Feb Project status & planning TIM HW installation SW setup accounts, file servers system software SonicMQ, OC4jsetup Gen. driver design GTPM pilot TDS switch off TDS driver Rules design and implement PLC driver design + impl. DIP driver Configuration design System configuration Editor and viewer design GTPM migration GTPM development Remaining driver design + impl. (SCADA, PLC, OPC, …) Operation and Maintenance UMMI migration LASER alarm integration System tests Tuning Database Mimics Data processing Drivers ADMIN/other P. Sollander, M. Batz TS/CSE
Conclusion • Integration in CCC • TIM Hardware and Software architecture choices made in view of integration • Must be integrated with other systems in CCC • Safety, access, accelerator, cryogenics and vacuum controls • CCC operator consoles must be agreed by all future operators • Choice of operating system • User interface standards • AB operations white book • Successful integration depends on departmental commitment and inter-departmental collaboration • Availability • System designed for 99% availability, but • Overall availability depends on the connected systems • Planning • On time, pilot in July and switch off TDS in December • Budget • 20 % below budget (grouped purchasing and own development) P. Sollander, M. Batz TS/CSE
More information on TIM http://ts-project-tim.web.cern.ch/ts-project-tim/ P. Sollander, M. Batz TS/CSE
