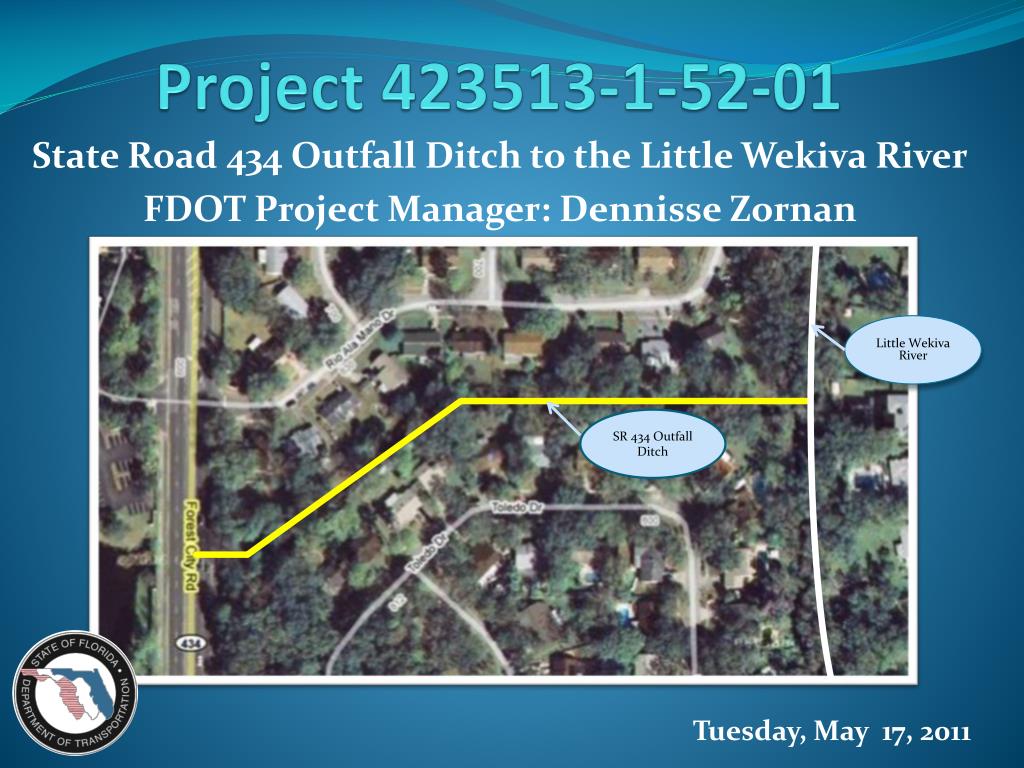

  1. Project 423513-1-52-01 Little Wekiva River State Road 434 Outfall Ditch to the Little Wekiva River FDOT Project Manager: Dennisse Zornan SR 434 Outfall Ditch Tuesday, May 17, 2011

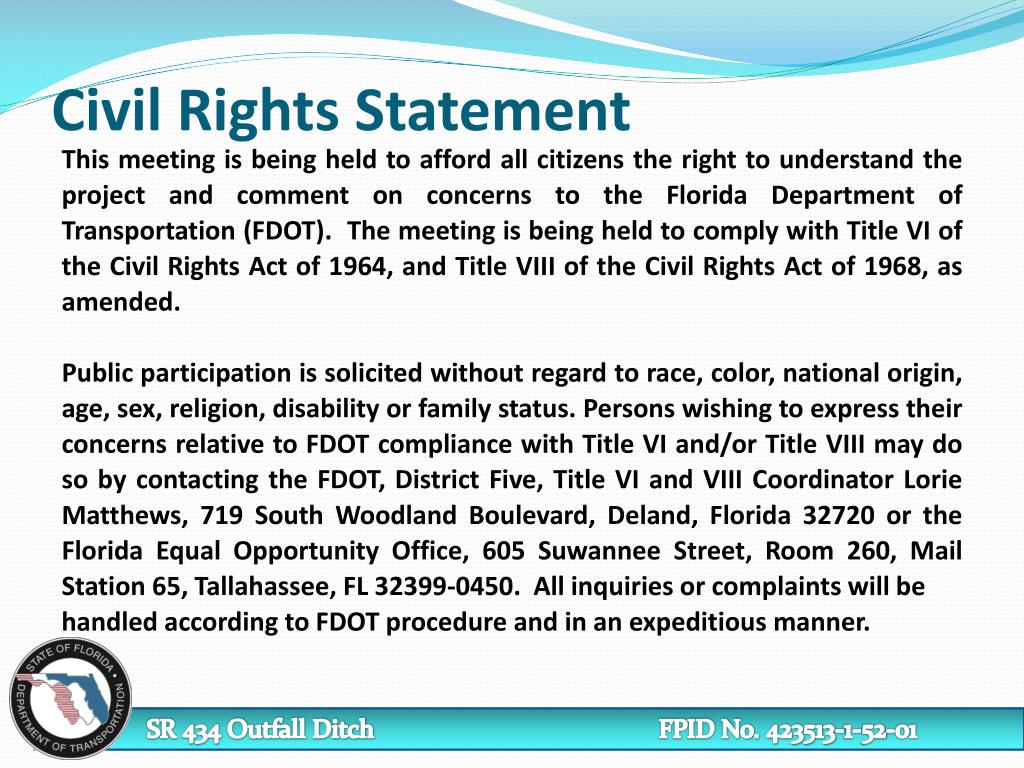

  2. Civil Rights Statement This meeting is being held to afford all citizens the right to understand the project and comment on concerns to the Florida Department of Transportation (FDOT). The meeting is being held to comply with Title VI of the Civil Rights Act of 1964, and Title VIII of the Civil Rights Act of 1968, as amended. Public participation is solicited without regard to race, color, national origin, age, sex, religion, disability or family status. Persons wishing to express their concerns relative to FDOT compliance with Title VI and/or Title VIII may do so by contacting the FDOT, District Five, Title VI and VIII Coordinator Lorie Matthews, 719 South Woodland Boulevard, Deland, Florida 32720 or the Florida Equal Opportunity Office, 605 Suwannee Street, Room 260, Mail Station 65, Tallahassee, FL 32399-0450. All inquiries or complaints will be handled according to FDOT procedure and in an expeditious manner. SR 434 Outfall Ditch FPID No. 423513-1-52-01

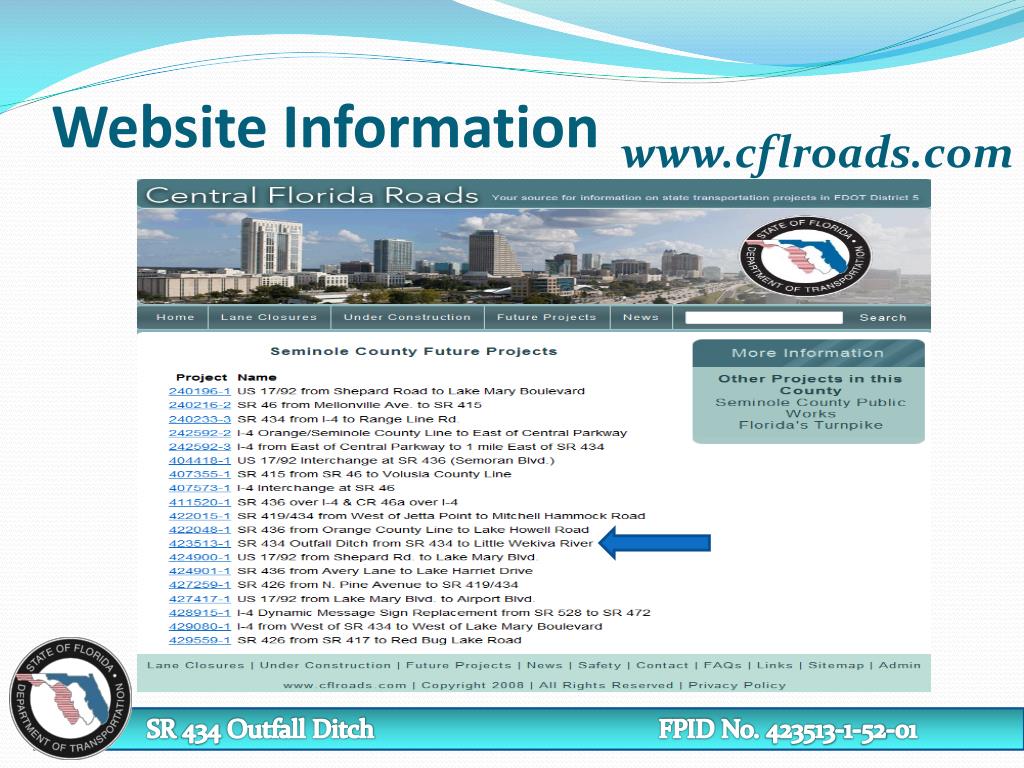

  3. Website Information www.cflroads.com SR 434 Outfall Ditch FPID No. 423513-1-52-01

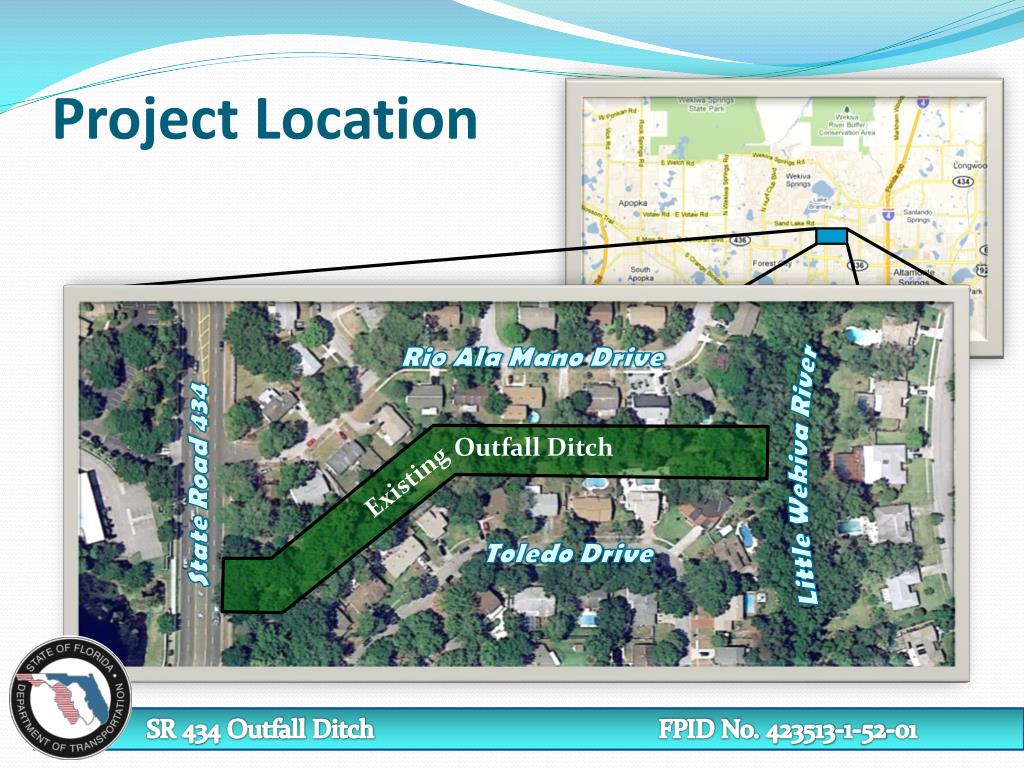

  4. Project Location Rio Ala Mano Drive Outfall Ditch Little Wekiva River Existing State Road 434 Toledo Drive SR 434 Outfall Ditch FPID No. 423513-1-52-01

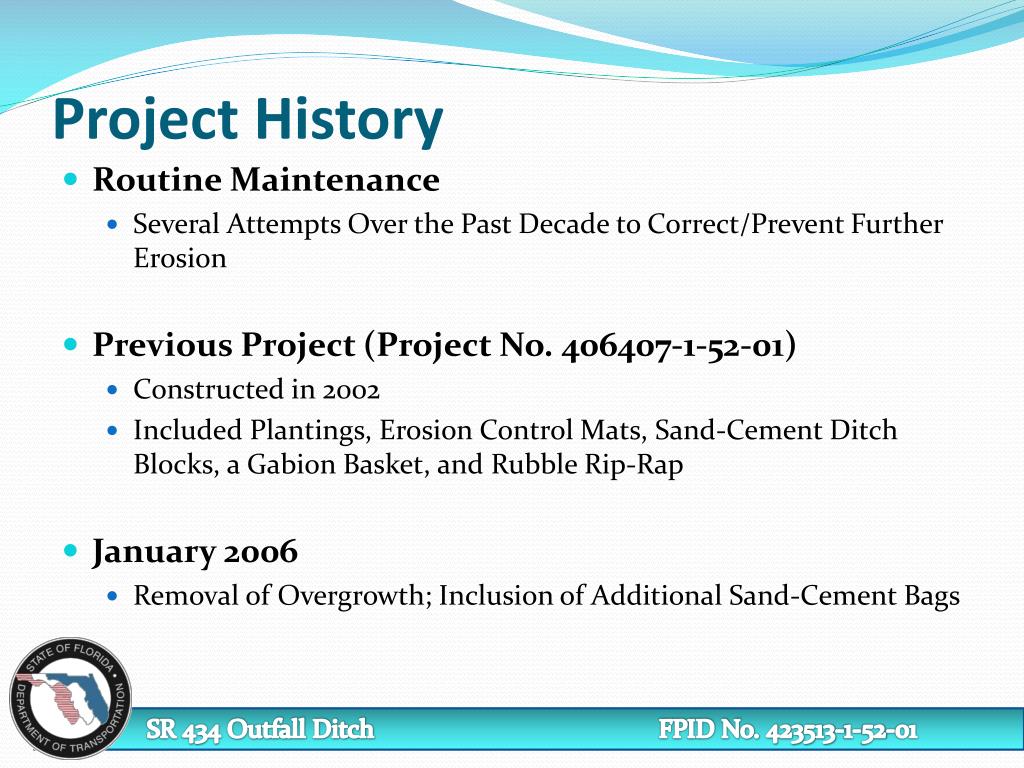

  5. Project History • Routine Maintenance • Several Attempts Over the Past Decade to Correct/Prevent Further Erosion • Previous Project (Project No. 406407-1-52-01) • Constructed in 2002 • Included Plantings, Erosion Control Mats, Sand-Cement Ditch Blocks, a Gabion Basket, and Rubble Rip-Rap • January 2006 • Removal of Overgrowth; Inclusion of Additional Sand-Cement Bags SR 434 Outfall Ditch FPID No. 423513-1-52-01

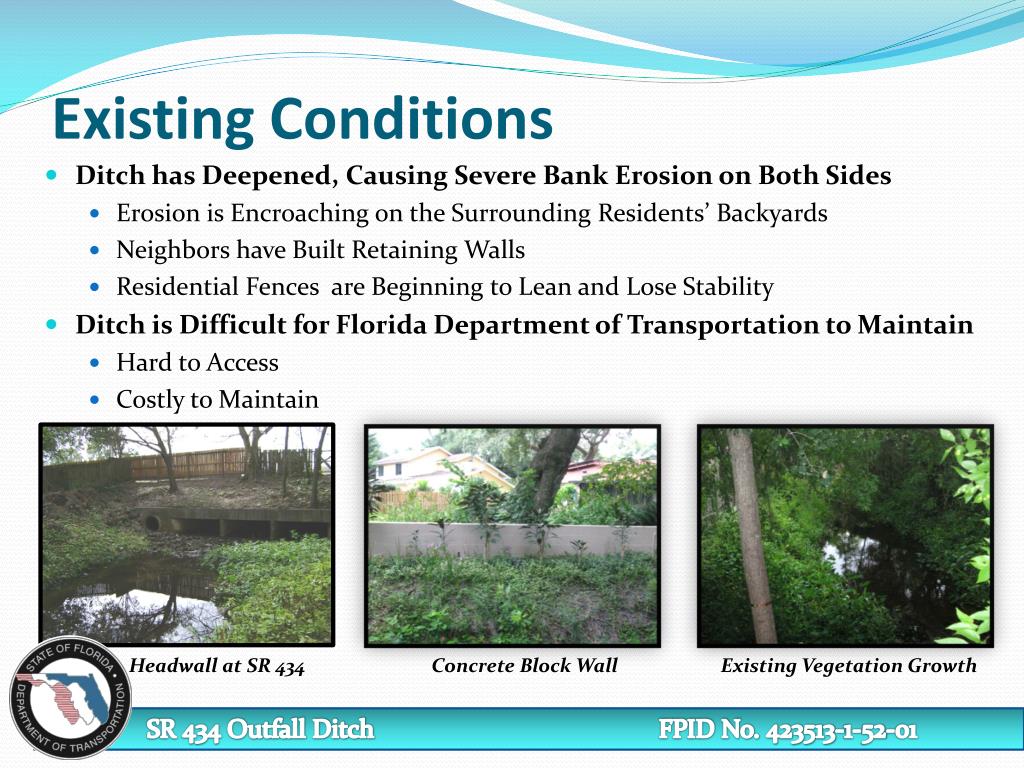

  6. Existing Conditions • Ditch has Deepened, Causing Severe Bank Erosion on Both Sides • Erosion is Encroaching on the Surrounding Residents’ Backyards • Neighbors have Built Retaining Walls • Residential Fences are Beginning to Lean and Lose Stability • Ditch is Difficult for Florida Department of Transportation to Maintain • Hard to Access • Costly to Maintain Headwall at SR 434 Concrete Block Wall Existing Vegetation Growth SR 434 Outfall Ditch FPID No. 423513-1-52-01

  7. Existing Conditions (Additional Photos) Existing Fence Line Steep Bank Slopes Active Stream Slope Protection (Sand-Cement) Existing Ditch Block Slope Protection (Erosion Mats) SR 434 Outfall Ditch FPID No. 423513-1-52-01

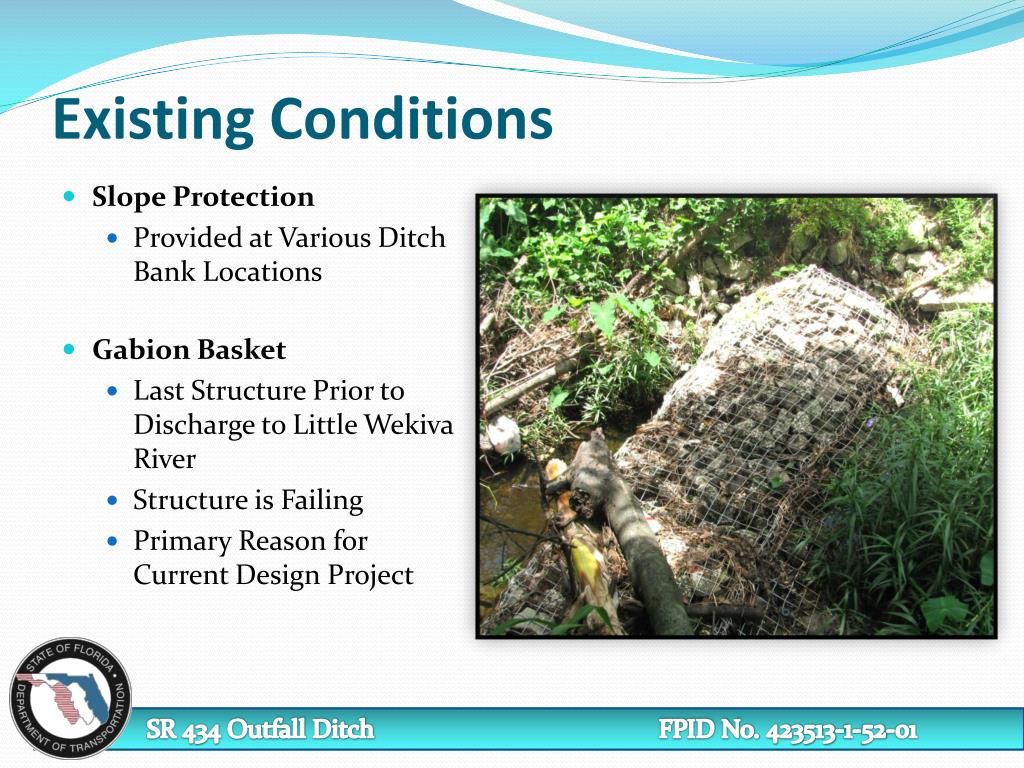

  8. Existing Conditions • Slope Protection • Provided at Various Ditch Bank Locations • Gabion Basket • Last Structure Prior to Discharge to Little Wekiva River • Structure is Failing • Primary Reason for Current Design Project SR 434 Outfall Ditch FPID No. 423513-1-52-01

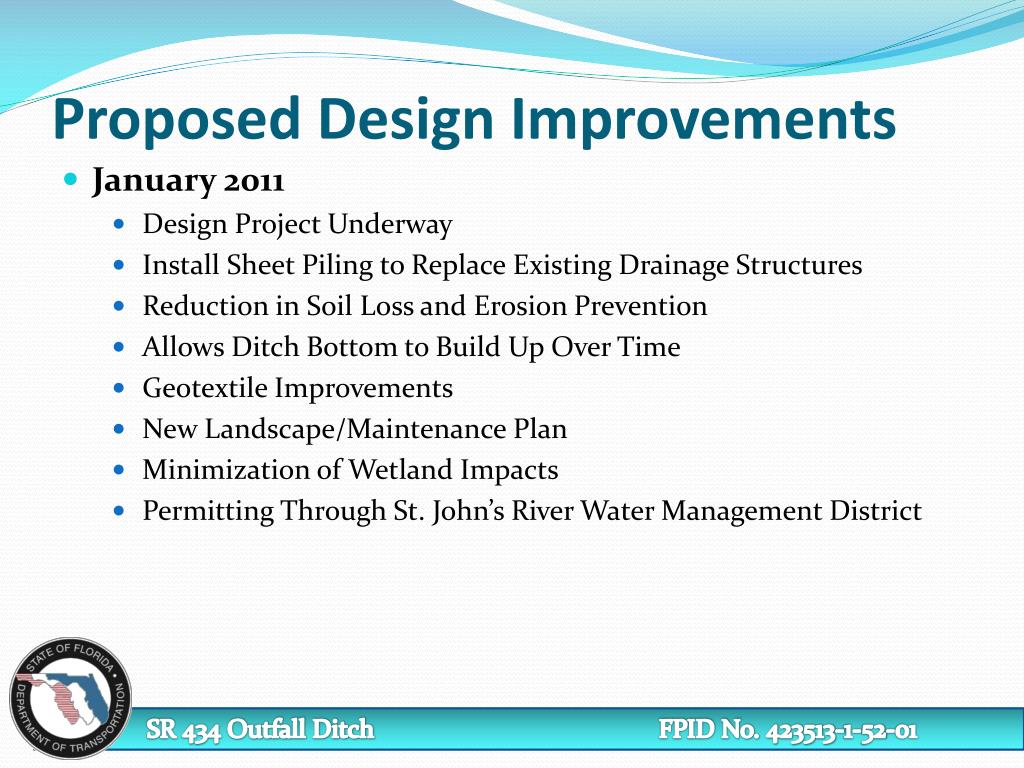

  9. Proposed Design Improvements • January 2011 • Design Project Underway • Install Sheet Piling to Replace Existing Drainage Structures • Reduction in Soil Loss and Erosion Prevention • Allows Ditch Bottom to Build Up Over Time • Geotextile Improvements • New Landscape/Maintenance Plan • Minimization of Wetland Impacts • Permitting Through St. John’s River Water Management District SR 434 Outfall Ditch FPID No. 423513-1-52-01

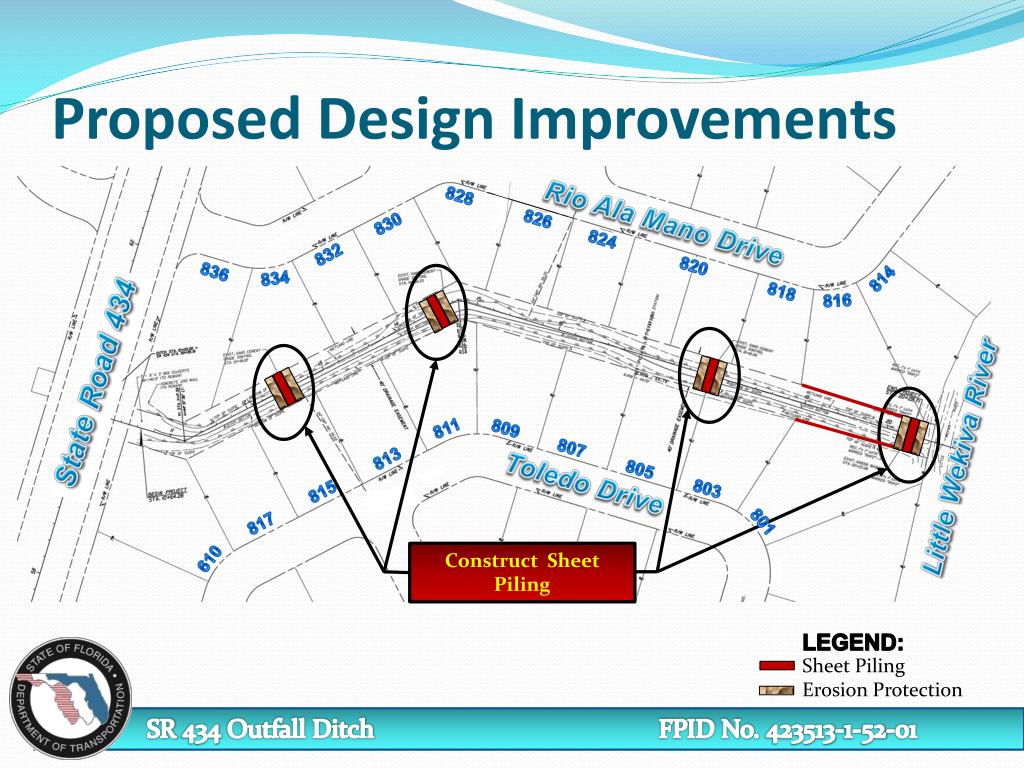

  10. Proposed Design Improvements 828 Rio Ala Mano Drive 826 830 824 832 820 836 834 814 818 816 State Road 434 811 809 807 Little Wekiva River 813 805 Toledo Drive 803 815 801 817 610 Construct Sheet Piling LEGEND: Sheet Piling Erosion Protection SR 434 Outfall Ditch FPID No. 423513-1-52-01

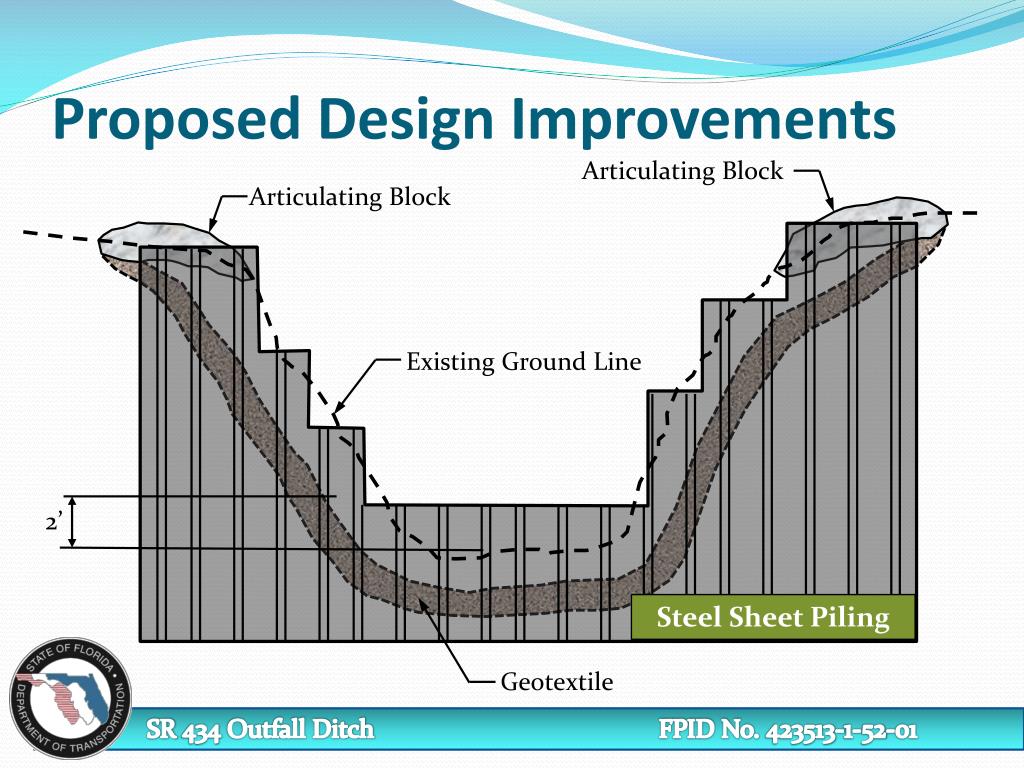

  11. Proposed Design Improvements Articulating Block Articulating Block Existing Ground Line 2’ Steel Sheet Piling Geotextile SR 434 Outfall Ditch FPID No. 423513-1-52-01

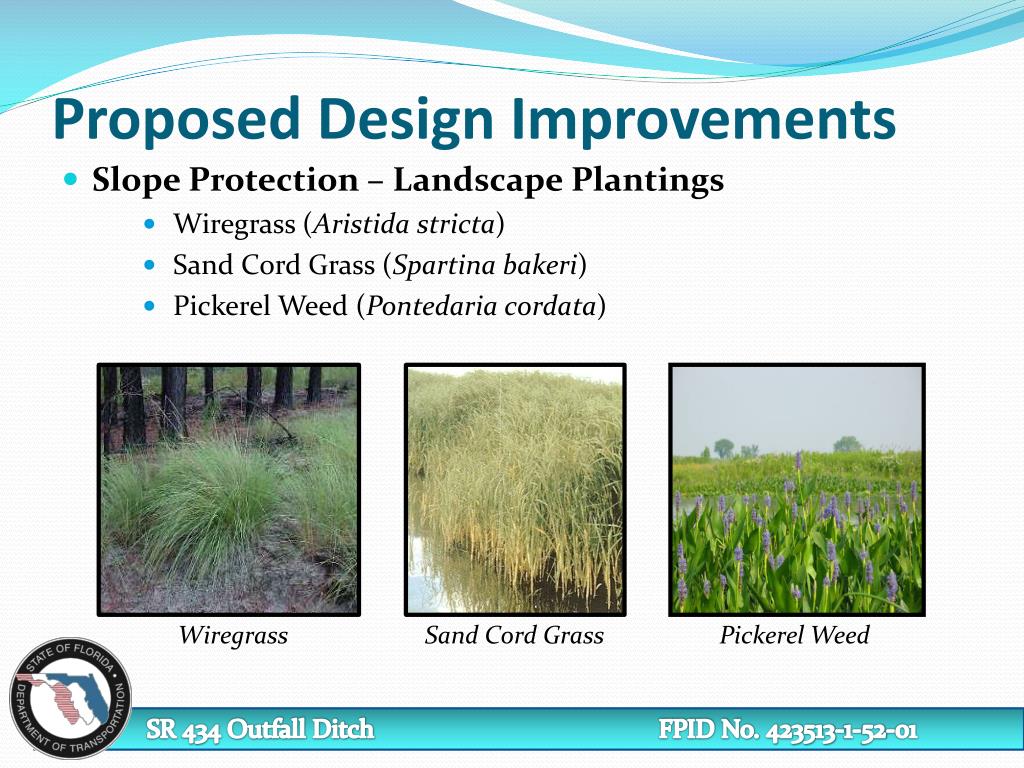

  12. Proposed Design Improvements • Slope Protection – Landscape Plantings • Wiregrass (Aristidastricta) • Sand Cord Grass (Spartinabakeri) • Pickerel Weed (Pontedariacordata) Wiregrass Sand Cord Grass Pickerel Weed SR 434 Outfall Ditch FPID No. 423513-1-52-01

  13. Proposed Design Improvements • Slope Protection - Geotextile Material • Articulating Block Articulating Block Samples SR 434 Outfall Ditch FPID No. 423513-1-52-01

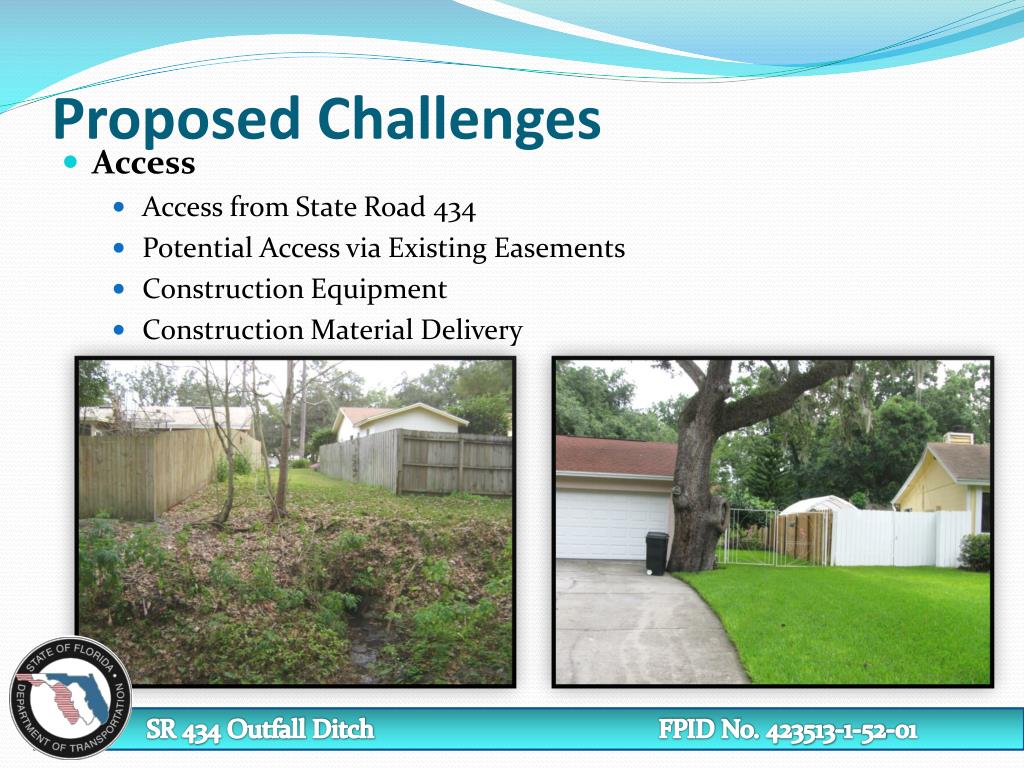

  14. Proposed Challenges • Access • Access from State Road 434 • Potential Access via Existing Easements • Construction Equipment • Construction Material Delivery SR 434 Outfall Ditch FPID No. 423513-1-52-01

  15. Construction Access Into Ditch 828 Rio Ala Mano Dr 826 830 824 832 820 836 834 814 818 816 SR 434 811 809 807 Little Wekiva River 813 805 Toledo Drive 803 815 801 817 610

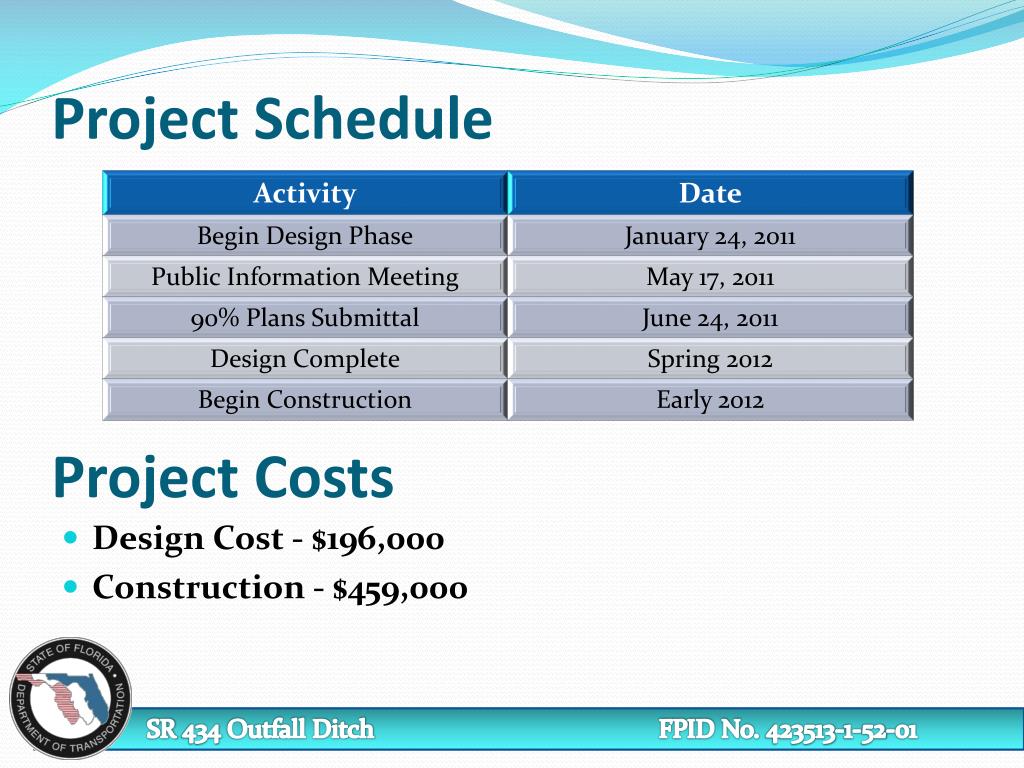

  16. Project Schedule • Design Cost - $196,000 • Construction - $459,000 Project Costs SR 434 Outfall Ditch FPID No. 423513-1-52-01

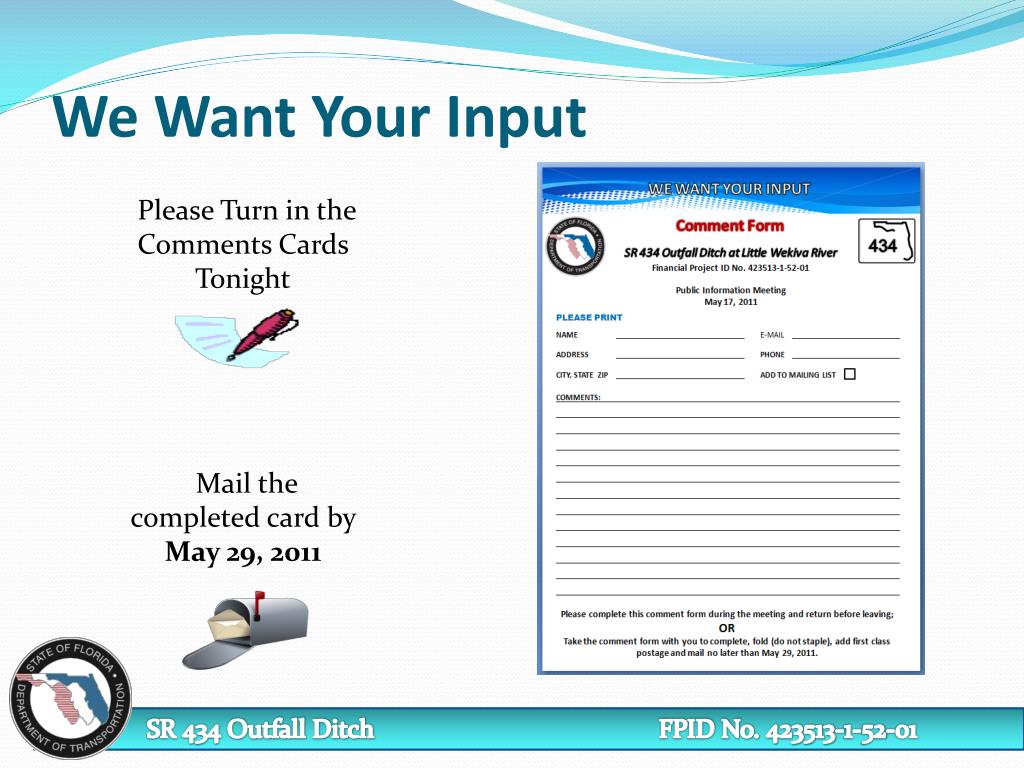

  17. We Want Your Input Please Turn in the Comments Cards Tonight Mail the completed card by May 29, 2011 SR 434 Outfall Ditch FPID No. 423513-1-52-01

  18. Thank You For Attending! We appreciate all who attended tonight’s Public Information Meeting DennisseZornan FDOT Project Management 719 South Woodland Boulevard Deland, Florida 32720 (386) 943-5184 dennisse.zornan@dot.state.fl.us • Stephanie Ghezzi • The LPA Group Incorporated • 615 Crescent Executive Court , Suite 200 • Lake Mary, Florida 32746 • (407) 562-4113 • sughezzi@lpagroup.com The Website for the Project can be Located Under the “Future Projects” Tab http://www.cflroads.com For Additional about other FDOT Projects and Programs:http://www.dot.state.fl.us SR 434 Outfall Ditch FPID No. 423513-1-52-01
