Lithuanian-Swiss Cooperation Programme Baltic Retreat September5-6, 2013

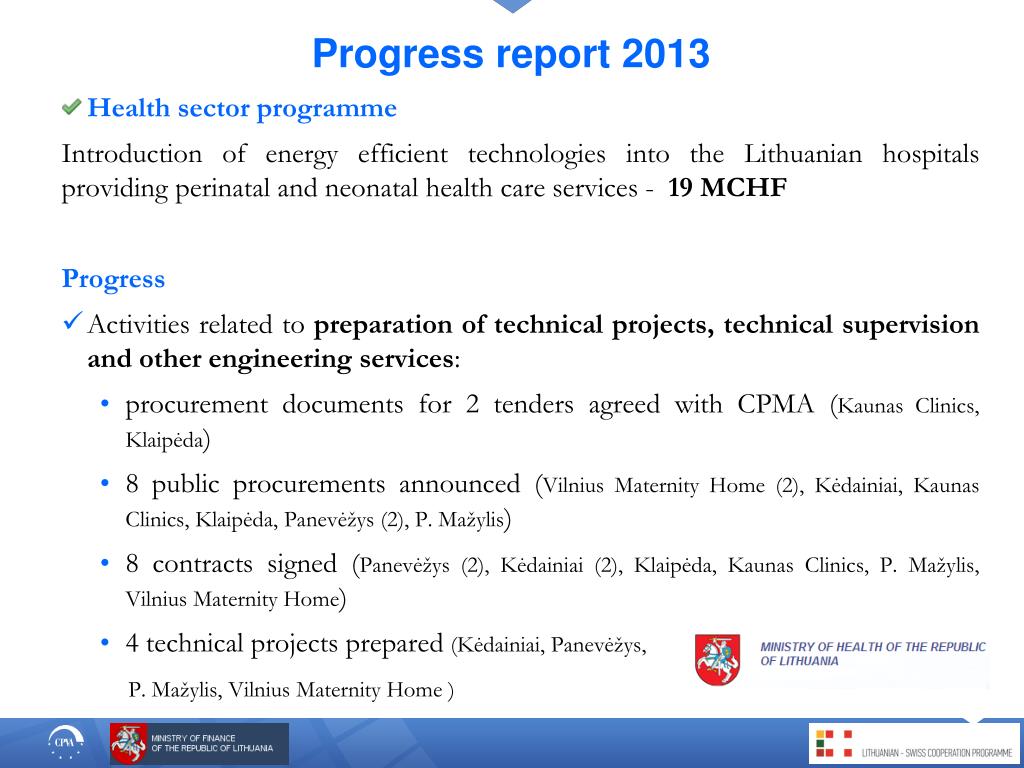

Health sector programme Introduction of energy efficient technologies into the Lithuanian hospitals providing perinatal and neonatal health care services - 19 MCHF Progress Activities related to preparation of technical projects, technical supervision and other engineering services: procurement documents for 2 tenders agreed with CPMA (Kaunas Clinics, Klaipėda) 8 public procurements announced (Vilnius Maternity Home (2), Kėdainiai, Kaunas Clinics, Klaipėda, Panevėžys (2), P. Mažylis) 8 contracts signed (Panevėžys (2), Kėdainiai (2), Klaipėda, Kaunas Clinics, P. Mažylis, Vilnius Maternity Home) 4 technical projects prepared (Kėdainiai, Panevėžys, P. Mažylis, Vilnius Maternity Home) Progress report 2013

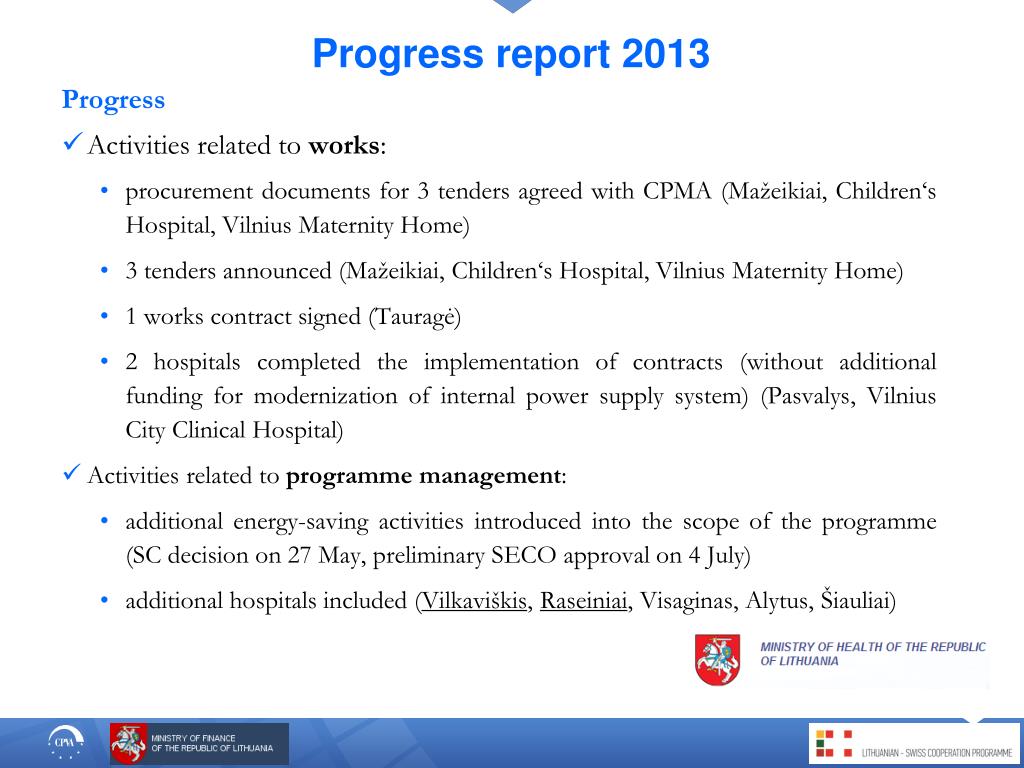

Progress Activities related to works: procurement documents for 3 tenders agreed with CPMA (Mažeikiai, Children‘s Hospital, Vilnius Maternity Home) 3 tenders announced (Mažeikiai, Children‘s Hospital, Vilnius Maternity Home) 1 works contract signed (Tauragė) 2 hospitals completed the implementation of contracts (without additional funding for modernization of internal power supply system) (Pasvalys, Vilnius City Clinical Hospital) Activities related to programme management: additional energy-saving activities introduced into the scope of the programme (SC decision on 27 May, preliminary SECO approval on 4 July) additional hospitals included (Vilkaviškis, Raseiniai, Visaginas, Alytus, Šiauliai) Progress report 2013

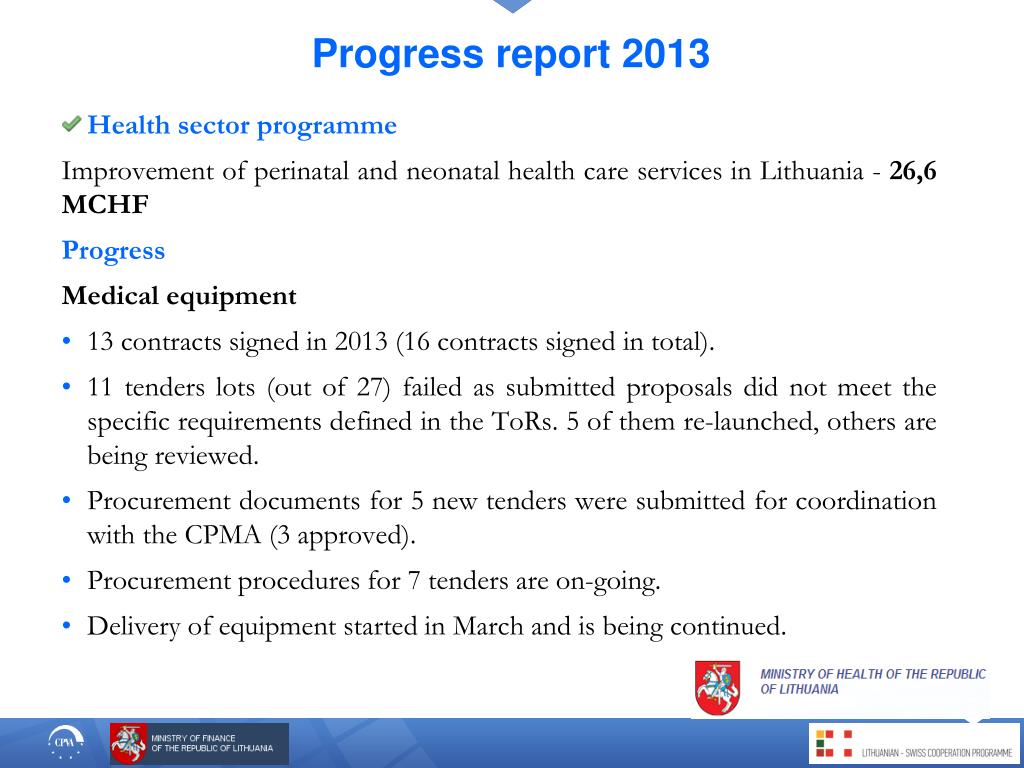

Health sector programme Improvement of perinatal and neonatal health care services in Lithuania - 26,6 MCHF Progress Medical equipment 13 contracts signed in 2013 (16 contracts signed in total). 11 tenderslots (outof 27) failed as submitted proposals did not meet the specific requirements defined in the ToRs. 5 of them re-launched, others are being reviewed. Procurement documents for 5 new tenders were submitted for coordination with the CPMA (3 approved). Procurement procedures for 7 tenders are on-going. Delivery of equipment started in March and is being continued. Progress report 2013
Progress Other procurements Tender on technical supervision services for development of computer data base launched in April 2013, envelopes opened on 15 May 2013. 2 proposals received. Evaluation on-going Contract on improvement of qualification and development of guidelines and protocols signed on 27 June 2013 2 hospitals are preparing tender documents fortechnical projects Technical projects (for repair works) for2 hospitals are under preparation 1 hospital completed the preparation of technical project, tender documents for procurement of the repair works are being developed 1 hospital is starting implementation of works Progress report 2013

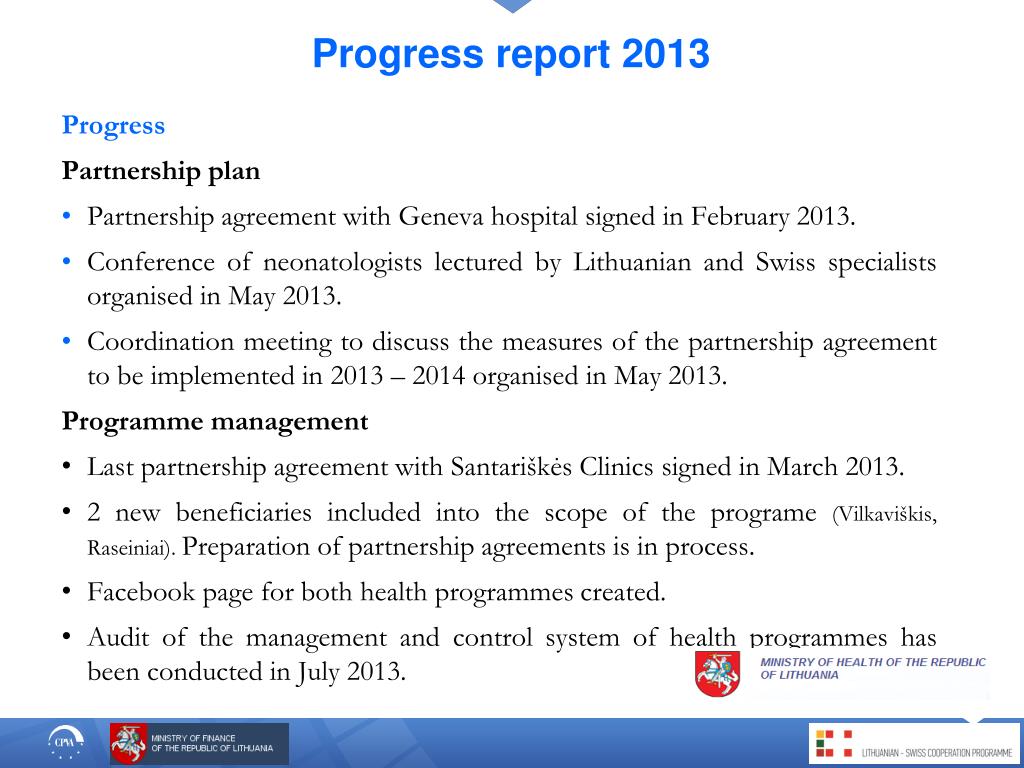

Progress Partnership plan Partnership agreement with Geneva hospital signed in February 2013. Conference of neonatologists lectured by Lithuanian and Swiss specialists organised in May 2013. Coordination meeting to discuss the measures of the partnership agreement to be implemented in 2013 – 2014 organised in May 2013. Programme management Last partnership agreement with Santariškės Clinics signed in March 2013. 2 new beneficiaries included into the scope of the programe(Vilkaviškis, Raseiniai). Preparation of partnership agreements is in process. Facebook page for both health programmes created. AuditofthemanagementandcontrolsystemofhealthprogrammeshasbeenconductedinJuly 2013. Progress report 2013

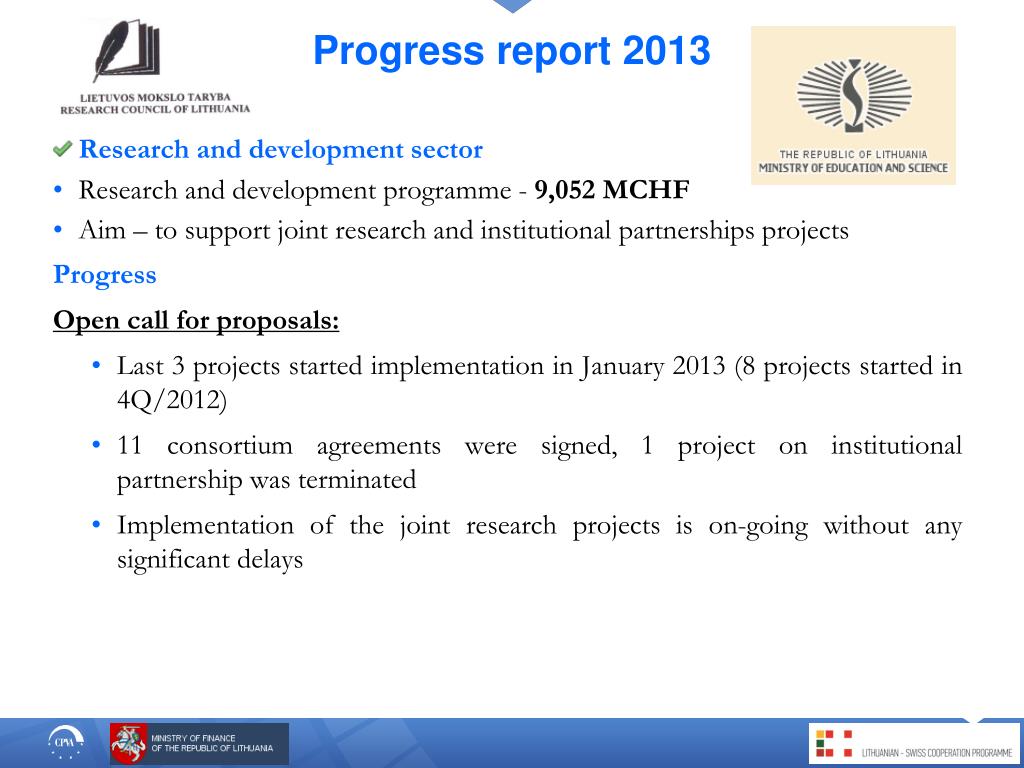

Progress report 2013 • Research and development sector • Research and development programme - 9,052 MCHF • Aim – to support joint research and institutional partnerships projects Progress Open call for proposals: • Last 3 projects started implementation in January 2013 (8 projects started in 4Q/2012) • 11 consortium agreements were signed, 1 project on institutional partnership was terminated • Implementation of the joint research projects is on-going without any significant delays

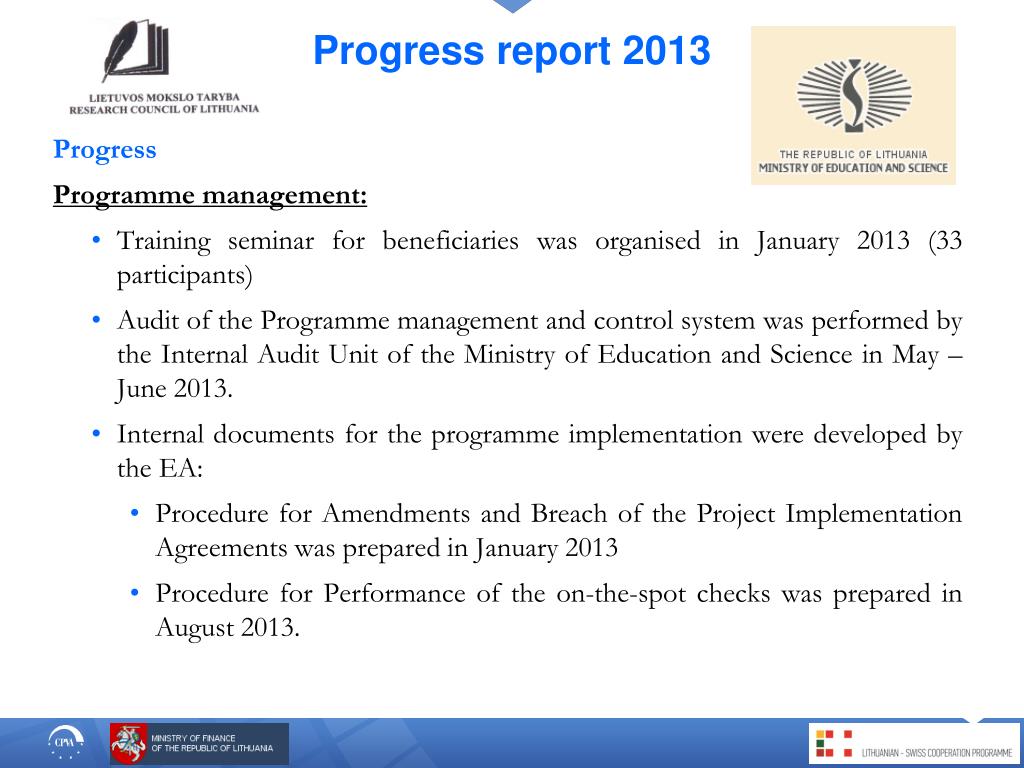

Progress report 2013 Progress Programme management: • Training seminar for beneficiaries was organised in January 2013 (33 participants) • Audit of the Programme management and control system was performed by the Internal Audit Unit of the Ministry of Education and Science in May – June 2013. • Internal documents for the programme implementation were developed by the EA: • Procedure for Amendments and Breach of the Project Implementation Agreements was prepared in January 2013 • Procedure for Performance of the on-the-spot checks was prepared in August 2013.

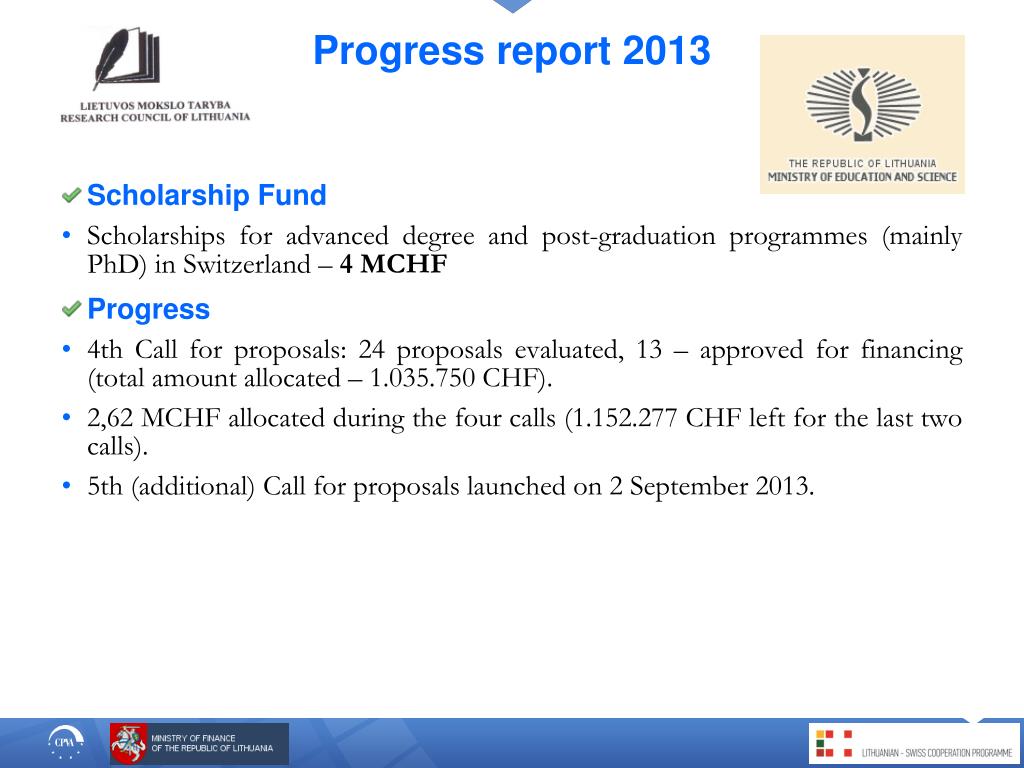

Progress report 2013 • Scholarship Fund • Scholarships for advanced degree and post-graduation programmes (mainly PhD) in Switzerland – 4 MCHF • Progress • 4th Call for proposals: 24 proposals evaluated, 13 – approved for financing (total amount allocated – 1.035.750 CHF). • 2,62 MCHF allocated during the four calls (1.152.277 CHF left for the last two calls). • 5th (additional) Call for proposals launched on 2 September 2013.

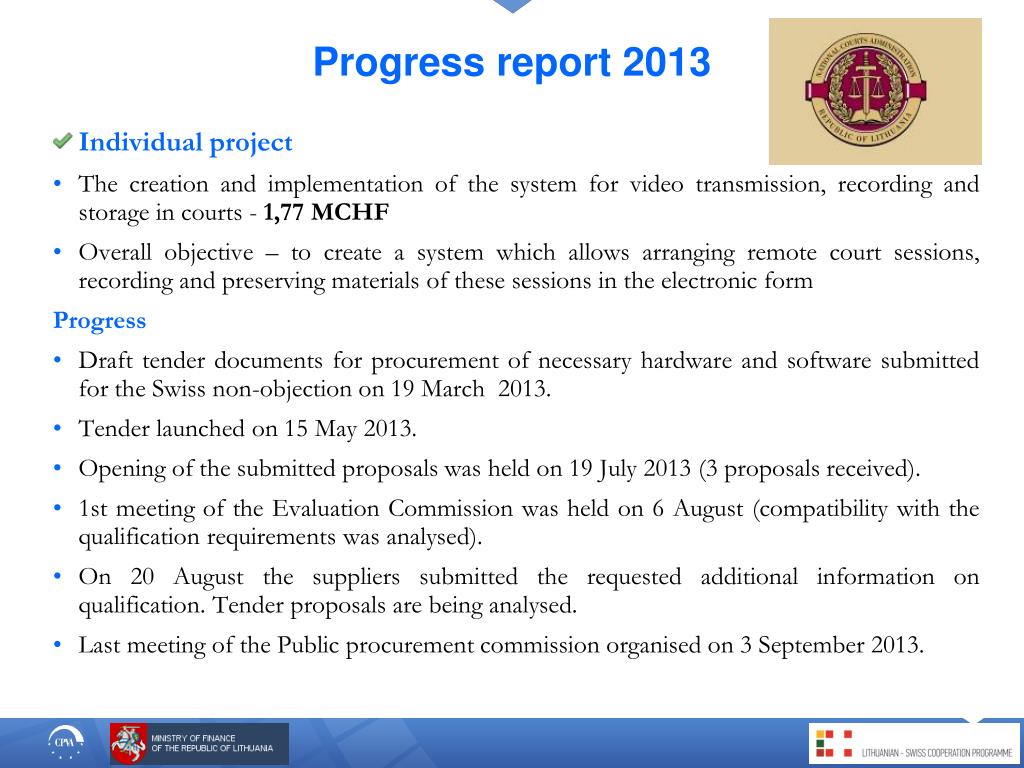

Progress report 2013 • Individual project • The creation and implementation of the system for video transmission, recording and storage in courts - 1,77 MCHF • Overall objective – to create a system which allows arranging remote court sessions, recording and preserving materials of these sessions in the electronic form Progress • Draft tender documents for procurement of necessary hardware and software submitted for the Swiss non-objection on 19 March 2013. • Tender launched on 15 May 2013. • Opening of the submitted proposals was held on 19 July 2013 (3 proposals received). • 1st meeting of the Evaluation Commission was held on 6 August (compatibility with the qualification requirements was analysed). • On 20 August the suppliers submitted the requested additional information on qualification.Tender proposals are being analysed. • LastmeetingofthePublicprocurementcommissionorganisedon 3 September 2013.
Progress report 2013 • Block grant • NGO Fund - 5,553 MCHF • Overall aims: • to promote civil society’s contribution to economic and social cohesion as an important actor of development and participation • to contribute to the further development of the NGO sector in Lithuania • Progress Implementation of the Fund • 85 sub-project implementation agreements signed in January – February 2013 (2 applicants refused from the allocated grant). • 12 additional applications were approved for financing by the SC on 16 April 2013: • 10 sub-project implementation agreements signed in June, 2013, • 2 sub-project implementation agreements signed in July 2013. • 1 sub-project completed in August 2013.

Progress report 2013 • Progress Fund management • 3 training seminars for the final beneficiaries conducted in January 2013 (145 participants) • 89 procurement plans and 15 amendments to the plans verified and confirmed by the EA in February – August 2013 • 237 payment claims verified by the EA in February – August 2013 • 396 tender documents of the sub-projects verified by the EA in February – August 2013 • 12 on-the-spot checks conducted by the EA in March - August 2013
Operational plan (September 2013 to December 2014) Improvement of perinatal and neonatal health care services in Lithuania • Medical equipment • To submit tender documents (on stationary ultrasonic devices) for the Swiss non-objection (September 2013) • To launch 2 new tenders in October 2013, 2 in December 2013, 2 in March 2014 • To re-launch 6 tenderlots in October– December 2013. • To sign 4 contracts in November – December 2013, 15 contracts in 2014 (4 in January, 3 in February, 3 in March, 1 in April, 2 in June, 2in December). • To continue the delivery of equipment to beneficiary hospitals
Operational plan (September 2013 to December 2014) Improvement of perinatal and neonatal health care services in Lithuania • Computer database • To sign the contract on technical supervision services (November 2013) • To develop the computer database: • To submit the tender documents for the review of CPMA (January 2014) • To launch the tender (April 2014) and to sign the contract (June 2014) • Preparation of Technical projects and supervision • To announce the tender (Kaunas clinical hospital – November 2013,Marijampolė – January 2014) • To conclude the contract (Kaunas clinical hospital – March 2014, Marijampolė – May 2014) • To prepare technical projects (Klaipėda – October 2013, Kaunas Clinics – December 2013, Kaunas clinical hospital – June 2014, Marijampolė –August 2014)
Operational plan (September 2013 to December 2014) Improvement of perinatal and neonatal health care services in Lithuania • Repair works • To announce tender (Panevėžys – September 2013, Klaipėda, Telšiai, Mažeikiai – January 2014, Kaunas Clinics, Trakai – February 2014, Kaunas clinical hospital,Marijampolė – November 2014 ) • To sign contract (Panevėžys – January 2014, Klaipėda, Telšiai, Mažeikiai – May 2014, Kaunas Clinics, Trakai – June 2014) • Completeworks (Vilnius City Clinical Hospital - November 2013, Vilnius Maternity Home – March 2014, Panevėžys – June2014, Klaipėda, Telšiai, Mažeikiai – October2014, Trakai – June 2014) • Guidelines, protocols and professional competence improvement • To prepare 23 methodologies (1/3 of total 70) till December 2013 (other till end of 2014)and to conduct first training activities in 1Q/2014 (after approval of first methodologies) • Vehicles • Tender documents will be coordinated with CPMA (November-December 2013)
Operational plan (September 2013 to December 2014) Improvement of perinatal and neonatal health care services in Lithuania • Programme management • To implement planned publicity measures(EAs, IB) • To organise „Journalist‘s breakfast“/openingevent(s) (IB, EA) in order to present the essential news on programme implementation • To sign partnershipagreements betweenthe EA andnewlyincluded hospitals (Raseiniai, Vilkaviškis) (October - November 2013) • Partnershipplan • To signpartnershipagreementswithBasel(3Q/2013) andZurich (4Q/2013) hospitals • To implementactivitiesaccording to thepartneshipplan.
Operational plan (September 2013 to December 2014) Introduction of energy efficient technologies into the Lithuanian hospitals providing perinatal and neonatal health care services • Programme management • To procure publicity, audit, translation services (EAs) • To implement planned publicity measures (EAs, IB) • To organise „Journalist‘s breakfast“/openingevent(s) (IB) in order to present the essential news on programme implementation • To sign project implementation agreements with the additional hospitals (October 2013) • Programme direct costs
Operational plan (September 2013 to December 2014) • Research and development programme Programme manegement • To complete and approve the internal Procedures for Estimationof joint research projects (IB) (November - December 2013). • To conduct interim financial audit (by March 2014). Implementation of Objective • To continue implementation of the joint research projects • To conduct expert evaluation of the projects’ annual reports (January - February 2014) • To check the submitted payment claims, interim implementation reports, tender documents
Operational plan (September 2013 to December 2014) • Individual project (on video conferencingsystem) 1 scenario (if the winner of the tender will be selected): • In case the winner will be selected in mid-September, the contract should be signed in mid-October 2013 (planned duration: 134 days). Contract should be completed (equipment installed) in February – March 2014. • To approach the Swiss side with a request to extend the project duration (September-October2013). • To start preparation for procurement of leaflets, stickers, organisation of the final conference and financial audit (October 2013). • To conduct financial audit activities (2 months after the completion of the project activities, could be June - July 2014). • To organise the closing conference (February2014).
Operational plan (September 2013 to December 2014) • Individual project (on video conferencingsystem) 2 scenario (if the winner of the tender will not be announced): • To approach the Swiss side with a request to extend the project duration (September-October2013). • To update the draft tender documents for procurement of hardware and software and agree with the CPMA (November2013) • To re-submit the draft tender documents for procurement of hardware and software to the Swiss side for no-objection (December2013) • To re-launch the tender on procurement of hardware and software (January2013) • To sign the contract (March – April 2014) • To organise the closing conference (September - October 2014) • To conduct financial audit activities (January – February 2015)

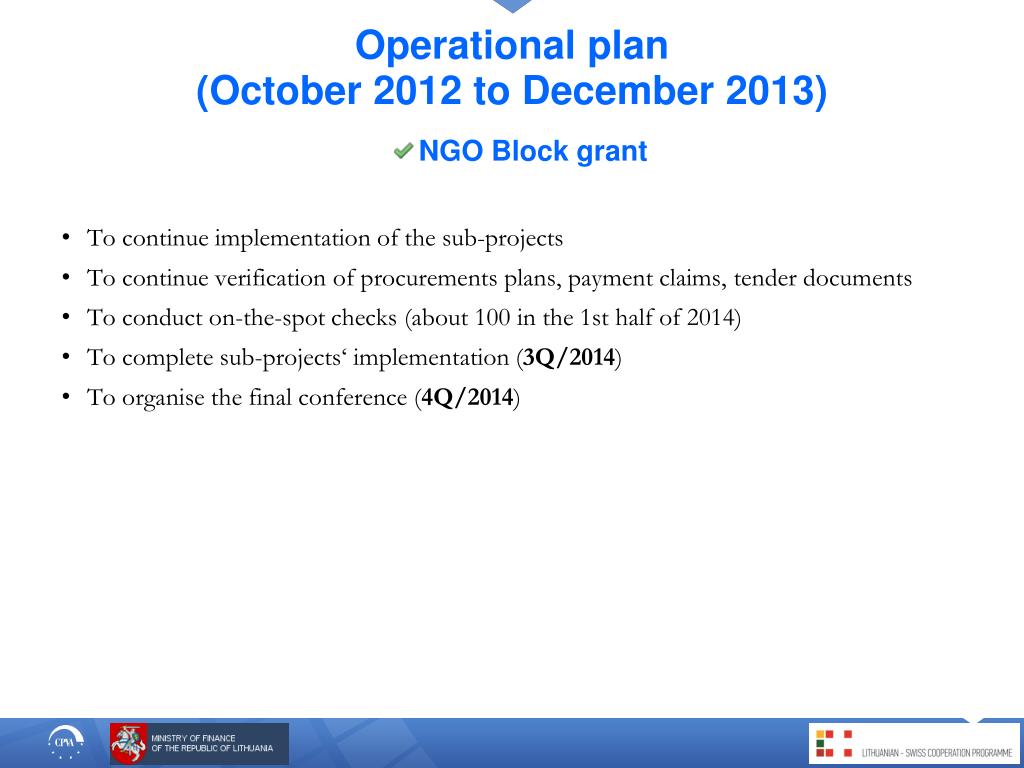

Operational plan (October 2012 to December 2013) • NGO Block grant • To continue implementation of the sub-projects • To continue verification of procurements plans, payment claims, tender documents • To conduct on-the-spot checks (about 100 in the 1st half of 2014) • To completesub-projects‘implementation (3Q/2014) • To organisethefinalconference (4Q/2014)

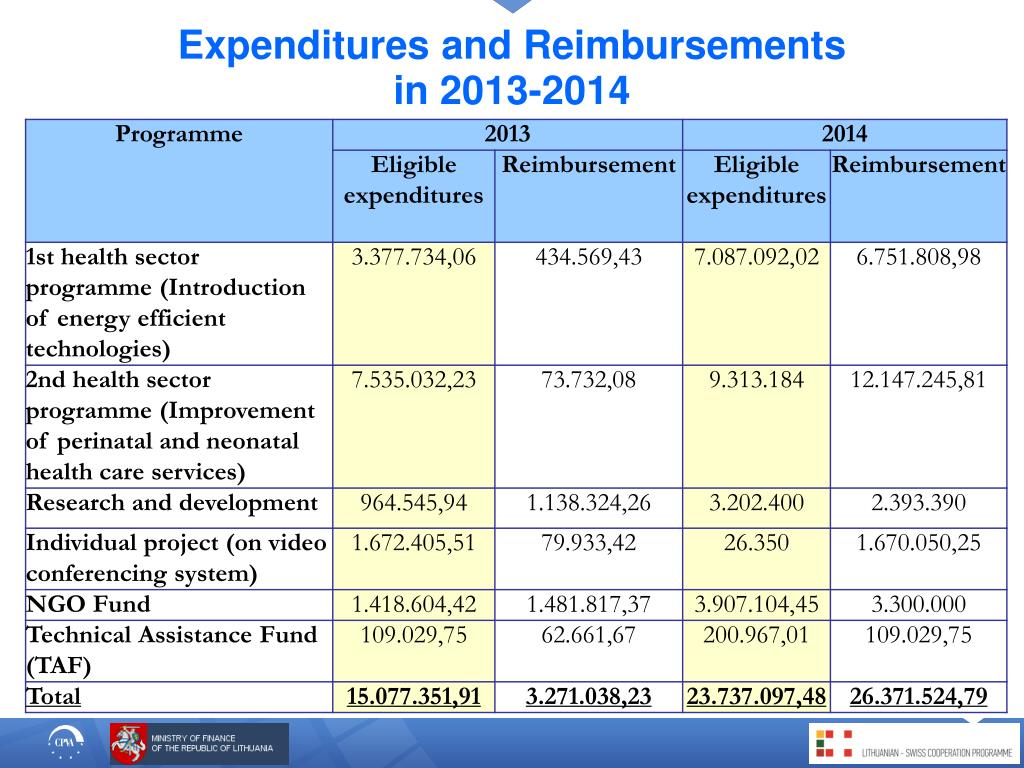

Expendituresand Reimbursementsin 2013-2014 Swisscontribution, thousands CHF
