An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. CSC / TPP SystmOne – Summary Care Record

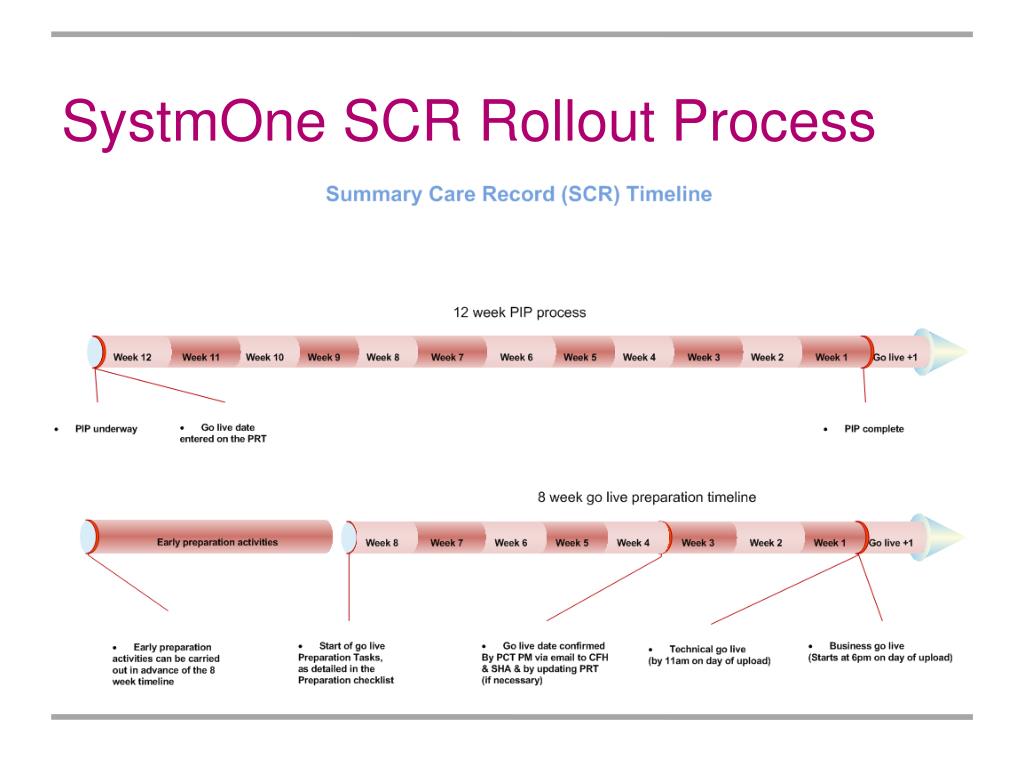

  2. SystmOne SCR Rollout Process

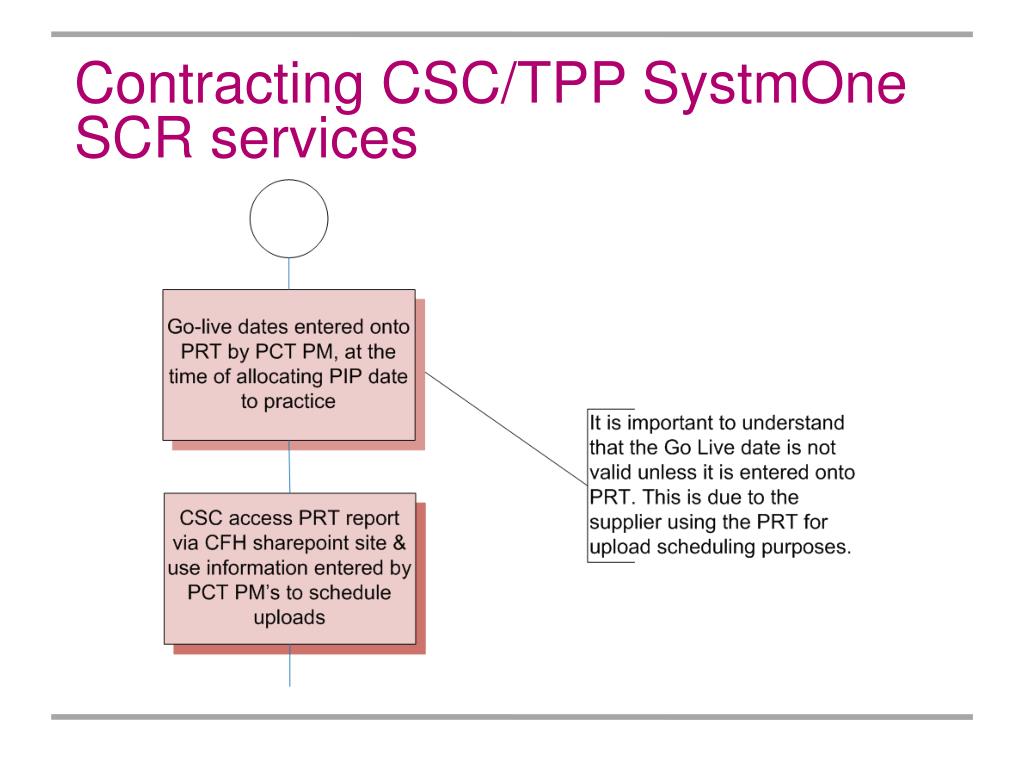

  3. Contracting CSC/TPP SystmOne SCR services

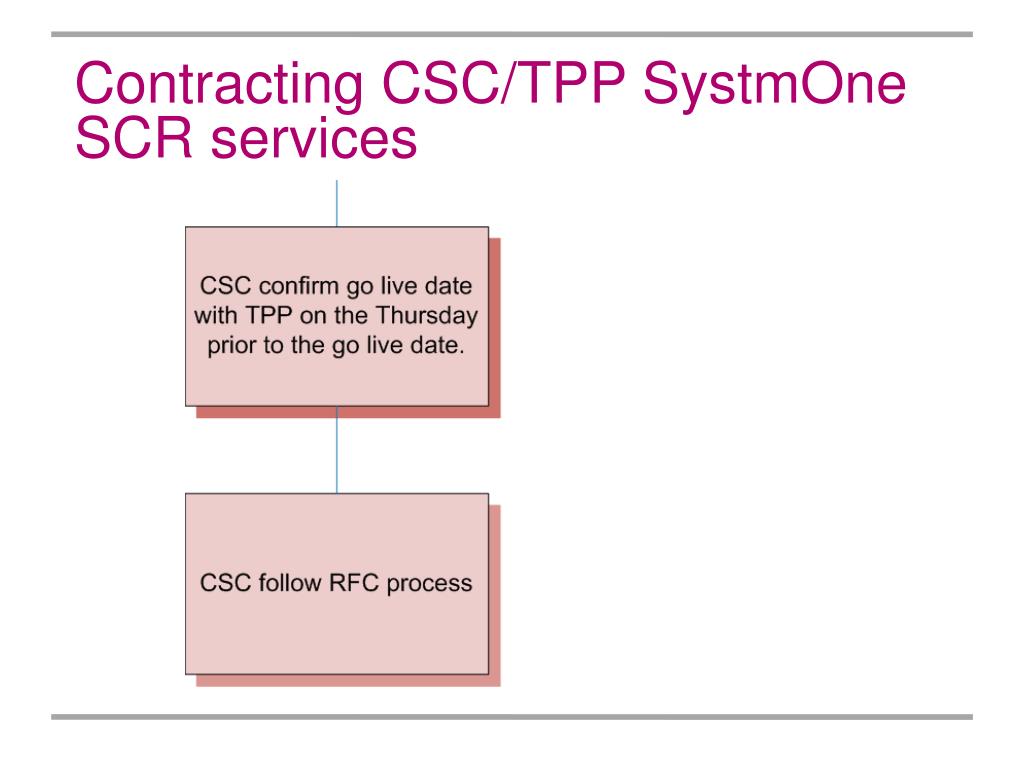

  4. Contracting CSC/TPP SystmOne SCR services

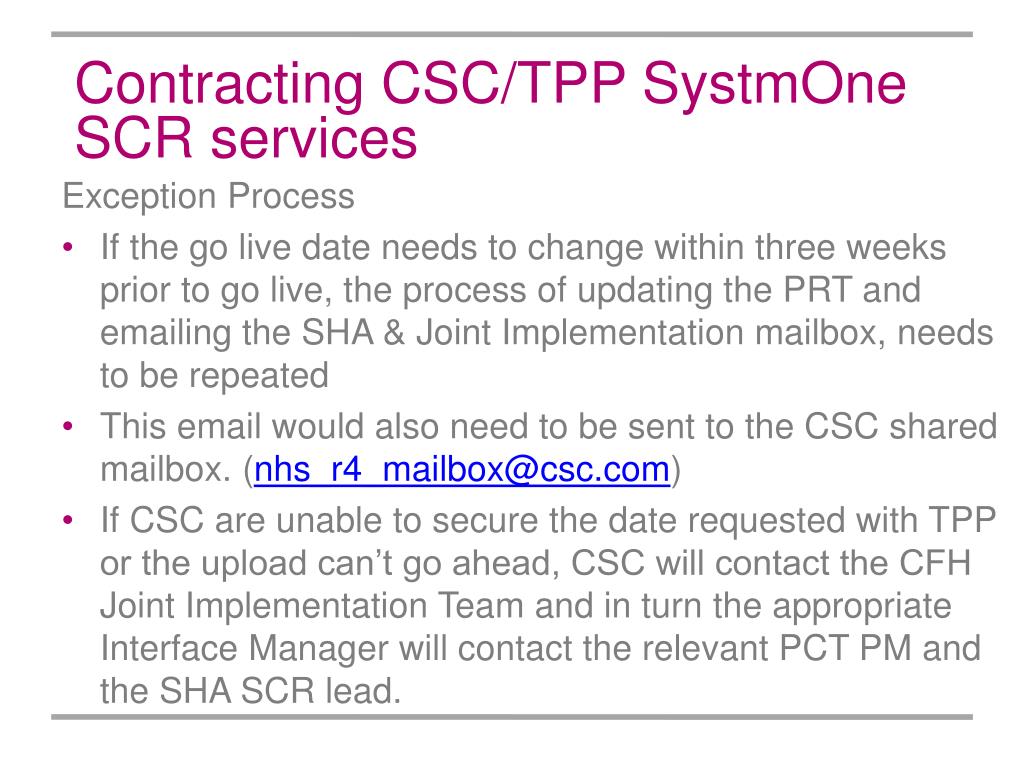

  5. Contracting CSC/TPP SystmOne SCR services Exception Process • If the go live date needs to change within three weeks prior to go live, the process of updating the PRT and emailing the SHA & Joint Implementation mailbox, needs to be repeated • This email would also need to be sent to the CSC shared mailbox. (nhs_r4_mailbox@csc.com) • If CSC are unable to secure the date requested with TPP or the upload can’t go ahead, CSC will contact the CFH Joint Implementation Team and in turn the appropriate Interface Manager will contact the relevant PCT PM and the SHA SCR lead.

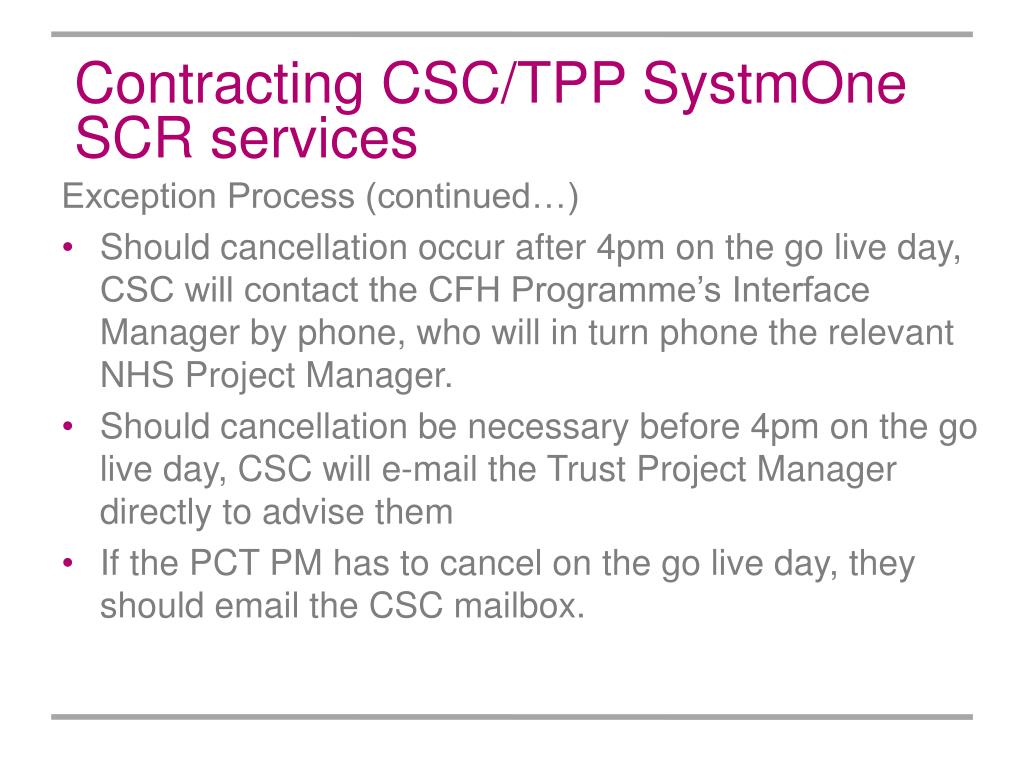

  6. Contracting CSC/TPP SystmOne SCR services Exception Process (continued…) • Should cancellation occur after 4pm on the go live day, CSC will contact the CFH Programme’s Interface Manager by phone, who will in turn phone the relevant NHS Project Manager. • Should cancellation be necessary before 4pm on the go live day, CSC will e-mail the Trust Project Manager directly to advise them • If the PCT PM has to cancel on the go live day, they should email the CSC mailbox.

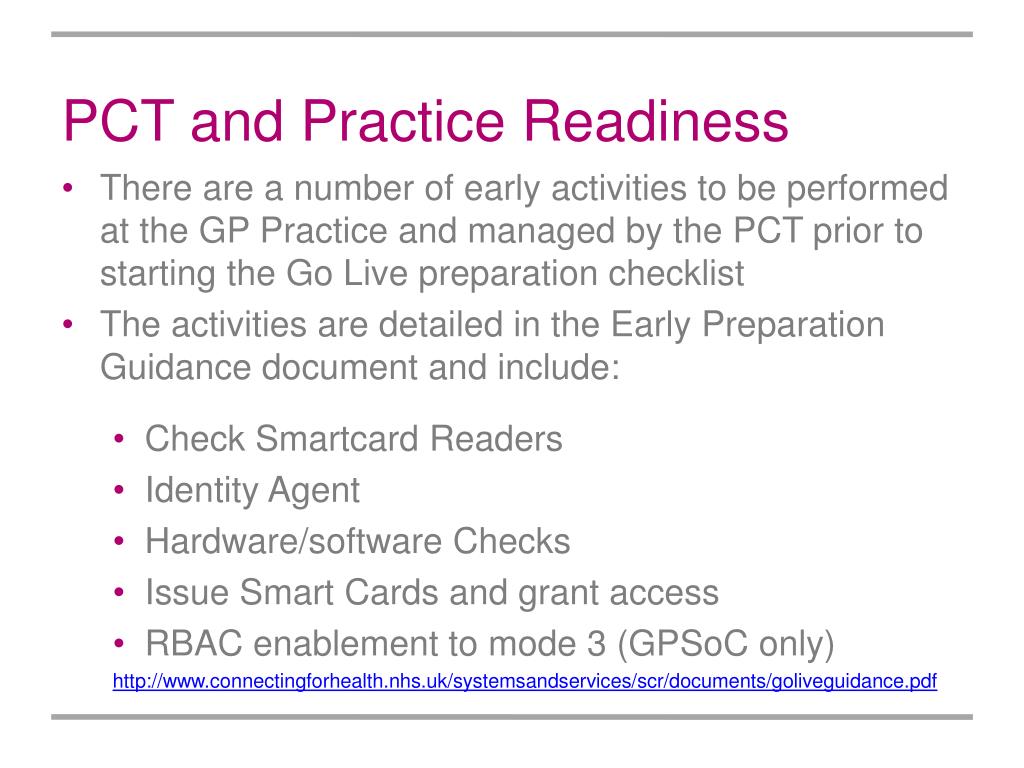

  7. PCT and Practice Readiness • There are a number of early activities to be performed at the GP Practice and managed by the PCT prior to starting the Go Live preparation checklist • The activities are detailed in the Early Preparation Guidance document and include: • Check Smartcard Readers • Identity Agent • Hardware/software Checks • Issue Smart Cards and grant access • RBAC enablement to mode 3 (GPSoC only) http://www.connectingforhealth.nhs.uk/systemsandservices/scr/documents/goliveguidance.pdf

  8. PCT and Practice Readiness • The Go Live Preparation Document is part of a set of products developed to provide the NHS with the guidance and tools required to successfully deploy the Summary Care Record (SCR) to GP Practices • Two checklists have been developed, as part of the Go Live Preparation Document covering both LSP & GPSoC areas • It lists all activities that need to be performed in the eight weeks prior to go live and is complemented with more detailed descriptions of each task • http://www.connectingforhealth.nhs.uk/systemsandservices/scr/documents/csctppscrgolivepreparationdocument.pdf

  9. Go live Technical Enablement • TPP will action technical enablement by 11am on the upload day (Monday, Tuesday or Wednesday) • The practice should check no later than midday that the SCR functionality has been enabled. If it has not, the relevant practice / PCT will need to email the CSC mailbox Business Go Live • User logs into SystmOne after technical go live has been actioned • Set the upload to run • The upload will automatically commence at 6pm

  10. Assurance Toolkit • Purpose – To provide detailed guidance to NHS staff who will be carrying out assurance of SCR uploads • The toolkit contains; • Guidance notes on carrying out assurance • CSC/TPP specific instructions and forms for recording the outcome of the assurance activities • Basic trouble shooting guidance around the assurance activities • Guidance on what to do, should the upload not reconcile • http://www.connectingforhealth.nhs.uk/systemsandservices/scr/documents/scrgoliveassurancetoolkittppsystmonepdf.pdf(The toolkit can also be found in the go live preparation document)

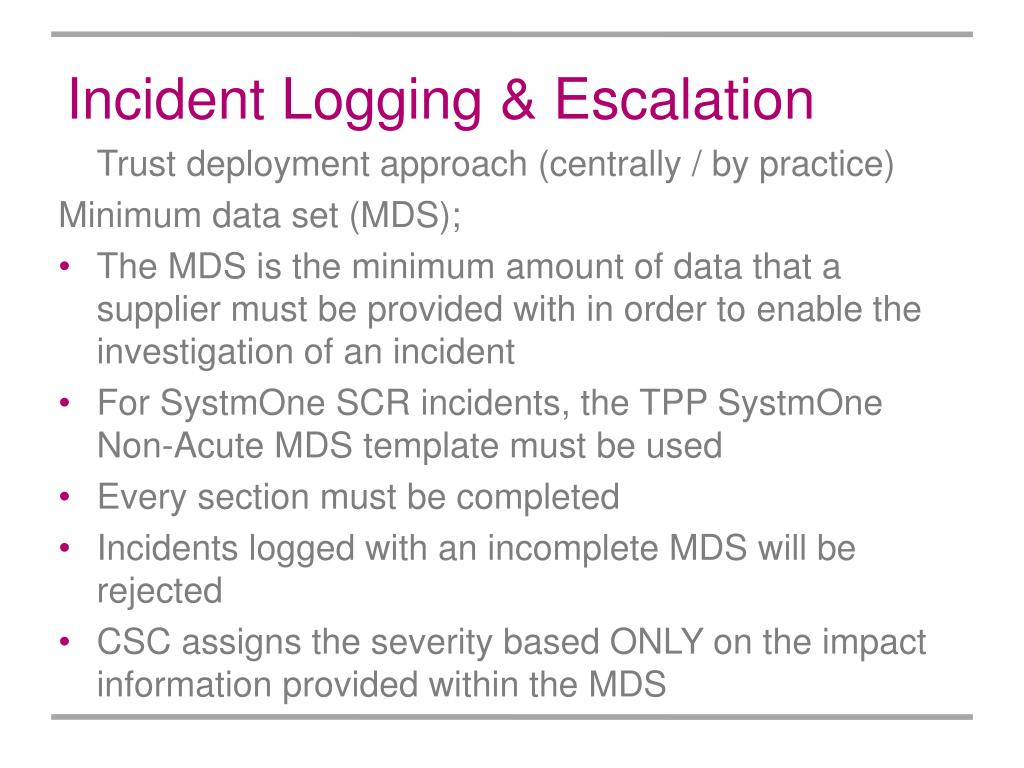

  11. Incident Logging & Escalation • Trust deployment approach (centrally / by practice) • Minimum data set (MDS); • The MDS is the minimum amount of data that a supplier must be provided with in order to enable the investigation of an incident • For SystmOne SCR incidents, the TPP SystmOne Non-Acute MDS template must be used • Every section must be completed • Incidents logged with an incomplete MDS will be rejected • CSC assigns the severity based ONLY on the impact information provided within the MDS

  12. Incident Logging & Escalation • User Rights; • If a severity is deemed unacceptable, it can and must be rejected by the Trust when it is received. • Two ways to invoke the severity dispute process: • Ask the CSC service desk to escalate the dispute to CSC for arbitration • Email the NHS CFH Incident Management Team. • If a closure solution is deemed unacceptable, the user should first reject it via the standard route, eg local SD • If still not satisfied, user should escalate to the TPP CRM team on 0113 205 0083

  13. In Summary • PCT enter a go live date on the PRT at the point when the PIP is undertaken • Early preparation activities undertaken • Go Live preparation tasks undertaken • Go Live date on PRT confirmed • Technical Go Live • Business Go Live (upload) • PCT perform assurance activities • The process from the start of the PIP to the completion of post Go Live Assurance typically takes about 13 weeks • Incident Logging and Escalation
