silver
Uploaded by
5 SLIDES
194 VIEWS
50LIKES

Mary Lin Elementary School Phasing Plan: Comprehensive Renovation and Expansion Project

DESCRIPTION

The Mary Lin Elementary School Phasing Plan outlines a structured approach for renovations and expansions at the school, situated at 586 Candler Park Drive. The project is divided into several phases: Phase 1 involves site utilities; Phase 2A includes the construction of new two-story classrooms; Phase 2B focuses on cafeteria and classroom renovations; Phase 3 addresses various classroom and gym updates; while Phase 4A introduces a new administration wing, and Phase 4B covers additional improvements to music classrooms. This project aims to enhance educational facilities and ensure a modern learning environment.

1 / 5

Download Presentation

Mary Lin Elementary School Phasing Plan: Comprehensive Renovation and Expansion Project

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. Mary Lin Elementary School586 Candler Park DrivePhasing Plan March 25, 2010

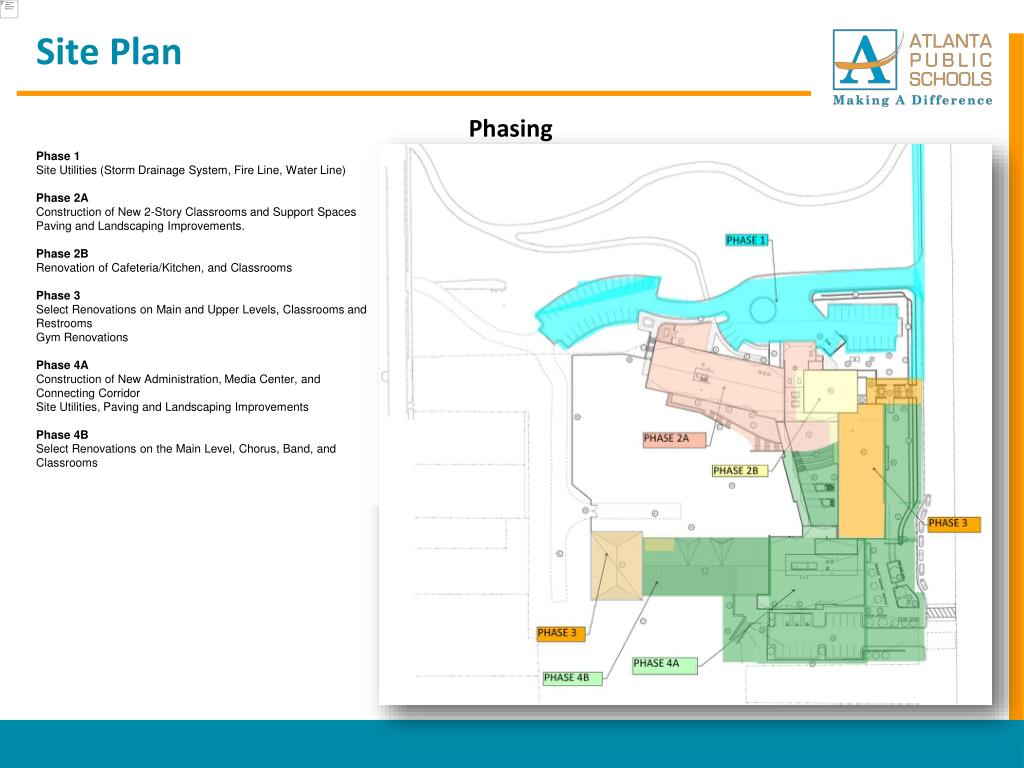

  2. Site Plan Phasing Phase 1 Site Utilities (Storm Drainage System, Fire Line, Water Line) Phase 2A Construction of New 2-Story Classrooms and Support Spaces Paving and Landscaping Improvements. Phase 2B Renovation of Cafeteria/Kitchen, and Classrooms Phase 3 Select Renovations on Main and Upper Levels, Classrooms and Restrooms Gym Renovations Phase 4A Construction of New Administration, Media Center, and Connecting Corridor Site Utilities, Paving and Landscaping Improvements Phase 4B Select Renovations on the Main Level, Chorus, Band, and Classrooms

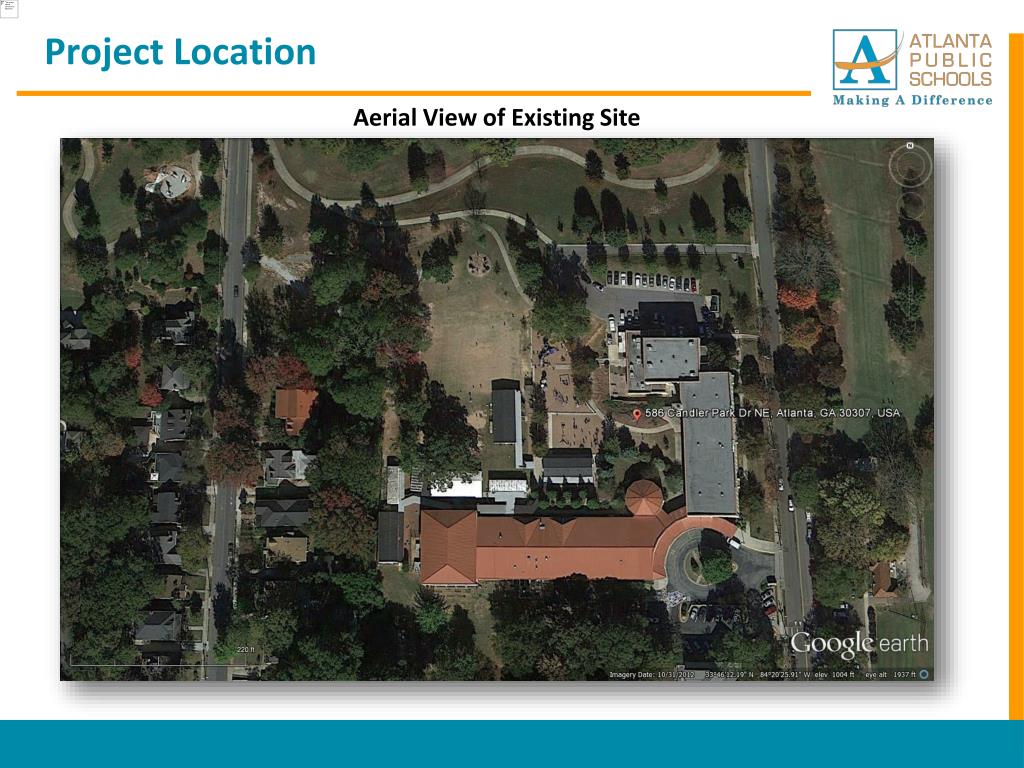

  3. Project Location Aerial View of Existing Site

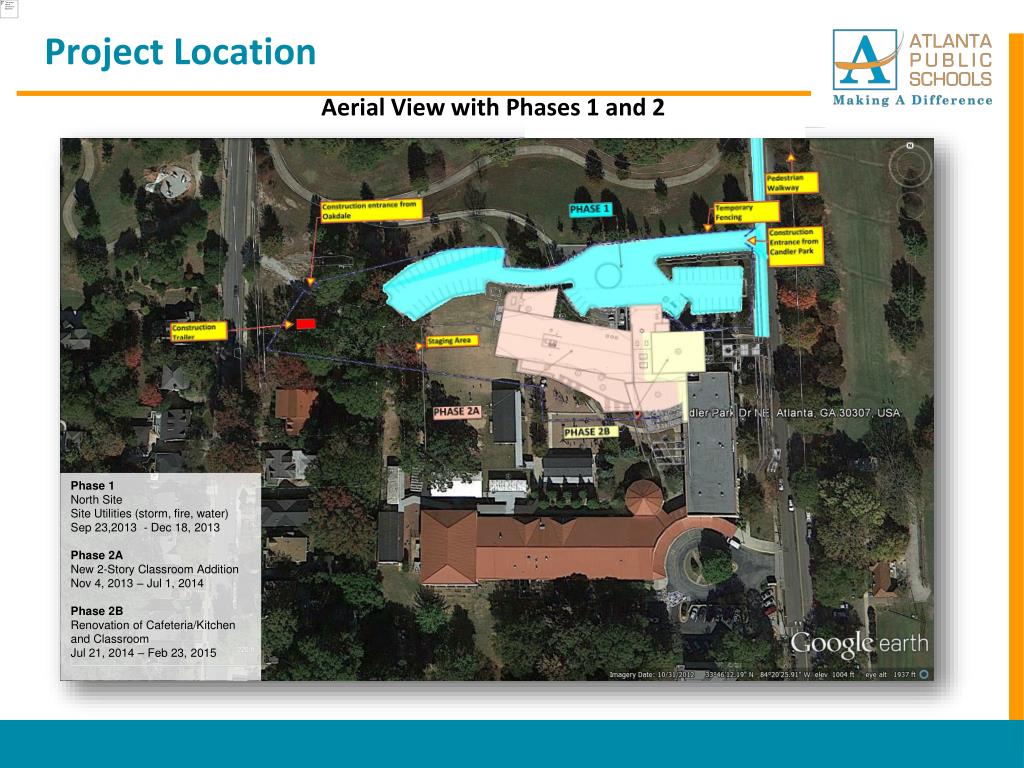

  4. Project Location Aerial View with Phases 1 and 2 Phase 1 North Site Site Utilities (storm, fire, water) Sep 23,2013 - Dec 18, 2013 Phase 2A New 2-Story Classroom Addition Nov 4, 2013 – Jul 1, 2014 Phase 2B Renovation of Cafeteria/Kitchen and Classroom Jul 21, 2014 – Feb 23, 2015

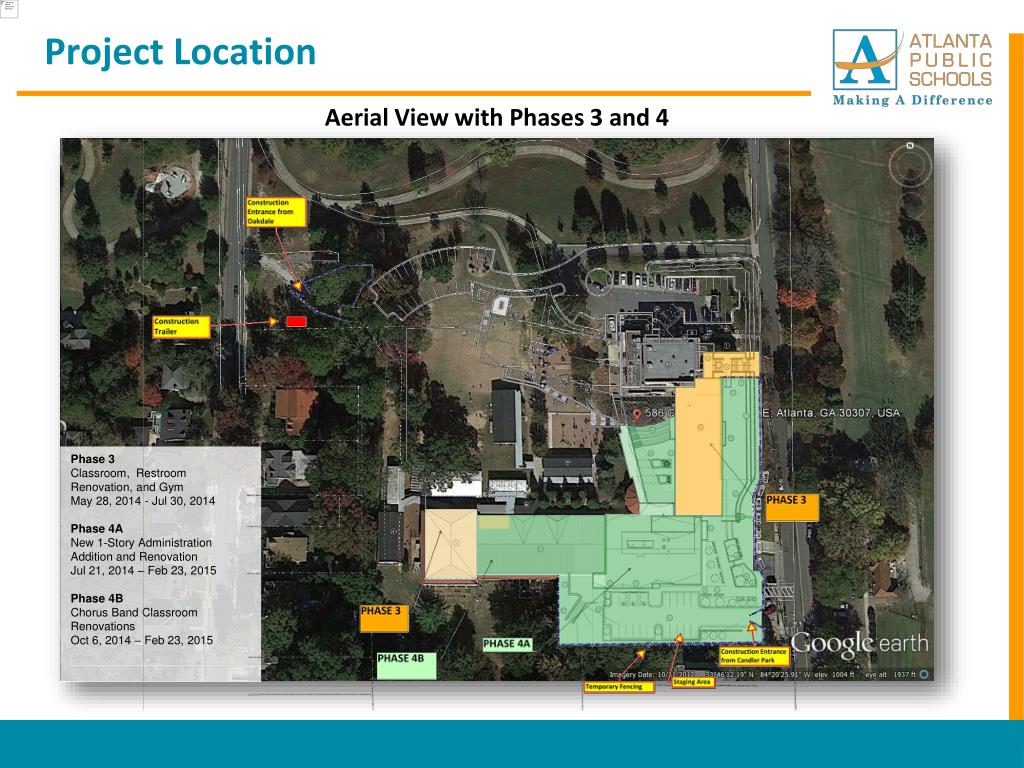

  5. Project Location Aerial View with Phases 3 and 4 Phase 3 Classroom, Restroom Renovation, and Gym May 28, 2014 - Jul 30, 2014 Phase 4A New 1-Story Administration Addition and Renovation Jul 21, 2014 – Feb 23, 2015 Phase 4B Chorus Band Classroom Renovations Oct 6, 2014 – Feb 23, 2015
