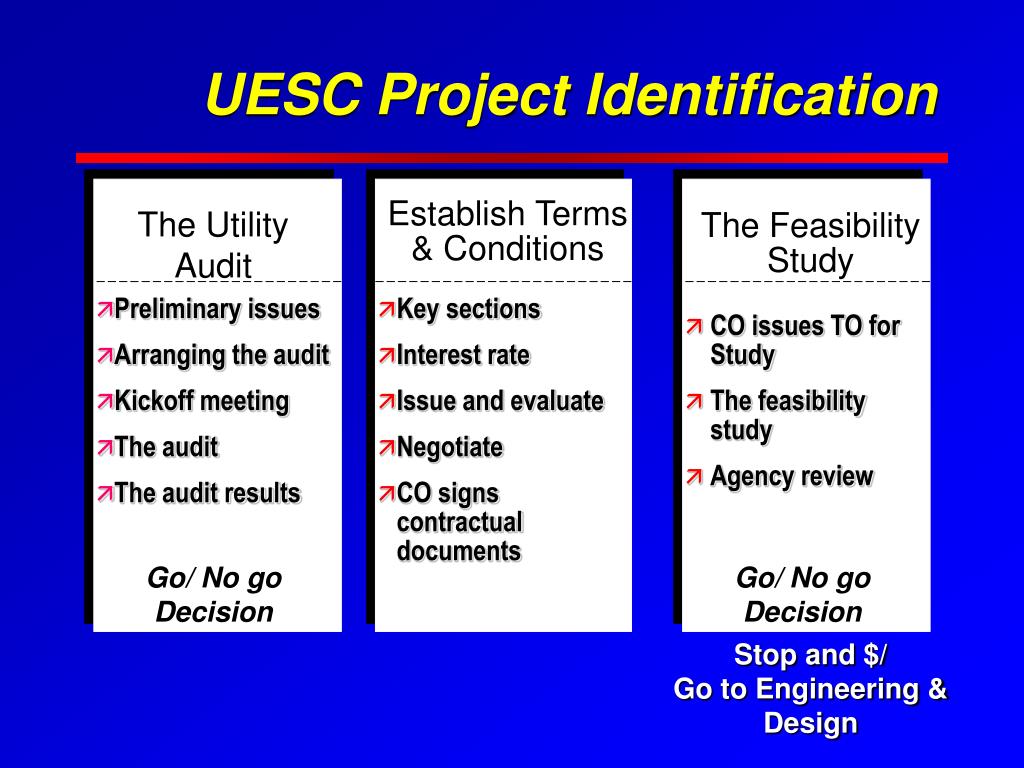

Uesc project identification
Download
1 / 54

UESC Project Identification - PowerPoint PPT Presentation


  • 123 Views
  • Uploaded on

UESC Project Identification. Establish Terms & Conditions. The Utility Audit. The Feasibility Study. Preliminary issues Arranging the audit Kickoff meeting The audit The audit results. Key sections Interest rate Issue and evaluate Negotiate CO signs contractual documents.

loader
I am the owner, or an agent authorized to act on behalf of the owner, of the copyrighted work described.
capcha
Download Presentation

PowerPoint Slideshow about 'UESC Project Identification' - royal


An Image/Link below is provided (as is) to download presentation

Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author.While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server.


- - - - - - - - - - - - - - - - - - - - - - - - - - E N D - - - - - - - - - - - - - - - - - - - - - - - - - -
Presentation Transcript
Uesc project identification
UESC Project Identification

Establish Terms & Conditions

The Utility Audit

The Feasibility Study

  • Preliminary issues

  • Arranging the audit

  • Kickoff meeting

  • The audit

  • The audit results

  • Key sections

  • Interest rate

  • Issue and evaluate

  • Negotiate

  • CO signs contractual documents

  • CO issues TO for Study

  • The feasibility study

  • Agency review

Go/ No go Decision

Go/ No go Decision

Stop and $/

Go to Engineering & Design

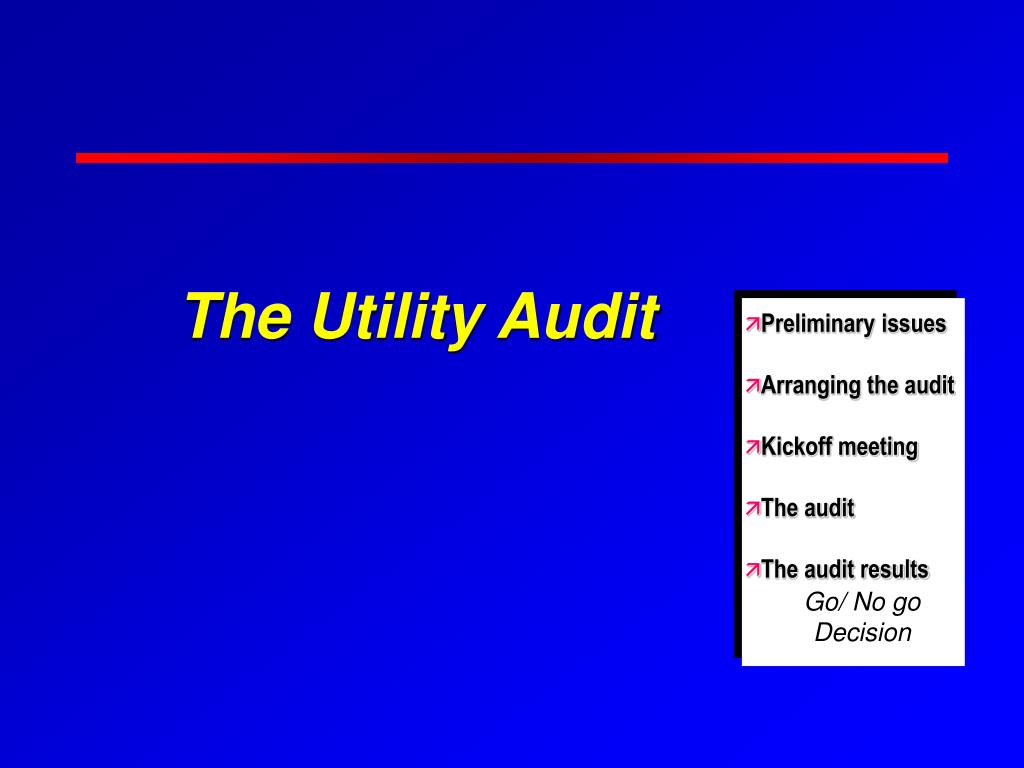

The utility audit

The Utility Audit

  • Preliminary issues

  • Arranging the audit

  • Kickoff meeting

  • The audit

  • The audit results

Go/ No go

Decision


Working the preliminary issues
Working the Preliminary Issues

  • Contact your utility to find out audit offers and any associated fees

  • Meet with your acquisition team and decision makers to establish concurrence


Arranging for the audit

App. 4

Arranging for the Audit

  • Contact your utility and request the audit

    • Provide some form of written documentation that says whether or not the service is for free or fee

    • Designate your agencies COTR

  • Schedule a kick-off meeting with the utility and key acquisition team players


Hosting your audit kick off meeting
Hosting Your Audit Kick-off Meeting

  • Establish your project expectations

  • Hand over your collected facility data

  • Share the outcomes of the acquisition strategy development

    • Make site specific needs & constraints clear

    • Answer all questions completely

  • Arrange a tour of the facility (notify your tenants)


The partnership begins here
The Partnership Begins Here

  • Remember: This is not traditional contracting! Success depends on open communication.

  • By minimizing utility’s costs you maximize government’s value.

  • Consider a formal partnering session


The audit
The Audit

  • Utility collects and reviews utility bills, purchased fuels data and metered data

    • Evaluation of utility rate schedule options

  • Utility performs a site visit to look at:

    • the operation and use of buildings, building envelope and systems

      • O&M procedures, insulation of pipes and tanks

    • all energy consuming equipment

      • Lighting, heating and cooling, motors, hot water

    • the utility systems


The audit results
The Audit Results

  • Utility provides report that:

    • documents existing equipment

    • describes recommended ECMs

    • offers a preliminary estimate of savings

    • establishes baseline conditions

    • offers technical recommendations

    • estimates payback periods


Note the audit is an estimate
Note: the Audit is an Estimate!

  • Don’t expect “a bulls eye”, it’s the first approximation of the project

  • Use this as an opportunity to evaluate the utility’s technical ability and compatibility

  • It’s all negotiable (technical and price) until the contract is signed


Evaluating the audit

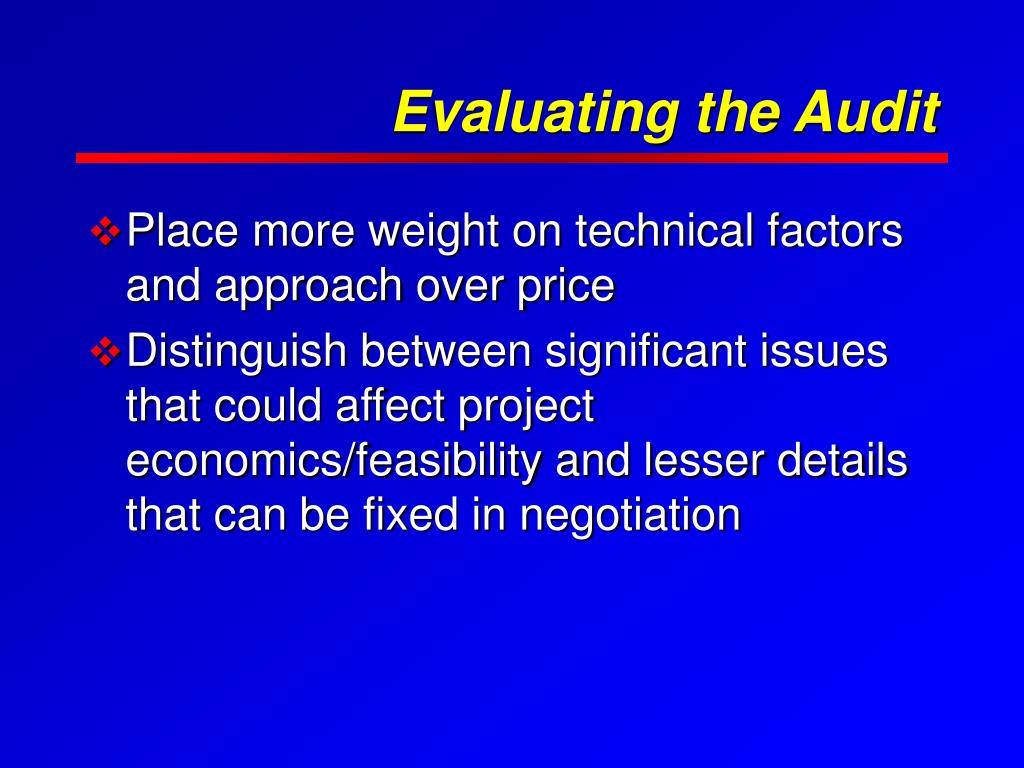

Evaluating the Audit

  • Place more weight on technical factors and approach over price

  • Distinguish between significant issues that could affect project economics/feasibility and lesser details that can be fixed in negotiation


Focus the evaluation
Focus the Evaluation

  • Is the ECM package reasonable and does it provide solutions to site problems?

  • Are estimates of energy and O&M savings reasonable?

  • Are assumptions, analyses and calculations clear and credible?

    • ECM costs, simple payback, energy and cost savings


Keep the evaluation focus
Keep The Evaluation Focus

  • Were requested items included?

  • Are you comfortable with what you see?

  • Do you think this is a good fit for your continued partnership?


Make the go no go decision
Make the Go/ No Go Decision

  • You make the call

    • Will you say thank you and go separate ways?

    • Will you ask for revisions?

    • Will you approve the audit and move forward?

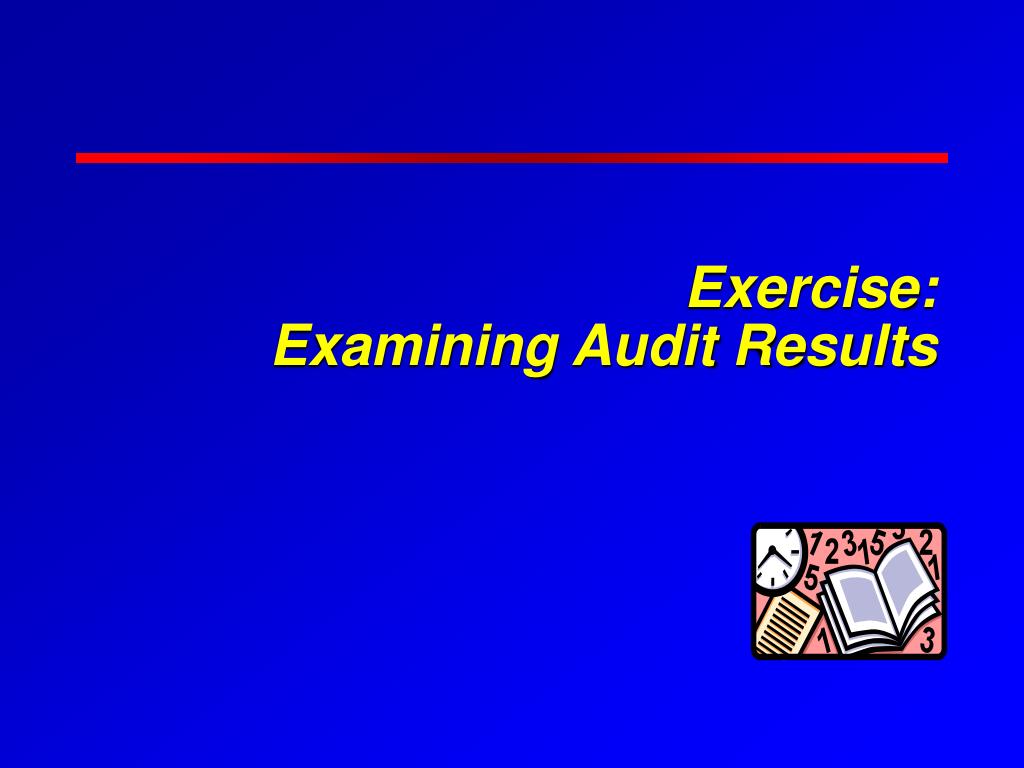

Exercise examining audit results

Exercise: Examining Audit Results


Establish contract terms and conditions

Establish Contract Terms and Conditions

  • Incorporating terms and conditions

  • Interest rate

  • Issue and evaluate

  • Negotiate

  • CO signs contractual documents


Uesc vehicles

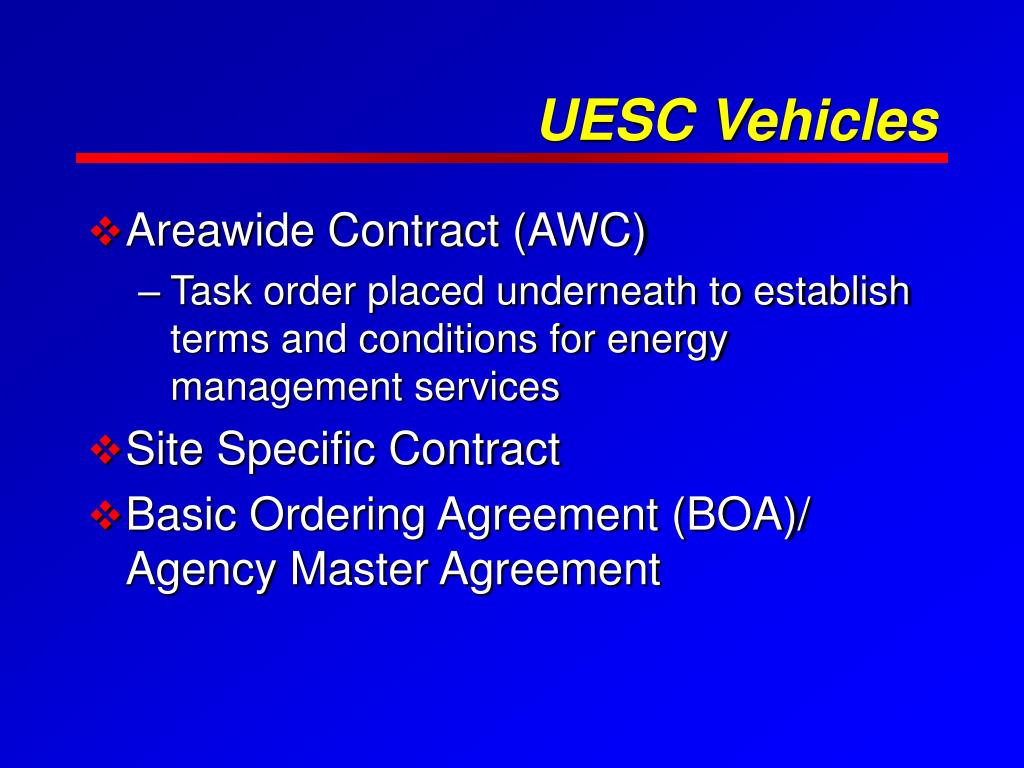

UESC Vehicles

  • Areawide Contract (AWC)

    • Task order placed underneath to establish terms and conditions for energy management services

  • Site Specific Contract

  • Basic Ordering Agreement (BOA)/ Agency Master Agreement


Gsa areawide users manual

App. 3

GSA Areawide Users Manual


Construction and service contracts

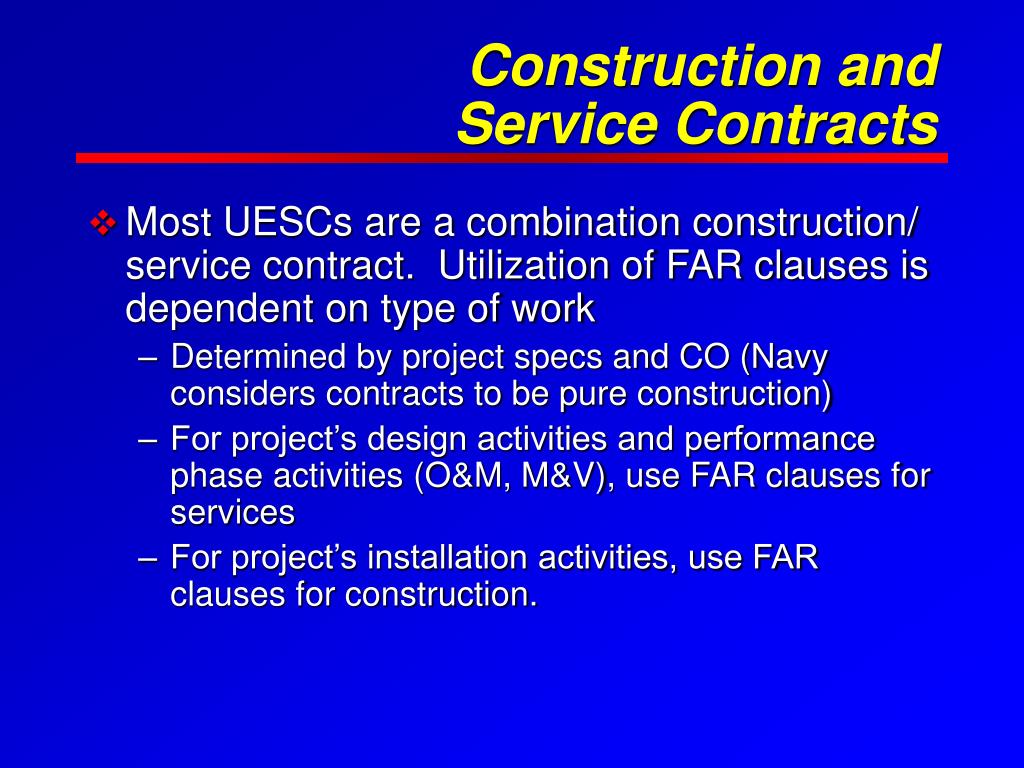

Construction and Service Contracts

  • Most UESCs are a combination construction/ service contract. Utilization of FAR clauses is dependent on type of work

    • Determined by project specs and CO (Navy considers contracts to be pure construction)

    • For project’s design activities and performance phase activities (O&M, M&V), use FAR clauses for services

    • For project’s installation activities, use FAR clauses for construction.


Construction and service contracts1
Construction and Service Contracts

  • Wages and rates

    • Davis Bacon rates for construction, Services Contract Act rates for services

  • Warranty

    • FAR 52.246-20 for construction, FAR 52.246-21 for services

  • Payment and performance bonds

    • Requirements determined by CO, utility letter of credit is low cost option

    • FAR 28.102 or 52.228-15 for construction, FAR 28.103 or 52.228-16 for services


Incorporate your terms and conditions

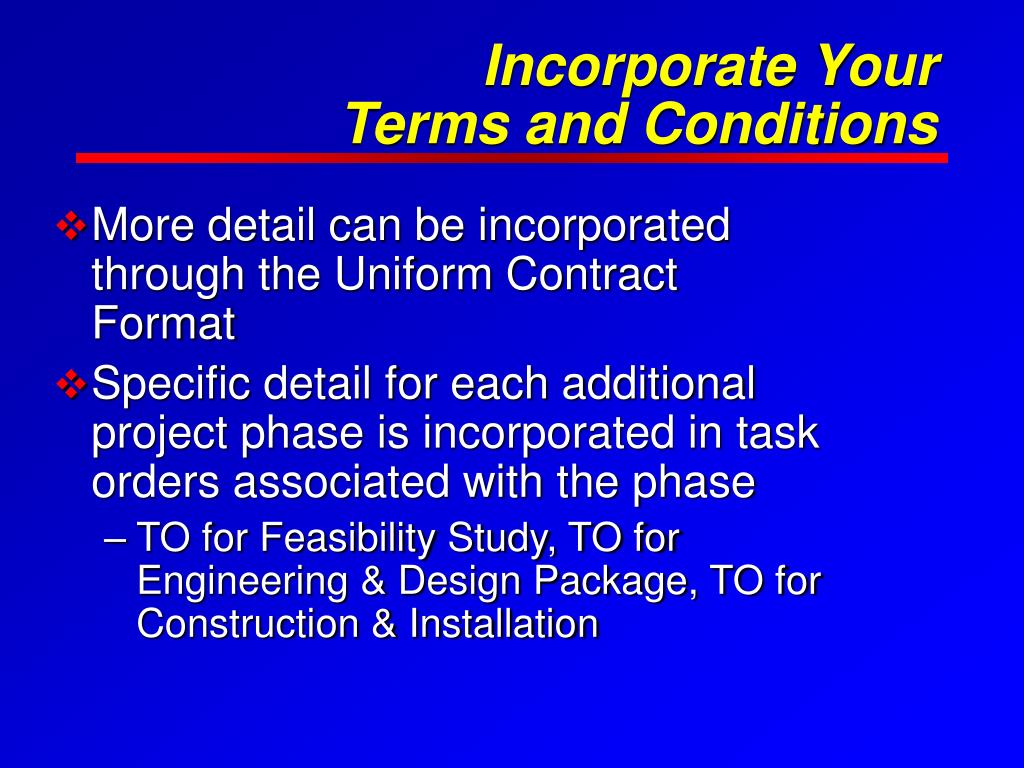

Incorporate Your Terms and Conditions

  • More detail can be incorporated through the Uniform Contract Format

  • Specific detail for each additional project phase is incorporated in task orders associated with the phase

    • TO for Feasibility Study, TO for Engineering & Design Package, TO for Construction & Installation


Uniform contract format
Uniform Contract Format

  • Part I: The Schedule

  • Part II: Contract Clauses

  • Part III: List of Documents, Exhibits, and Other Attachments

  • Part IV: Representations and Instructions


Section b supplies or services and prices cost
Section B: Supplies or Services and Prices/Cost

  • Required supplies and services

  • Total price (minimum/maximum)

  • Ordering

  • Utility margins


Section c descriptions specs work statement

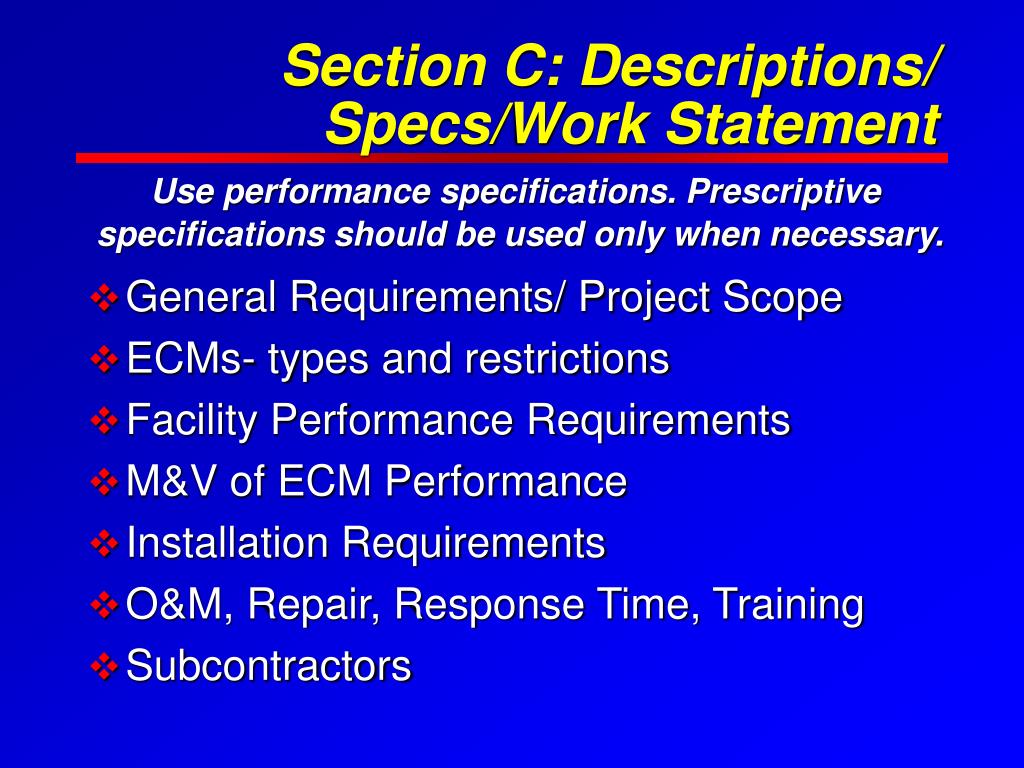

Section C: Descriptions/ Specs/Work Statement

Use performance specifications. Prescriptive

specifications should be used only when necessary.

  • General Requirements/ Project Scope

  • ECMs- types and restrictions

  • Facility Performance Requirements

  • M&V of ECM Performance

  • Installation Requirements

  • O&M, Repair, Response Time, Training

  • Subcontractors


Section e inspection and acceptance
Section E: Inspection and Acceptance

  • Inspection requirements

  • Acceptance requirements

  • Warranty of service


Section f deliveries or performance
Section F: Deliveries or Performance

  • Period of performance

  • Principal place of performance

  • Deliverables


Section g contract administration data
Section G: Contract Administration Data

  • Invoicing Instructions

  • Invoice submittals for TO projects


Section h special contract requirements
Section H: Special Contract Requirements

  • Wage determination

  • Title and ownership of equipment:

    • Government decides who retains title during the contract term (taxes, subsidies and interest are impacted)

  • Payment and performance bond requirements

    • Performance bonds on typical construction contract carry a penal sum of 100% of the price of implementation phase.

    • Payment bonds carry a penal sum of 40% if the project is 1-5 million dollars


Section h special contract requirements1
Section H: Special Contract Requirements

  • Financier protection

    • Assignment of claims (direct finance payment to financier)

    • Notification to government of problems

  • Buy-down provisions

    • Index formula vs. fixed schedule

    • decide to either decrease the payment or reduce the term


Loan amortization schedule
Loan Amortization Schedule

  • Termination for convenience (FAR 52.249-2)

  • Required by financiers

  • Mutually agreed upon by agency, utility and financier

  • Buy-out options:

    • Add lender fees to capital portion of termination schedule

    • Increase the interest rate to accommodate risk

    • Leave it open to be agreed upon at time of buy-out

    • Indexed formula (recommended)

Termination contracts- FAR 49, FAR 52.217-2


Section i contract clauses section j list of attachments
Section I: Contract Clauses Section J: List of Attachments

  • I: Clauses incorporated by reference

  • J: Definition of terms applicable to contract, Required schedules


Section l instructions conditions notice to offerors
Section L: Instructions, Conditions & Notice to Offerors

  • For each ECM in technical proposal, specify

    • Description and purpose

    • Current status

    • Implementation costs, rebates,

    • Annual energy and O&M costs (may not offer O&M)

    • Life-cycle cost analysis

    • Commissioning plan (Commission guide on FEMP web site)

    • M&V (if requested)

    • Guaranteed savings, if requested (Not offered by all utilities)


Section l instructions conditions notice to offerors1
Section L: Instructions, Conditions & Notice to Offerors

  • Requirements for price proposal

    • Specify cost reasonableness verification method

      • Explanation of equipment choices

      • Number of vendor quotes for generic equipment

      • Competition for subcontractors


Section m proposal evaluation factors

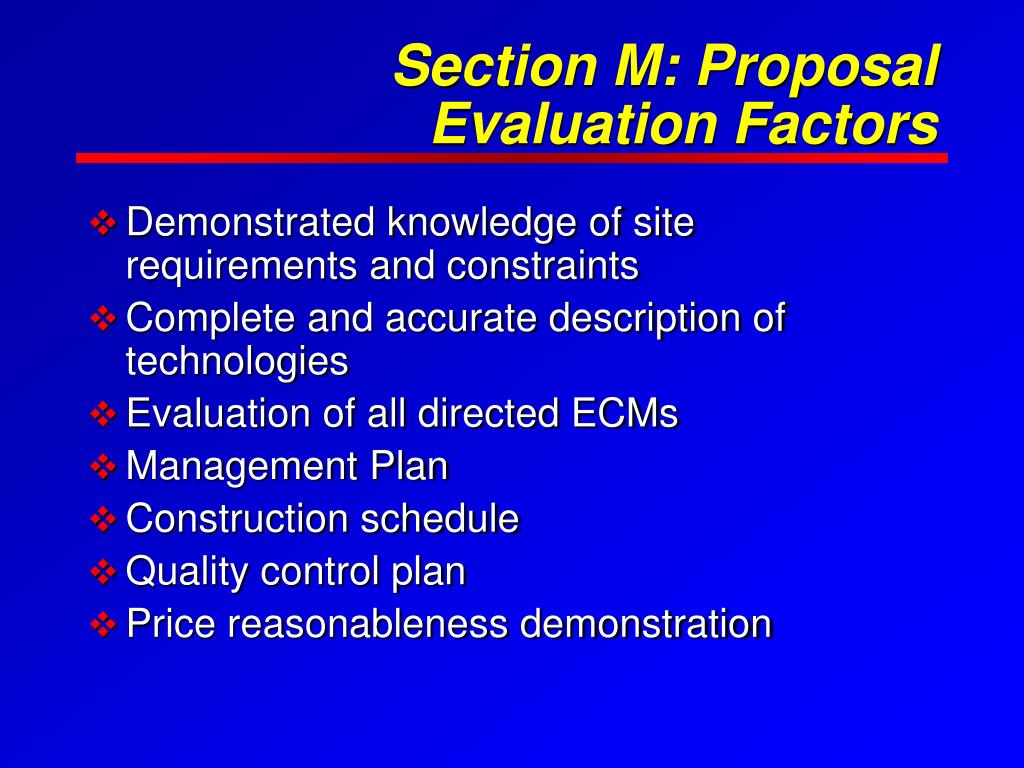

Section M: Proposal Evaluation Factors

  • Demonstrated knowledge of site requirements and constraints

  • Complete and accurate description of technologies

  • Evaluation of all directed ECMs

  • Management Plan

  • Construction schedule

  • Quality control plan

  • Price reasonableness demonstration


Optional elements that impact interest rate
Optional Elements that Impact Interest Rate

  • Cost savings guarantee

    • is more risky to financier, could add up to 2-3%

  • Performance guarantee:

    • provides energy savings incentive to utility

  • Level of M&V

  • Responsibility for O&M


10 ways to lower financing costs

App. 5

10 Ways to Lower Financing Costs

  • Time is money– don’t delay

  • Learn about financing

  • Use standard terms and conditions

  • Negotiate prepayment formula

  • Include assignment of claims

  • Ask for appropriate M&V

  • Don’t buy a rate lock

  • Bundle ECMs

  • Annual instead of monthly payments

  • Compare rates


Contractual documents
Contractual Documents

  • Your contracting documents are determined by agency procedure

  • Reach agreement with utility

  • Utility signs, agency CO signs and project proceeds


The feasibility study

The Feasibility Study

  • Issue Task Order for Study

  • The feasibility study

  • Agency review

Go/

No go Decision

Stop and $


Feasibility study
Feasibility Study

  • Definition: an investment-grade review of the site’s condition & potential efficiency improvements, and a detailed assessment of both the technical and economic viability of the proposed ECMs.


What the feasibility study should include

App. 4

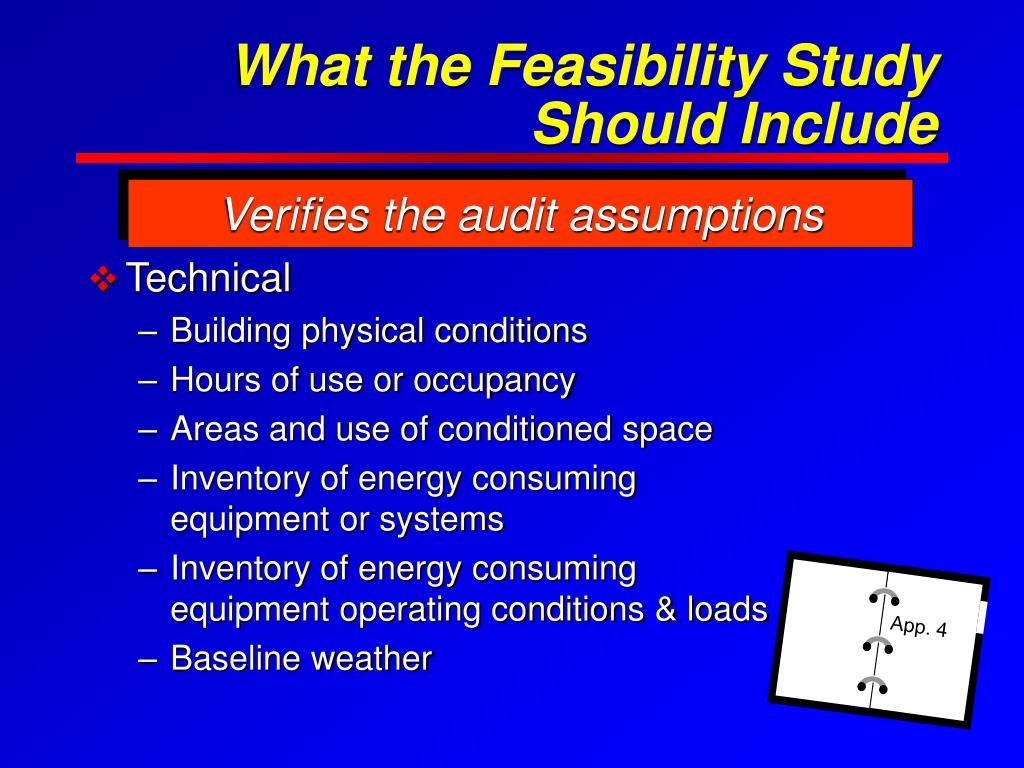

What the Feasibility Study Should Include

Verifies the audit assumptions

  • Technical

    • Building physical conditions

    • Hours of use or occupancy

    • Areas and use of conditioned space

    • Inventory of energy consuming equipment or systems

    • Inventory of energy consuming equipment operating conditions & loads

    • Baseline weather


What the feasibility study should include1
What the Feasibility Study Should Include

  • For price

    • Estimated annual operating cost

    • Project cost by ECM

    • Estimated annual cost savings by ECM

    • Unit cost by major components and systems

    • LCC analysis

    • Breakdown of implementation cost and estimate of annual energy savings


What the feasibility study should include2
What the Feasibility Study Should Include

  • Other

    • O&M plan

    • M&V plan

    • Guaranteed performance/savings

Ensure that individual ECM schedules

don’t interfere with mission activities


What to look for when evaluating the study
What to Look for When Evaluating the Study

  • Inclusion of all required ECMs

  • Reasonable savings for each ECM

  • Reasonable baseline

  • Reasonable assumptions and interaction of multiple ECMs

  • Inclusion of ECMs for water and renewables


More things to look for when evaluating the study
More Things to Look For When Evaluating the Study

  • Fuel neutrality

  • Price reasonableness

  • Reasonable financing rate

  • Savings that exceed payments

  • Reasonable term

  • Recognition of site-specific issues

  • Consideration of environmental benefits


The economic review of the feasibility study
The Economic Review of the Feasibility Study

  • Check to see if the utility looked at the rate schedule when calculating savings

  • Analyze the project implementation costs

    • Use cost estimating handbooks and past experience to compare

    • Consider level of competition among subcontractors

  • Examine adders: project management, hourly rate, OH and profit (both % and basis), taxes

  • Consider early ECM payoffs and financial impacts


Take a look at the estimate of energy and cost savings
Take a Look at the Estimate of Energy and Cost Savings

  • ECM baseline consistent with requirements

  • Acceptable ECM assumptions

    • Operating hours

    • Weather data

  • Acceptable variance between audit and final figure in feasibility study

  • Compare with an independent estimate and check the savings calculations


Evaluating optional items
Evaluating Optional Items

  • Does what you see comply with the levels you asked for?

  • Will O&M be conducted by in-house staff or through the utility’s subcontractor

    • O&M handled by someone other than the utility will require a performance guarantee

    • do you still want it?

  • M&V cost benefit analysis

    • the FEMP M&V Guidelines provide information on available options


Why m v
Why M&V

  • The Guidelines are grouped into four categories or options (A, B, C, & D).

    • Each option is a generic approach to measurement and verification of energy and water projects

    • The options address accuracy and risk allocation


Option a engineering calculations
Option A – Engineering Calculations

  • A stipulated approach which may include measured values at the retrofit

  • Example: Lighting retrofits

    • Based on calculated energy savings and time of use schedules or light loggers


Option b metering and monitoring
Option B – Metering and Monitoring

  • A measurement approach which may include spot, short term or continuous measurement at the retrofit

  • Example: Variable Speed Drives

    • Based on actual, measured motor speed and corresponding monitored run time


Option c utility meter billing analysis
Option C – Utility Meter Billing Analysis

  • An approach which studies the overall energy use through utility billing data analysis

    • Derived from long term, whole-building, facility or sub-metered data analysis

  • Example: Building Envelope

    • Used when the conserving measures cannot be measured directly.

    • Used when the anticipated energy savings is at least 20% of the total metered energy use.


Option d computer simulation
Option D – Computer Simulation

  • A computer simulation modeling at the retrofit or the building level

  • Example: New Construction

    • Based on a comparison of the building energy use without energy and water measures less the energy use with conserving measures installed


M v plan key elements
M&V PlanKey Elements

  • Clarify the objectives

  • Determine the baseline approach

    • Consider the building characteristics, intended measures and interaction between measures

  • Specify the option to be used for each measure

    • Identify methods and procedures of data gathering and analysis for each measure

  • Indicate the reporting format and schedule

  • Identify budget impacts and resource requirements


M&V Results

ECMs installed here

Baseline

Baselineor adjusted baseline

Avoided use or savings

Energy Usage

Measured or calculated performance

Time


Make the go no go decision1
Make the Go/No Go Decision

  • You make the call

    • Will you say thank you and go separate ways?

    • Will you approve or modify the feasibility study and issue a TO for the next step?

  • If you opt out here, you pay the fee established in the task order


ad
