  1. Quarterly Progress Report Staff Updating & Review meeting Netherlands Leprosy Relief, India DHANBAD, 7-8 July 2010 Presented by Dr.H.C.Pandey ILEP State Co-ordinator,U.P. Lucknow.

  2. Gantt. Chart showingQuarterly Progress Report

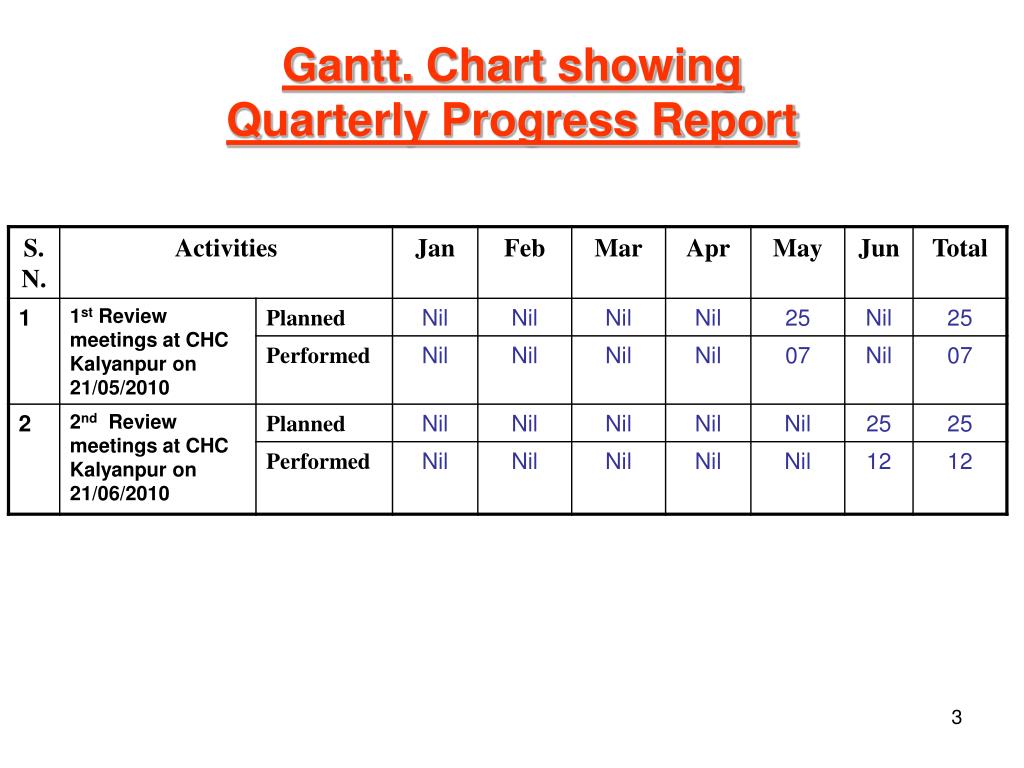

  3. Gantt. Chart showingQuarterly Progress Report

  4. Activities Completion Report 20101st & 2nd Quarter

  5. Half Day Sensitization of ANMs at CHC Nawabganj Unnao on 23rd March 2010

  6. Half Day Sensitization of ANMs at CHC Bighapur Unnao on 05th April 2010

  7. Activities Completion Report 20101st & 2nd Quarter

  8. Half day Sensitization of ASHAs at CHC Saurik Kannauj on 15th May 2010.

  9. Half day Sensitization of ASHAs at CHC Chhibramau Kannauj on 04th June 2010.

  10. Activities Completion Report 20101st & 2nd Quarter

  11. 02 days Self Care training cum Practice workshop at CHC Bilgram Hardoi On 29th June 2010

  12. 02 days Self Care training cum Practice workshop at CHC Bilgram Hardoi On 30th June 2010 Footprints taken by GHC Staff.

  13. NLR Activities performed All three NLR activities for 2010 have been completed. • Half day Sensitization workshop of ANMs at Distt. Unnao( Batches :- 09 ) • Half day Sensitization workshop of ASHAs at Distt. Kannauj ( Batches :- 07) • 02 days POD & Self Care in villages workshop 1) At CHC Kalyanpur Kanpur Nagar ( Batch :- 01) 2) At CHC Bilgram at Hardoi ( Batch :- 01) 4) 1st Review meeting at CHC Kalyanpur on 21/05/2010. 5) 2nd Review meeting at CHC Kalyanpur on 21/06/2010.

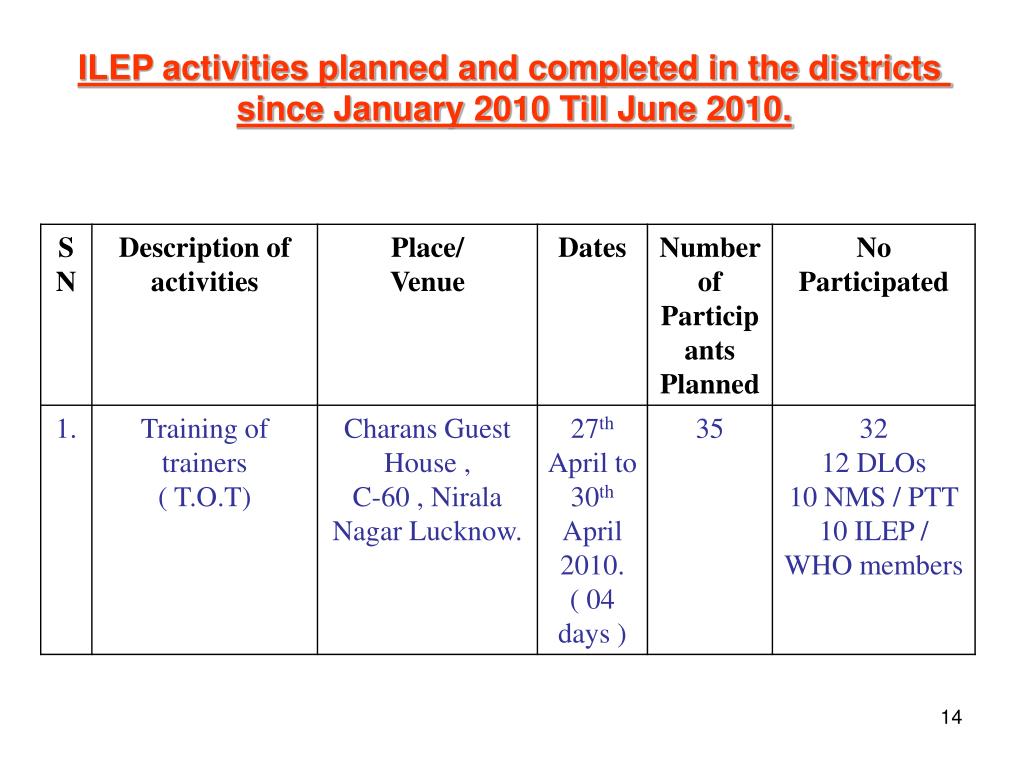

  14. ILEP activities planned and completed in the districts since January 2010 Till June 2010.

  15. Comments Difficulties faced ½ day Sensitization workshop of ANMs :- At District Unnao. 1) No notable problem faced during Sensitization of ANMs except :- • For Sensitization workshop at CHC Bichhia 04 dates were given & only on 4th date workshop could be completed. • At PHC Sumerpur & CHC Bangarmau ANMs went on coming even after 01 hour start of the workshop. Rest no problem Expectations from District/State/NLR 1) DLO /DN has promised that above problems will not be faced in future.

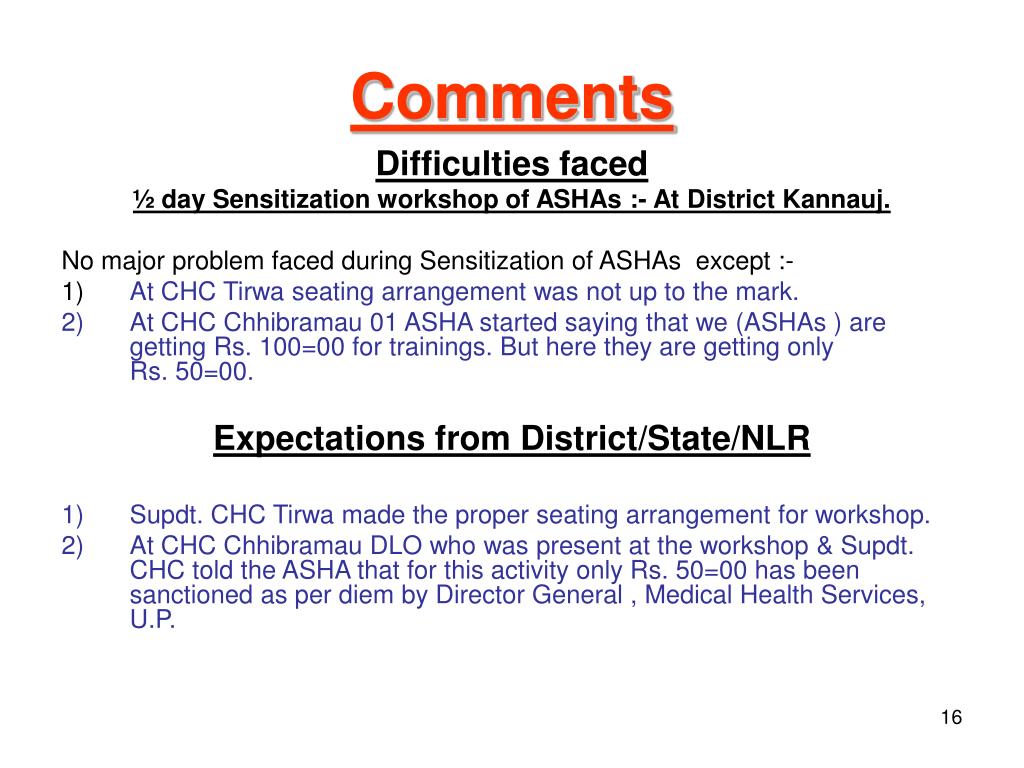

  16. Comments Difficulties faced ½ day Sensitization workshop of ASHAs :- At District Kannauj. No major problem faced during Sensitization of ASHAs except :- 1) At CHC Tirwa seating arrangement was not up to the mark. 2) At CHC Chhibramau 01 ASHA started saying that we (ASHAs ) are getting Rs. 100=00 for trainings. But here they are getting only Rs. 50=00. Expectations from District/State/NLR • Supdt. CHC Tirwa made the proper seating arrangement for workshop. • At CHC Chhibramau DLO who was present at the workshop & Supdt. CHC told the ASHA that for this activity only Rs. 50=00 has been sanctioned as per diem by Director General , Medical Health Services, U.P.

  17. Comments Difficulties faced 02 days POD & Self Care in villages workshop At CHC Kalyanpur, Kanpunagar :- • Accommodation for the workshop was insufficient. At CHC Bilgram Hardoi :- No Problem faced. Expectations from District/State/NLR • DLO Kanpur Nagar & Supdt. CHC Kalyanpur has promised for selection of big room for such activities in future.

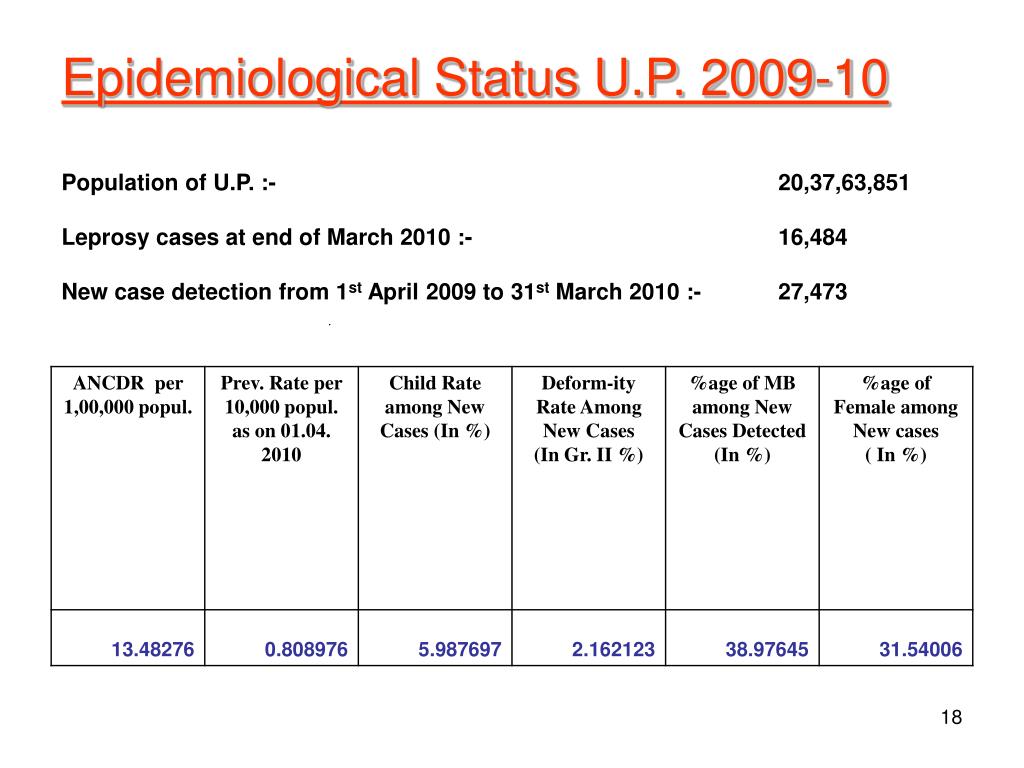

  18. Epidemiological Status U.P. 2009-10Population of U.P. :- 20,37,63,851Leprosy cases at end of March 2010 :- 16,484 New case detection from 1st April 2009 to 31st March 2010 :- 27,473

  19. NLEP- Monthly Reporting Form Uttar Pradesh State Report

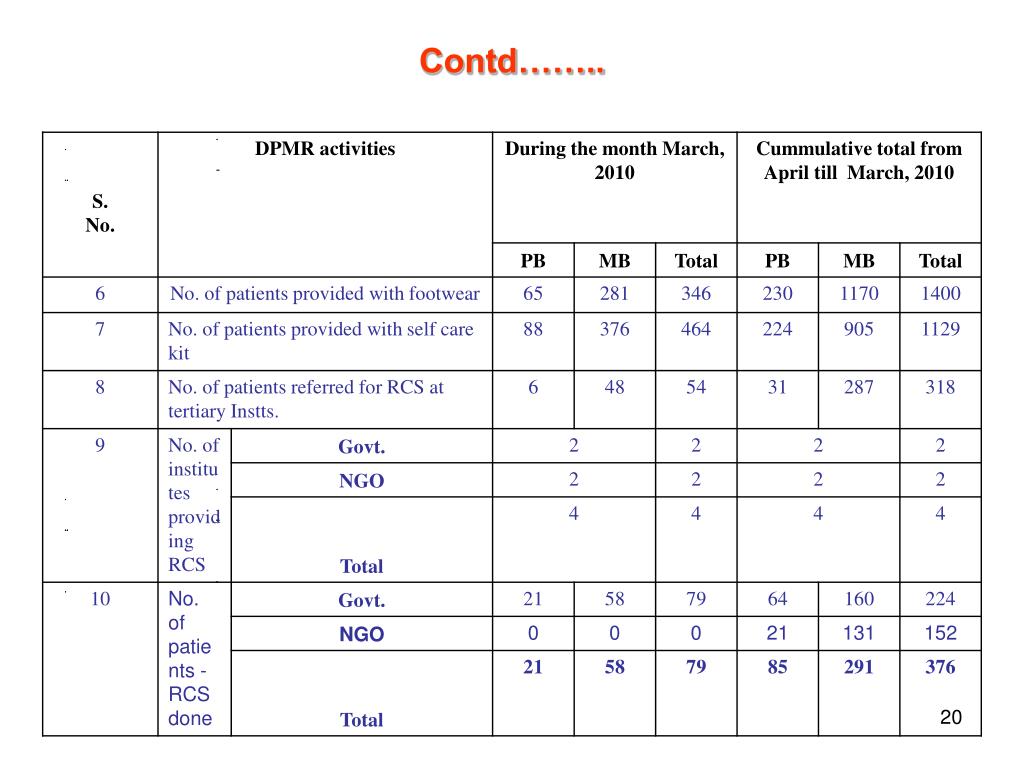

  20. Contd……..

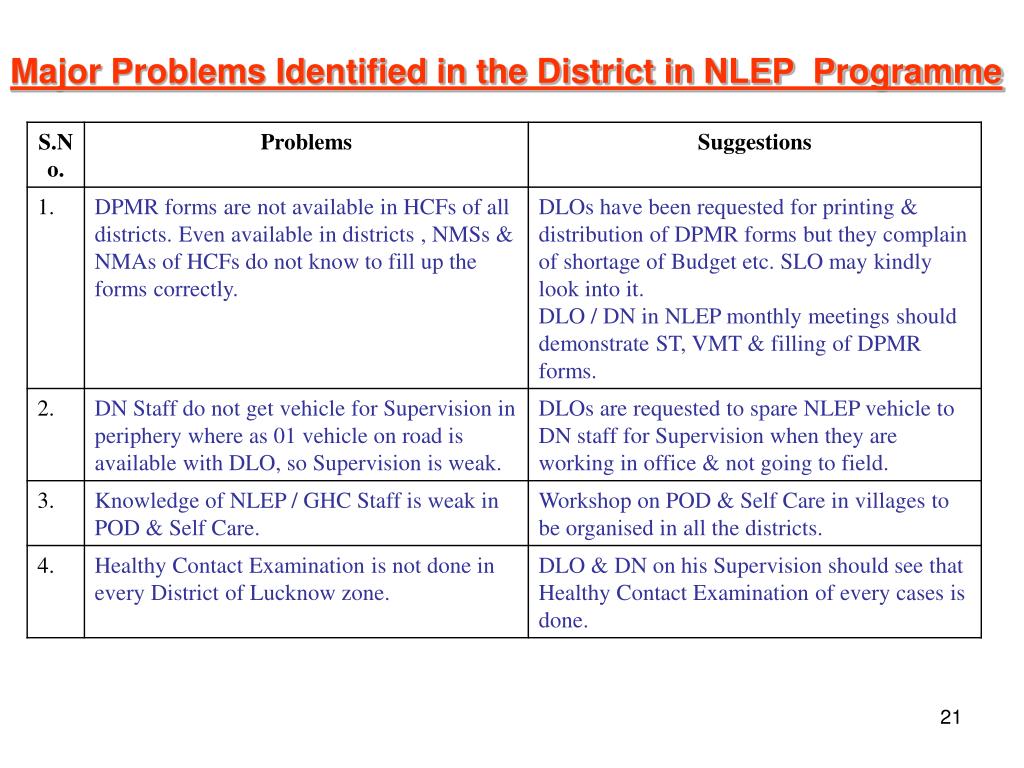

  21. Major Problems Identified in the District in NLEP Programme

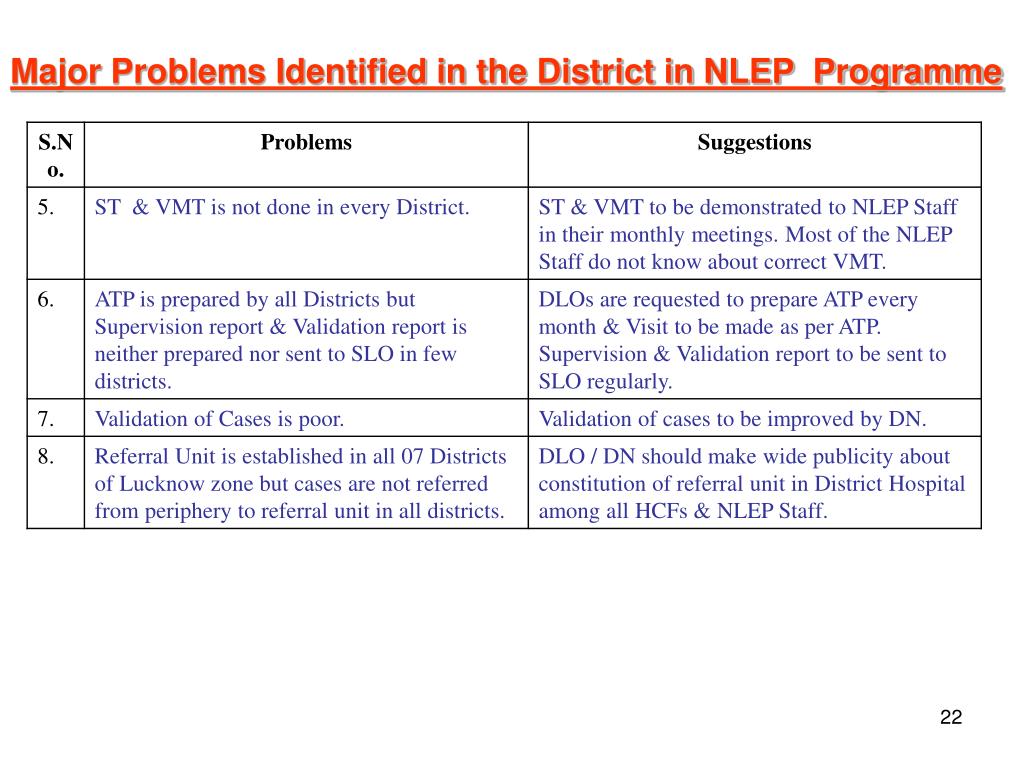

  22. Major Problems Identified in the District in NLEP Programme

  23. Feed Back on ½ day Sensitization of ANMs & ASHAs. ANMs :- ANMs were trained in District Unnao. • ANMs referral of Leprosy case is negligible only 04 cases are referred & confirmed from total district till June 2010. • Training was performed in May & June 2010. ASHAs :- ASHAs were trained in District Kannauj. • In Last weak of April :- 01 batch ( 60) rest May & June 2010. • After training cases by ASHAs are referred & confirmed in no. of 02 to 03 cases from each CHCs / PHCs. • Leprosy Cases recorded are mostly referred by ASHAs.

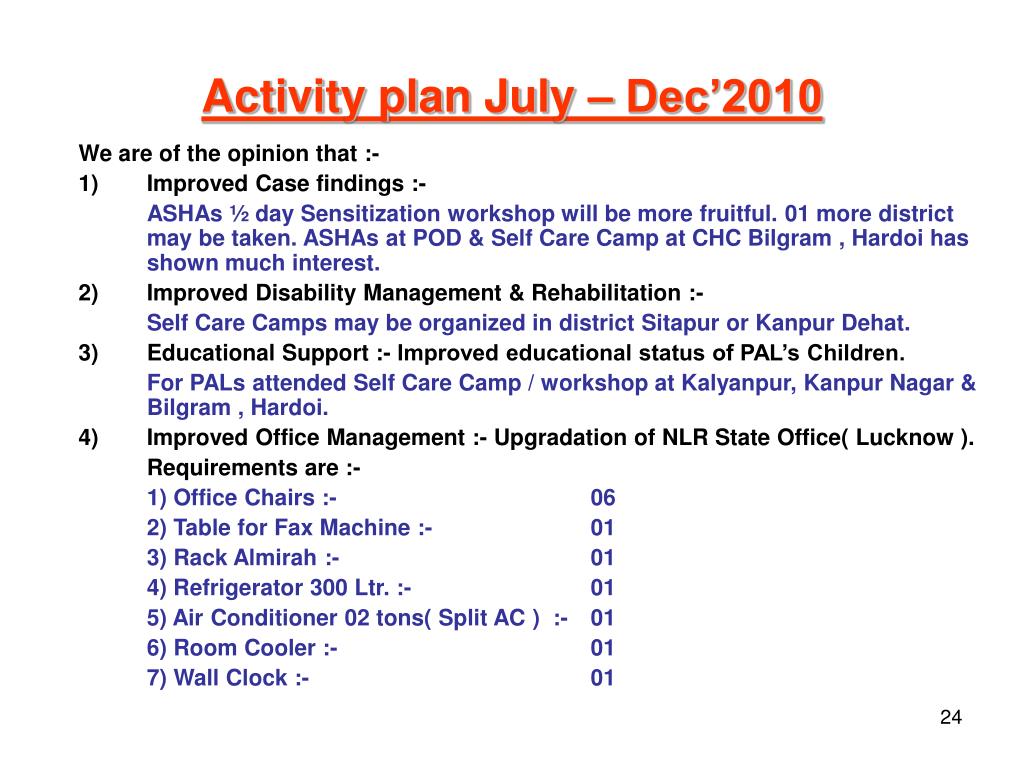

  24. Activity plan July – Dec’2010 We are of the opinion that :- 1) Improved Case findings :- ASHAs ½ day Sensitization workshop will be more fruitful. 01 more district may be taken. ASHAs at POD & Self Care Camp at CHC Bilgram , Hardoi has shown much interest. 2) Improved Disability Management & Rehabilitation :- Self Care Camps may be organized in district Sitapur or Kanpur Dehat. • Educational Support :- Improved educational status of PAL’s Children. For PALs attended Self Care Camp / workshop at Kalyanpur, Kanpur Nagar & Bilgram , Hardoi. • Improved Office Management :- Upgradation of NLR State Office( Lucknow ). Requirements are :- 1) Office Chairs :- 06 2) Table for Fax Machine :- 01 3) Rack Almirah :- 01 4) Refrigerator 300 Ltr. :- 01 5) Air Conditioner 02 tons( Split AC ) :- 01 6) Room Cooler :- 01 7) Wall Clock :- 01

  25. Thank you all
