1 / 17

Uncertainty Based Scheduling: Energy-Efficient Ordering for Tasks with Variable Execution Time

Embedded Systems Design Laboratory. Lund Institute of Technology Sweden. Uncertainty Based Scheduling: Energy-Efficient Ordering for Tasks with Variable Execution Time. Flavius Gruian and Krzysztof Kuchcinski. Presentation Outline. Problem Set-up A Motivation Uncertainty Based Scheduling

reese-byers
Download Presentation

Uncertainty Based Scheduling: Energy-Efficient Ordering for Tasks with Variable Execution Time

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript

  1. Embedded Systems Design Laboratory Lund Institute of Technology Sweden Uncertainty Based Scheduling:Energy-Efficient OrderingforTasks with Variable Execution Time Flavius Gruian and Krzysztof Kuchcinski

  2. Presentation Outline • Problem Set-up • A Motivation • Uncertainty Based Scheduling • Experiments • comparison to FullSearch • measurements on EVB80200 platform • Summary & Conclusions ISLPED 2003 --- Uncertainty Based Scheduling…

  3. Problem Set-up • tasks: period=deadline, variable execution • off-line (static) ordering but • run-time speed selection • speed for the kth task • energy for a period(clock energy e(s)=Ks) • average energy ISLPED 2003 --- Uncertainty Based Scheduling…

  4. A Motivational Example Task Set: 3 tasks, uniform distribution (BCE,WCE) = {t1:(12,20),t2:(10,30),t3:(24,40)}A = 100, K=1, fref=1, b=2 ISLPED 2003 --- Uncertainty Based Scheduling…

  5. UBS in a Nutshell • Main ideas: • achieve a low speed ASAP by ordering tasks wisely • approximate by • Priority: • Observations: • prioritize short tasks • prioritize tasks with large variation in execution • prioritize power efficient tasks • algorithmic complexity O(N2) for ordering N tasks ISLPED 2003 --- Uncertainty Based Scheduling…

  6. UBS vs. Full Search • 300 sets of each size(3,4,5,6 tasks) • used the “real” E formula (4) • under 2% difference ISLPED 2003 --- Uncertainty Based Scheduling…

  7. The Test Platform: EVB80200 • Intel i80200 (XScale) • MAX1855 voltage regulator • 32MB SDRAM, 4MB Flash • RS232, JTAG, 7segLED ISLPED 2003 --- Uncertainty Based Scheduling…

  8. UBS example on i80200: m6 • 6 tasks • 2 LZ (K=770mW) • 2 QS (K=840mW) • 2 FOR (K=800mW) • max speed time 49ms • variation 17ms • runtime rescheduling after every 5 x H ISLPED 2003 --- Uncertainty Based Scheduling…

  9. More Experimental Results: m6 ISLPED 2003 --- Uncertainty Based Scheduling…

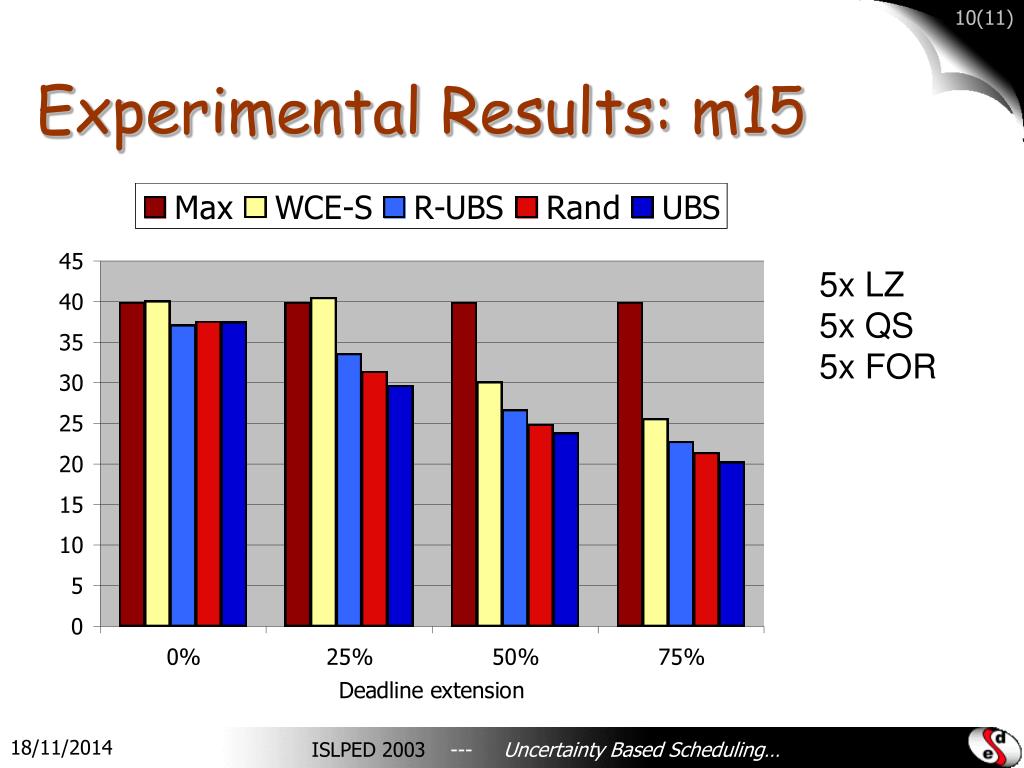

  10. Experimental Results: m15 5x LZ 5x QS 5x FOR ISLPED 2003 --- Uncertainty Based Scheduling…

  11. Summary & Conclusions • use more information to derive better methods • UBS: runtime, non-intrusive ordering for tasks with variable execution time • measurements on • a real platform: EVB80200 • realistic tasks: Lempel-Ziv codec & Quicksort • execution order matters! • random reordering: OK • UBS strategy: BEST ISLPED 2003 --- Uncertainty Based Scheduling…

  12. Thank You! ISLPED 2003 --- Uncertainty Based Scheduling…

  13. Measuring the core Power ISLPED 2003 --- Uncertainty Based Scheduling…

  14. i80200 I/O Power ISLPED 2003 --- Uncertainty Based Scheduling…

  15. i80200 Core Power ISLPED 2003 --- Uncertainty Based Scheduling…

  16. UBO extension to EDF • Use preemption to extract regions • Push forward uncertain regions • Algorithm: • Start from the latest deadline • Between two consecutive deadlines order the regions according to the already given priorities • Preempt the task which does not fit entirely • Proceed with the next consecutive deadlines ISLPED 2003 --- Uncertainty Based Scheduling…

  17. T=16 WCE=10 D=15 Task 1 mean=9 WCE=6 Task 2 m=3 D=16 10 6 Classic EDF Preemption for Reduced Energy 5 + 10 1 Reordering In the long run: 18% less energy than for the classic EDF! An Example of UBO EDF ISLPED 2003 --- Uncertainty Based Scheduling…
