18. December 2006

Banedanmark Draft Signalling implementation plan. 18. December 2006. Banedanmark Railway Network. Capacity, performance, obsolescence and economic requirements are the key drivers to determine asset replacement strategy . Interlocking asset type. Remaining life key drivers.

presley
Download Presentation

18. December 2006

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. Banedanmark Draft Signalling implementation plan 18. December 2006

  2. Banedanmark Railway Network

  3. Capacity, performance, obsolescence and economic requirements are the key drivers to determine asset replacement strategy Interlocking asset type Remaining life key drivers Spares shortage and re-servicing capability Electro mechanical Relay based Ability to modify for future capacity needs and supply chain management Semi computer based e.g. 1977 DSB Spares and know how which make renewal challenging Spares and know how which make renewal challenging 1. gen. computer based e.g. 1990 DSB Source: Booz Allen Hamilton analysis

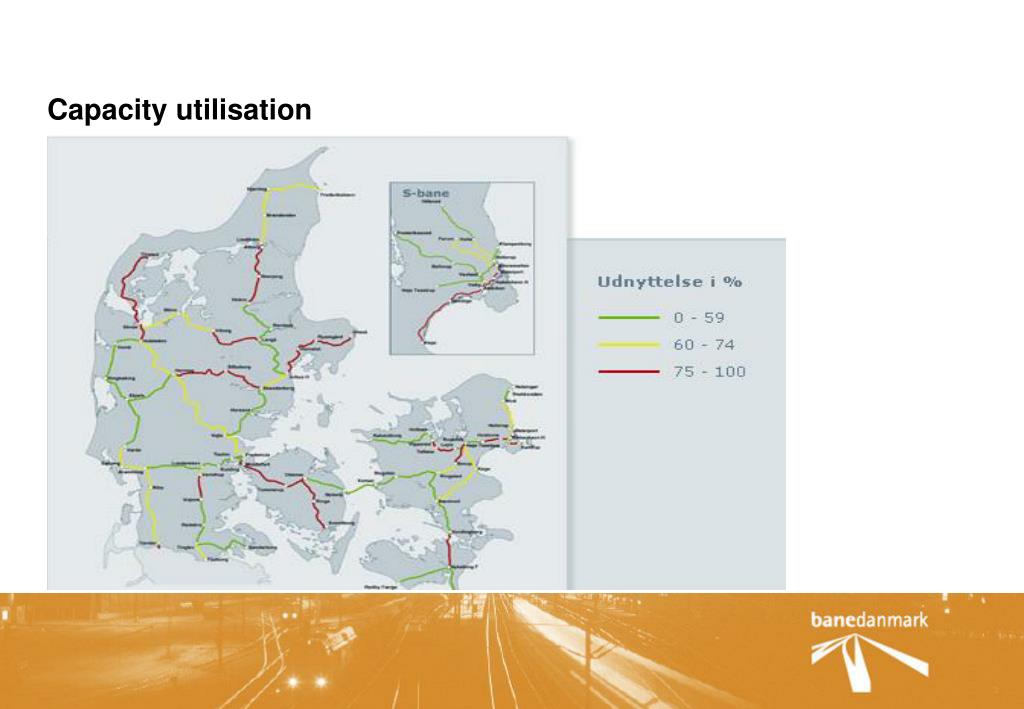

  4. Capacity utilisation

  5. Age of Interlockings and Lineblock

  6. Danish assets are quite old… • Following a ”natural” renewal scheme almost 46 % of all Interlockings and Lineblocks would be renewed before 2015. • These calculations are based on expected high Service life for existing Relay based Interlockings (55 ys.), • and in fact optimistic Service lifes for existing electronic IL’s(35 years for EBILOCK 850 & SICAS S5..) • This fact is a key driver for the business case

  7. And Danish ATP is also ageing • ZUB123 was developed from 1987-1990, based on ZUB100 from Siemens. Part of the hardware dates back to the late 70’ties. Service life ends 2011(Contract for 25 years). • Life extension programme(20 % reinvestment) for the ATC Infrastructure side will be undertaken 2007-11, and is estimated to prolong Service life until 2020, at which point the system must be renewed. Most onboard systems can live until 2020 with small scale life extension. • Very few people support hardware as well as software of this type today, and the specific development platform and software is essentially only supported by 1 or 2 engineers at Siemens. • ZUB 100 product line is no longer supported by Siemens Braunschweig

  8. What is ERTMS? • Common Interoperable European specification managed by the European Railway Agency, and supported by products from 6 major signalling manufacturers • Mandatory for new lines and larger reinvestment in signalling and train control on the operationally integrated European Railway Network (~All DK lines excluding S-bane) • Current baseline is SRS 2.3.0, Next baseline (3.0.0) is planned for 2010/11, including a number of essential functions for conventional lines. • Installed on more than 6.000 km of lines today, expected 18.000 km in 2008.

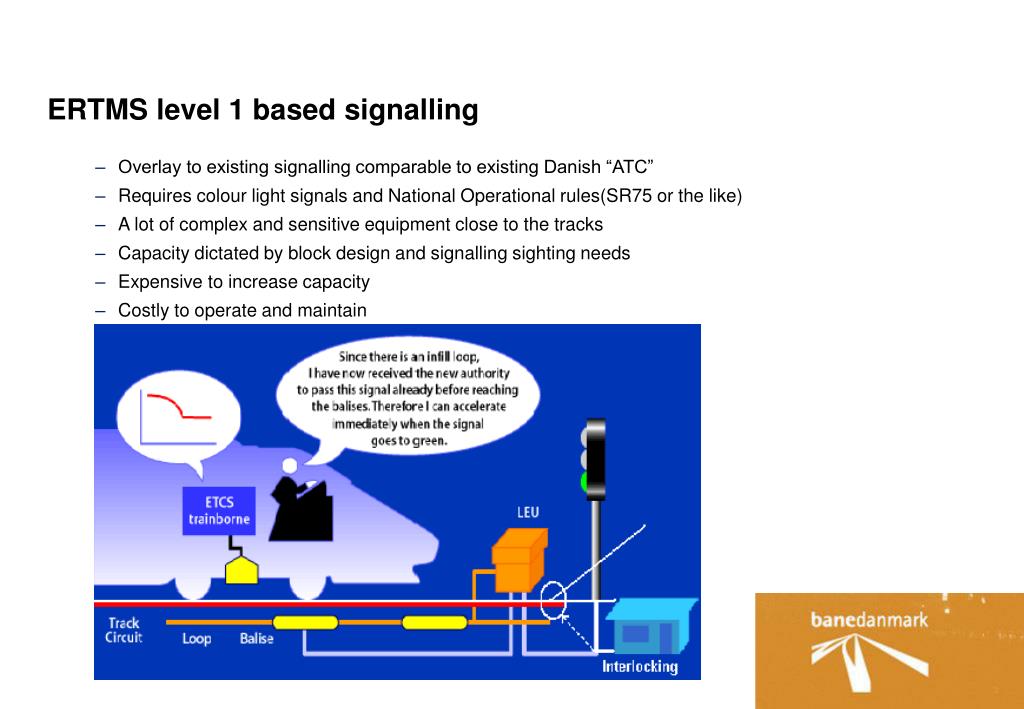

  9. ERTMS level 1 based signalling • Overlay to existing signalling comparable to existing Danish “ATC” • Requires colour light signals and National Operational rules(SR75 or the like) • A lot of complex and sensitive equipment close to the tracks • Capacity dictated by block design and signalling sighting needs • Expensive to increase capacity • Costly to operate and maintain

  10. ERTMS level 2 based signalling • New Radio based signalling system, comparable to up-to-date Metro signalling • Reduces the need for colour light signals by approx 80% (theoretically there’s no need) • Normal operational mode covered by European Operational Rules. • Very little complex and sensitive equipment close to tracks • Capacity only related to block design • High capacity ”only” requires shorter train detection sections

  11. ERTMS Regional based signalling • Near future Radio based signalling system, comparable to Level 2 • Reduces the need for colour light signals to a minimum • Normal operational mode covered by European Operational Rules. • Virtually no complex and sensitive equipment close to tracks • Substantial savings on Signalling Infrastructure cost (no train detection) compared to present system, L1 as well as L2 • Suitable for low capacity lines

  12. KEY Migration Schemes Route Mainline ERTMS L2 Route Route Secondary lines ERTMS L2 or Reg. The draft mainline implementation plan includes two ERTMS level 2 migration schemes starting in service by 2010 2009 2010 2011 2012 2013 2014 2015 2016 2017 2018 2019 2020 • …followed by a mainline roll out from North Jutland (Langå) by 2013, heading South and East to Odense by 2015, and Copenhagen including connection to Sweden by 2018. Rest of the network from 2017 to 2020 most likely with ERTMS Regional Fredericia-Esbjerg, Esbjerg - Varde – Skjern, Vejle - Herning - Holstebro - Struer – Thisted, Langaa – Struer, Skanderborg – Herning, Herning - Skjern – Holstebro, Lunderskov – Padborg, Tinglev- Sønderborg, Bramming - Ribe – Tønder, Århus H – Grenå Langå - Århus H Århus H – Vejle - Fredericia Jutland Langå -Ålborg – Frederikshavn Fredericia – Odense- Nyborg- Korsør Region Odense – Svendborg Funen Korsør – Ringsted – Roskilde - København H, København H (Fjern)/Vigerslev – Peberholm, København H – Helsingør, Roskilde-Holbæk, Ringsted – Rødby Fg Zealand Holbæk - Kalundborg, Næstved - Gedser Roskilde - Køge – Næstved

  13. KEY Migration Scheme Route Main roll out Route Route Circular line The draft S-bane implementation plan includes a migration scheme on the Northern line starting in service by 2013/14 2012 2013 2014 2015 2016 2017 • …followed by a roll out on the other fingers 2015-16. The Circular line will be finished last around 2017. Region S-bane Svanemøllen – Farum, København - Høje Tåstrup, Valby – Frederikssund, Skelbæk – Køge, København - Klampenborg Hellerup-Hillerød Flintholm-Hellerup

  14. Rolling stock fitment plans Migration Main Roll out Øresund

  15. Main target 1: Increase train-path Punctuality on Mainline

  16. Main target 2: Increase train-path Punctuality on S-bane

  17. Summary/assumptions roll out • Signalling system totally renewed by 2020(2018). High reliability centralised system. • Cab signalled Railway based on ERTMS level 2 and likely ERTMS Regional for rural lines. • 80 % of all signals will be decommissioned. Only signals for shunting at stations and yards (and possibly supporting a simple station to station fall-back operational mode) • 2 CTC centres to cover the Network, normal running based on timeplan/train number system and conflict handling/advanced decision support for disruptions. • Fibre optic transmission for whole Network • Joint less Train detection (Presumably Axle counters) • Massive parallel roll out, in the later stages

  18. Summary/assumptions continued • 525 Rolling stock units to be mainly retrofitted at an expected cost below 100 K€ each (Business Case uses 130-210 K€). • GSM-R voice Radio planning tender will be issued end of this year including optional Circuit Switched Data for Migration schemes. • Network will be extended with GSM-R data in 2012-15, expected on basis of GPRS for ETCS. • Pilots based on ETCS baseline 2.3.0 + tests of 3.0.0 functions • National roll out based on ETCS baseline 3.0.0 • STM development starts 2007, delivery 2009/10. Needed for Pilots and Øresund 2009/10 due to Swedish Malmø citytunnel. Need for close cooperation between Danish and Swedish ERTMS programmes. At some point also with Germany if they decide for anything in their Northern region. If Fehmarn decision Germany will also be high priority

  19. Questions? • Thank you for your attention
