Activity during test run Zoltán Fodor Wigner Research Centre for Physics, Hungarian Academy of Sciences
Main goals: Check the functionality of all possible parts. TPC Total readout and data taking with Kr source Needed full gas and HV settings, readout, … New pulser system test TOF Only readout check is possible, full readout and processors must be switched on Get running the laser signal and check the channels, /could be with the start with laser diodes?/.
DCS All connectivity must be checked BPD Readout check HV stability test? LMPD Readout test Kr? Beam counters S11 needed for trigger, others checks for working

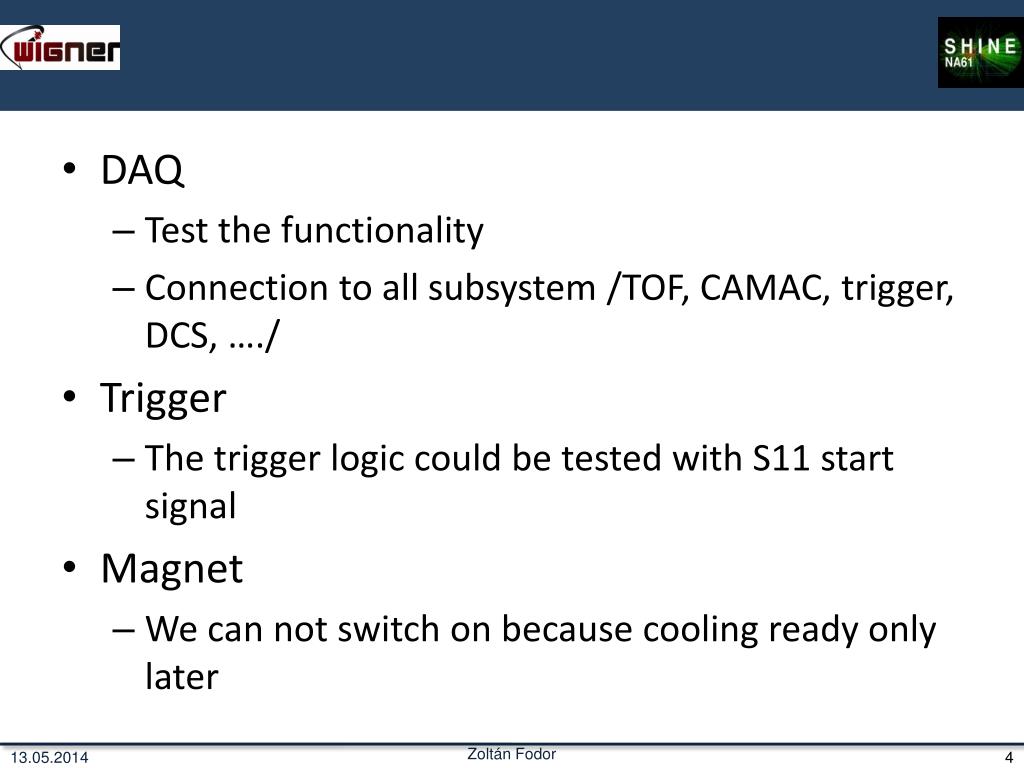

DAQ • Test the functionality • Connection to all subsystem /TOF, CAMAC, trigger, DCS, …./ • Trigger • The trigger logic could be tested with S11 start signal • Magnet • We can not switch on because cooling ready only later

PSD • Readout test
Schedule • Setup and DAQ test Sept. 1-14 • Kr run • VTPC1 Sept. 15 • VTPC2 Sept. 16 • MTPCR Sept. 17 • MTPCL Sept. 18 • GTPC Sept. 19 • LMPD Sept. 20
