MFS605/EE605 Systems for Factory Information and Control . Lecture 7 (Fall 2005) Introductory Production Control and MRP Larry Holloway Dept. of Electrical and Computer Engineering and UK Center for Manufacturing. Where we’ve come from: Models of Manufacturing Systems:

loader
I am the owner, or an agent authorized to act on behalf of the owner, of the copyrighted work described.
capcha
Download Presentation

PowerPoint Slideshow about 'MFS605/EE605 Systems for Factory Information and Control' - orinda


An Image/Link below is provided (as is) to download presentation

Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author.While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server.


- - - - - - - - - - - - - - - - - - - - - - - - - - E N D - - - - - - - - - - - - - - - - - - - - - - - - - -
Presentation Transcript
Mfs605 ee605 systems for factory information and control l.jpg

MFS605/EE605Systems for Factory Information and Control

Lecture 7 (Fall 2005)

Introductory Production Control and MRP

Larry Holloway

Dept. of Electrical and Computer Engineering and

UK Center for Manufacturing


Slide2 l.jpg

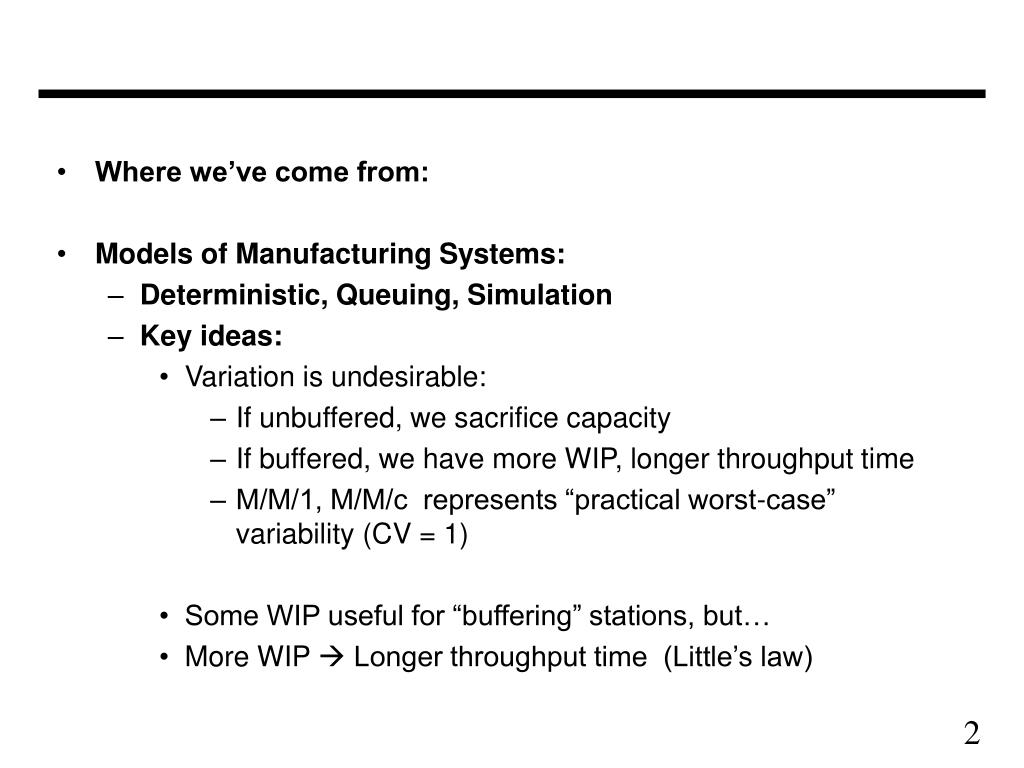

  • Where we’ve come from:

  • Models of Manufacturing Systems:

    • Deterministic, Queuing, Simulation

    • Key ideas:

      • Variation is undesirable:

        • If unbuffered, we sacrifice capacity

        • If buffered, we have more WIP, longer throughput time

        • M/M/1, M/M/c represents “practical worst-case” variability (CV = 1)

      • Some WIP useful for “buffering” stations, but…

      • More WIP  Longer throughput time (Little’s law)


Key points of material so far l.jpg
Key points of material so far:

  • Relationship between WIP and time (Little’s law)

  • Impact of variability

  • Modeling for estimating time, WIP, performance

    • Deterministic

    • Stochastic/Queueing

    • Simulation models

      Now… how do we manage the orders and inventory…?


Manufacturing planning production control l.jpg
Manufacturing Planning/Production Control

  • Suppose we have a product designed

  • Suppose we have a facility to produce it

    Question: How do we operate the factory to produce the product?

    --> Production Control

    Production Control: coordination of resources to meet customer demands/orders.

    (Resources mean: inventory, equipment, labor)

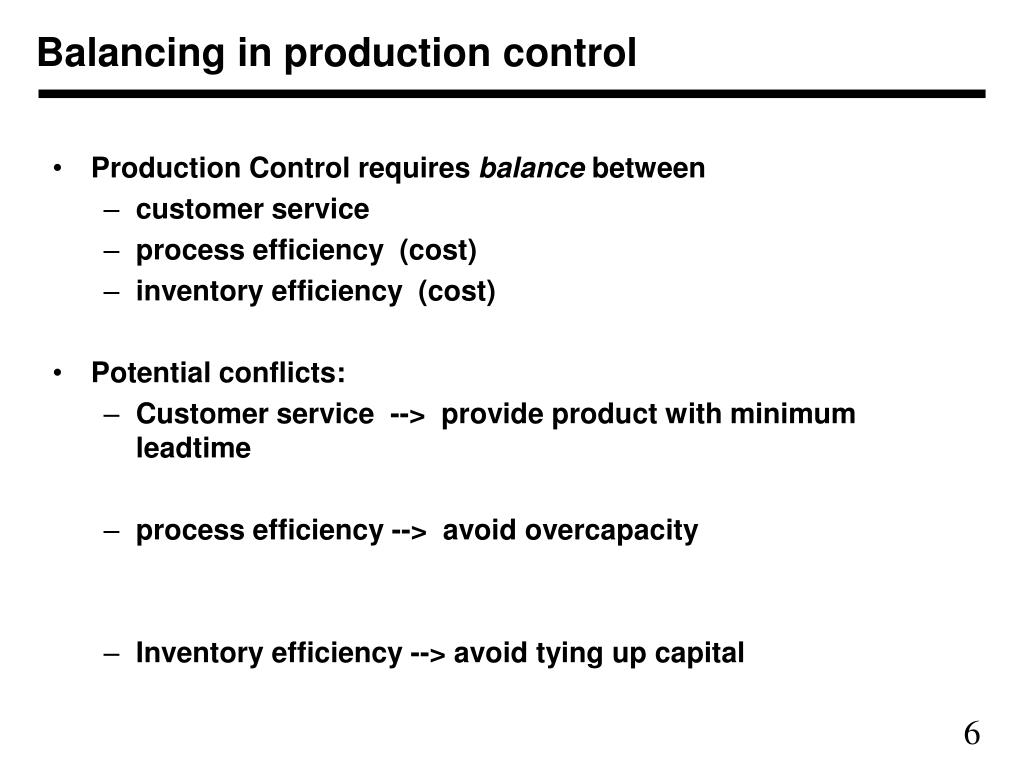

Balancing in production control l.jpg
Balancing in production control

  • Production Control requires balance between

    • customer service

    • process efficiency (cost)

    • inventory efficiency (cost)

  • Potential conflicts:

    • Customer service --> provide product with minimum leadtime

    • process efficiency --> avoid overcapacity

    • Inventory efficiency --> avoid tying up capital


Slide7 l.jpg

  • inventory reduces cost through

    • fewer missed sales (if finished product available)

    • amortized setups

    • reduced order costs (administrative overhead)

    • reduced material cost through quantity discounts

  • inventory contributes to cost through

    • cost of invested funds

    • cost of storage space

    • quality costs

    • coordination costs (tracking and transport of WIP)

    • Cost of poor responsiveness, obsolescence, decay


Slide8 l.jpg
WIP

  • WIP (Work in Process):

    • parts and products on the factory floor

      • --> not in raw materials inventory

      • --> not in finished goods inventory

  • WIP means money tied up since products not shippable

  • (From Dilworth): Value of inventory in average manufacturing company is 1.61 months sales = 13.4% of annual sales

    • From 1988 to 1989, after tax profits of mfg. Companies averaged 5.4% sales

    • This means manufacturing company had 2.5 years of profits invested in inventory

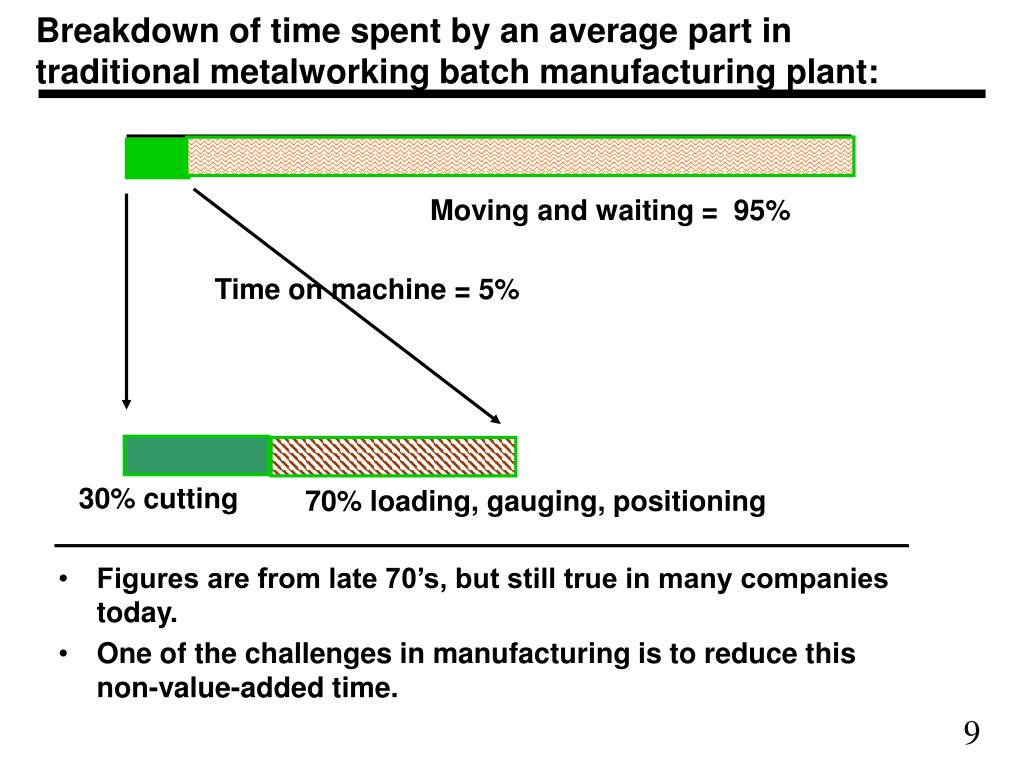

Breakdown of time spent by an average part in traditional metalworking batch manufacturing plant l.jpg
Breakdown of time spent by an average part in traditional metalworking batch manufacturing plant:

  • Figures are from late 70’s, but still true in many companies today.

  • One of the challenges in manufacturing is to reduce this non-value-added time.

Moving and waiting = 95%

Time on machine = 5%

30% cutting

70% loading, gauging, positioning

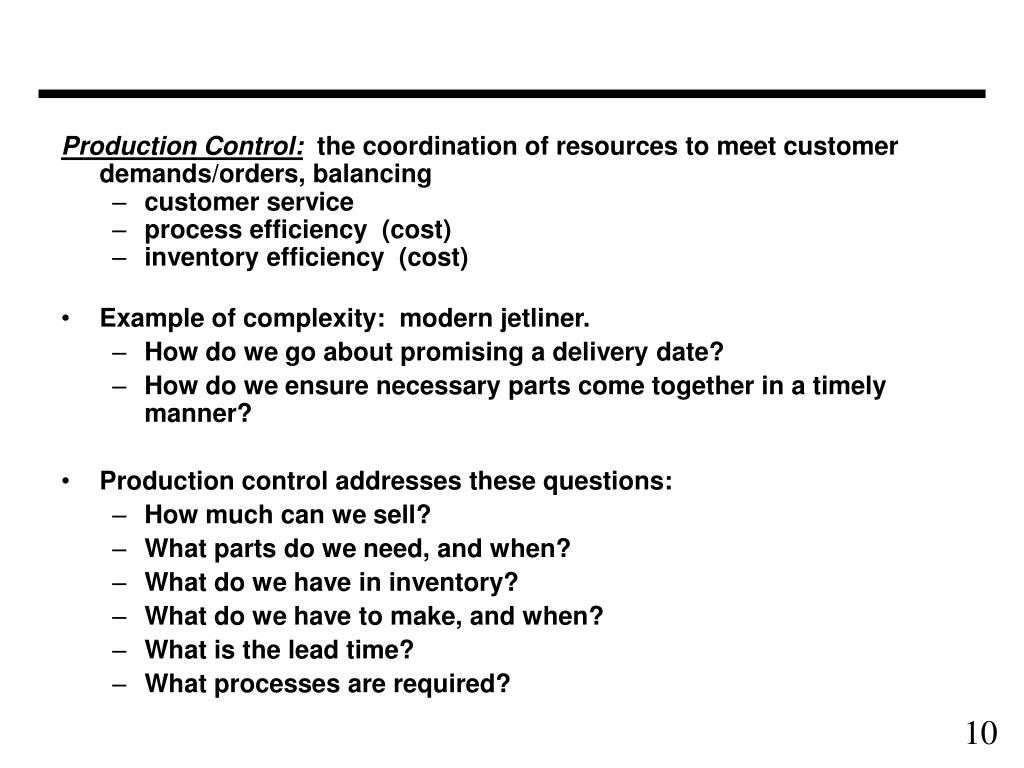

Slide10 l.jpg

Production Control: metalworking batch manufacturing plant: the coordination of resources to meet customer demands/orders, balancing

  • customer service

  • process efficiency (cost)

  • inventory efficiency (cost)

  • Example of complexity: modern jetliner.

    • How do we go about promising a delivery date?

    • How do we ensure necessary parts come together in a timely manner?

  • Production control addresses these questions:

    • How much can we sell?

    • What parts do we need, and when?

    • What do we have in inventory?

    • What do we have to make, and when?

    • What is the lead time?

    • What processes are required?


  • Slide11 l.jpg

    • Process decoupling metalworking batch manufacturing plant:: separation of direct effects of different processes:

      • examples: job shop (high) vs. transfer line (low)

      • low decoupling --> higher inventory efficiency

      • high decoupling --> higher process efficiency

    • Product Focus: How dedicated are facilities to a specific product.

    Complex production control: many products,

    lots of buffering

    Process Decoupling

    Low High

    simpler production control: few products,

    no buffering

    Low Product Focus High


    Production control classifications l.jpg
    Production Control Classifications metalworking batch manufacturing plant:

    Multiple-period inventory systems

    • Methods for Independent Demands

      • External demands (final products)

      • Uncertainty

      • Examples:

        • Economic Order Quantity

        • Fixed Quantity

        • Fixed Interval

    • Methods for Dependent Demands

      • Demand depends directly on demand for higher level products.

      • Examples:

        • Push Systems (MRP)

        • Pull Systems (JIT or lean manufacturing)


    Independent demand inventory methods l.jpg
    Independent Demand Inventory Methods metalworking batch manufacturing plant:

    • Fixed Quantity Reorder

      • reorder a fixed quantity when parts fall below reorder point

      • good for parts with constant use rates

      • “Two-bin” reorder useful for inexpensive parts


    Independent demand inventory methods14 l.jpg
    Independent Demand Inventory Methods metalworking batch manufacturing plant:

    • Fixed Interval System

      • at fixed time points, reorder to replenish up to fill line

      • Useful when multiple part types from same supplier.

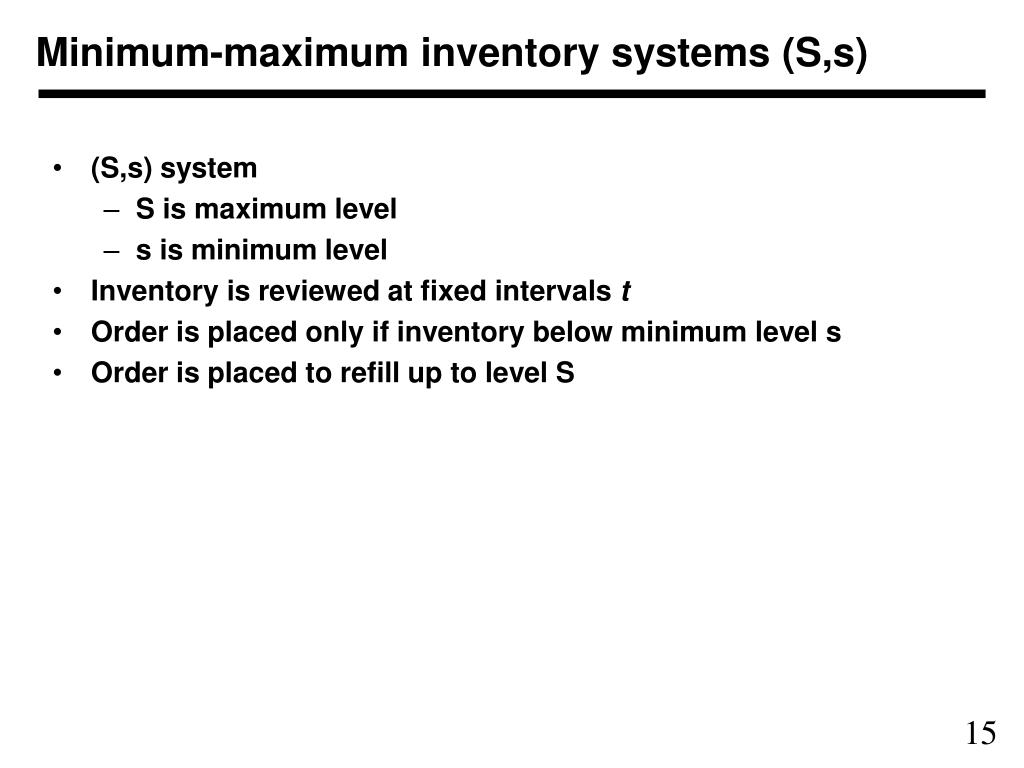

    Minimum maximum inventory systems s s l.jpg
    Minimum-maximum inventory systems (S,s) metalworking batch manufacturing plant:

    • (S,s) system

      • S is maximum level

      • s is minimum level

    • Inventory is reviewed at fixed intervals t

    • Order is placed only if inventory below minimum level s

    • Order is placed to refill up to level S


    Economic order quantity l.jpg
    Economic Order Quantity metalworking batch manufacturing plant:

    • Economic Order Quantity Model: allows determination of “optimal” order size or order period.

    • Assumes:

      • demand is known and constant

      • setup cost and inventory costs are known

        C=inventory carrying cost per unit per time

        Q=batch size

        S=setup cost per batch

        D=Demand per unit time


    Slide17 l.jpg
    EOQ metalworking batch manufacturing plant:

    C=inventory carrying cost per unit per time

    Q=batch size --> avg inventory level = Q/2

    S=setup cost per batch

    D=Demand per unit time

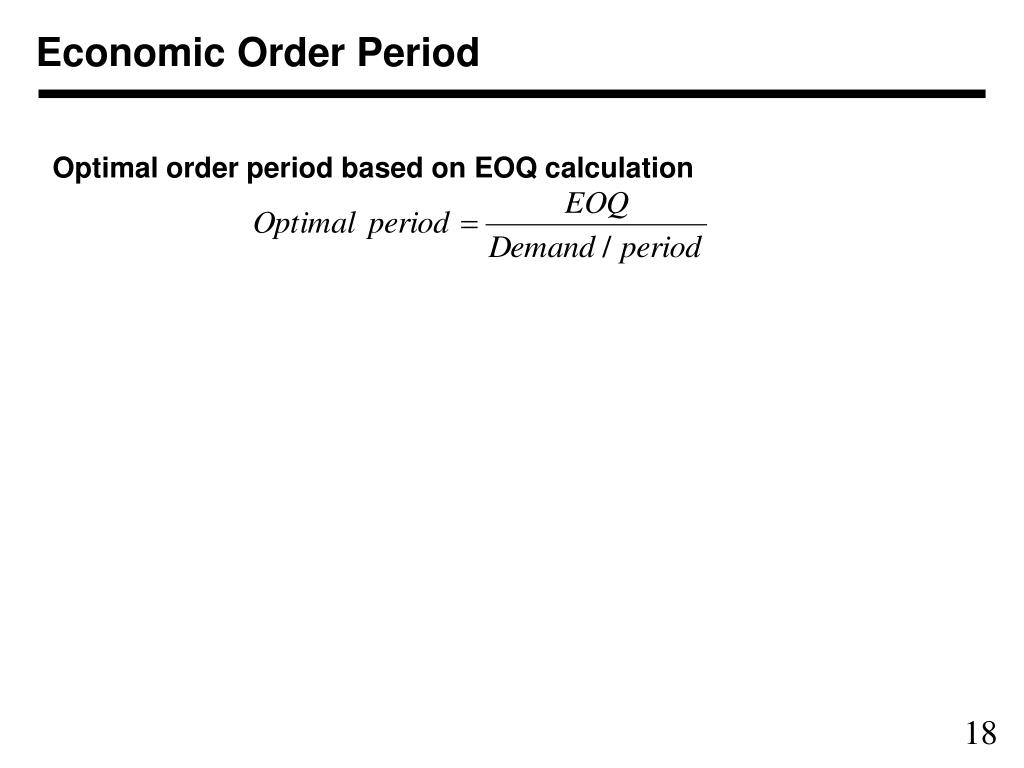

    Economic order period l.jpg
    Economic Order Period metalworking batch manufacturing plant:

    Optimal order period based on EOQ calculation


    Assumptions of eoq l.jpg
    Assumptions of EOQ metalworking batch manufacturing plant:

    Assumptions of EOQ:

    • Use rate is uniform and known (constant demand)

    • Lead time is known in advance

    • Cost of order is same regardless of amount ordered

      (item cost does not vary with order size (no quantity discounts))

    • Cost of holding inventory is a linear function of # of items held (no economies of scale in holding)

    • No backorders (all of order delivered at same time)

    • No probability or uncertainty

    • Setup and inventory costs assumed fixed

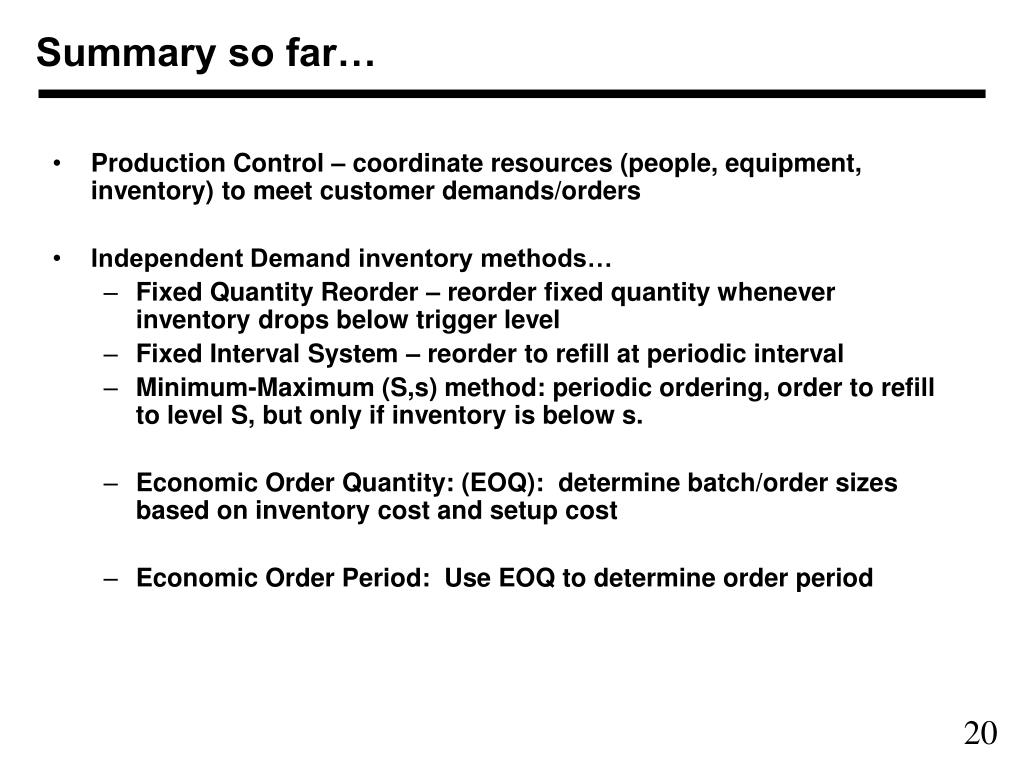

    Summary so far l.jpg
    Summary so far… metalworking batch manufacturing plant:

    • Production Control – coordinate resources (people, equipment, inventory) to meet customer demands/orders

    • Independent Demand inventory methods…

      • Fixed Quantity Reorder – reorder fixed quantity whenever inventory drops below trigger level

      • Fixed Interval System – reorder to refill at periodic interval

      • Minimum-Maximum (S,s) method: periodic ordering, order to refill to level S, but only if inventory is below s.

      • Economic Order Quantity: (EOQ): determine batch/order sizes based on inventory cost and setup cost

      • Economic Order Period: Use EOQ to determine order period


    Abc inventory classification l.jpg
    ABC inventory classification metalworking batch manufacturing plant:

    Classify and choose policy based on value:

    A: items of highest expenditure (top 10-20%)

    • given greatest attention

    • may warrant constant record keeping

    • often fixed quantity reorder or frequent review interval

      B: items of mid importance (next 20-30%)

      C: items of lowest value

    • examples: bolts or screws

    • not worthwhile to track individually, don’t worry if some extra

    • just reorder on regular basis -- use simple methods

    % of $ usage

    % of items

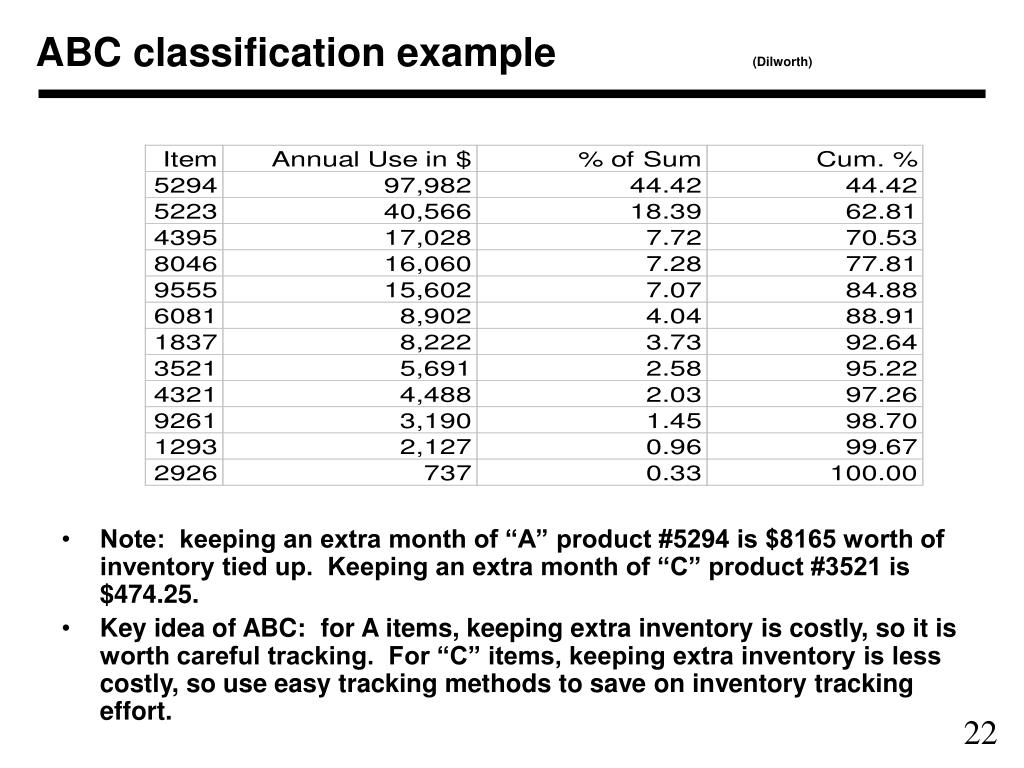

    Abc classification example dilworth l.jpg
    ABC classification example metalworking batch manufacturing plant:(Dilworth)

    • Note: keeping an extra month of “A” product #5294 is $8165 worth of inventory tied up. Keeping an extra month of “C” product #3521 is $474.25.

    • Key idea of ABC: for A items, keeping extra inventory is costly, so it is worth careful tracking. For “C” items, keeping extra inventory is less costly, so use easy tracking methods to save on inventory tracking effort.

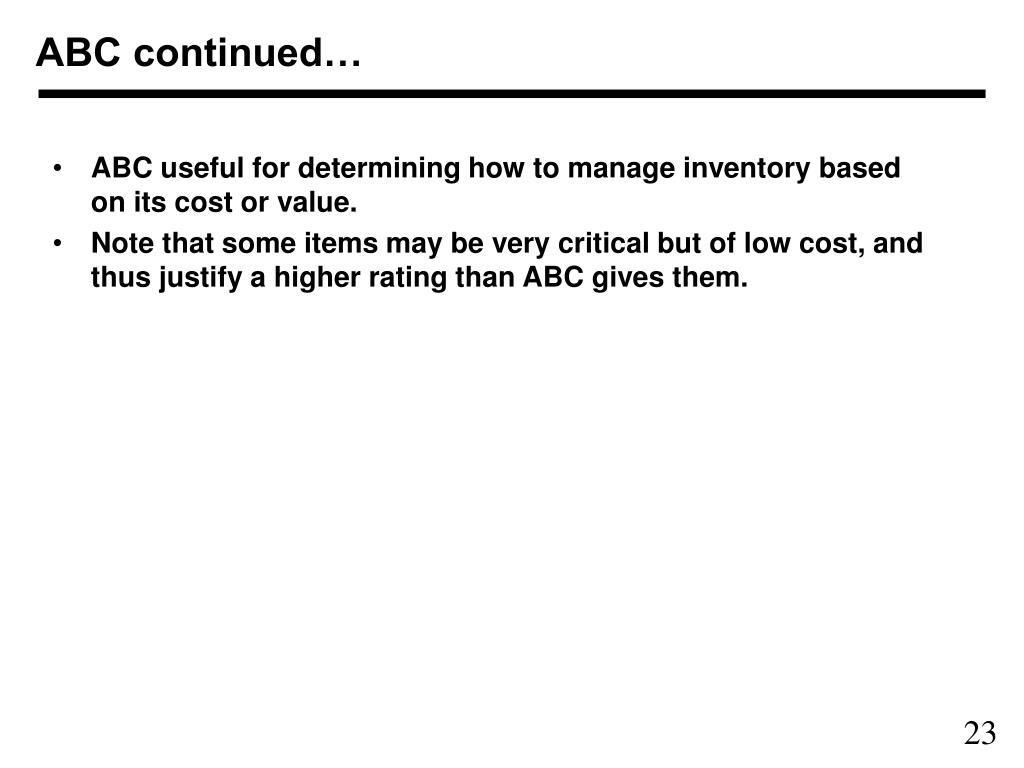

    Abc continued l.jpg
    ABC continued… metalworking batch manufacturing plant:

    • ABC useful for determining how to manage inventory based on its cost or value.

    • Note that some items may be very critical but of low cost, and thus justify a higher rating than ABC gives them.


    Slide24 l.jpg


    Production control for dependent demand items l.jpg
    Production control for dependent demand items metalworking batch manufacturing plant:

    • Dependent demand items:

    • Example: Forklift:

      • each order requires 4 wheels, 4 tires, 1 seat, 1 steering wheel, etc.

    • Methods:

      • Push

      • Pull

      • OPT (drum-buffer-rope methods)


    Slide26 l.jpg

    Push System metalworking batch manufacturing plant:

    • Customer orders and forecasts are fed into beginning of line

    Forecasts

    CUSTOMER

    Raw materials

    Product

    Manufacturing Facility


    Slide27 l.jpg

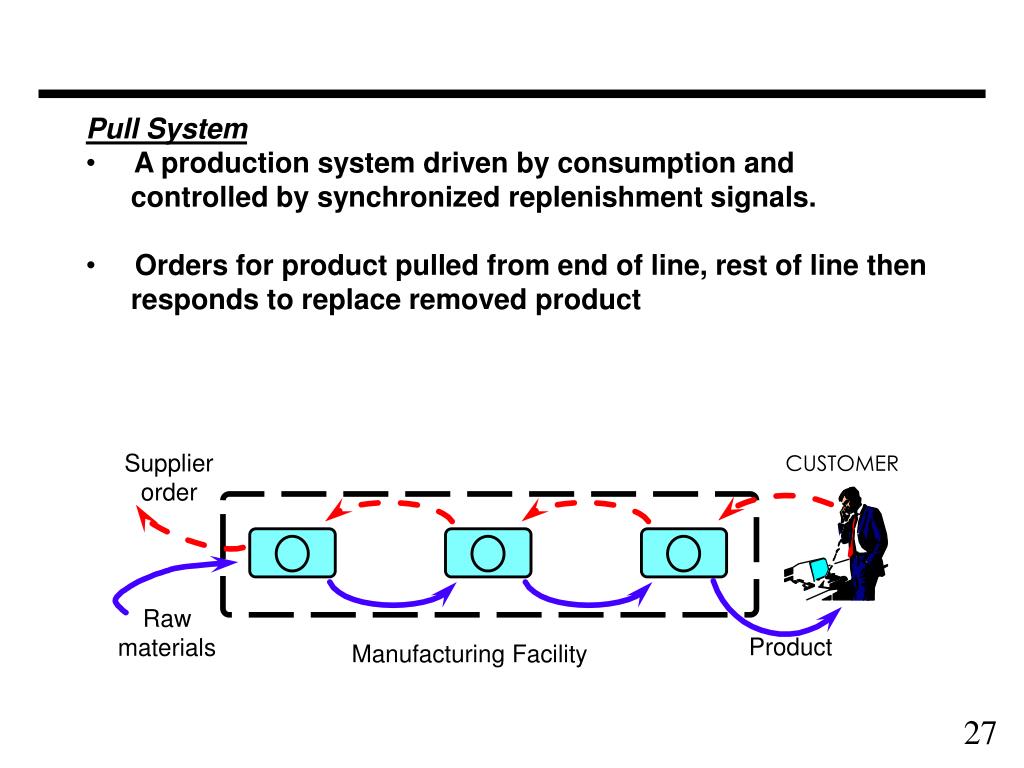

    Pull System metalworking batch manufacturing plant:

    • A production system driven by consumption and controlled by synchronized replenishment signals.

    • Orders for product pulled from end of line, rest of line then responds to replace removed product

    Supplier

    order

    CUSTOMER

    Raw materials

    Product

    Manufacturing Facility


    Slide28 l.jpg

    Push System metalworking batch manufacturing plant:

    • Customer orders and forecasts are fed into beginning of line

    Forecasts

    CUSTOMER

    Raw materials

    Product

    Manufacturing Facility


    Slide29 l.jpg

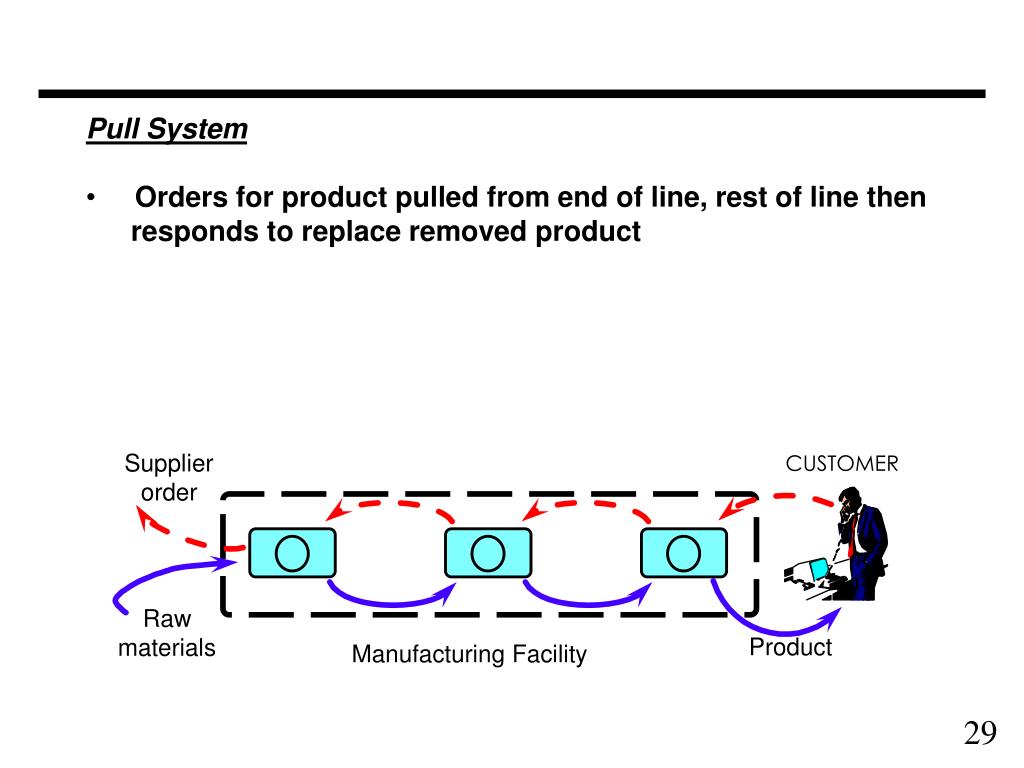

    Pull System metalworking batch manufacturing plant:

    • Orders for product pulled from end of line, rest of line then responds to replace removed product

    Supplier

    order

    CUSTOMER

    Raw materials

    Product

    Manufacturing Facility


    Mrp mrpii l.jpg
    MRP / MRPII metalworking batch manufacturing plant:

    MRP: Material Requirements Planning

    MRPII: Manufacturing Resource Planning

    • Typical Push system:

      • “explodes out” demand for final product into orders for raw materials and subassemblies.

    • began in 1960’s as computerized approach to materials planning (MRP)

    • Later expanded (MRPII), which included:

      • master production scheduling

      • capacity requirements planning

      • purchasing

      • forecasting

      • financial modules


    Background l.jpg
    Background metalworking batch manufacturing plant:

    • Popularity stems to the “MRP crusade” in 70’s by APICS (American Production and Inventory Control Society)

    • Focus:

      • convince industry that MRP was integrated decision support system for management of the total manufacturing business.

    • Promoted by APICS, consultants, and computer industry

    • Recently: MRP has come under fire:

      • oversold and poorly implemented

      • in practice, often leads to large WIP, large lead time

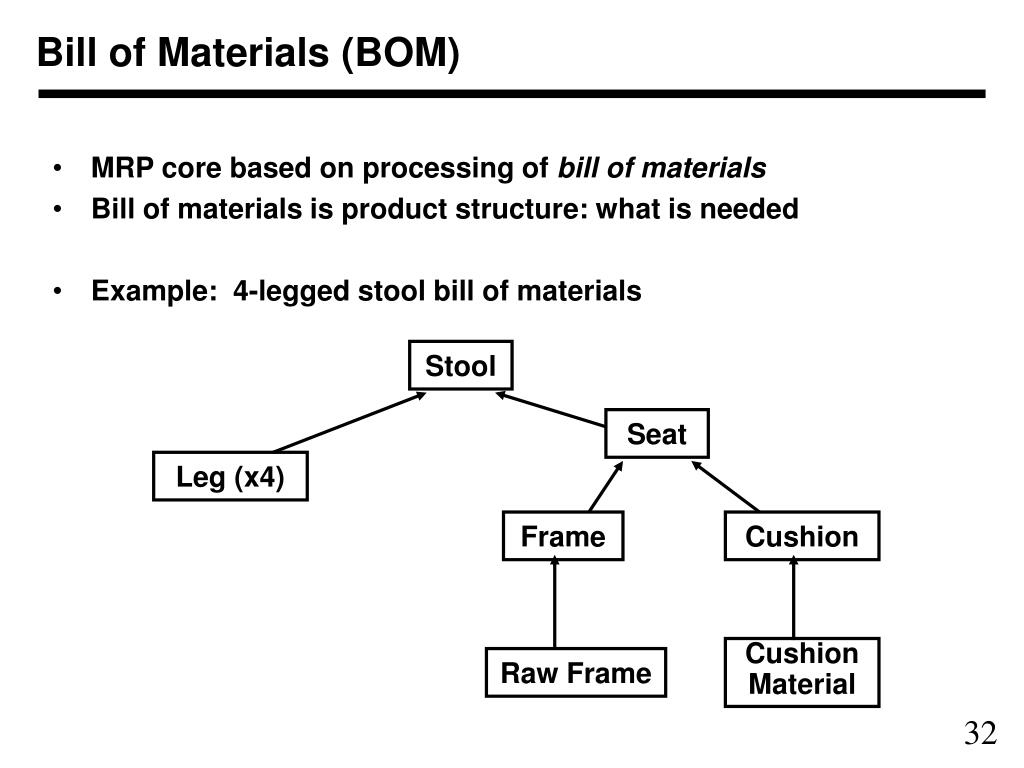

    Bill of materials bom l.jpg
    Bill of Materials (BOM) metalworking batch manufacturing plant:

    • MRP core based on processing of bill of materials

    • Bill of materials is product structure: what is needed

    • Example: 4-legged stool bill of materials

    Stool

    Seat

    Leg (x4)

    Frame

    Cushion

    Cushion

    Material

    Raw Frame


    Slide33 l.jpg

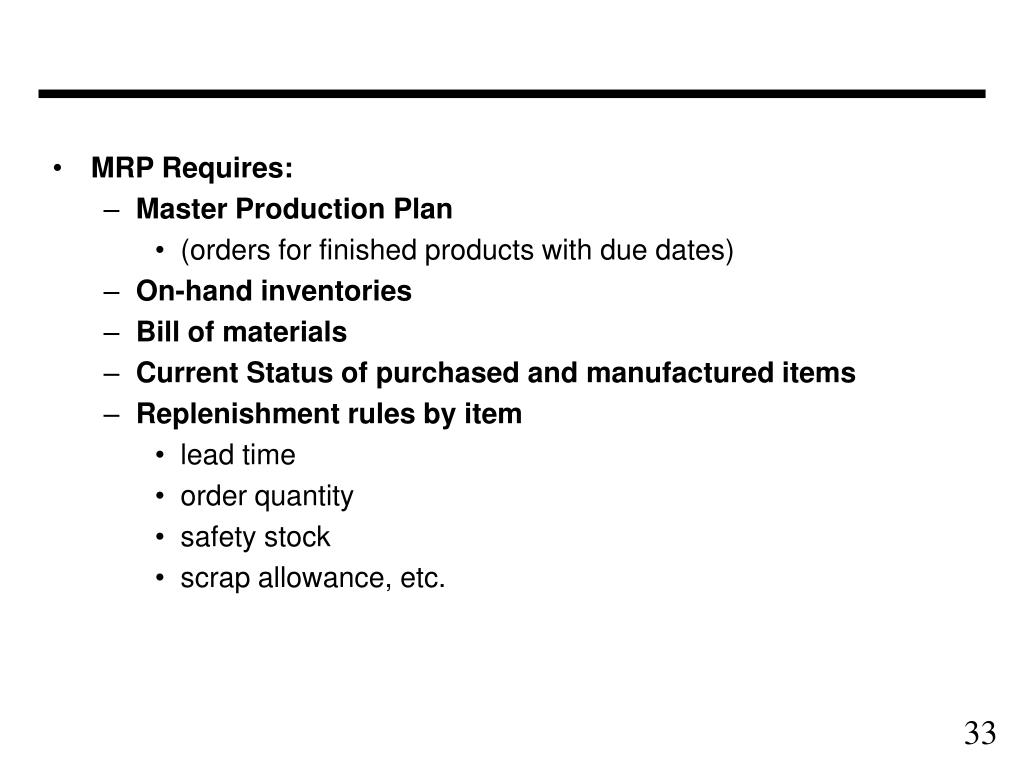

    • MRP Requires: metalworking batch manufacturing plant:

      • Master Production Plan

        • (orders for finished products with due dates)

      • On-hand inventories

      • Bill of materials

      • Current Status of purchased and manufactured items

      • Replenishment rules by item

        • lead time

        • order quantity

        • safety stock

        • scrap allowance, etc.


    Slide34 l.jpg

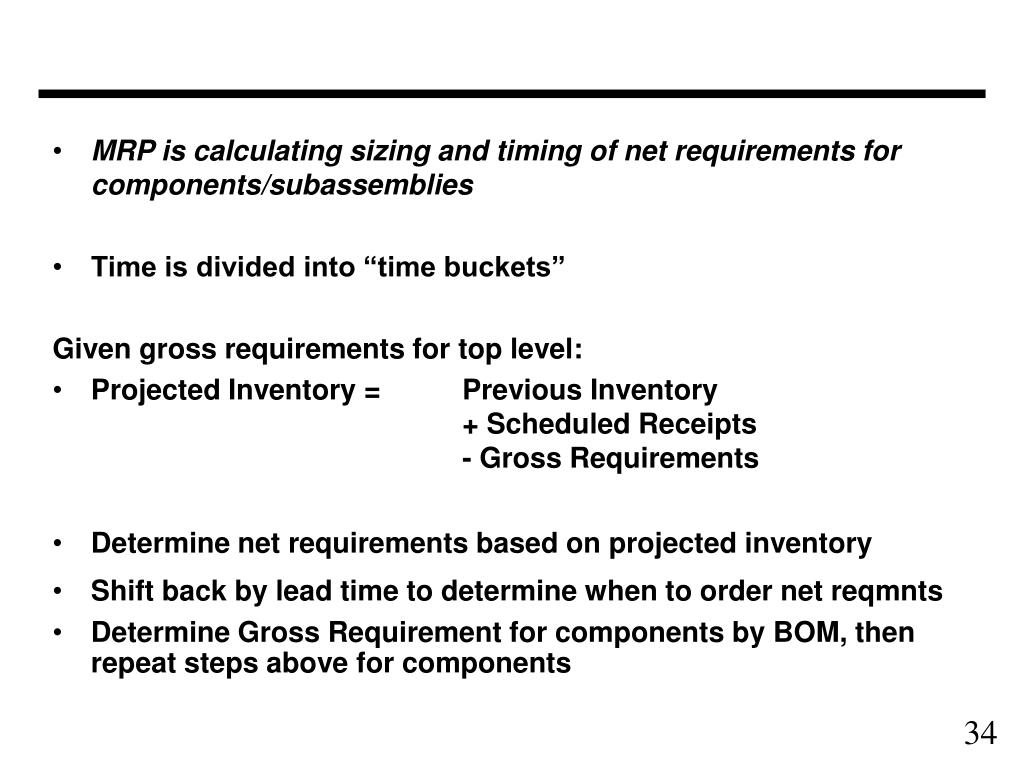

    • MRP is calculating sizing and timing of net requirements for components/subassemblies

    • Time is divided into “time buckets”

      Given gross requirements for top level:

    • Projected Inventory = Previous Inventory + Scheduled Receipts - Gross Requirements

    • Determine net requirements based on projected inventory

    • Shift back by lead time to determine when to order net reqmnts

    • Determine Gross Requirement for components by BOM, then repeat steps above for components


    Example l.jpg

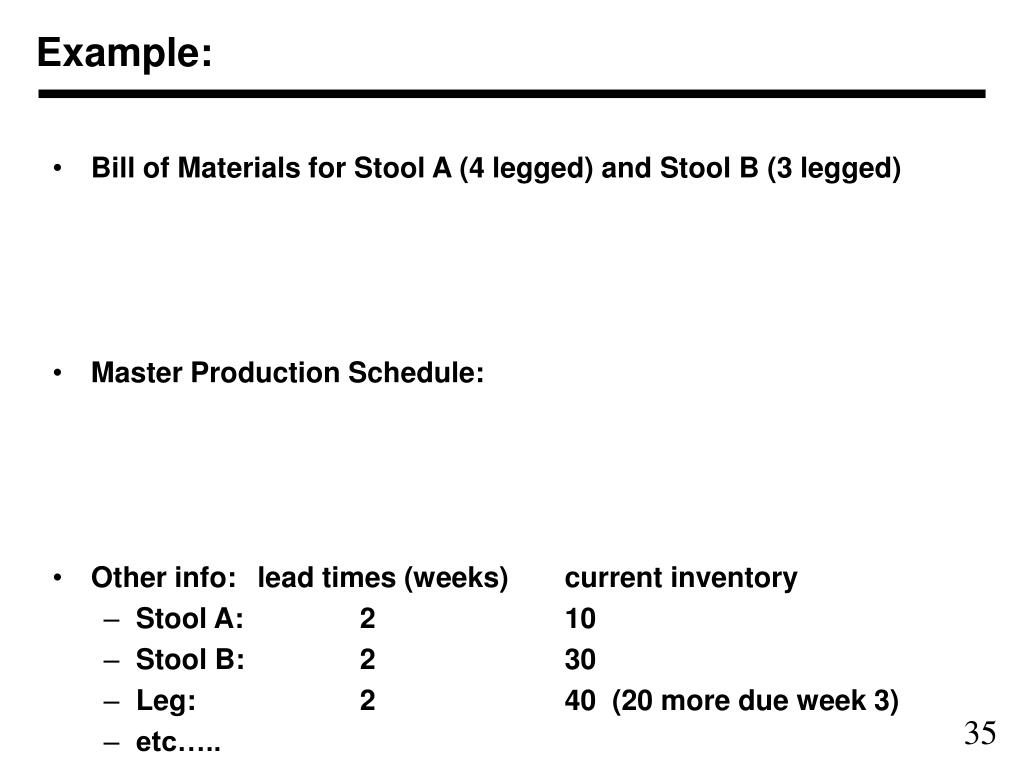

    Example: components/subassemblies

    • Bill of Materials for Stool A (4 legged) and Stool B (3 legged)

    • Master Production Schedule:

    • Other info: lead times (weeks) current inventory

      • Stool A: 2 10

      • Stool B: 2 30

      • Leg: 2 40 (20 more due week 3)

      • etc…..


    Mrp example l.jpg
    MRP Example: components/subassemblies


    Slide37 l.jpg

    • Summary of basic method: components/subassemblies

      • take final orders (gross reqmnts)

      • determine net requirements (after inventory, sched recpts)

      • from lead time, determine when to begin order

      • from bill of materials, determine gross reqmnts of components


    Slide38 l.jpg

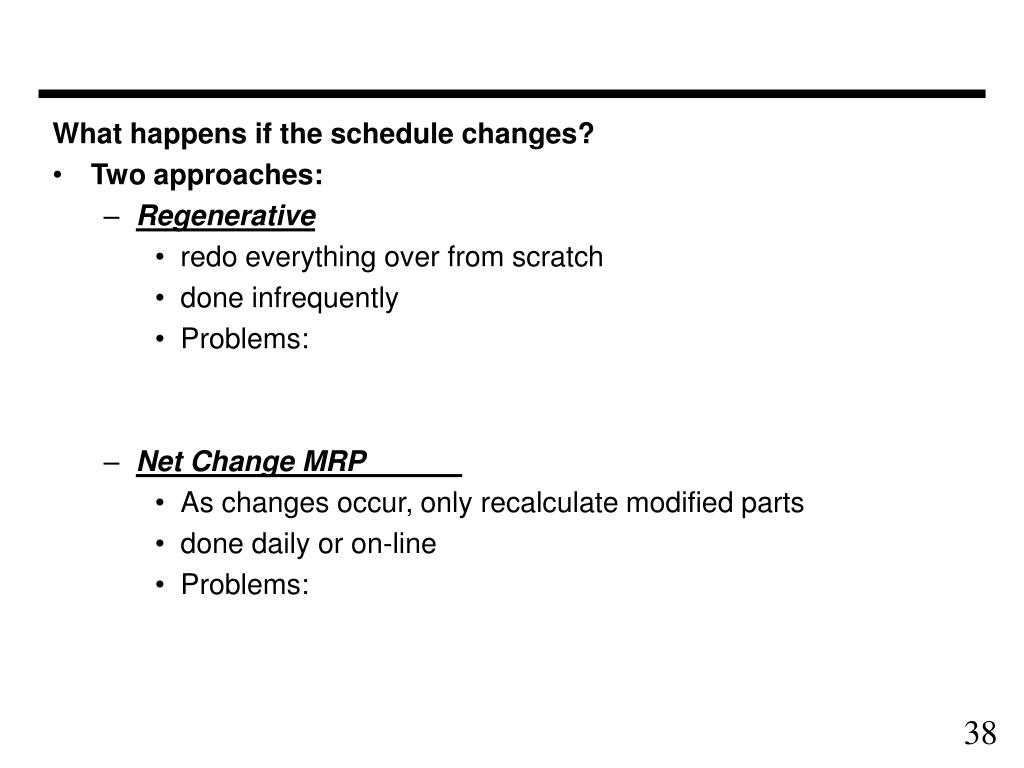

    What happens if the schedule changes? components/subassemblies

    • Two approaches:

      • Regenerative

        • redo everything over from scratch

        • done infrequently

        • Problems:

      • Net Change MRP

        • As changes occur, only recalculate modified parts

        • done daily or on-line

        • Problems:


    Other issues of mrp l.jpg
    Other issues of MRP components/subassemblies

    • Time buckets:

      • bucket is fixed time slot, and system has fixed # of buckets (planning horizon)

      • typically buckets are 1 week

        • note that there is no explicit indication as to whether event occurs at beginning or end of the bucket

    • Safety Stocks:

      • excess quantities of inventory maintained to cover unexpected fluctuations in supply or demand.

      • “Just-in-case” inventory

      • 2 methods

        • always order stock to keep inventory above minimum

        • just hide safety stock from MRP system (don’t include in inventory)


    Slide40 l.jpg

    Net change and regenerative are both “top-down” planning components/subassemblies

    “Bottom-up planning” is where human operator takes over

    • rush orders, special exceptions, scheduling

  • Firm-planned orders: allows over-ride of MRP rules

    • override lot size or lead time

  • Pegged Requirements: allows operator to see what final order is associated with given component orders (retrace the MRP steps)


  • Mrp review l.jpg
    MRP Review components/subassemblies

    • MRP: Materials Requirement Planning

      • computerized approach to translating orders for final goods into orders for operations and raw materials

      • Key idea: Blow up bill of materials

        • expand to subcomponents

        • factor in lead times

        • determine when operations and orders should be done


    Mrpii l.jpg
    MRPII components/subassemblies

    • MRPII: Manufacturing Requirements Planning

      • built around MRP bill-of-materials processor

      • adds additional functionality:

        • master production scheduling

        • capacity planning

        • financial modules

        • etc.

      • Integrated set of manufacturing planning tools


    Rough cut capacity planning l.jpg

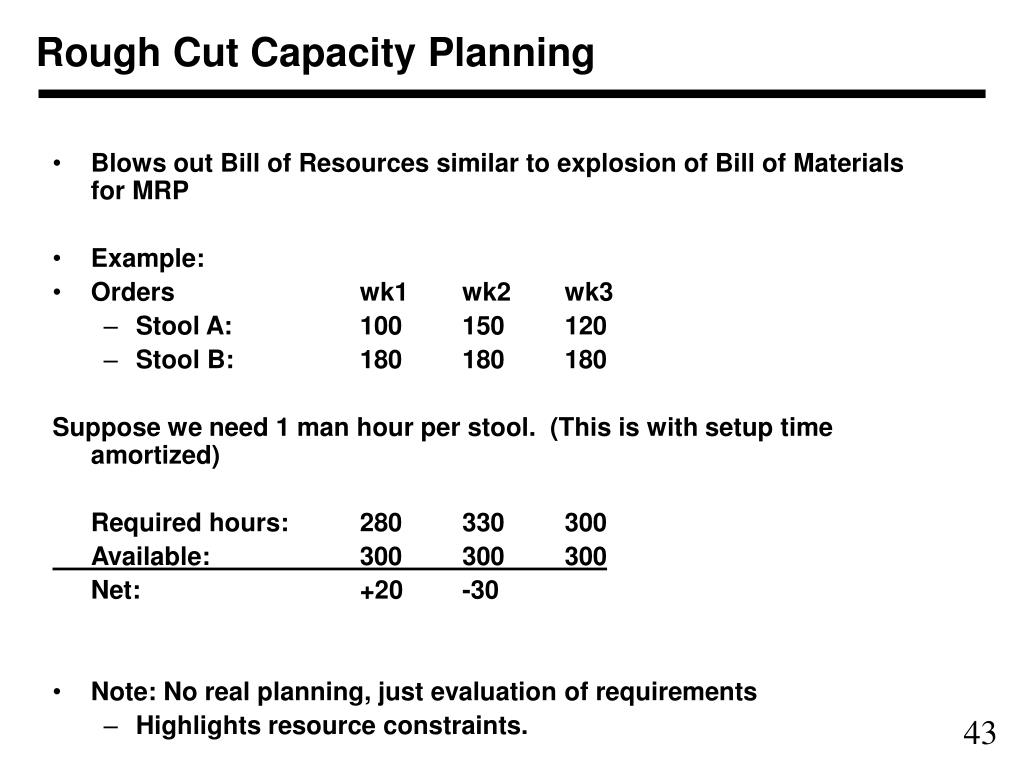

    Rough Cut Capacity Planning components/subassemblies

    • Blows out Bill of Resources similar to explosion of Bill of Materials for MRP

    • Example:

    • Orders wk1 wk2 wk3

      • Stool A: 100 150 120

      • Stool B: 180 180 180

        Suppose we need 1 man hour per stool. (This is with setup time amortized)

        Required hours: 280 330 300

        Available: 300 300 300

        Net: +20 -30

    • Note: No real planning, just evaluation of requirements

      • Highlights resource constraints.


    Positive aspects of mrp l.jpg
    Positive aspects of MRP components/subassemblies

    • Better coordination of orders for dependent demand items…

      • May reduce WIP by ordering component products only as needed for final product.

      • But…

    • Production Planning: Helps determine peaks and valleys

    • Purchasing and Finance: tells needs over the horizon.

    • Sales: MRP helps sales by giving estimates of lead times…

      • But…


    Issues with mrp l.jpg

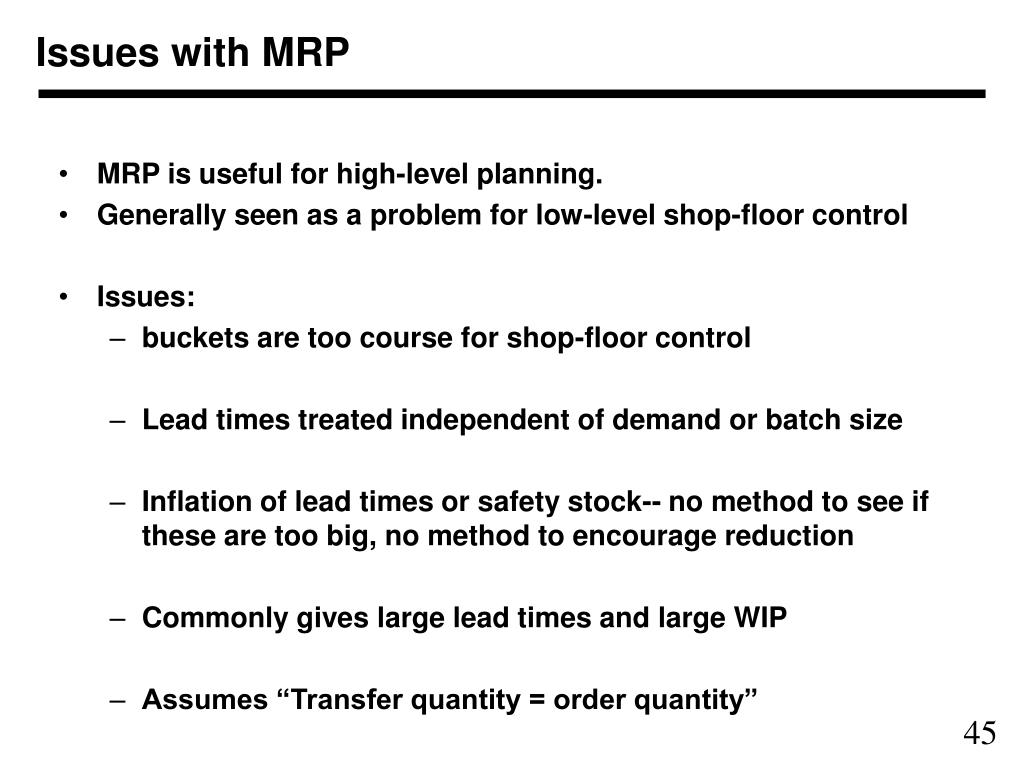

    Issues with MRP components/subassemblies

    • MRP is useful for high-level planning.

    • Generally seen as a problem for low-level shop-floor control

    • Issues:

      • buckets are too course for shop-floor control

      • Lead times treated independent of demand or batch size

      • Inflation of lead times or safety stock-- no method to see if these are too big, no method to encourage reduction

      • Commonly gives large lead times and large WIP

      • Assumes “Transfer quantity = order quantity”


    Transfer quantity vs order quantity l.jpg

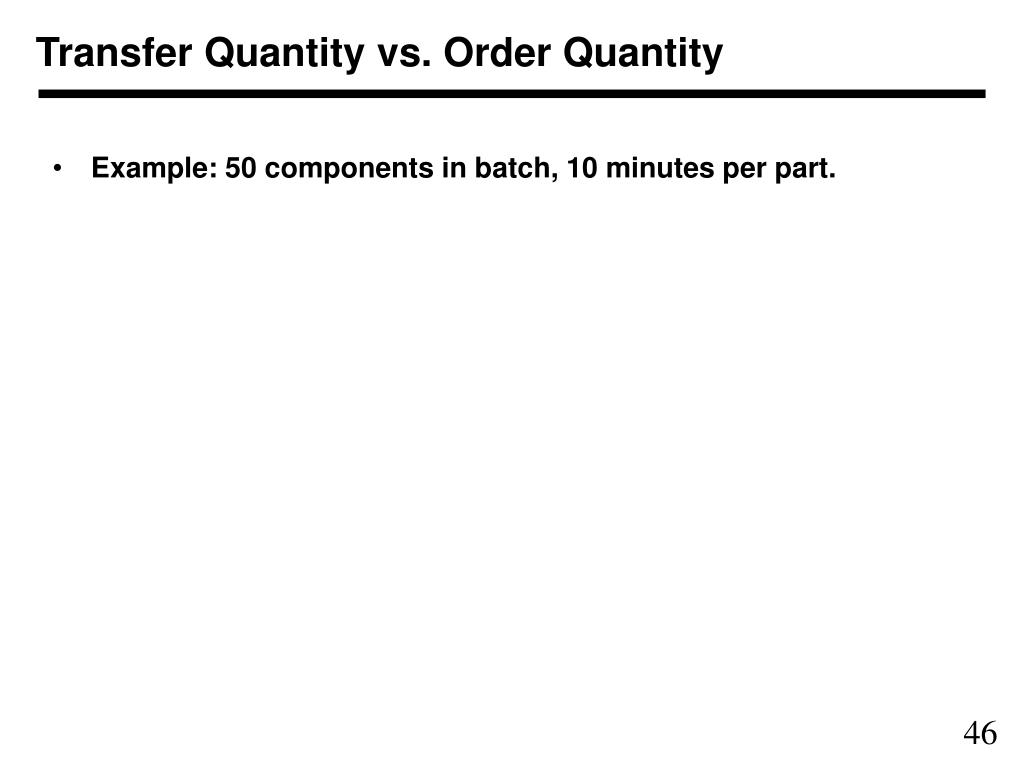

    Transfer Quantity vs. Order Quantity components/subassemblies

    • Example: 50 components in batch, 10 minutes per part.


    Slide47 l.jpg

    Pull System components/subassemblies

    • A production system driven by actual consumption and controlled by synchronized replenishment signals.

    • Orders for product pulled from end of line, rest of line then responds to replace removed product

    Supplier

    order

    CUSTOMER

    Raw materials

    Product

    Manufacturing Facility


    Just in time manufacturing l.jpg

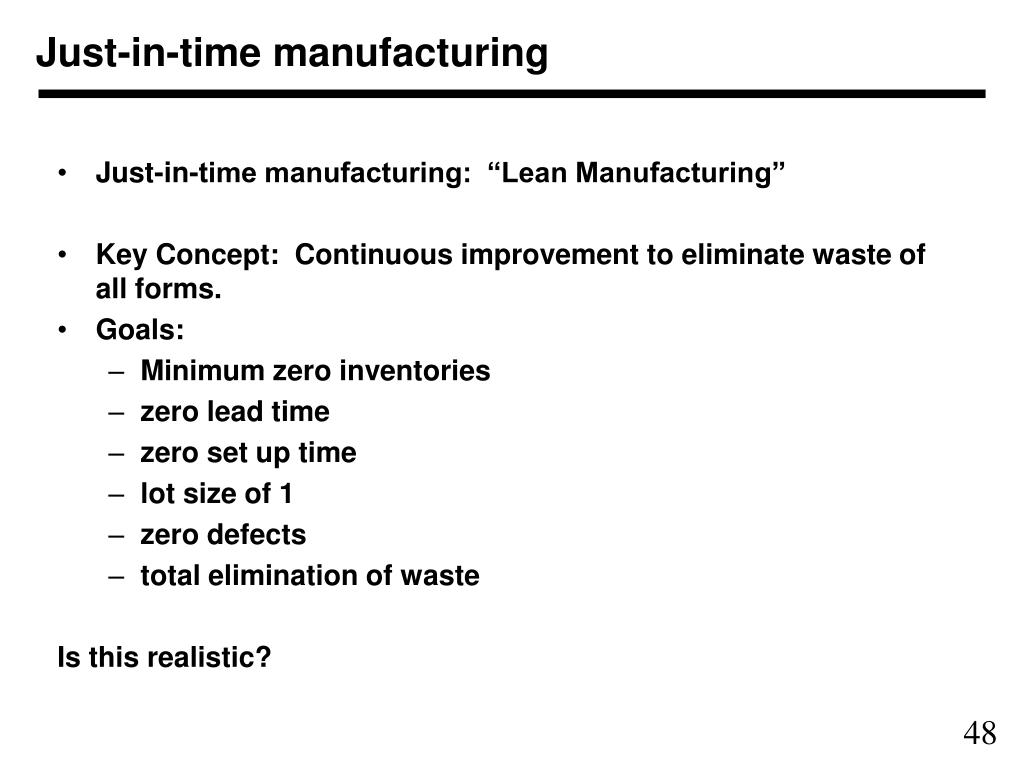

    Just-in-time manufacturing components/subassemblies

    • Just-in-time manufacturing: “Lean Manufacturing”

    • Key Concept: Continuous improvement to eliminate waste of all forms.

    • Goals:

      • Minimum zero inventories

      • zero lead time

      • zero set up time

      • lot size of 1

      • zero defects

      • total elimination of waste

        Is this realistic?


    Slide49 l.jpg


    Slide50 l.jpg

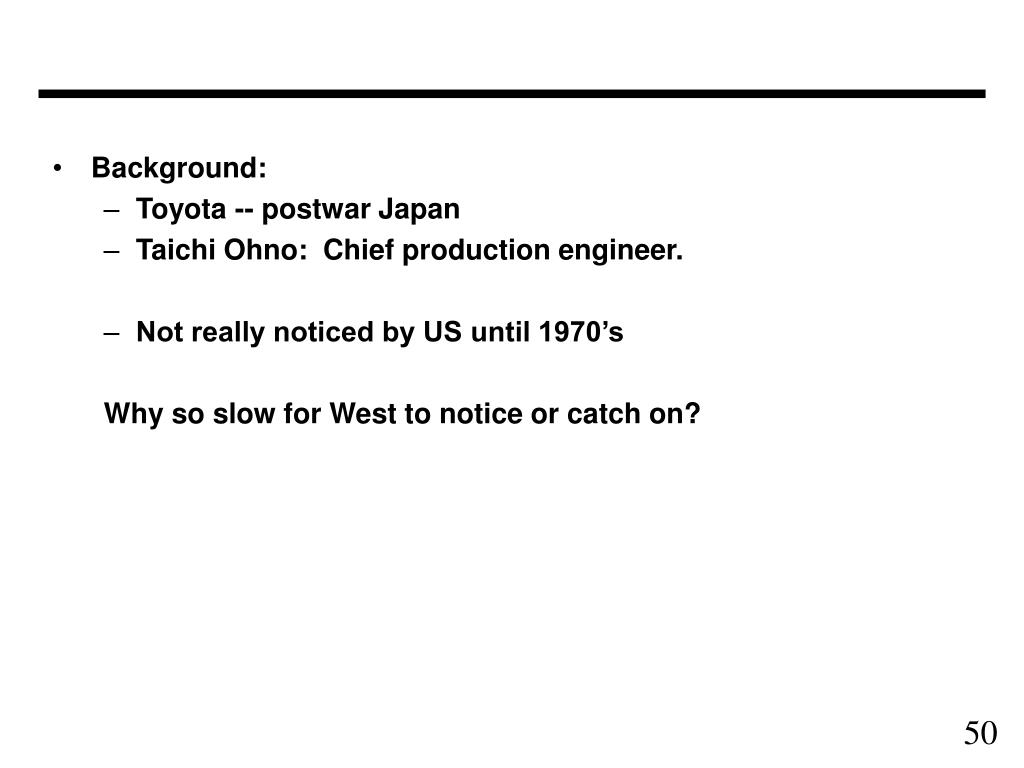

    • Background: components/subassemblies

      • Toyota -- postwar Japan

      • Taichi Ohno: Chief production engineer.

      • Not really noticed by US until 1970’s

        Why so slow for West to notice or catch on?


    Jit lean l.jpg
    JIT/Lean components/subassemblies

    • JIT/Lean is holistic approach

      • keep tackling all parts of system

        • different aspects affect each other

          • example: lot sizing and setup time

      • keep striving for continuous improvement


    Conventional mfg l.jpg
    Conventional Mfg. components/subassemblies

    • Why did it take so long for US mfg. To understand?

      Possible ideas:
