  1. 數位學習管理平台建置 國立雲林科技大學-資訊中心 資訊二隊 報告人:Howh

  2. 1.專案組織圖(Project Organization Chart) 97年獎勵大學教學卓越計畫 林校長 嚴副教務長 教卓辦公室 楊教務長 子計畫1 子計畫2 教學品質資訊整合計畫 子計畫3 子計畫4 子計畫5 子計畫6 採購 電子文書資訊系統建構小組 硬體建置 分析探勘系統 建構小組 軟體建置 數位學習管理平台建構小組 推廣

  3. 2.專案成員角色及執掌表

  4. 3.1專案責任指派矩陣表

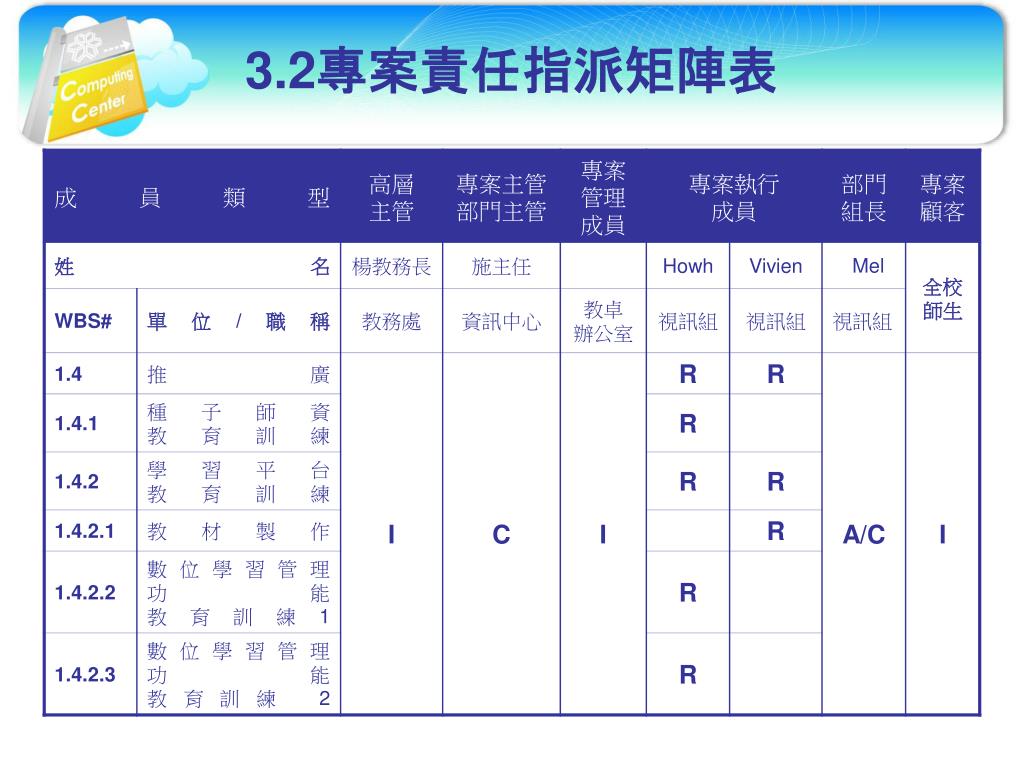

  5. 3.2專案責任指派矩陣表

  6. 3.3專案責任指派矩陣表

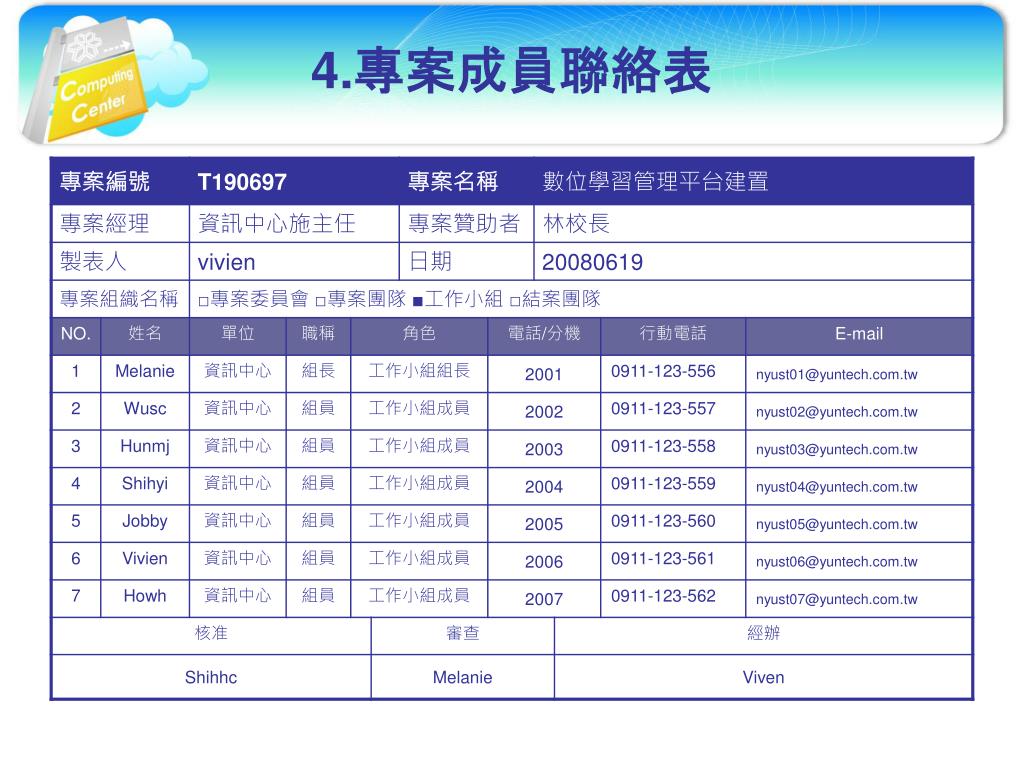

  7. 4.專案成員聯絡表

  8. 5.1產出規格定義清單

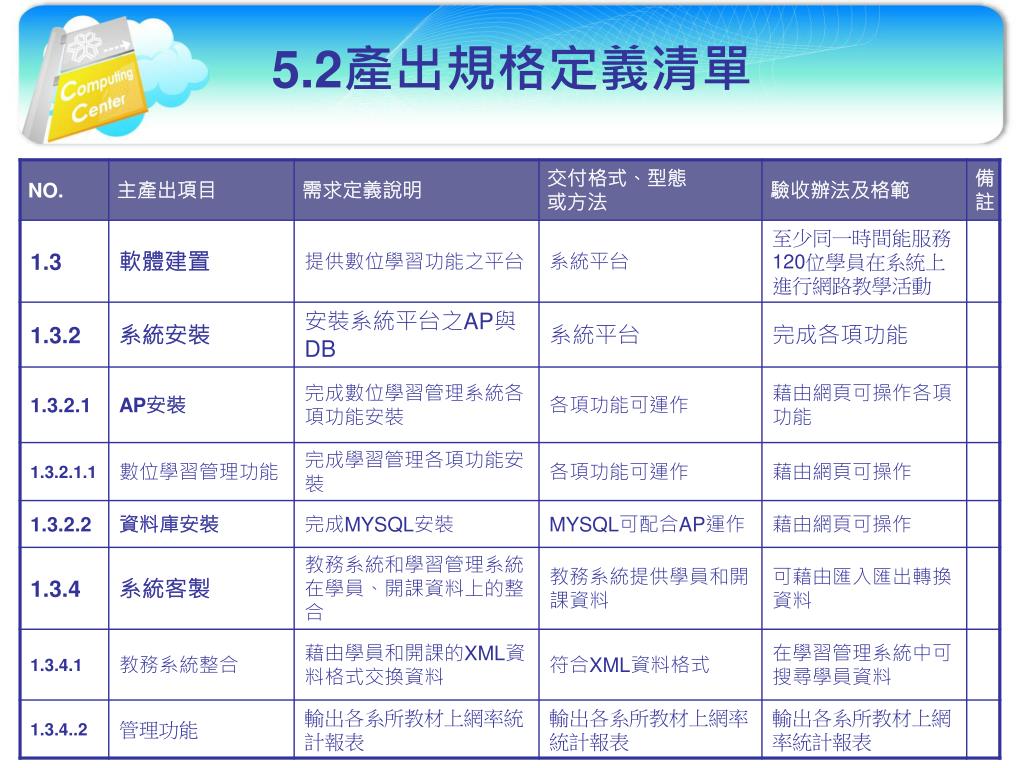

  9. 5.2產出規格定義清單

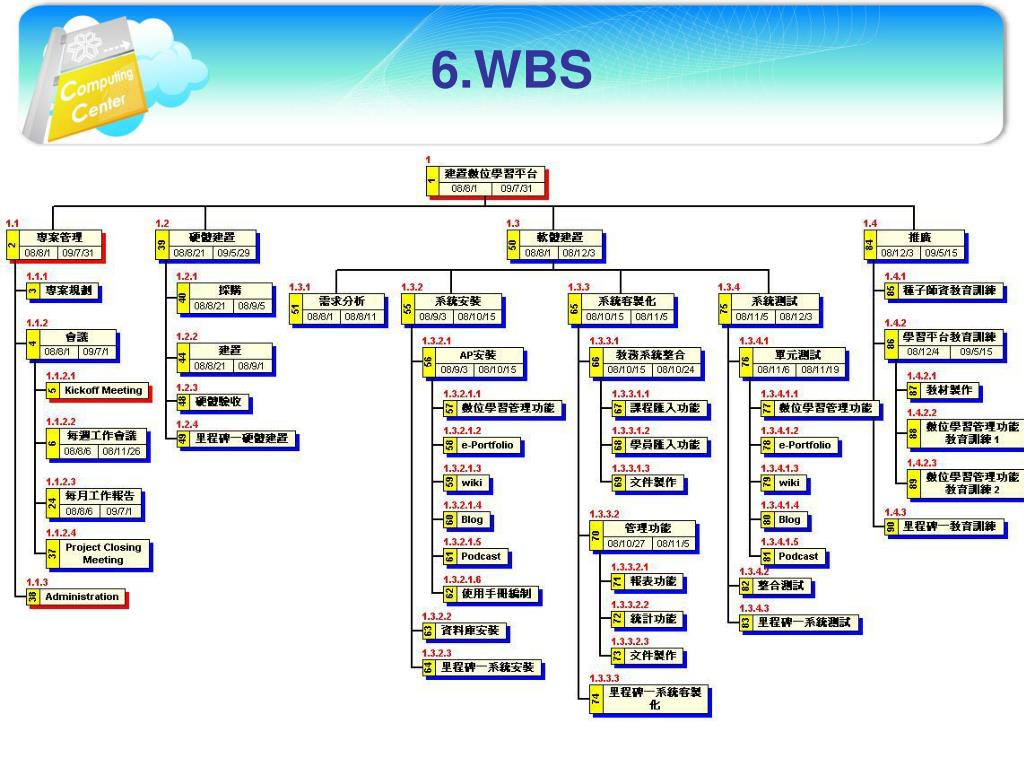

  10. 6.WBS

  11. 7.活動定義清單

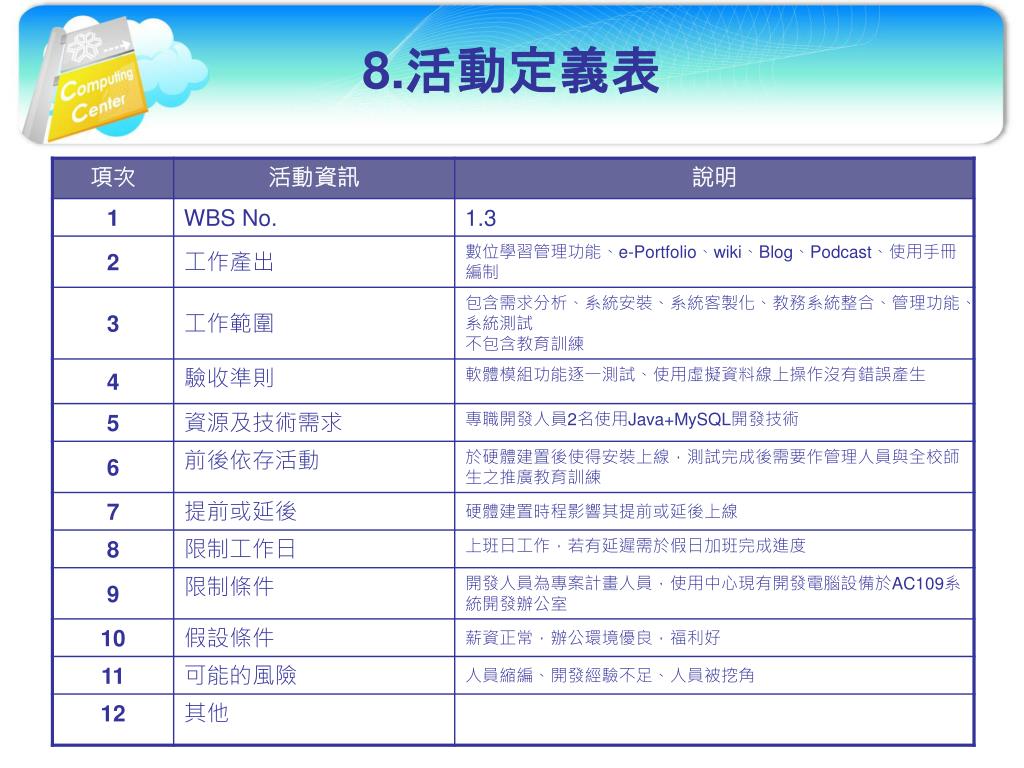

  12. 8.活動定義表

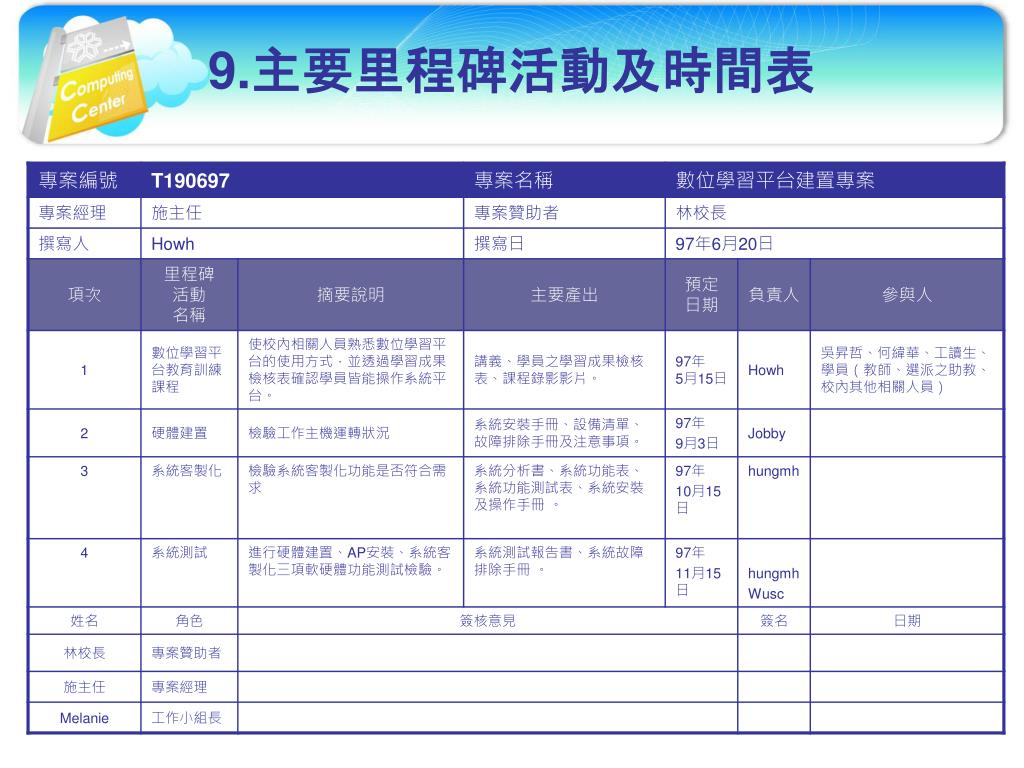

  13. 9.主要里程碑活動及時間表

  14. 10.活動時程估算表

  15. 11.成本估算單價分析表

  16. 12.甘特圖

  17. 13.資源需求計劃表

  18. 14.產出品質計畫表

  19. 14.產出品質計畫表

  20. 15.專案溝通報告計畫表

  21. 報告完畢,謝謝聆聽~
