protocol revision subcommittee

Protocol Revision Subcommittee

Report to the ERCOT

Technical Advisory Committee

August 6, 2003

summary
Summary
  • Two Urgent Timelines
  • Five PRRs for approval
  • One rejected PRR
  • Status of PRR 384
urgent timelines requested
Urgent Timelines Requested
  • PRR 442 – Profile Development Cost Recovery
  • PRR 443 – Competitive Metering
    • Preparing to meet statutory deadline
prr 410 resource obligations during blt
PRR 410 – Resource Obligations During BLT
  • Relieves ERCOT generation resources of ancillary service or other obligations to ERCOT during the time the resource is in a BLT to a non-ERCOT area
  • No impact to ERCOT computer systems
  • Effective date September 1, 2003
prr 413 rprs optimization

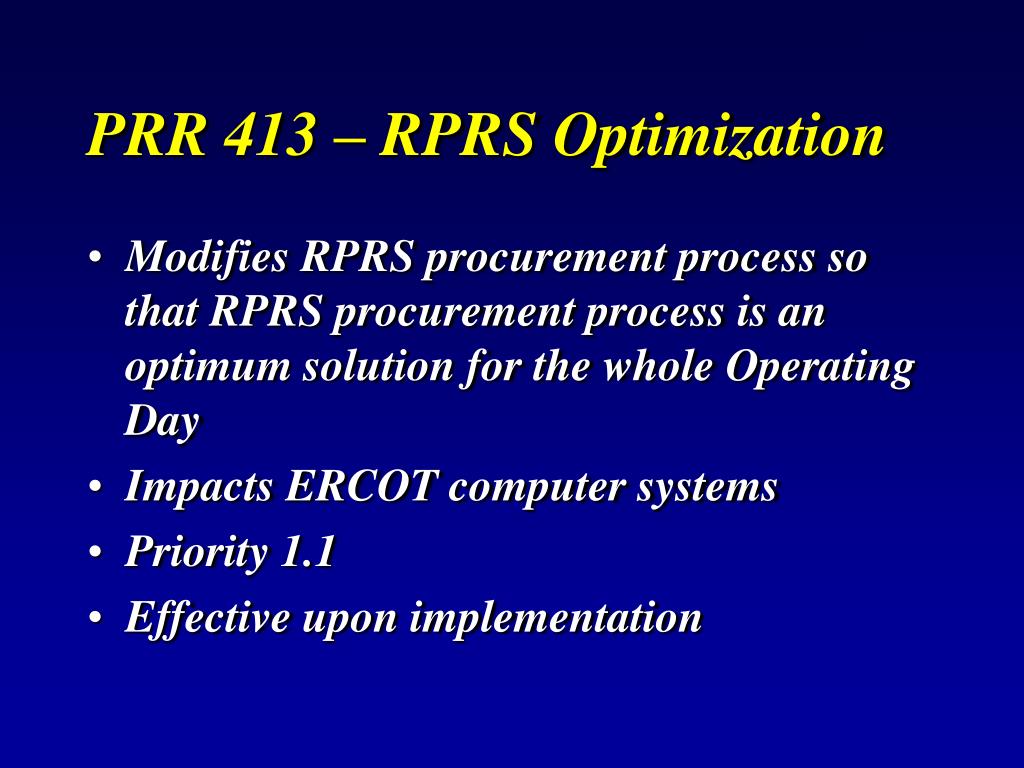

PRR 413 – RPRS Optimization
  • Modifies RPRS procurement process so that RPRS procurement process is an optimum solution for the whole Operating Day
  • Impacts ERCOT computer systems
  • Priority 1.1
  • Effective upon implementation
prr 422 oom zonal dispatch instructions
PRR 422 – OOM Zonal Dispatch Instructions
  • Provides deployment and settlement guidance for zonal OOM dispatch instructions – currently not in protocols
  • Impacts ERCOT computer systems and staffing; may have manual workaround
  • Effective September 1, 2003; manual workaround to be explored
prr 431 collateral requirements for rbs eal
PRR 431 – Collateral Requirements for RBS/EAL
  • Calculates collateral requirements for QSEs using RBS; excludes certain portions of EAL calculation from 60-Day ratchet; reduces from 3 to 2 days the period in which collateral must be posted; allows ERCOT to accelerate due dates
  • No impact on ERCOT computer systems
  • Effective September 1, 2003
prr 439 clarification of oome as instructed deviation
PRR 439 – Clarification of OOME as Instructed Deviation
  • Clarifies two exceptions on defining OOME as an instructed deviation
  • Impacts ERCOT computer system
  • Same priority as PRR 373 (in progress)
  • Effective on implementation of EMMS Release 3.2
prr 435 confidentiality of lse transaction data
PRR 435 – Confidentiality of LSE Transaction Data
  • Provides confidentiality for TX Set transactions between REPs and ERCOT
  • PRS recommended rejection of the PRR
prr 384 preamble and code of conduct
PRR 384 – Preamble and Code of Conduct
  • BOD remanded to TAC/PRS to consider if preamble should be in protocol and to consider alternative language
  • Alternative language prepared by Laurie Pappas and Shannon McClendon
  • PUC issued draft Code of Conduct rule in Project 26201
  • PRS recommends tabling PRR 384 until final rule is issued
action items
Action Items
  • Urgent Status
    • PRR 442 – Profiling Cost Recovery
    • PRR 443 – Competitive Metering
  • Recommend Approval
    • PRR 410 – Resource Obligations during BLT
    • PRR 413 – RPRS Optimization
    • PRR 422 – OOM Zonal Dispatch Instructions
    • PRR 431 – RBS/EAL Collateral Requirements
    • PRR 439 – OOME as Instructed Deviation
  • Affirm Rejection
    • PRR 435 – Confidentiality of LSE Information
  • Affirm Recommendation to Table
    • PRR 384 – Preamble & Code of Conduct
