Chapter 9 Resource Allocation

DESCRIPTION

Chapter 9 Resource Allocation. Introduction. This chapter addresses: Trade-offs involved to crash cost Relationship between resource loading and leveling Some approaches used to solve allocation problem. Critical Path Method – Crashing a Project. One important difference between CPM & PERT:

1 / 25

Download Presentation

Chapter 9 Resource Allocation

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. Chapter 9Resource Allocation Chapter 9 Resource Allocation

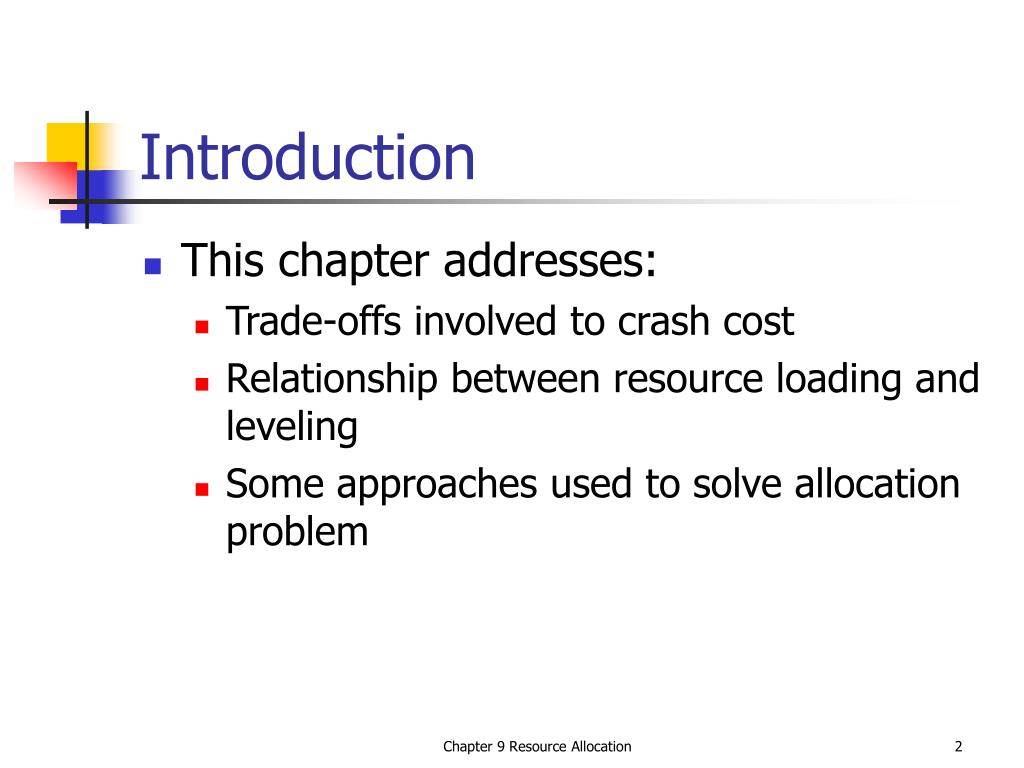

  2. Introduction • This chapter addresses: • Trade-offs involved to crash cost • Relationship between resource loading and leveling • Some approaches used to solve allocation problem Chapter 9 Resource Allocation

  3. Critical Path Method – Crashing a Project • One important difference between CPM & PERT: • CPM included a way of relating the project schedule to the level of physical resources • trade time for cost, or vice versa • Can specify 2 activity times and 2 costs • 1st time/cost combination- called normal • 2nd combination called crash • Normal – usual ‘average’ time, resources • Crash – expedite by applying additional resources Chapter 9 Resource Allocation

  4. Critical Path Method – Crashing a Project • Allocation problem requires more careful consideration-additional resources? • Many things make crashing a way of life on some projects (i.e last minutes changes in client specification, without permission to extend the project deadline by an appropriate increment) • Careful planning is critical when crashing project – need to consider feasibility of expediting work (e.g equipment availability) Chapter 9 Resource Allocation

  5. Critical Path Method – Crashing a Project Where: slope = cost per day of crashing a project When slope is negative : indicate the time required for a project is decreased, the cost is increased Slope = crash cost – normal cost crash time – normal time Chapter 9 Resource Allocation

  6. The dollars per day slope of activities is relevant only if the whole crash increment is useful • Crashing may involve a relatively simple decision to increase groups of resources (labor-shovel, Ditch-Witch Technology) • If do changes in technology tend to produce discontinuities in outcomes and also in cost. Chapter 9 Resource Allocation

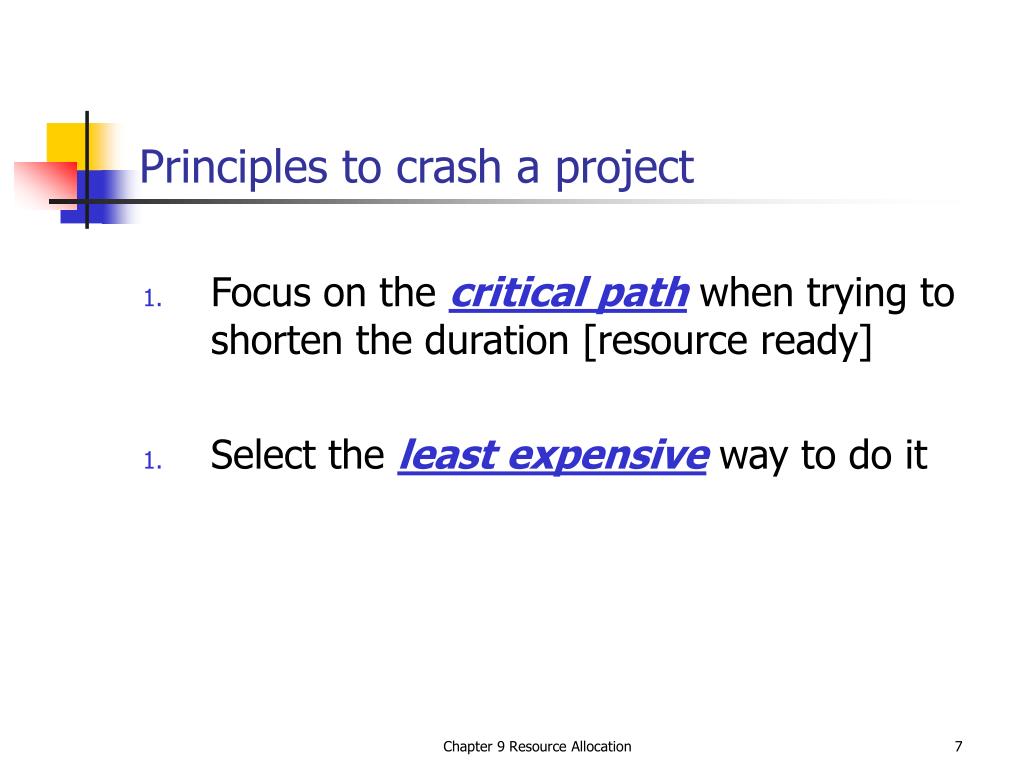

  7. Principles to crash a project • Focus on the critical path when trying to shorten the duration [resource ready] • Select the least expensive way to do it Chapter 9 Resource Allocation

  8. Crashing a Project (E.g Two-Time CPM) *Partial crashing allowed **Partial crashing not allowed Chapter 9 Resource Allocation

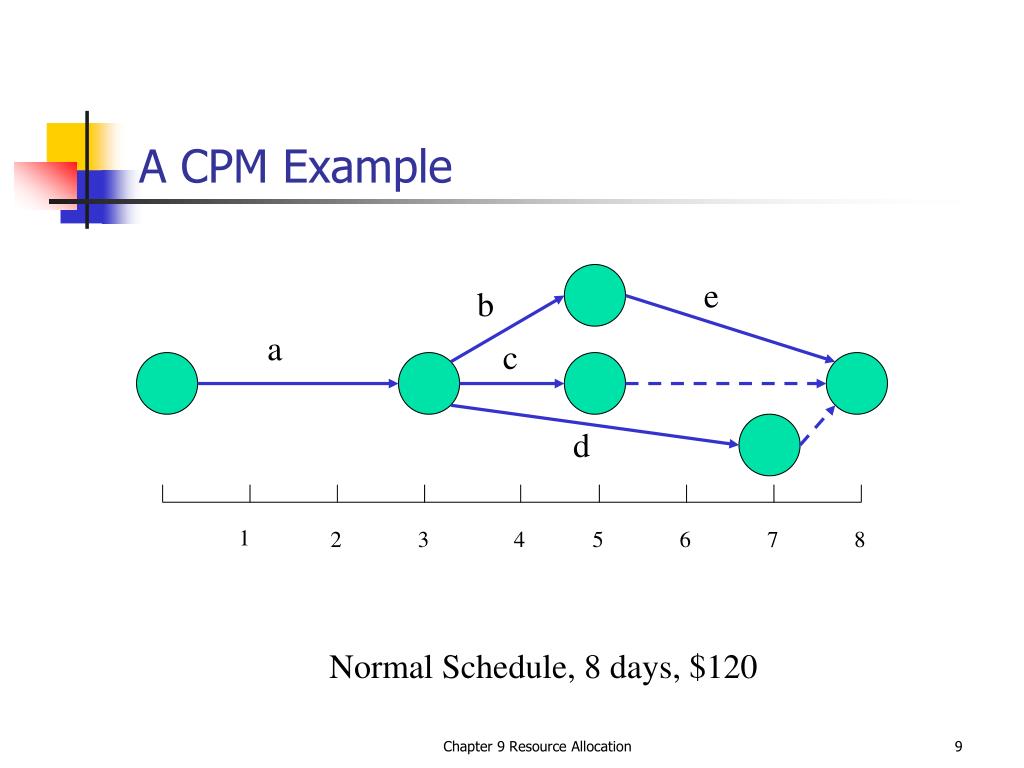

  9. e b a c d 1 2 3 4 5 6 7 8 A CPM Example Normal Schedule, 8 days, $120 Chapter 9 Resource Allocation

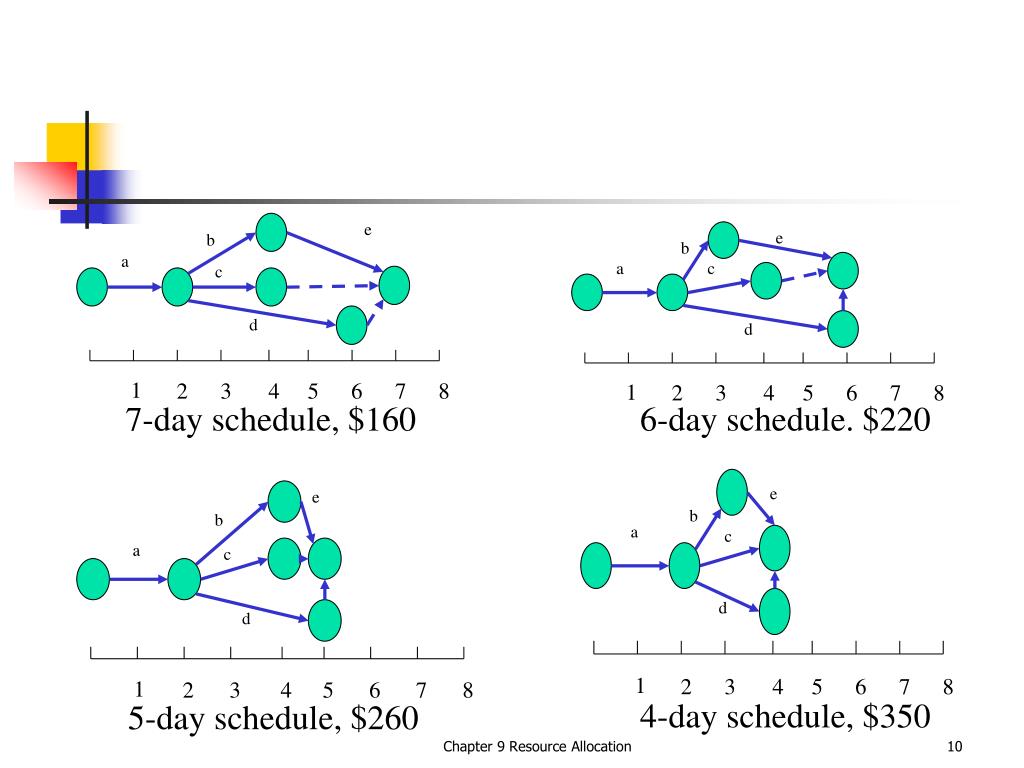

  10. e b b a a c c d d 1 1 2 3 4 5 6 7 8 2 3 4 5 6 7 8 e e b b a a c c d d 1 1 2 3 4 5 6 7 8 2 3 4 5 6 7 8 e 7-day schedule, $160 6-day schedule. $220 4-day schedule, $350 5-day schedule, $260 Chapter 9 Resource Allocation

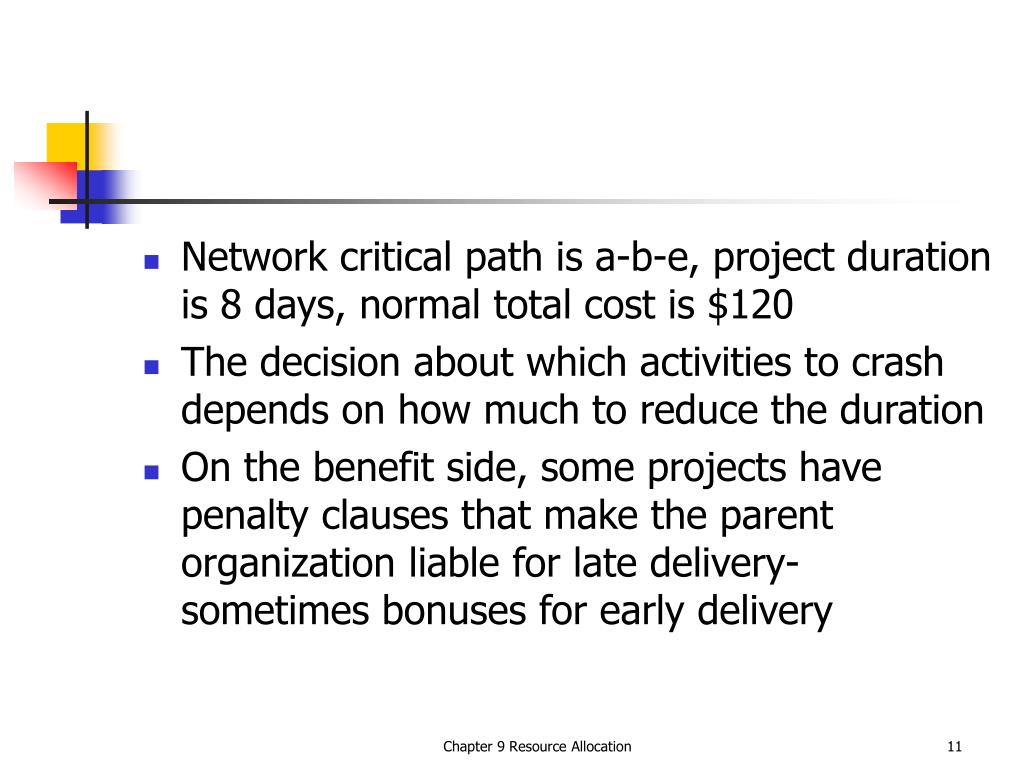

  11. Network critical path is a-b-e, project duration is 8 days, normal total cost is $120 • The decision about which activities to crash depends on how much to reduce the duration • On the benefit side, some projects have penalty clauses that make the parent organization liable for late delivery- sometimes bonuses for early delivery Chapter 9 Resource Allocation

  12. On the cost side, figure below shows the time/cost relationship of crashing the project All crash a + b + 2d + 2e a + d + 2e - b a + b a All normal Chapter 9 Resource Allocation

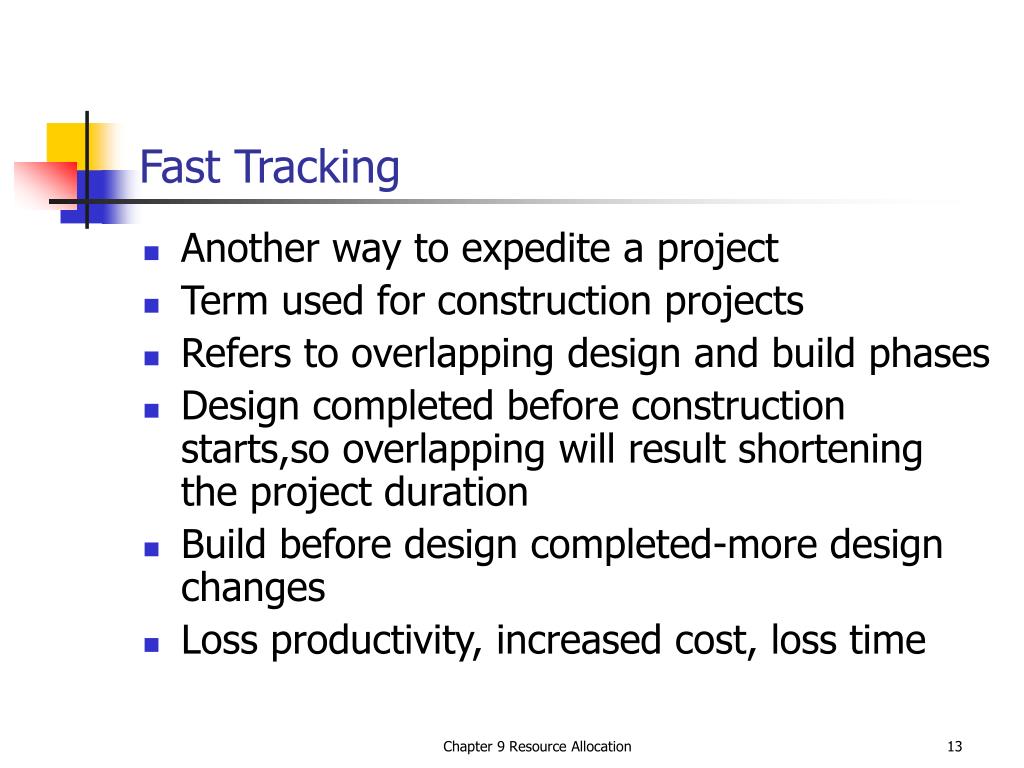

  13. Fast Tracking • Another way to expedite a project • Term used for construction projects • Refers to overlapping design and build phases • Design completed before construction starts,so overlapping will result shortening the project duration • Build before design completed-more design changes • Loss productivity, increased cost, loss time Chapter 9 Resource Allocation

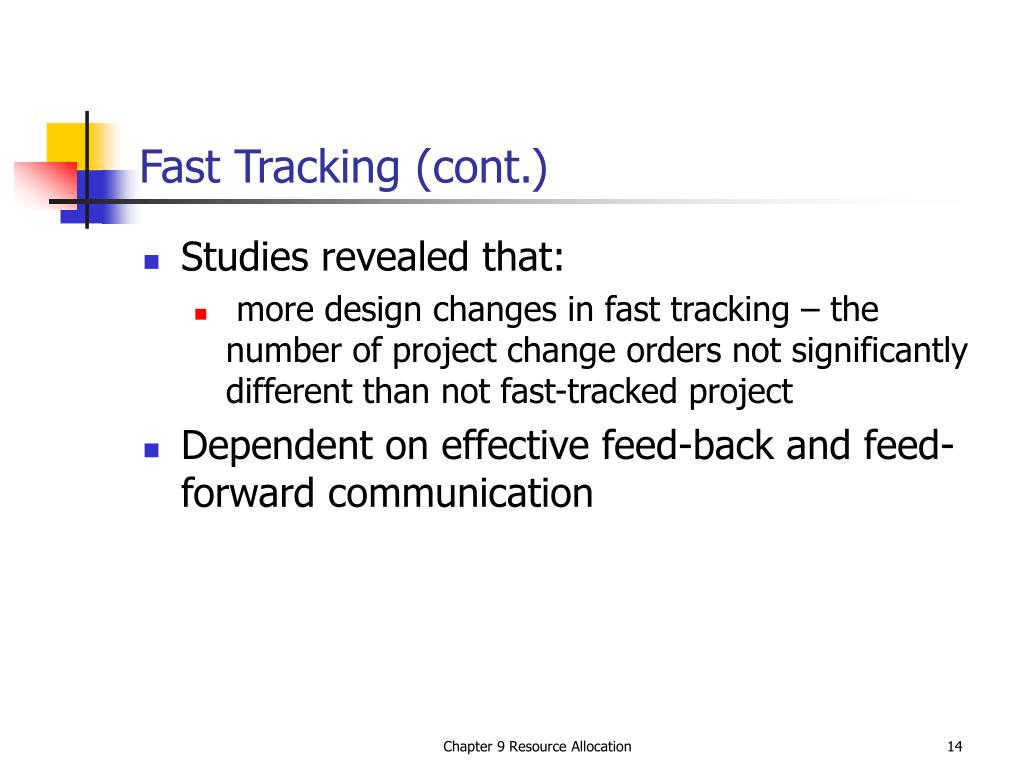

  14. Fast Tracking (cont.) • Studies revealed that: • more design changes in fast tracking – the number of project change orders not significantly different than not fast-tracked project • Dependent on effective feed-back and feed-forward communication Chapter 9 Resource Allocation

  15. 2 d a c 1 4 b e 3 SOLVED PROBLEM Find the lowest cost to complete the project in 10 days Chapter 9 Resource Allocation

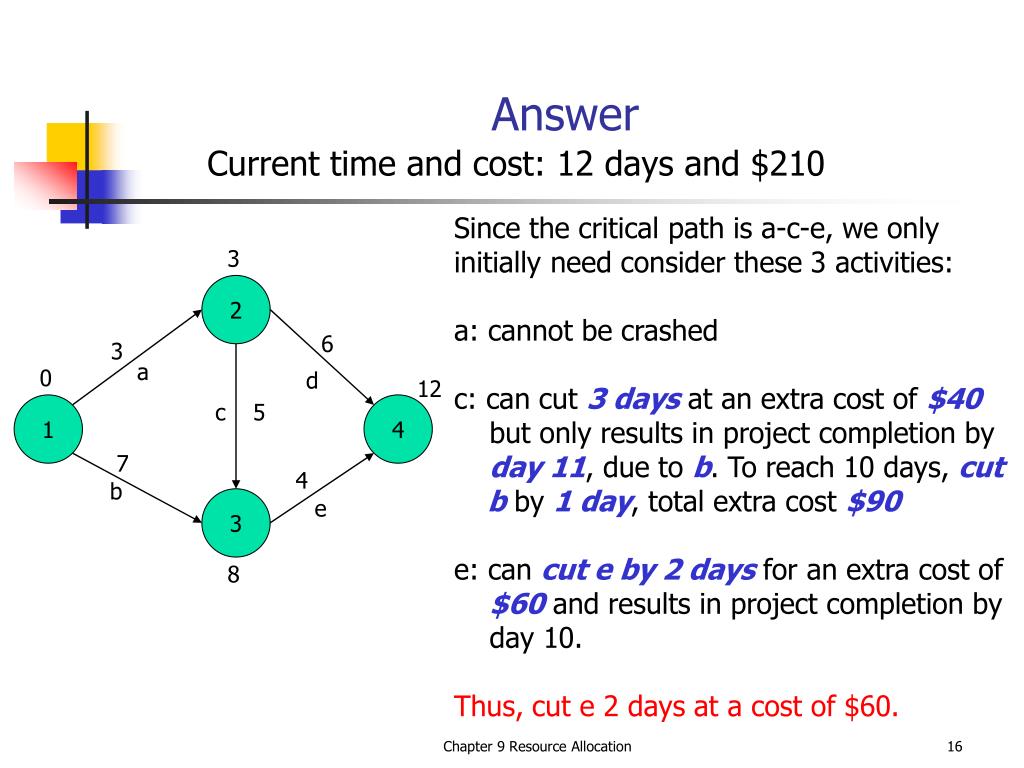

  16. 3 2 6 3 a 0 d 12 c 5 1 4 7 4 b 3 e 8 Answer Current time and cost: 12 days and $210 Since the critical path is a-c-e, we only initially need consider these 3 activities: a: cannot be crashed c: can cut 3 daysat an extra cost of$40 but only results in project completion by day 11, due to b. To reach 10 days, cut b by 1 day, total extra cost$90 e: can cut e by 2 days for an extra cost of $60 and results in project completion by day 10. Thus, cut e 2 days at a cost of $60. Chapter 9 Resource Allocation

  17. RESOURCE ALLOCATION PROBLEM • A fundamental measure of the PM’s success in project mgmt is the skill with which the trade-offs among performance, time and cost are managed • The extreme points of the relationship between time use and resource are: • Time limited • Resource limited Chapter 9 Resource Allocation

  18. RESOURCE LOADING • The amount of individuals resources an existing schedule requires during specific time periods • Resource loading can be illustrated by: • Resource usage calendar • Modified PERT/CPM AOA diagram (similar with Gantt Chart) • PM responsibility: • Demand for resources does not exceed resource capacities • Ensure that the required resources, in the required amounts Chapter 9 Resource Allocation

  19. Resource Usage Calendar Chapter 9 Resource Allocation

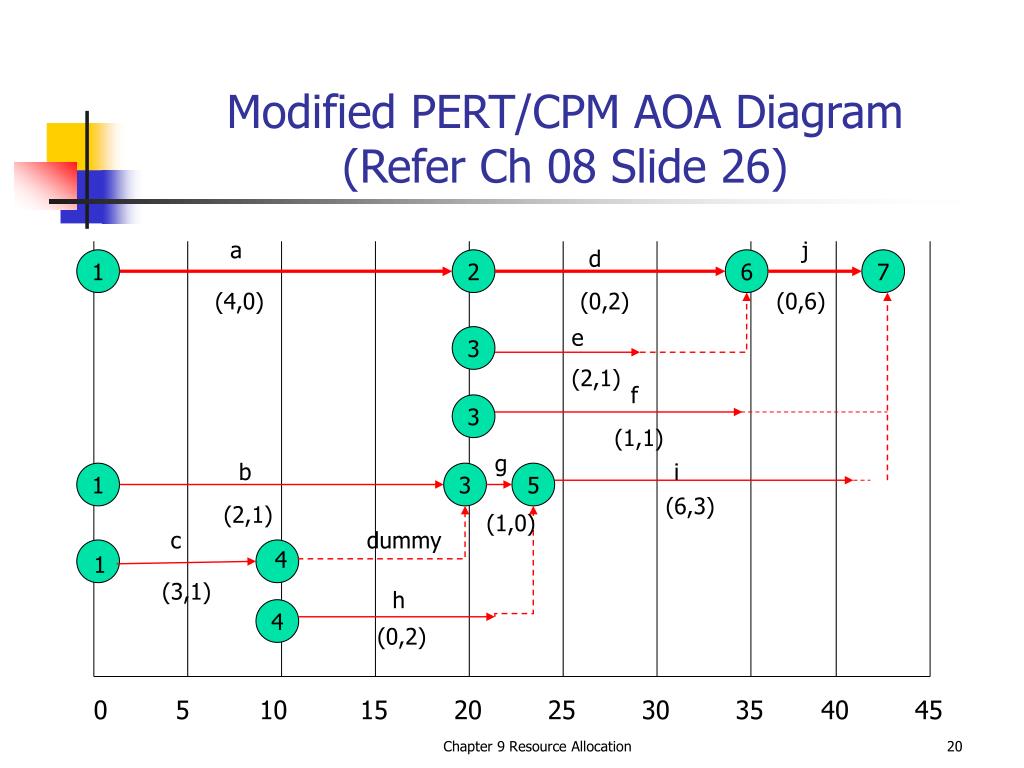

  20. a j d 1 2 6 7 (4,0) (0,2) (0,6) e 3 (2,1) f 3 (1,1) g b i 1 3 5 (6,3) (2,1) (1,0) c dummy 4 1 (3,1) h 4 (0,2) 0 5 10 15 20 25 30 35 40 45 Modified PERT/CPM AOA Diagram(Refer Ch 08 Slide 26) Chapter 9 Resource Allocation

  21. RESOURCE LEVELING • Aims to minimize the period-by-period variations in resource loading by shifting tasks within their slack allowances • Purpose to create a smoother distribution of resource usage • Advantages; • Much less hands on management • Be able to use ‘just in time’ inventory policy with right quantity delivered • If the resource being leveled is people, it improves morale and results in fewer problems in the personnel and payroll offices Chapter 9 Resource Allocation

  22. E.g: Network 2 a, 2 [2] c, 5 1 4 [4] b, 3 [2] 3 The activity time is shown above the arc, and resource usage (one resource, workers) is in brackets below the arc. Chapter 9 Resource Allocation

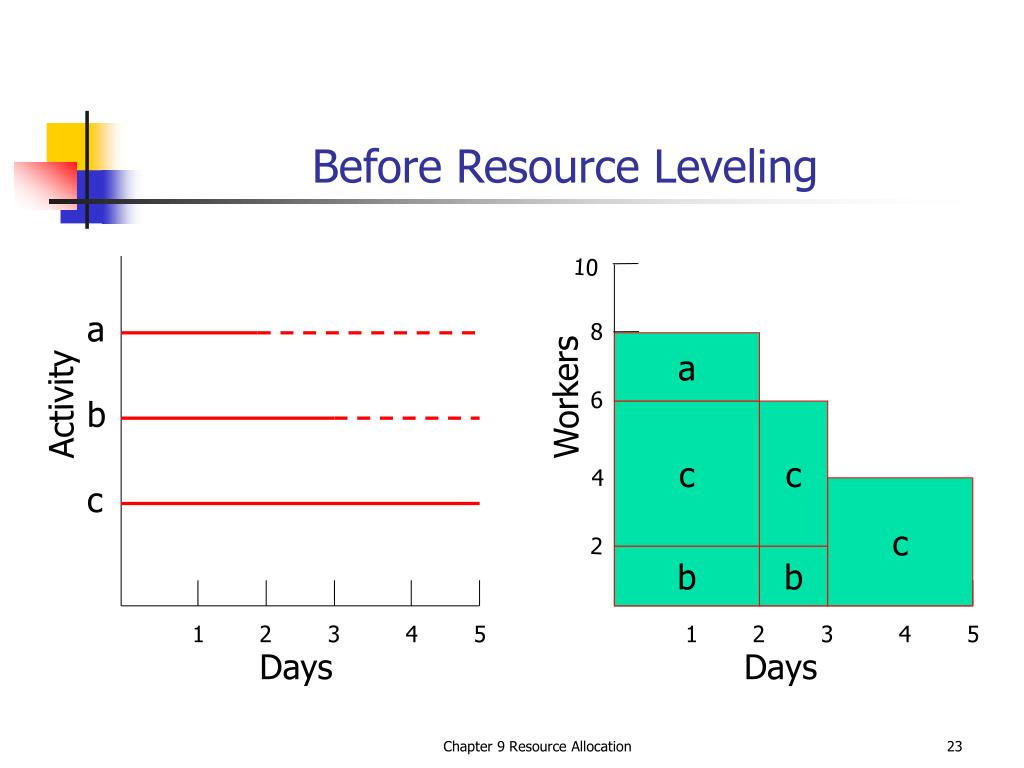

  23. 10 a 8 a 6 b c c 4 c c 2 b b 1 2 3 4 5 1 2 3 4 5 Days Before Resource Leveling Activity Workers Days Chapter 9 Resource Allocation

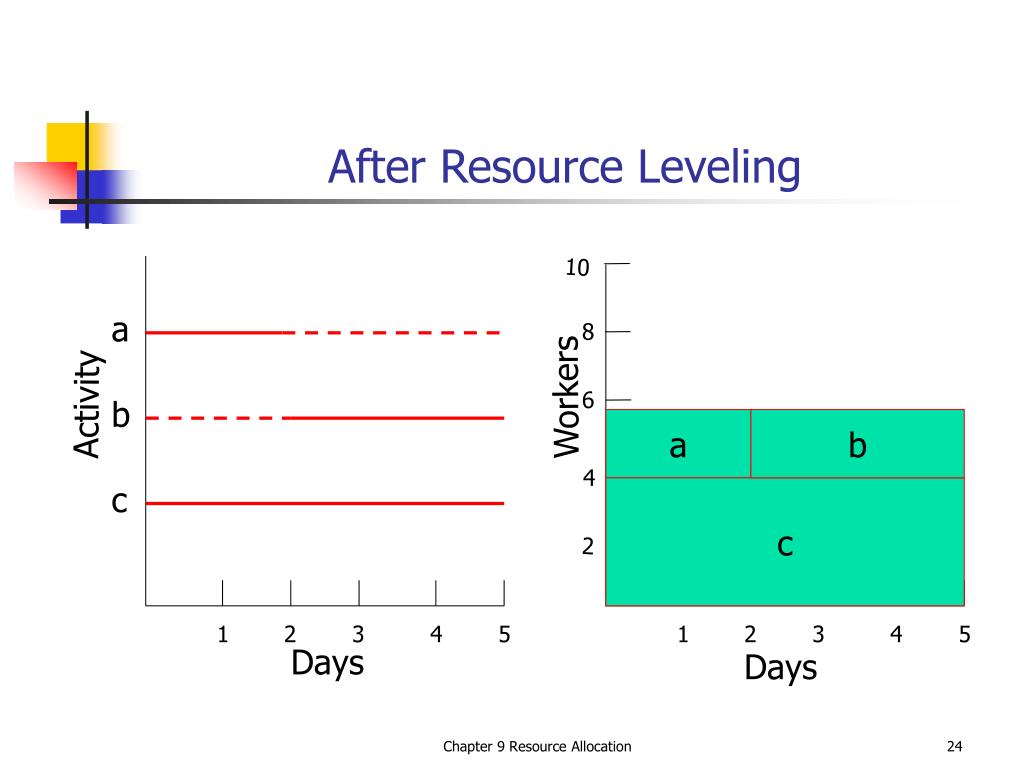

  24. a Activity b c 1 2 3 4 5 Days After Resource Leveling 10 8 Workers 6 a b 4 c 2 1 2 3 4 5 Days Chapter 9 Resource Allocation

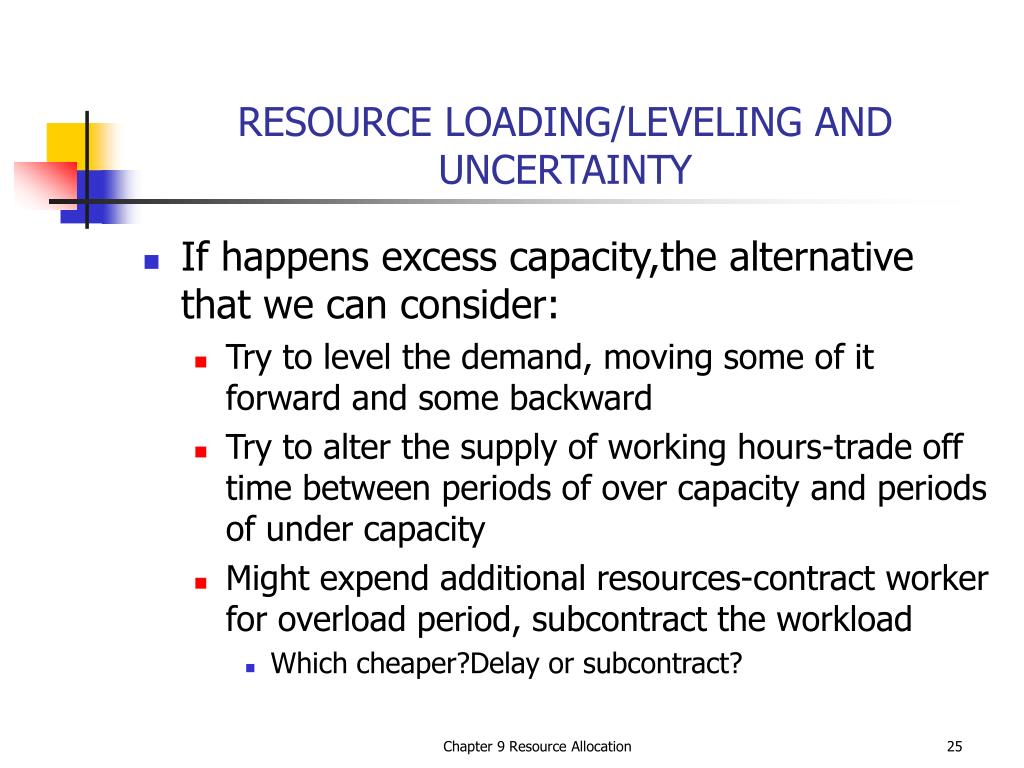

  25. RESOURCE LOADING/LEVELING AND UNCERTAINTY • If happens excess capacity,the alternative that we can consider: • Try to level the demand, moving some of it forward and some backward • Try to alter the supply of working hours-trade off time between periods of over capacity and periods of under capacity • Might expend additional resources-contract worker for overload period, subcontract the workload • Which cheaper?Delay or subcontract? Chapter 9 Resource Allocation
