DataTAG – WP4& GLUE A.Ghiselli DataGrid PTB, 10 April 2002 ESA

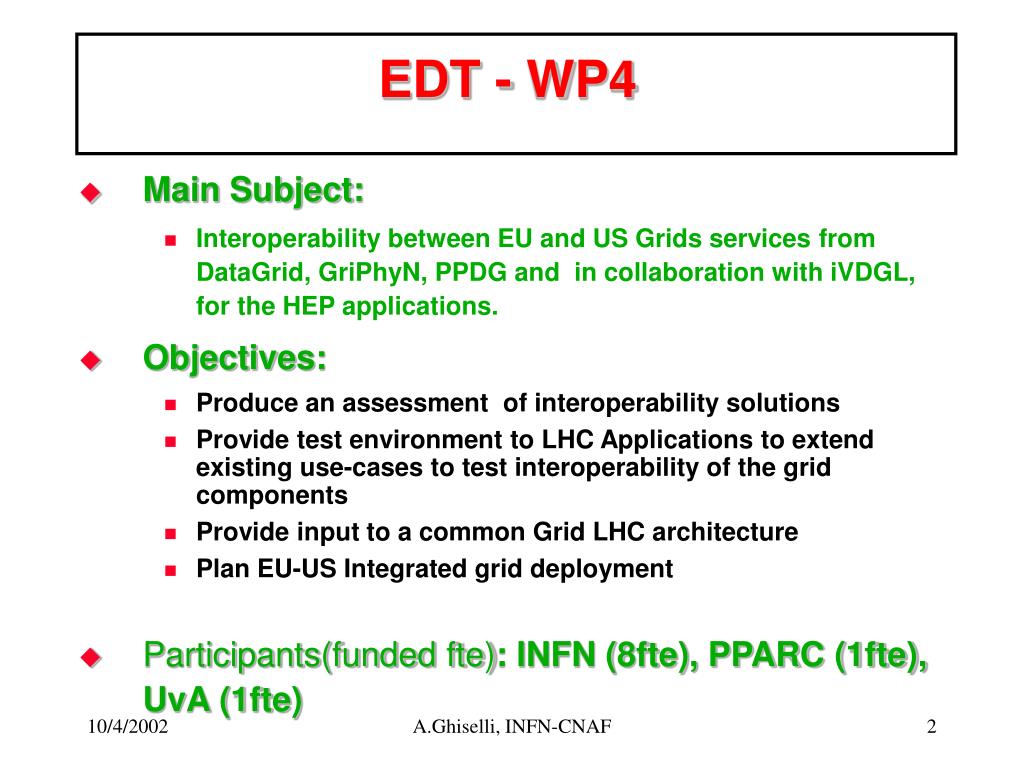

EDT - WP4 • Main Subject: • Interoperability between EU and US Grids services from DataGrid, GriPhyN, PPDG and in collaboration with iVDGL, for the HEP applications. • Objectives: • Produce an assessment of interoperability solutions • Provide test environment to LHC Applications to extend existing use-cases to test interoperability of the grid components • Provide input to a common Grid LHC architecture • Plan EU-US Integrated grid deployment • Participants(funded fte): INFN (8fte), PPARC (1fte), UvA (1fte) A.Ghiselli, INFN-CNAF
WP4 Taskswp managers A.Ghiselli, C.Vistoli Assuming the same grid basic services (gram,gsi,gris) between the differen grid projects, the main issues are: • 4.1 resource discovery, coord. C.Vistoli • 4.2 security/authorization, coord. R.Cecchini • 4.3 interoperability of collective services between EU-US grid domains, coord. F.Donno • 4.4 test applications, contact people from each application : • Atlas L.Perini, CMS C.Grandi, Alice P.Cerello, CDF S.Belforte A.Ghiselli, INFN-CNAF

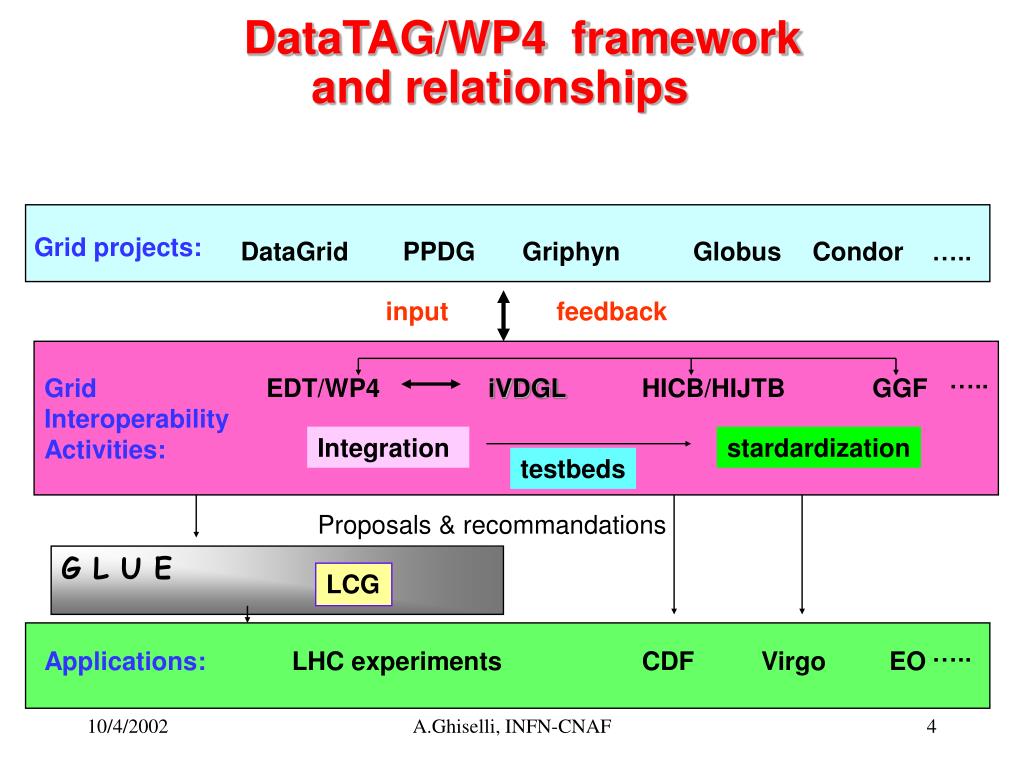

….. Grid Interoperability Activities: EDT/WP4 iVDGL HICB/HIJTB GGF Integration stardardization testbeds ….. Applications: LHC experiments CDF Virgo EO DataTAG/WP4 framework and relationships Grid projects: DataGrid PPDG Griphyn Globus Condor ….. input feedback Proposals & recommandations G L U E LCG A.Ghiselli, INFN-CNAF
EDT/WP4 – iVDGL contacts • Security (task 4.1) • R.Cecchini <---> D.Olson • Information discovery (task 4.2) • C.Vistoli <----> J.Schopf, B.Tierney • Grid Middleware (task 4.3) • F.Donno <----> R.Pordes, R.Cavanaugh A.Ghiselli, INFN-CNAF

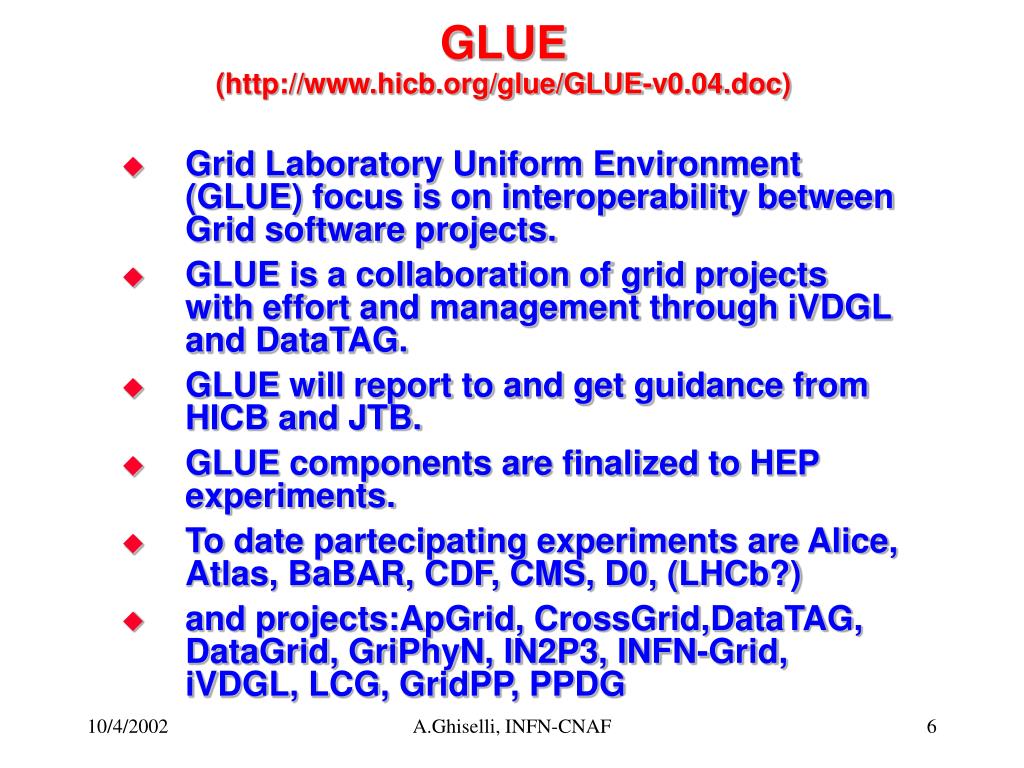

GLUE(http://www.hicb.org/glue/GLUE-v0.04.doc) • Grid Laboratory Uniform Environment (GLUE) focus is on interoperability between Grid software projects. • GLUE is a collaboration of grid projects with effort and management through iVDGL and DataTAG. • GLUE will report to and get guidance from HICB and JTB. • GLUE components are finalized to HEP experiments. • To date partecipating experiments are Alice, Atlas, BaBAR, CDF, CMS, D0, (LHCb?) • and projects:ApGrid, CrossGrid,DataTAG, DataGrid, GriPhyN, IN2P3, INFN-Grid, iVDGL, LCG, GridPP, PPDG A.Ghiselli, INFN-CNAF

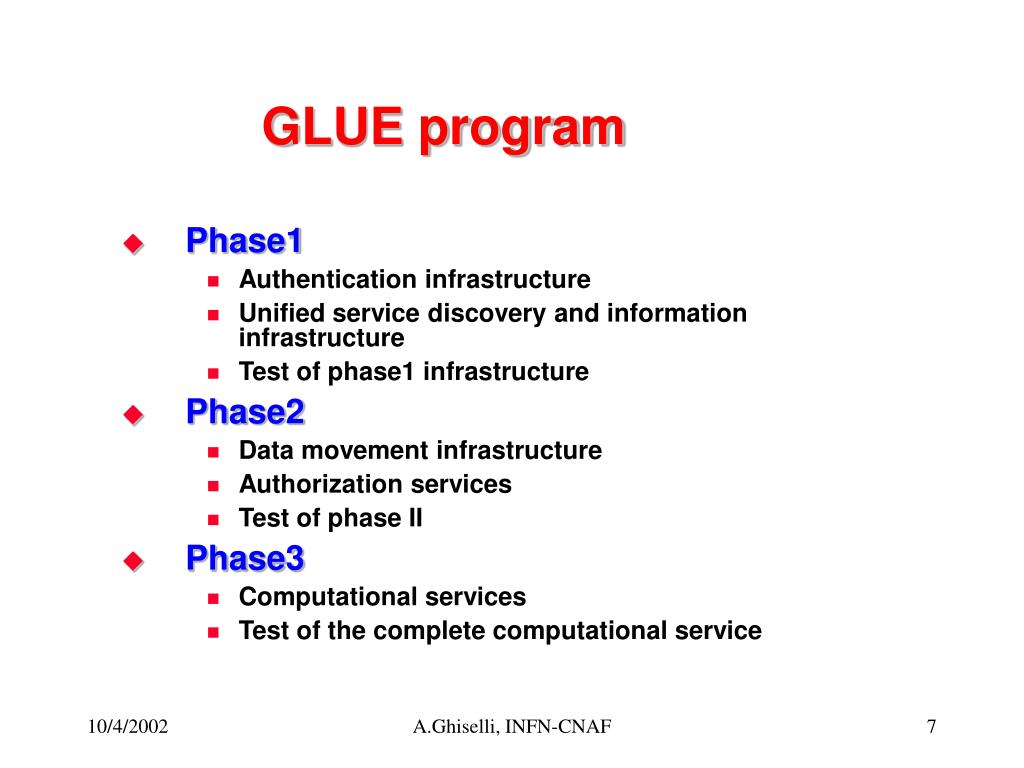

GLUE program • Phase1 • Authentication infrastructure • Unified service discovery and information infrastructure • Test of phase1 infrastructure • Phase2 • Data movement infrastructure • Authorization services • Test of phase II • Phase3 • Computational services • Test of the complete computational service A.Ghiselli, INFN-CNAF

Glue Schedule • Feb 2002: test interoperating certificates between US and Europe. Done • May 2002: review of common resource discovery schema. In progress • …………………… • …………………………. A.Ghiselli, INFN-CNAF
Common schemas for the US and EU Grid projectswork coordinated by J.Schopf, B.Tierney, C.Vistoliwith the collaboration of Globus, PPDG, EDG WP managersunder the ombrella of JTBsummary from the document: • A schema refers to a description of objects and attributes needs to describe grid resources and the relationships between the objects • Computing element (CE): one or more similar machines managed by a single scheduler/job queue • Storage Element (SE): any data storage that is registred in a GIS,…. • Network Element ……. A.Ghiselli, INFN-CNAF

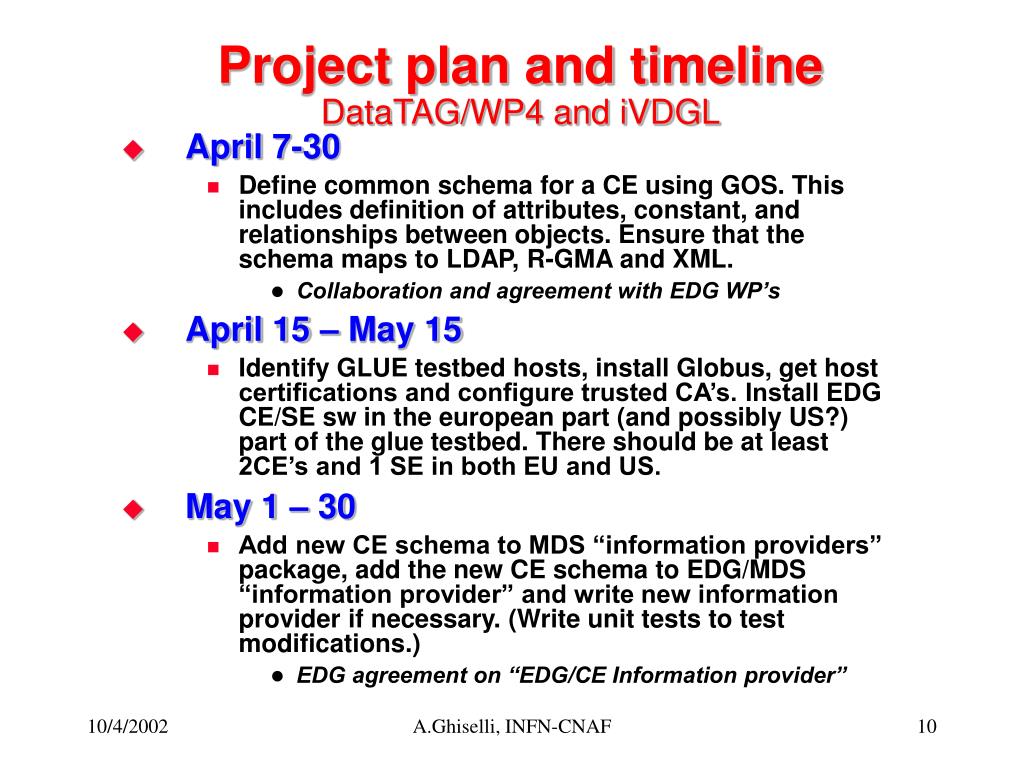

Project plan and timelineDataTAG/WP4 and iVDGL • April 7-30 • Define common schema for a CE using GOS. This includes definition of attributes, constant, and relationships between objects. Ensure that the schema maps to LDAP, R-GMA and XML. • Collaboration and agreement with EDG WP’s • April 15 – May 15 • Identify GLUE testbed hosts, install Globus, get host certifications and configure trusted CA’s. Install EDG CE/SE sw in the european part (and possibly US?) part of the glue testbed. There should be at least 2CE’s and 1 SE in both EU and US. • May 1 – 30 • Add new CE schema to MDS “information providers” package, add the new CE schema to EDG/MDS “information provider” and write new information provider if necessary. (Write unit tests to test modifications.) • EDG agreement on “EDG/CE Information provider” A.Ghiselli, INFN-CNAF

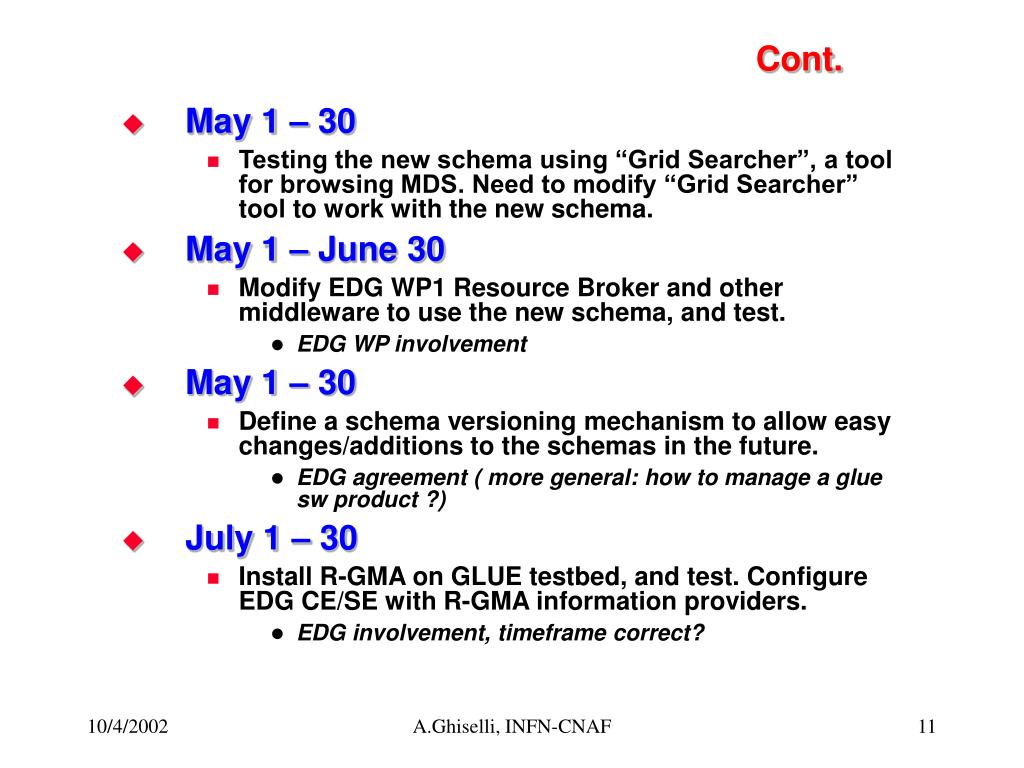

Cont. • May 1 – 30 • Testing the new schema using “Grid Searcher”, a tool for browsing MDS. Need to modify “Grid Searcher” tool to work with the new schema. • May 1 – June 30 • Modify EDG WP1 Resource Broker and other middleware to use the new schema, and test. • EDG WP involvement • May 1 – 30 • Define a schema versioning mechanism to allow easy changes/additions to the schemas in the future. • EDG agreement ( more general: how to manage a glue sw product ?) • July 1 – 30 • Install R-GMA on GLUE testbed, and test. Configure EDG CE/SE with R-GMA information providers. • EDG involvement, timeframe correct? A.Ghiselli, INFN-CNAF
Cont. • July 1 – 30 • Modify R-GMA equivalent to “Grid Searcher” to work with the new schema (if it does not exist). • June 1 – 30 • Define common schema for Storage Element in GOS and repeat verification steps • July 1 – 30 • Define common schema for Network Element in GOS and repeat verification steps • August • More testing • September • Deploy on EDG testbed 2 (?) • EDG work A.Ghiselli, INFN-CNAF

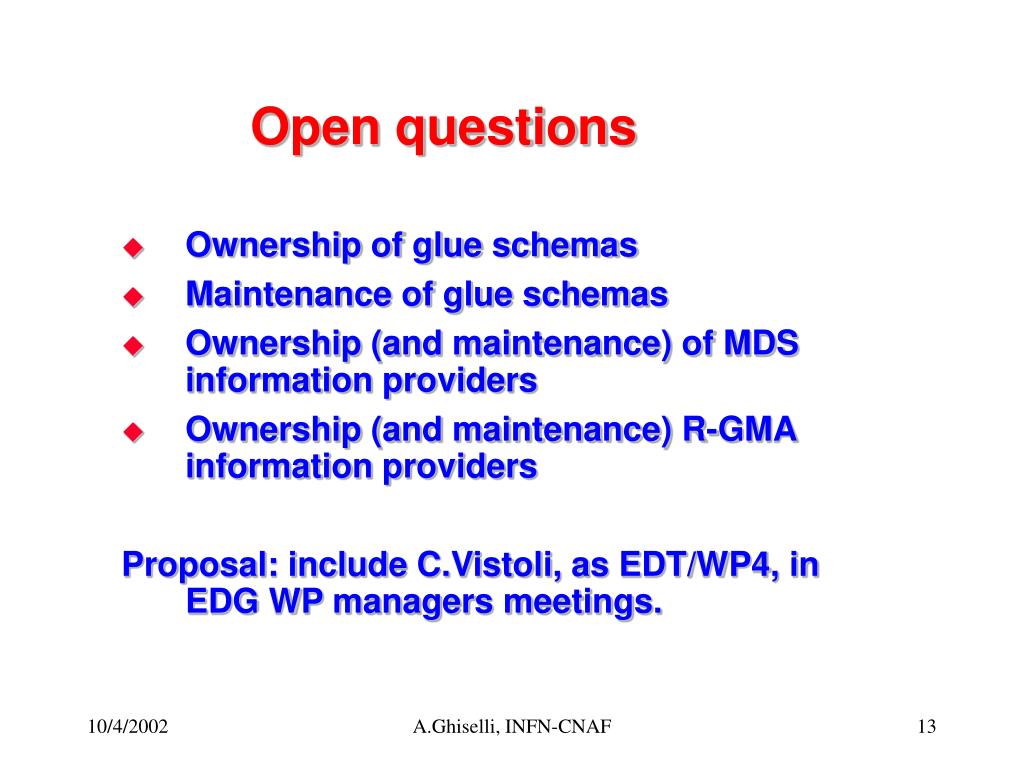

Open questions • Ownership of glue schemas • Maintenance of glue schemas • Ownership (and maintenance) of MDS information providers • Ownership (and maintenance) R-GMA information providers Proposal: include C.Vistoli, as EDT/WP4, in EDG WP managers meetings. A.Ghiselli, INFN-CNAF
DataTag Grid HW Resources • CE, SE, VO services, glue schema tests and CAS test in Cnaf • CE, SE in Padova, Milano, Torino • CE in Trieste and Bologna A.Ghiselli, INFN-CNAF
iVDGL / DataTAG joint meeting26 april Chicago, agenda • 8:30 am DataTAG WP4 -iVDGL collaboration introduction - Ruth/Antonia • 8:45am GLUE Schema iVDGL status and plans - Jenny • 8:55am DataTAG support for the common schema tests and DataGrid integration - Cristina • 9:10 VO grid environment set up and preliminary CAS tests report - Roberto • 9:40 Short term DataTAG program for experiment grid integration - Flavia • 10:10 iVDGL Experiment and Laboratory Testbeds - Rob 10:30 Break • 11:00 Existing Packaging and deployment tools, first comparison and evaluation - Flavia • 11:15 VDT packaging and installation - Alain - this will have been covered earlier in the week but we will have some datatag people participating by video...? 11:30 Discussion of EDG and VDT commonality, interoperability and next steps in DataTAG, iVDGL collaboration - all A.Ghiselli, INFN-CNAF
