Critical Path Method

DESCRIPTION

Critical Path Method. Farrokh Alemi, Ph.D. Purpose of CPM. Finish fast Quantify progress Communicate effectively. Advantages and Disadvantages of Formal Schedules . Saves time and money on large complex projects Effective communication tool Too much work Assessment of duration of tasks

1 / 40

Download Presentation

Critical Path Method

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. Critical Path Method Farrokh Alemi, Ph.D.

  2. Purpose of CPM • Finish fast • Quantify progress • Communicate effectively

  3. Advantages and Disadvantages of Formal Schedules • Saves time and money on large complex projects • Effective communication tool • Too much work • Assessment of duration of tasks • Assessment of interdependencies

  4. Resource Oriented and Time Oriented Schedules • Resource oriented • Time oriented

  5. Elements of a Critical Path Chart • Activity • Precedence • Duration/cost

  6. Elements of a Critical Path Chart • Activity • Precedence • Duration/cost

  7. Elements of a Critical Path Chart • Activity • Precedence • Duration/cost

  8. Elements of a Critical Path Chart • Activity • Precedence • Duration/cost

  9. Elements of a Critical Path Chart • Activity • Precedence • Duration/cost

  10. Elements of a Critical Path Chart • Activity • Precedence • Duration/cost

  11. Branch and Node Charts • Activity on branch • Activity on node

  12. Activity In Node A E G B F C D

  13. Activity On Branches A B E F G 1 5 6 7 End 3 Start C D 2 4

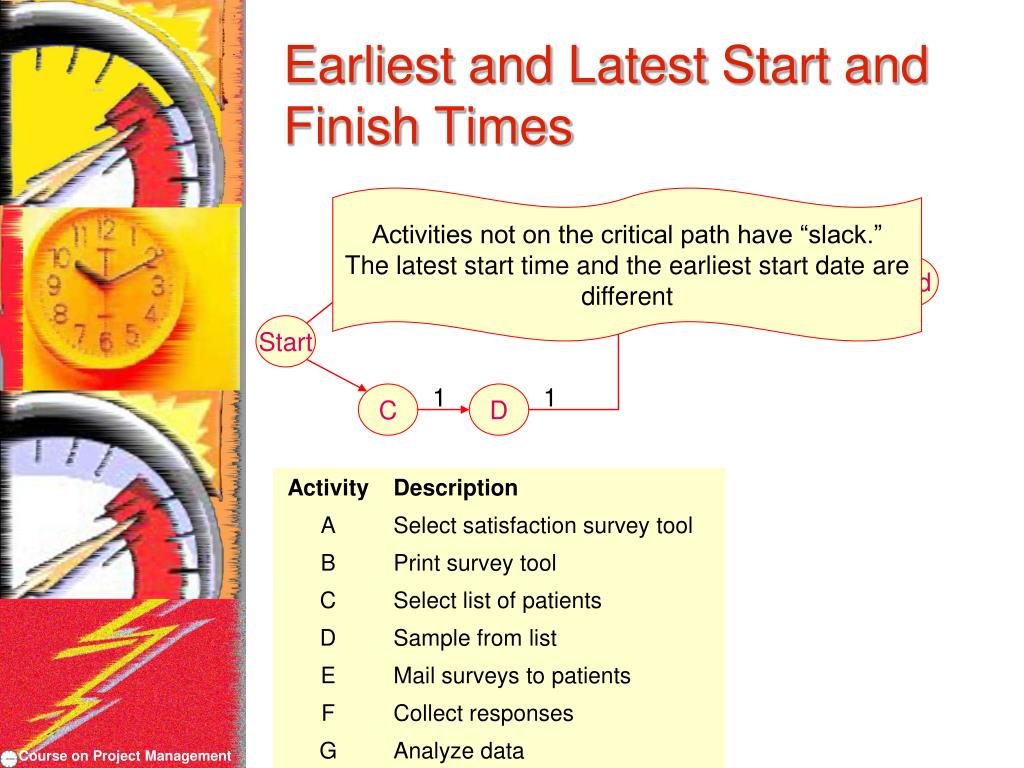

  14. Earliest and Latest Start and Finish Times A 2 3 E 2 4 G 3 End B F Start C 1 D 1

  15. Earliest and Latest Start and Finish Times Forward pass calculates early start and finish A 2 3 E 2 4 G 3 End B F Start C 1 D 1

  16. Earliest and Latest Start and Finish Times Backward pass calculates latest start and end times A 2 3 E 2 4 G 3 End B F Start C 1 D 1

  17. Earliest and Latest Start and Finish Times Critical Path includes activities where earliest start time and latest start time are equal A 2 3 E 2 4 G 3 End B F Start C 1 D 1

  18. Earliest and Latest Start and Finish Times Activities not on the critical path have “slack.” The latest start time and the earliest start date are different A 2 3 E 2 4 G 3 End B F Start C 1 D 1

  19. Earliest and Latest Start and Finish Times A 2 3 E 2 4 G 3 End B F Start C 1 D 1

  20. Earliest and Latest Start and Finish Times A 2 3 E 2 4 G 3 End B F Start C 1 D 1

  21. Earliest and Latest Start and Finish Times A 2 3 E 2 4 G 3 End B F Start C 1 D 1

  22. Earliest and Latest Start and Finish Times A 2 3 E 2 4 G 3 End B F Start C 1 D 1

  23. Earliest and Latest Start and Finish Times A 2 3 E 2 4 G 3 End B F Start C 1 D 1

  24. Earliest and Latest Start and Finish Times A 2 3 E 2 4 G 3 End B F Start C 1 D 1

  25. Earliest and Latest Start and Finish Times A 2 3 E 2 4 G 3 End B F Start C 1 D 1

  26. Earliest and Latest Start and Finish Times A 2 3 E 2 4 G 3 End B F Start C 1 D 1 Latest finish is the minimum of latest start of succeeding tasks. Latest start is the latest finish minus duration.

  27. Earliest and Latest Start and Finish Times A 2 3 E 2 4 G 3 End B F Start C 1 D 1 Latest finish is the minimum of latest start of succeeding tasks. Latest start is the latest finish minus duration.

  28. Earliest and Latest Start and Finish Times A 2 3 E 2 4 G 3 End B F Start C 1 D 1

  29. Earliest and Latest Start and Finish Times A 2 3 E 2 4 G 3 End B F Start C 1 D 1

  30. Slack Time A 2 3 E 2 4 G 3 End B F Start C 1 D 1 Slack time = Latest start – Earliest start

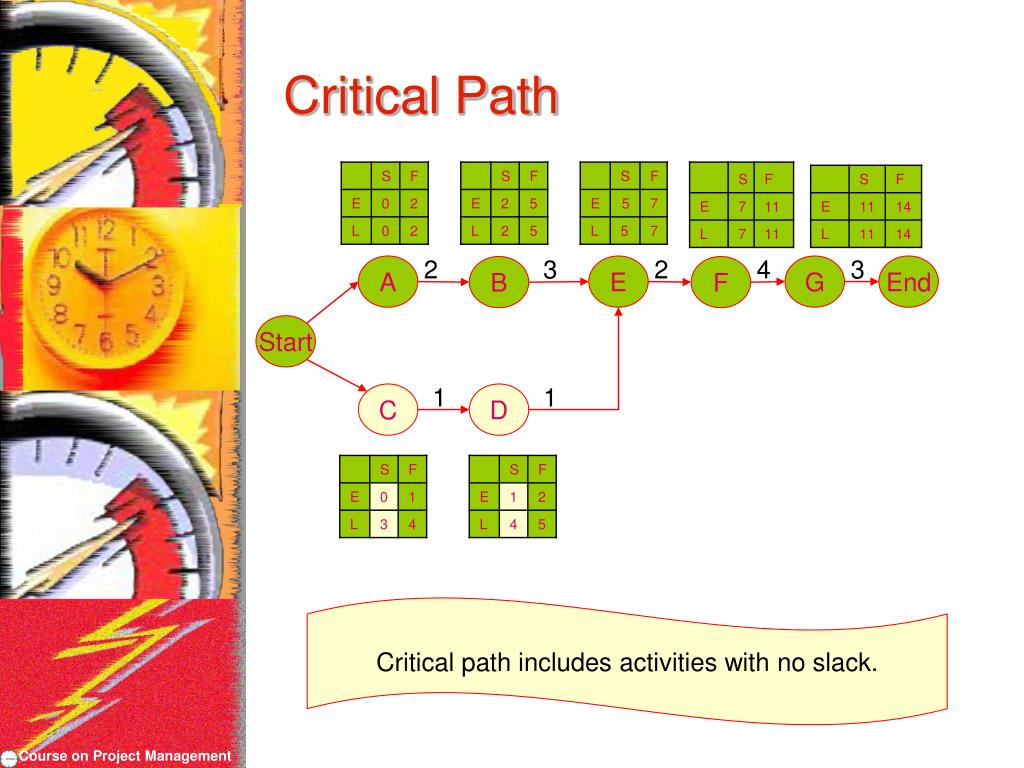

  31. Critical Path A 2 3 E 2 4 G 3 End B F Start C 1 D 1 Critical path includes activities with no slack.

  32. Communicating Project Schedule • Time scaled network of activities • Gantt chart • Time an activity graphs and completion graphs

  33. Communicating Project Schedule • Time scaled network of activities • Gantt chart • Time an activity graphs and completion graphs

  34. Communicating Project Schedule • Time scaled network of activities • Gantt chart • Time an activity graphs and completion graphs

  35. Activity Splitting A E G B F C D

  36. Activity Splitting A E G B F C D

  37. Activity Splitting A E G B F1 C D F2

  38. Software • Discovery of Critical Path

  39. Crashing Schedules • Cost time tradeoff • Order of crashing

  40. Take Home Lesson The critical path includes activities with no slack
