260 likes | 428 Views
Apex Information Systems Anuja Jahagirdar Jason Miller Amol Kakade Priyanka Akella Bhaumik Shah. Project Execution and Monitoring and Control. Project. Title: Medical Insurance Management System Start Date: 07 Feb,2011 Finish Date: 25 April,2011 Manager: Anuja Jahagirdar .
E N D
Apex Information Systems AnujaJahagirdar Jason Miller AmolKakade PriyankaAkella Bhaumik Shah Project Execution and Monitoring and Control

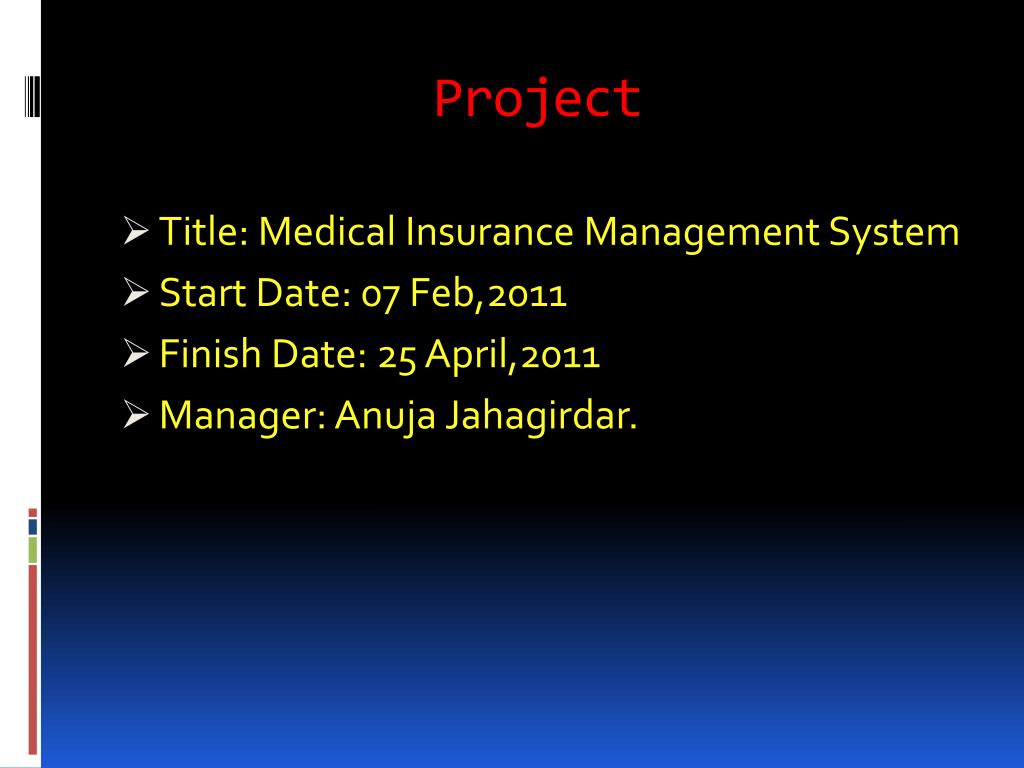

Project • Title: Medical Insurance Management System • Start Date: 07 Feb,2011 • Finish Date: 25 April,2011 • Manager: AnujaJahagirdar.
Project Objective The main objective of the project is to create a unique and convenient software solution for handling insurance related issues medical professionals have to deal with. To create an Information system that can handle the details of multiple insurance companies at the same time.

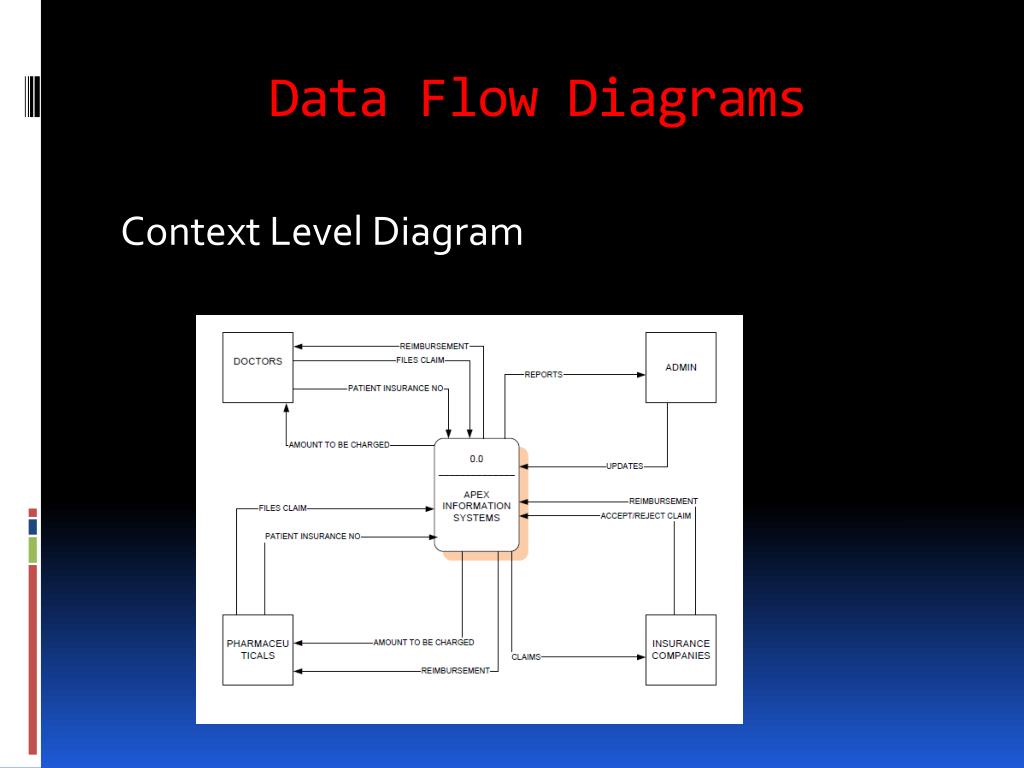

Data Flow Diagrams Context Level Diagram

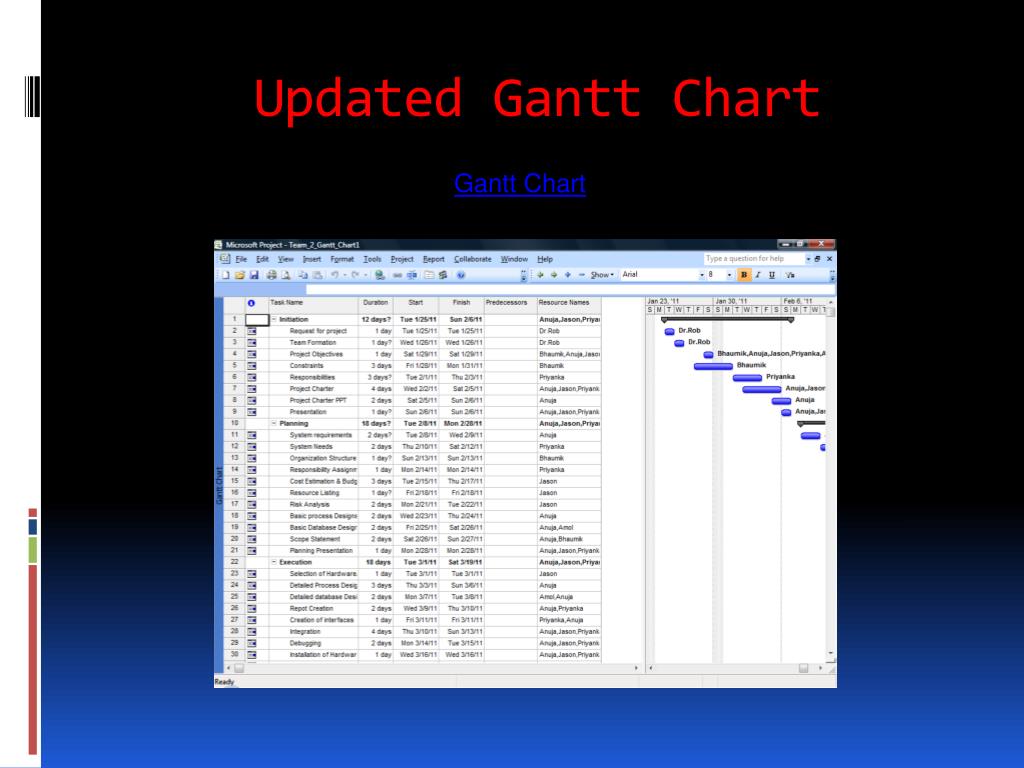

Updated Gantt Chart Gantt Chart

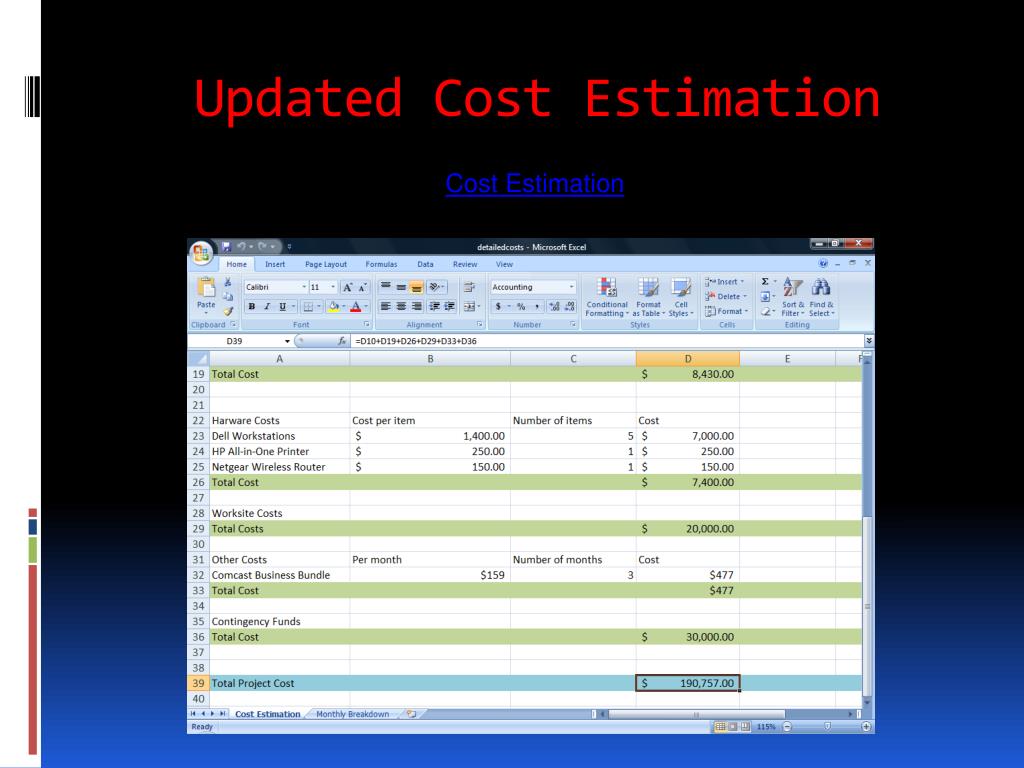

Updated Cost Estimation Cost Estimation
Updated Resource Listing • Hardware: • 5 Dell workstations • 1 HP all-in-one printer • Netgear Wireless Router • Software: • Microsoft Office Suite • Microsoft Project • Microsoft Visio • Adobe Creative Suite • Microsoft Visual Studio 2010

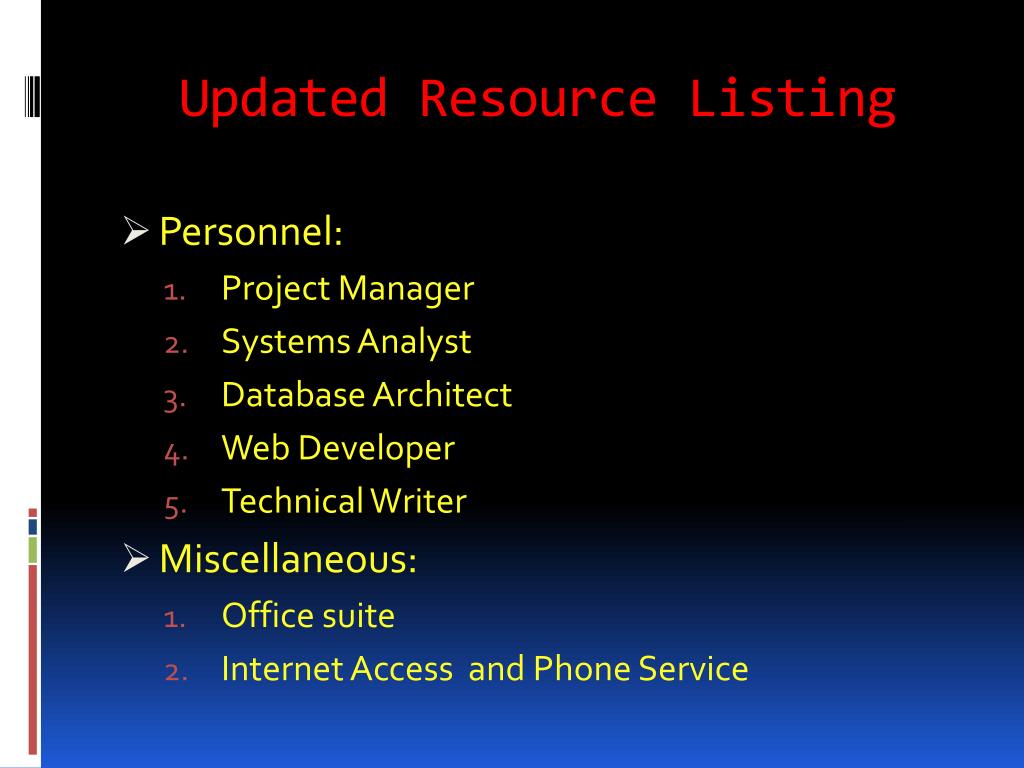

Updated Resource Listing • Personnel: • Project Manager • Systems Analyst • Database Architect • Web Developer • Technical Writer • Miscellaneous: • Office suite • Internet Access and Phone Service

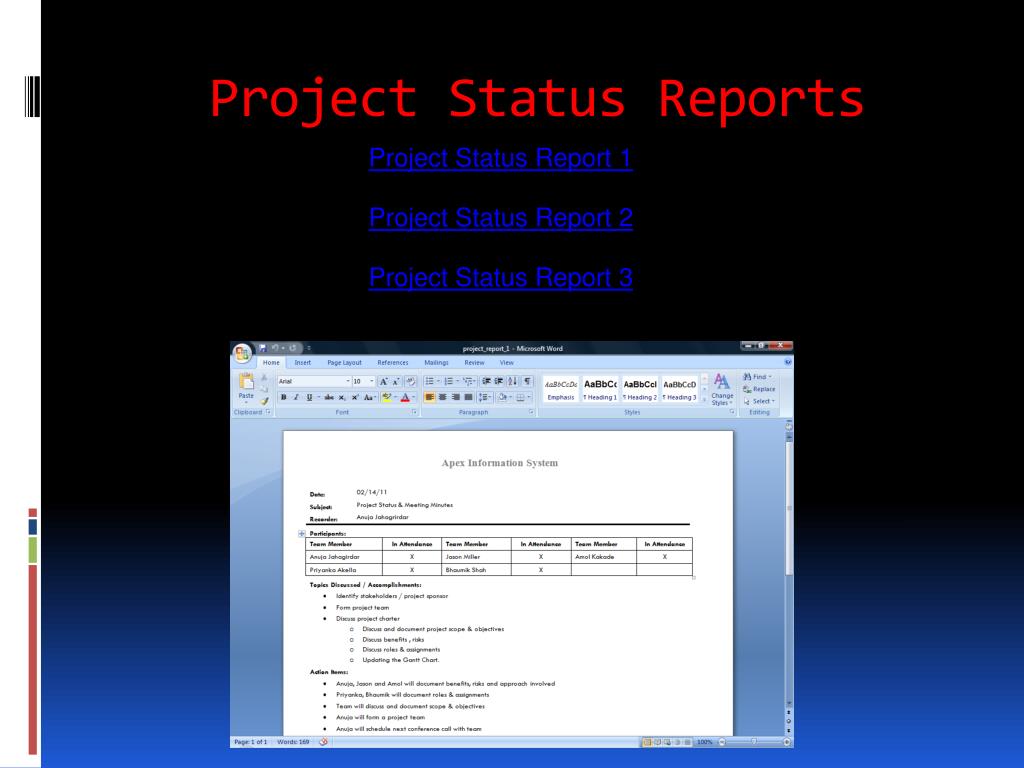

Project Status Reports Project Status Report 1 Project Status Report 2 Project Status Report 3
Quality Assurance Document Quality Assurance Document
Milestone Reports Milestone Report
