  1. DPW Procurement Bidding and Contracts Project Bid Submittals

  2. Project Bid Submittals • Plans and Specs • Table of Content • Bid Data Sheet • Bid Release Assessment Checklist • Bid Release Sheet

  3. Electronic Files of the Plans & Specs • Specifications • One (1) PDF File per Volume • Plans/Drawings • One(1) PDF File per Volume • Table of Content • Check withus for the latest version • Word Document

  4. Assessment Checklist

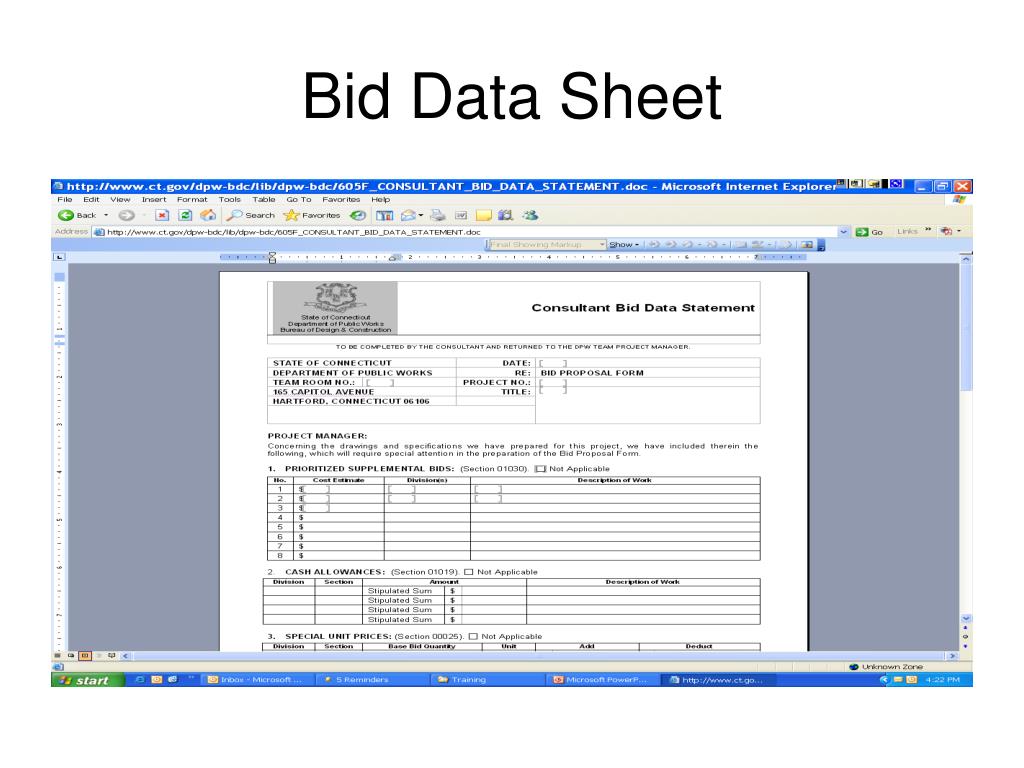

  5. Bid Data Sheet

  6. Bid Release • http://www.ct.gov/dpw%2Dbdc/site/default.asp • Bid Stagelink • Bid Releaselink • Bid Release Assessment Checklist • Bid Release Procedures/Instructions - tab • Form 600 – tab - The Bid Release Sheet

  7. Bid Release Sheet

  8. Procedures/Instructions

  9. DAS Pre-qualification Classification • DAS Pre-qualification is only required for projects with an estimated value over $500,000. • If you use more than one classification then make sure you are clear whether you mean one or the other or both. • For example, • Use “or” for either • Use “and” for both • I prefer one classification

  10. DAS Pre-qualification Classification • The classification isin the “Invitation To Bid” • The Biddermust be DAS Pre-certified in the classificationon the Invitation To Bid • Make sure you review the DAS List and its definitionsbefore entering a classification – they are part of Bid Release Sheet Procedures

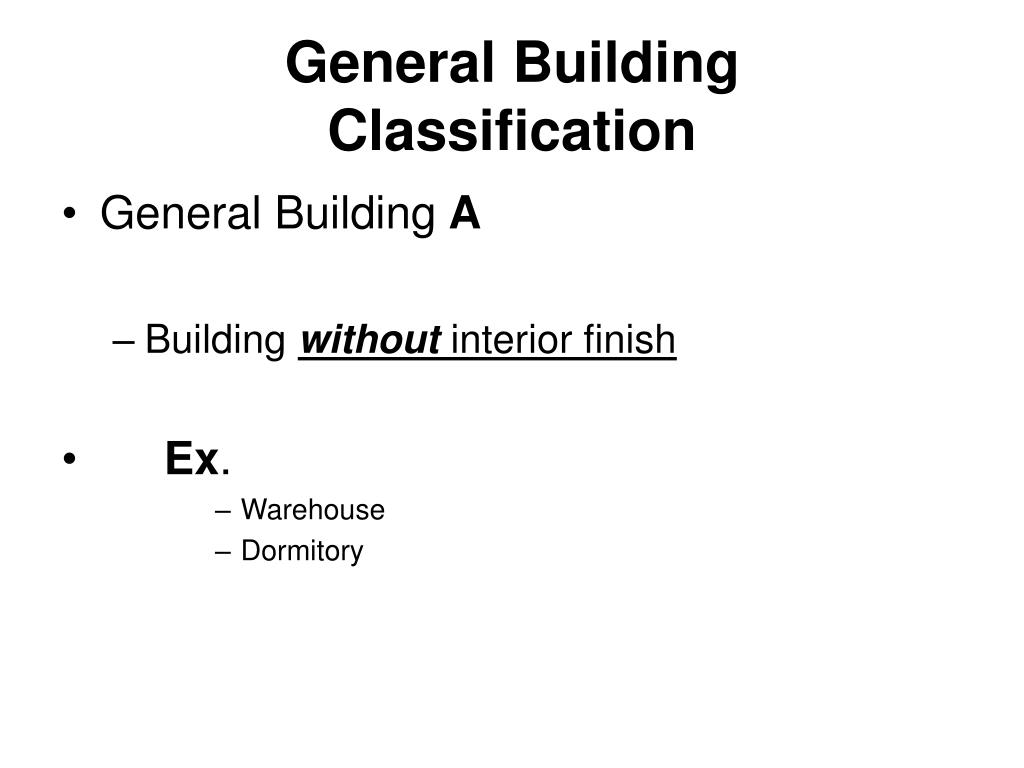

  11. General Building Classification • General Building A • Building without interior finish • Ex. • Warehouse • Dormitory

  12. General Building Classification • Gen. Bldg. Const. B • Buildingwith INTERIOR FINISH • Ex. • Office Buildings • Classrooms • Adm. Offices • Auditoriums

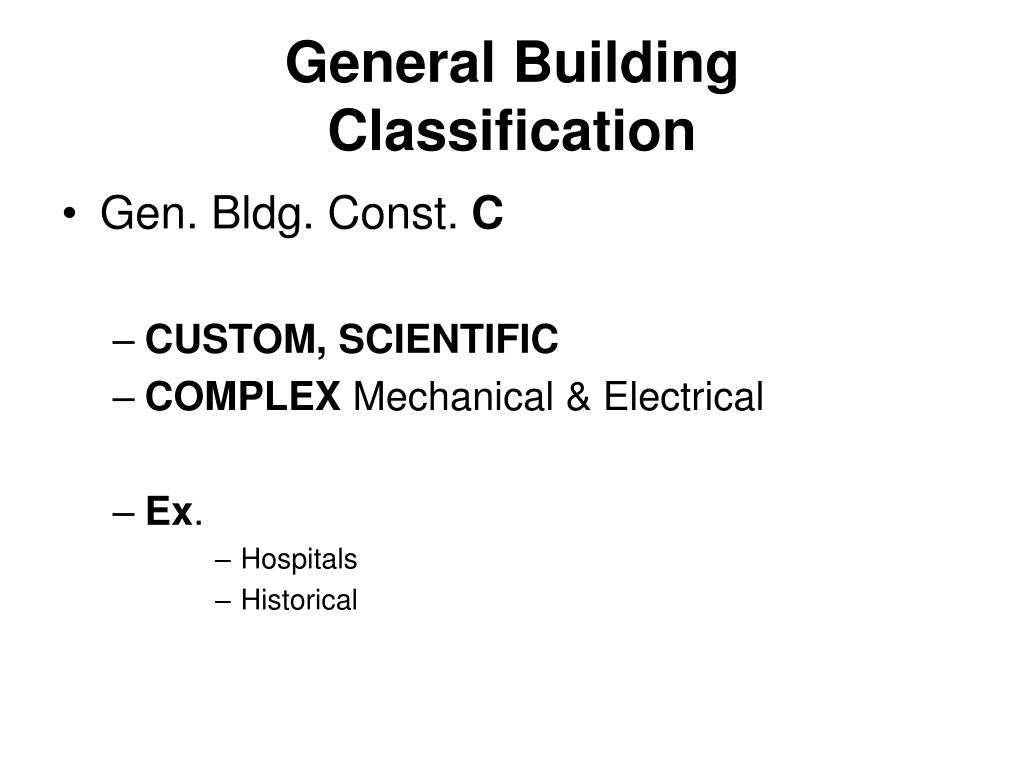

  13. General Building Classification • Gen. Bldg. Const. C • CUSTOM, SCIENTIFIC • COMPLEX Mechanical & Electrical • Ex. • Hospitals • Historical

  14. Supplementals • Onlyup to the Maximum Available Amount. • This means that in your Bid Release, the Base plus the Supplementals should not exceed the Maximum Available Amount. • Make sure that the base and supplemental calculations in the Bid Release Sheet match with those in the Data Sheet.

  15. Date Planning Began • CGS 4-252(e) requirement for purchases at $50,000 or more • For bonded projects this is the date B100S was accepted

  16. Funding Authorized • Date • Section

  17. Pre-bid Meeting • If the pool of bidders is limited and you make the pre-bid meeting mandatory then chances are that you may need to rebid. • Make sure that you only allow SBSA contractors in pre-bid conference for SBSA projects (most Informals)

  18. Sub-trades • The sub-trades are for formal projects, those over $500,000 and the individual sub-trades over $25,000 • The sub-trades should only be the four (4) noted in the statue: • Electrical • Mechanical other than HVAC • HVAC • Masonry

  19. Set-aside Waiver • Set-aside waivers are request from Bruce Bockstael, Chief Architect • You must explain in detail and verify your justification for your request for a Set-aside Waiver.

  20. Special Requirements • Any special requirement is intent for information that the bidders should know up-front before they bid because it may cause their bid to be rejected. • This information will be place in the Invitation To Bid. • So anything you want on the Invitation to Bid put it here.

  21. Insurances • Builders Risk • Special Hazard • Asbestos Abatement • Type "X", "C", "U" – Explosion, Collapse, Underground in accordance with Article 35 of the General Conditions.

  22. Unit Prices • Make sure that the Unit Prices in the Bid Release Sheet match with those in the Data Sheet.

  23. Additional Remarks • Additional remarks are NOT made part of the Invitation to Bid. • Let us know here if the GC will be required to have asbestos removed.

  24. Asbestos Abatement By GC • Attached the Report.

  25. Addenda • Addenda must be submitted with enough time for the Bidding and Contracts staff to post on the Web site - this is seven (7) days in advance • NO addenda on Fridays • Addenda issues through AFAO

  26. Addenda • Bureau of Design & Construction Intranet • Bid Stagelink • Addendum Format link • Addendum Transmittal link

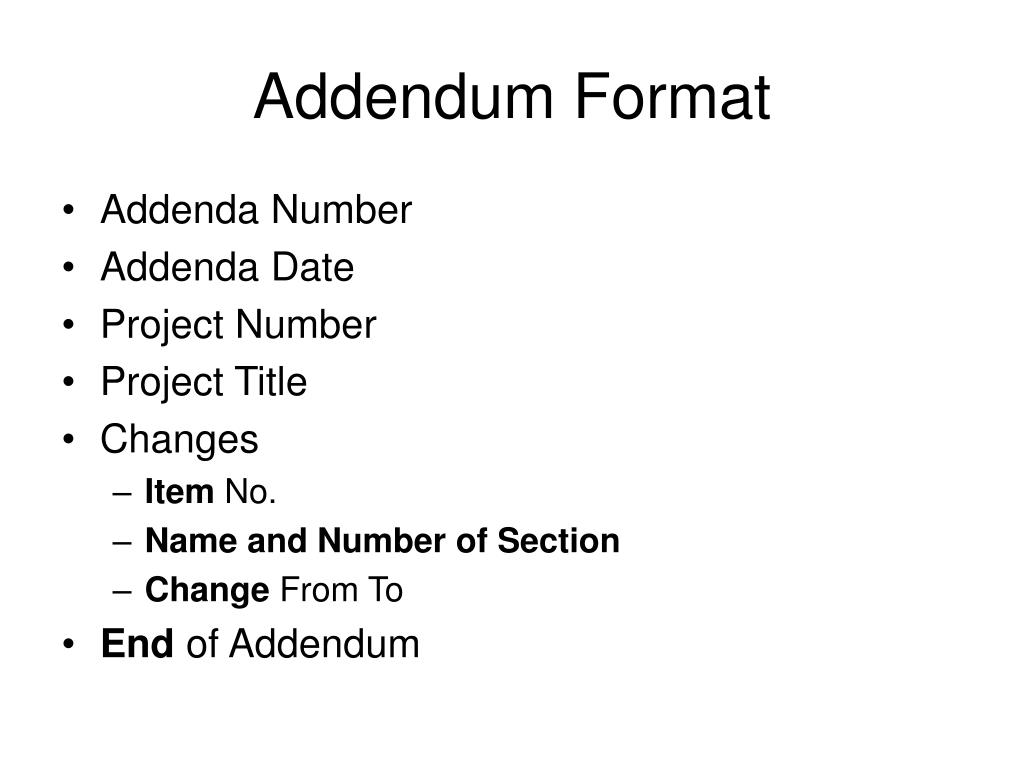

  27. Addendum Format

  28. Addendum Format • Addenda Number • Addenda Date • Project Number • Project Title • Changes • Item No. • Name and Number of Section • Change From To • End of Addendum

  29. Sequence of Changes • Changes to PRIOR ADDENDA • Changes to BIDDING REQUIREMENTS • Changes to GENERAL CONDITIONS • Changes to SPECIFICATIONS/Technical Section • Changes to DRAWINGS/PLANS

  30. Addendum Transmittal

  31. Addenda • Before you submit an addendum consider the future consequences • For example, some addenda generated more addenda that in turn reverse the previous addenda • In one project, the outcome was ten (10) addenda • In this same project, some items were supposed to be color code but this was not communicated; thus, requiring another addendum

  32. Recommend

  33. Start Date Notice to Proceed

  34. Milestones • Bid Opening • Set-aside Schedule • Contractors Qualification Reviews • Recommends • Affirmative Action Plan [cc PMs] – CHRO approval • Bond Commission Funding Approval or Transfer posted • Letter of Intent[cc PMs] - Contract Documents • Contract Approval – Project Clearance Memo [to PMs] • Construction Schedule Approval • Start Date & Notice To Proceed

  35. Time Line After Bid Opening • Set-aside Schedule – 10 Days • Affirmative Action Plan • Contractor file w/i 30 days, CHRO accept or reject w/i 60 days • Recommends (?) • Bond Commission Funding Approval (?) • Letter of Intent – 15 Days • Contract Package – 2 days • Contract Approval – 2 weeks • Legal • Commissioner • AG’s – average of 7 Days • Project Clearance Memo (?)

  36. Efficiency • Project managers are copied on the AAP Letter, Letter of Intent, and are notified of the award via the Clearance Memo. • Inquiries to fiscal officers for information they already provided time away from processing. • Please be brief with your inquiries and comments to the fiscal officers.

  37. Efficiency • Please allow the staff to go through the bidding and contracting process for your request. • Are we there yet? • Please keep in mind that the staff is working on multiple projects.

  38. Questions
