Berkeley NEST Wireless OEP David Culler, Shankar Sastry, Eric Brewer, Kris Pister, David Wagner Unversity of California, Berkeley
Administrative • Secure Language-Based Adaptive Service Platform (SLAP) for Large-Scale Embedded Sensor Networks • PM: Vijay Raghavan • PIs: • David Culler, culler@cs.berkeley.edu • Eric Brewer, brewer@cs.berkeley.edu • David Wagner, daw@cs.berkeley.edu • Shankar Sastry, sastry@eecs.berkeley.edu • Kris Pister, pister@eecs.berkeley.edu • University of California, Berkeley • Award Start Date: 6/1/01 • Award End Date: 10/31/04 • Agent Name and Organization:Juan Carbonell, AFWL NEST PI Meeting - Berkeley OEP

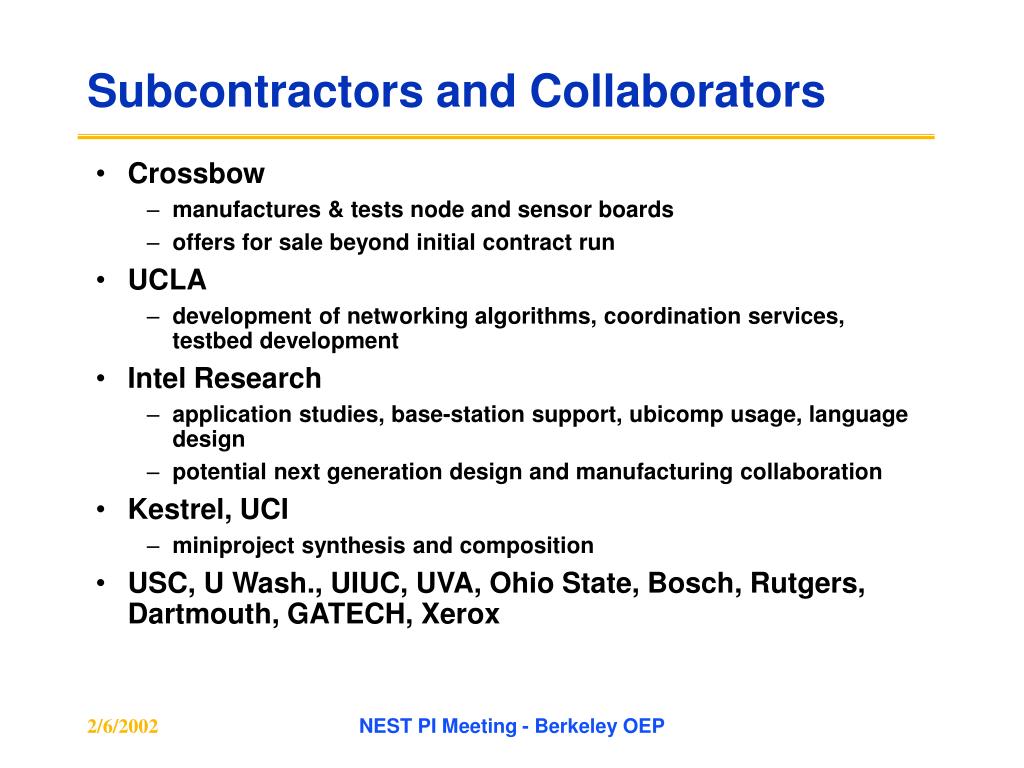

Subcontractors and Collaborators • Crossbow • manufactures & tests node and sensor boards • offers for sale beyond initial contract run • UCLA • development of networking algorithms, coordination services, testbed development • Intel Research • application studies, base-station support, ubicomp usage, language design • potential next generation design and manufacturing collaboration • Kestrel, UCI • miniproject synthesis and composition • USC, U Wash., UIUC, UVA, Ohio State, Bosch, Rutgers, Dartmouth, GATECH, Xerox NEST PI Meeting - Berkeley OEP

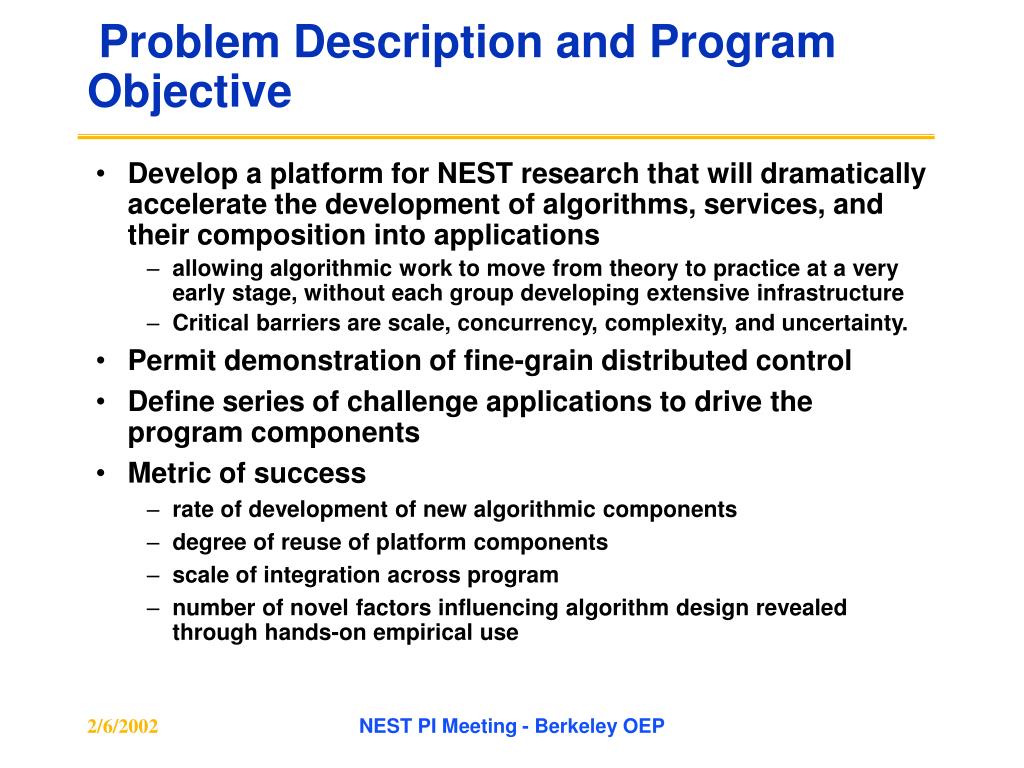

Problem Description and Program Objective • Develop a platform for NEST research that will dramaticallyaccelerate the development of algorithms, services, and their composition into applications • allowing algorithmic work to move from theory to practice at a very early stage, without each group developing extensive infrastructure • Critical barriers are scale, concurrency, complexity, and uncertainty. • Permit demonstration of fine-grain distributed control • Define series of challenge applications to drive the program components • Metric of success • rate of development of new algorithmic components • degree of reuse of platform components • scale of integration across program • number of novel factors influencing algorithm design revealed through hands-on empirical use NEST PI Meeting - Berkeley OEP
New Ideas • Small, flexible, low-cost, low-power, wireless embedded sensor devices • Tiny event-driven, robust, open component OS for NEST devices • - mcast, AM, prune algorithmic primitives • FSM high-concurrency prog. env. • Resilient aggregation • - for security and other noise • Macroprogramming unstructured aggregates • Adversarial Simulation Secure Language-Based Adaptive Service Platform for Large-scale Embedded Sensor Networks David Culler, Eric Brewer, David Wagner UC Berkeley Schedule • Impact • • Enable creation of embedded distributed syst. of unprecedented scale and role • - 1,000s of tiny networked sensors • Enable new classes of applications integrated with physical world • - Greatly simplify creation of distributed systems at extreme scale (HW & SW) • - fine-grained distributed control • • Accelerate prototyping and evaluation of new coord. & synthesis algorithms • • Enable new, robust basis for distributed, embedded software thru platform design & novel tools for simulation and visualization • Drive NW sensor challenge applications lang based optimize & viz log & trace adv. sim chal. app defn final prog. env macro. lang design FSM on OEP1 OEP1 defn OEP1 eval June 02 June 03 June 04 Oct 04 End June 01 Start OEP2 proto OEP2 platform design OEP2 OEP3 OEP1 10x100 kits OEP3 platform design chal app & evaluation NEST PI Meeting - Berkeley OEP OEP2 analysis

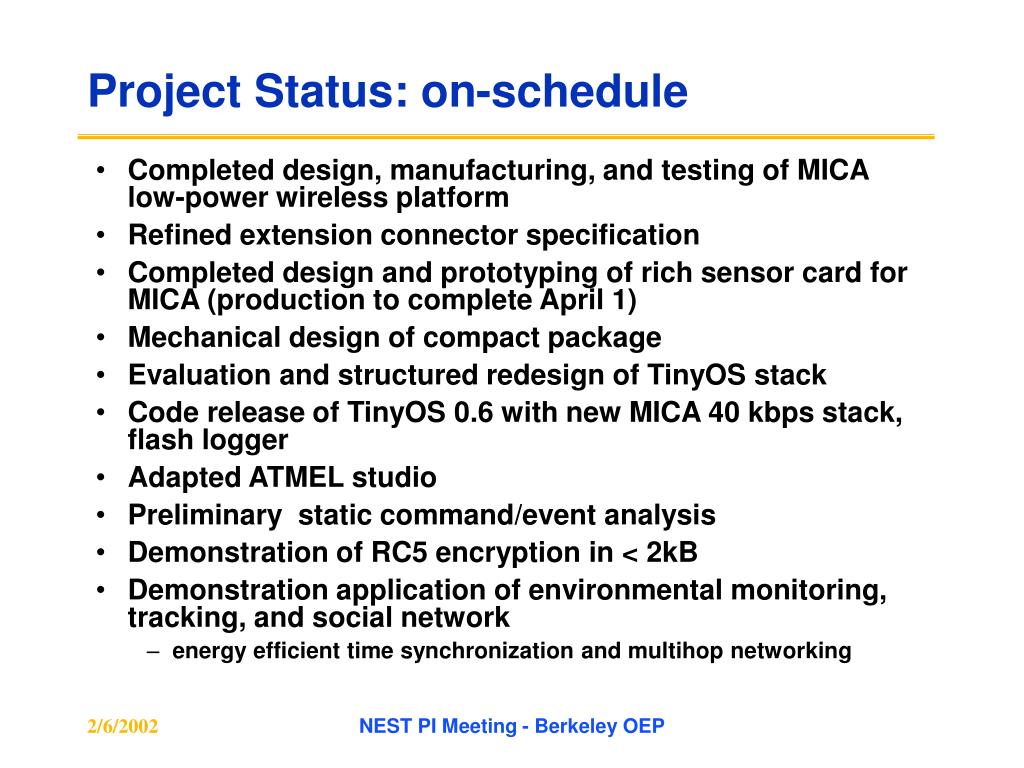

Project Status: on-schedule • Completed design, manufacturing, and testing of MICA low-power wireless platform • Refined extension connector specification • Completed design and prototyping of rich sensor card for MICA (production to complete April 1) • Mechanical design of compact package • Evaluation and structured redesign of TinyOS stack • Code release of TinyOS 0.6 with new MICA 40 kbps stack, flash logger • Adapted ATMEL studio • Preliminary static command/event analysis • Demonstration of RC5 encryption in < 2kB • Demonstration application of environmental monitoring, tracking, and social network • energy efficient time synchronization and multihop networking NEST PI Meeting - Berkeley OEP
Platform: Ahead of Schedule or Unplanned • Developed TOSSIM for detailed simulation up to 1000s of nodes (uniform application) • Demonstration of initial aggregation operators • Prototype Implementation of Geocast • Prototype visual TinyOS programming tool • Development and calibration of RF-based localization components • Implementation of general actuator control (with SDR pgm) • Studies of large-scale algorithm dynamics NEST PI Meeting - Berkeley OEP

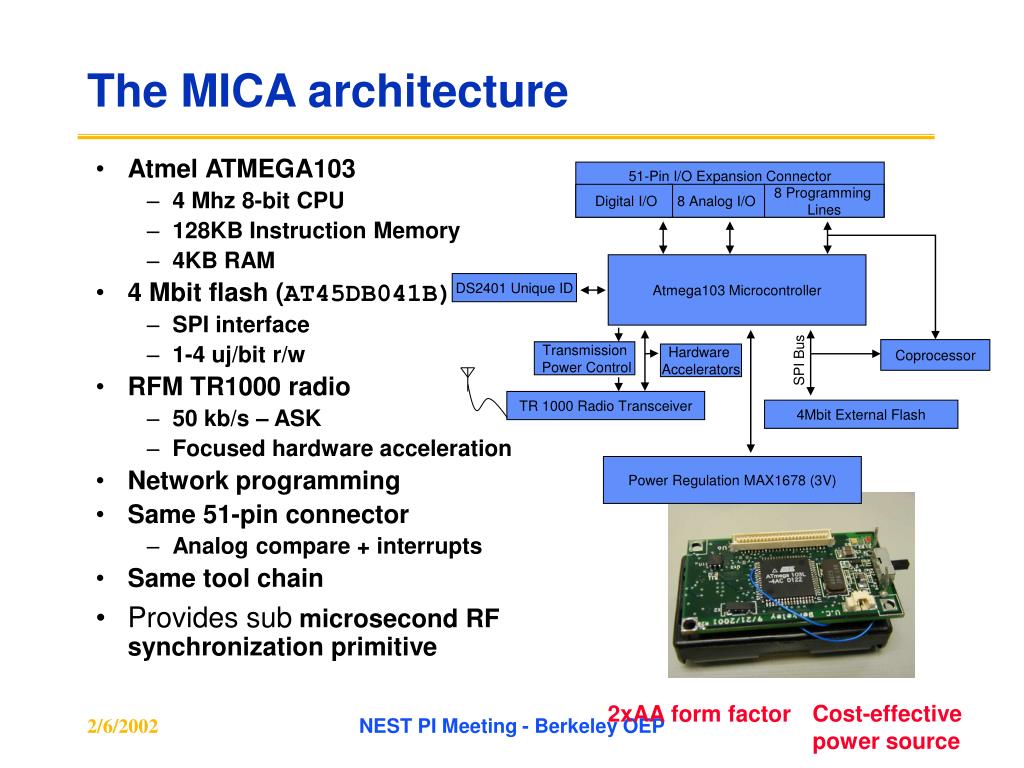

The MICA architecture • Atmel ATMEGA103 • 4 Mhz 8-bit CPU • 128KB Instruction Memory • 4KB RAM • 4 Mbit flash (AT45DB041B) • SPI interface • 1-4 uj/bit r/w • RFM TR1000 radio • 50 kb/s – ASK • Focused hardware acceleration • Network programming • Same 51-pin connector • Analog compare + interrupts • Same tool chain • Provides sub microsecond RF synchronization primitive 51-Pin I/O Expansion Connector Digital I/O 8 Analog I/O 8 Programming Lines Atmega103 Microcontroller DS2401 Unique ID Coprocessor Transmission Power Control Hardware Accelerators SPI Bus TR 1000 Radio Transceiver 4Mbit External Flash Power Regulation MAX1678 (3V) Cost-effective power source 2xAA form factor NEST PI Meeting - Berkeley OEP
Mica PINS Tone Intr PHOTO SOUNDER Mic Signal MICROPHONE TEMP Y Axis Gain Adjustment X Axis MAGNETOMETER ACCELEROMETER ADC Signals (ADC1-ADC6) On/Off Control I2C Bus Interrupt Rich Sensor board Microphone Sounder Magnetometer 1.25 in Temperature Sensor Light Sensor 2.25 in NEST PI Meeting - Berkeley OEP Accelerometer

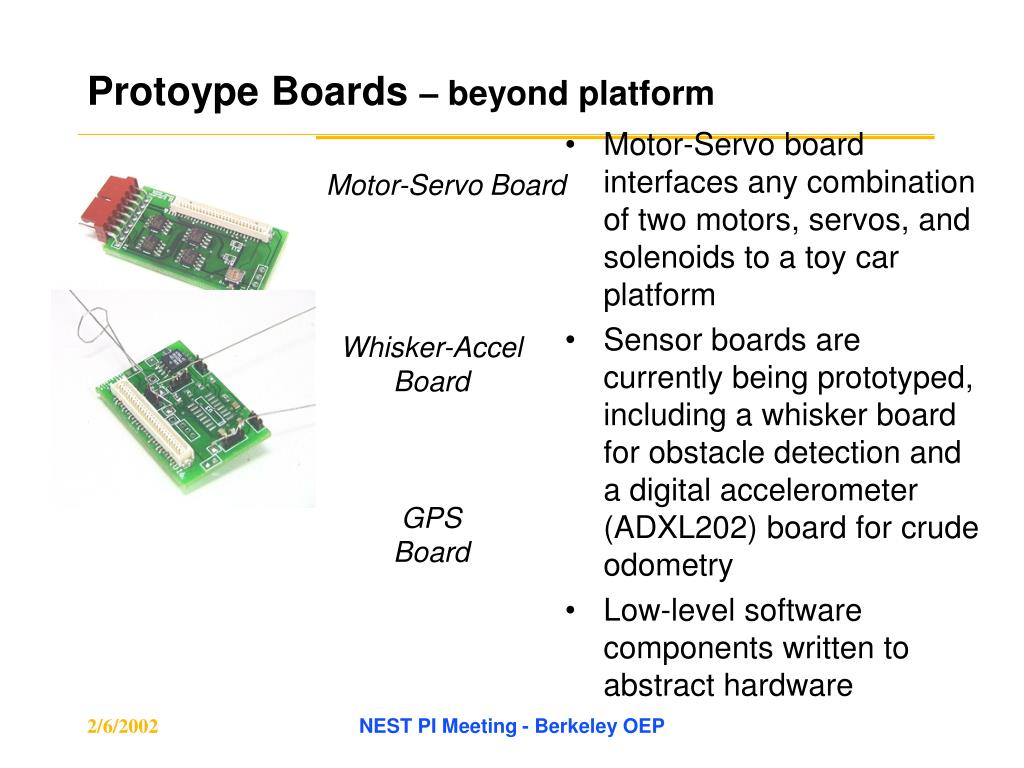

Protoype Boards – beyond platform • Motor-Servo boardinterfaces any combination of two motors, servos, and solenoids to a toy car platform • Sensor boards are currently being prototyped, including a whisker board for obstacle detection and a digital accelerometer (ADXL202) board for crude odometry • Low-level software components written to abstract hardware Motor-Servo Board Whisker-Accel Board GPS Board NEST PI Meeting - Berkeley OEP

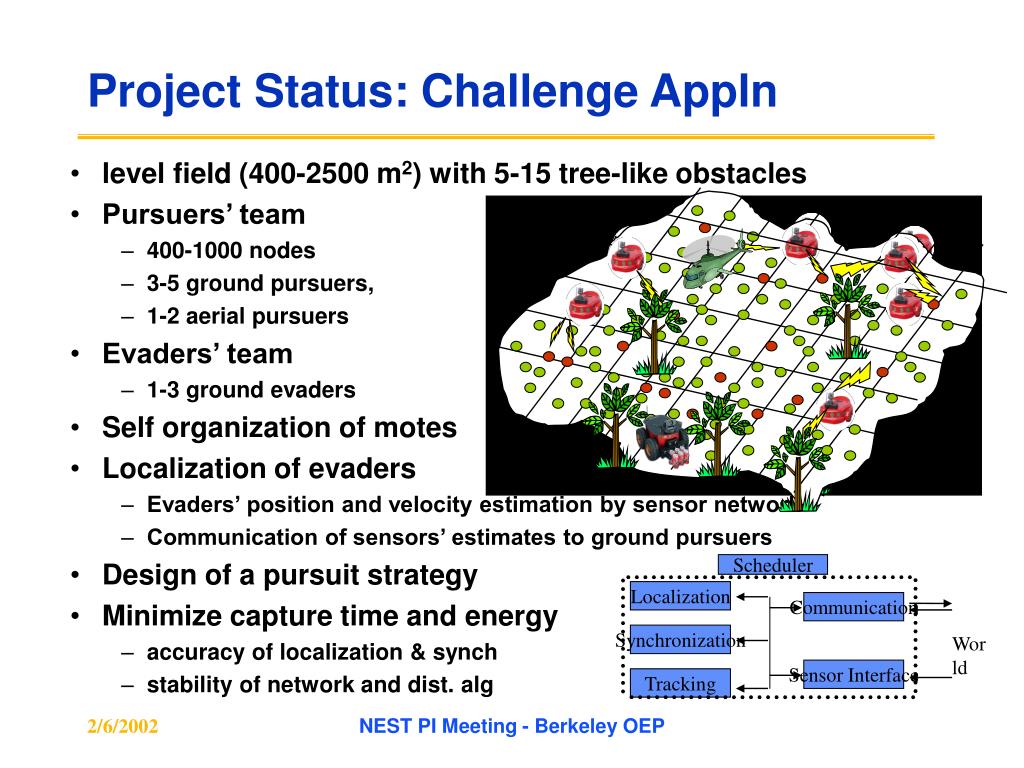

Scheduler Localization Communication Synchronization World Sensor Interface Tracking Project Status: Challenge Appln • level field (400-2500 m2) with 5-15 tree-like obstacles • Pursuers’ team • 400-1000 nodes • 3-5 ground pursuers, • 1-2 aerial pursuers • Evaders’ team • 1-3 ground evaders • Self organization of motes • Localization of evaders • Evaders’ position and velocity estimation by sensor network • Communication of sensors’ estimates to ground pursuers • Design of a pursuit strategy • Minimize capture time and energy • accuracy of localization & synch • stability of network and dist. alg NEST PI Meeting - Berkeley OEP
Project Plans • Complete 1.0 release of TinyOS • Support facility for project groups using the platform • Logging and analysis of platform usage, failure modes, energy profile. • Analysis of hardware design and TinyOS relative to evolving project needs • Develop simulation environment • Design specification for robust version of TinyOS • Design of low-level programming language for FSM component • Preliminary Analysis of techniques for resilient aggregation and random sampling • Demonstration of distributed control loops NEST PI Meeting - Berkeley OEP

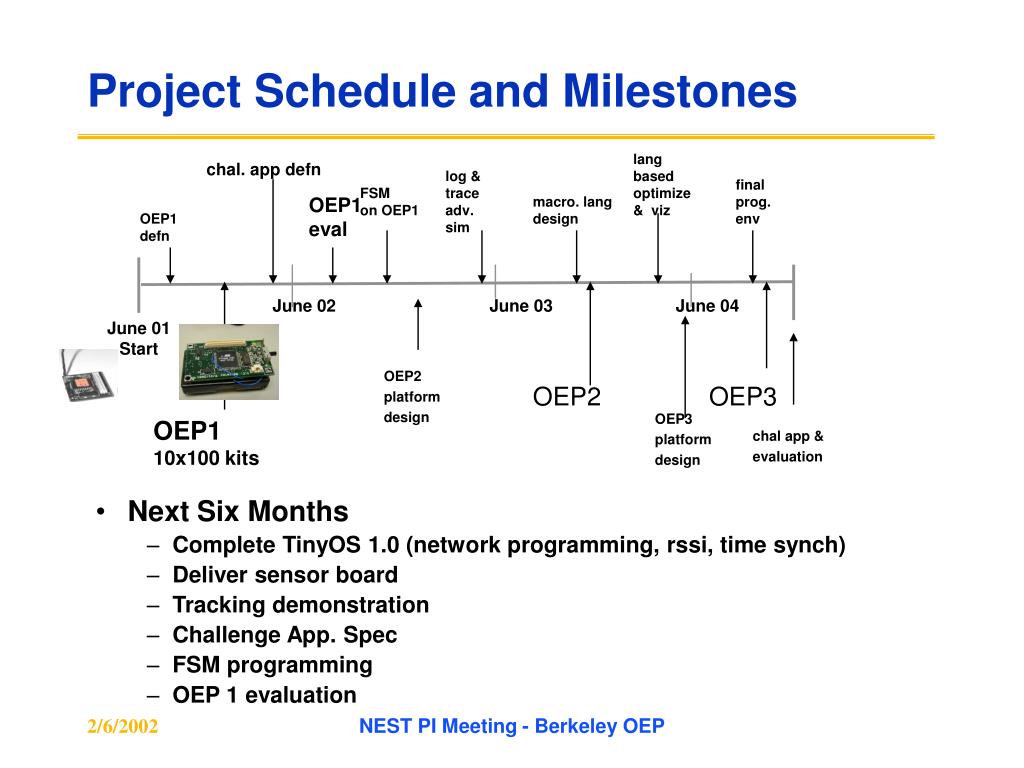

Project Schedule and Milestones lang based optimize & viz • Next Six Months • Complete TinyOS 1.0 (network programming, rssi, time synch) • Deliver sensor board • Tracking demonstration • Challenge App. Spec • FSM programming • OEP 1 evaluation chal. app defn log & trace adv. sim final prog. env FSM on OEP1 OEP1 eval macro. lang design OEP1 defn June 02 June 03 June 04 June 01 Start OEP2 platform design OEP2 OEP3 OEP1 10x100 kits OEP3 platform design chal app & evaluation NEST PI Meeting - Berkeley OEP

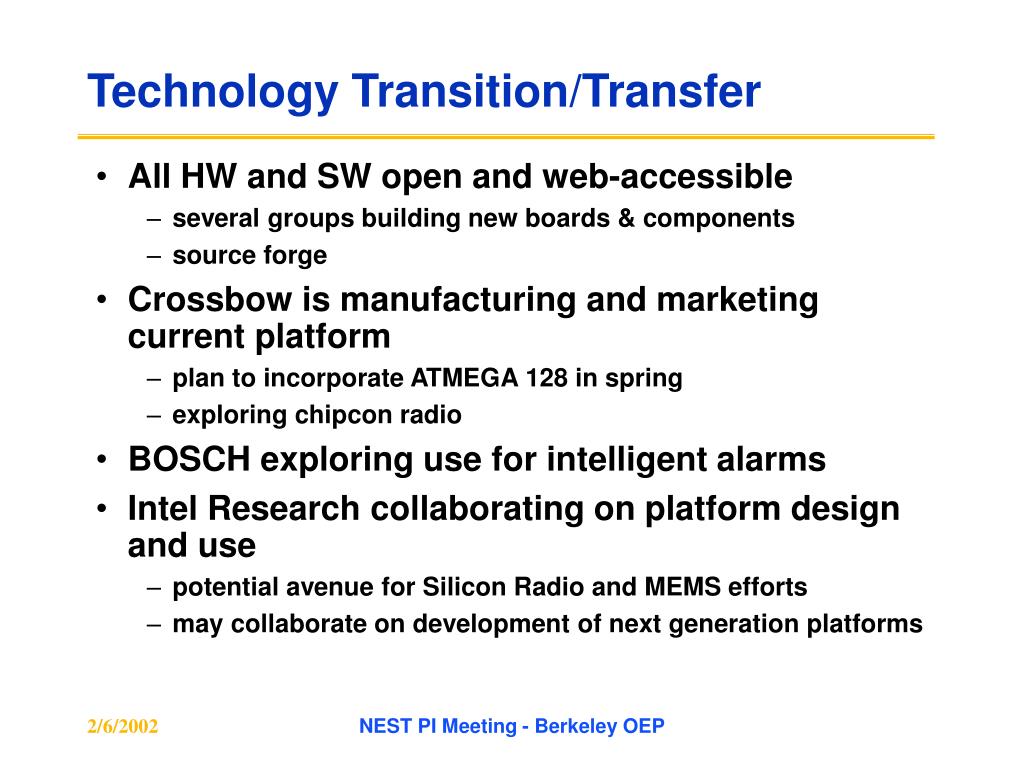

Technology Transition/Transfer • All HW and SW open and web-accessible • several groups building new boards & components • source forge • Crossbow is manufacturing and marketing current platform • plan to incorporate ATMEGA 128 in spring • exploring chipcon radio • BOSCH exploring use for intelligent alarms • Intel Research collaborating on platform design and use • potential avenue for Silicon Radio and MEMS efforts • may collaborate on development of next generation platforms NEST PI Meeting - Berkeley OEP

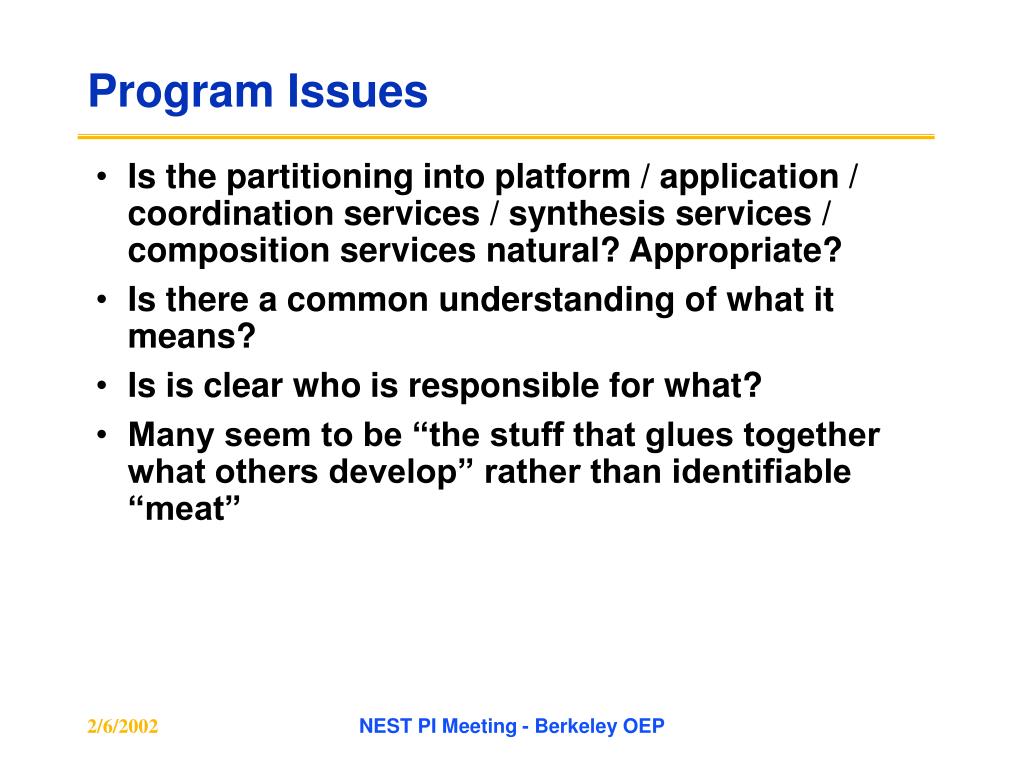

Program Issues • Is the partitioning into platform / application / coordination services / synthesis services / composition services natural? Appropriate? • Is there a common understanding of what it means? • Is is clear who is responsible for what? • Many seem to be “the stuff that glues together what others develop” rather than identifiable “meat” NEST PI Meeting - Berkeley OEP
