### Comprehensive Phase 1 Plan for Hadron Hall Secondary Beamline Installation ###
130 likes | 247 Views
This document outlines the original plan for the installation of secondary beamlines in Hadron Hall during Phase 1. It details the approved experiments, including stages for hyper-nuclear and kaonic nuclei experiments, as well as the operational schedule for various experiments. Funding applications are discussed, emphasizing the need for international cooperation in detector upgrades and project execution. A timeline for job assignments and the progress of beamline development is included, aiming to ensure collaborative enhancement of experimental capabilities. ###
### Comprehensive Phase 1 Plan for Hadron Hall Secondary Beamline Installation ###
E N D
Presentation Transcript

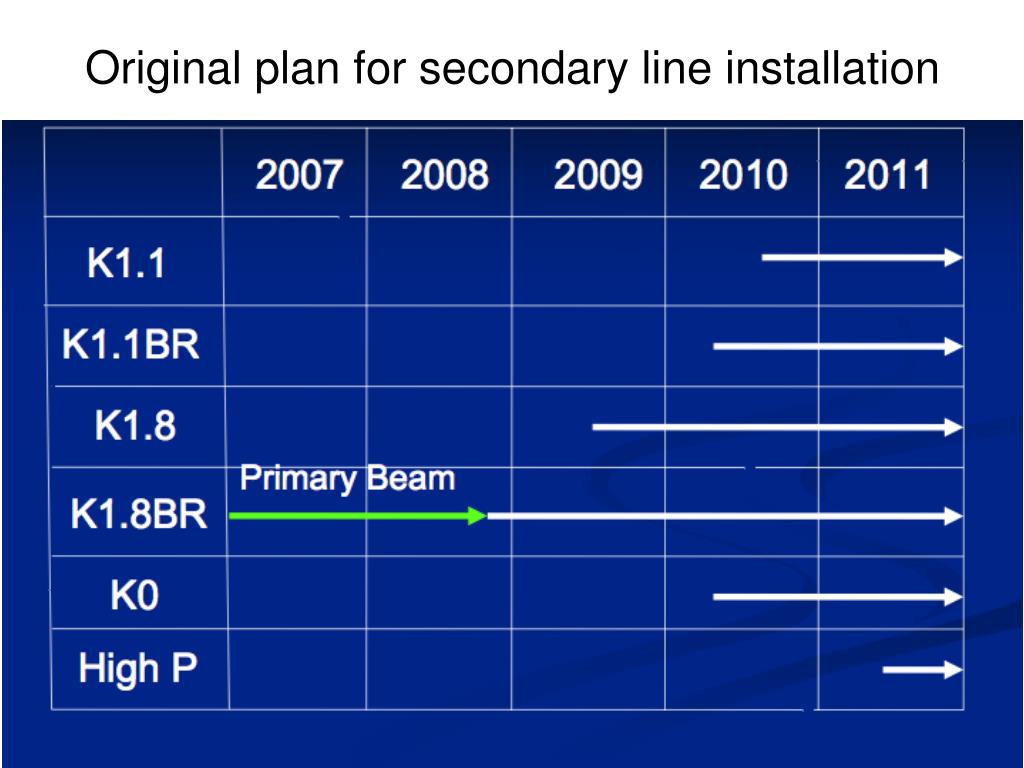

Hadron hall secondary beamlines Hadron hall beamlines in Phase1 ① ② ③ ④
Other approved experiments E05, E13: stage-2 E07, E19, etc: stage-2 Hyper-nuclear exp. Using SKS as Day-1 from 2009 @K1.8 E15, E17: stage-2 Kaonic nuclei exp. as Day-1 @ K1.8BR E14 :stage-1 KL->p0nn-bar @K0 E06 @K1.1BR Three secondary lines run simultaneously

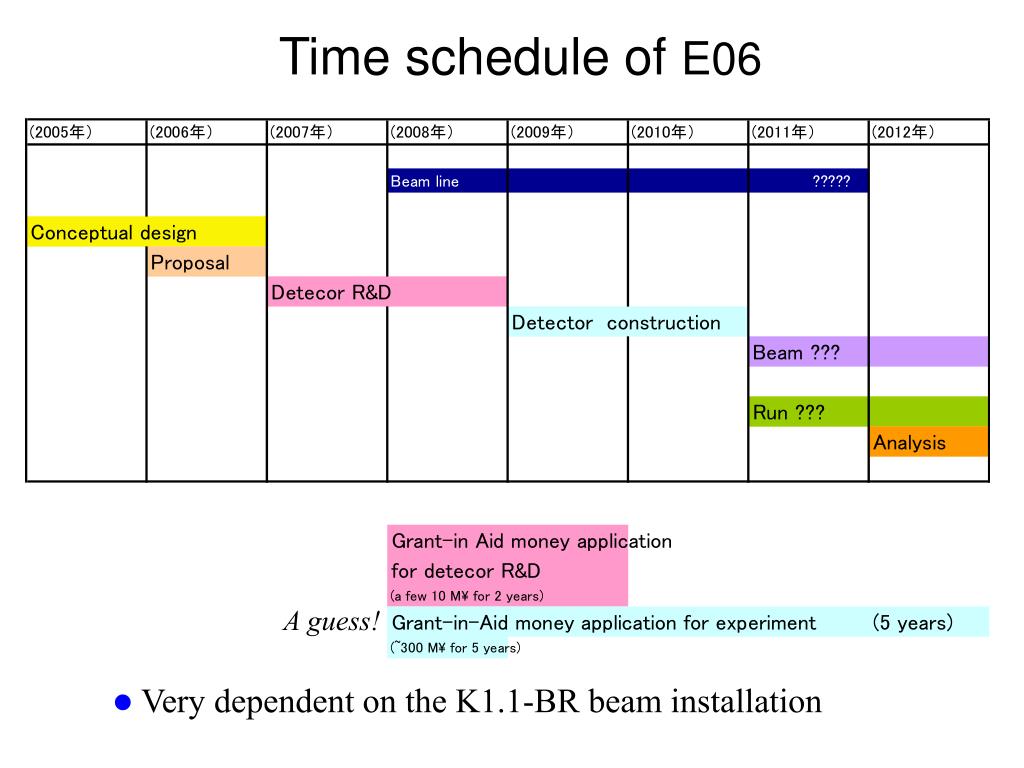

Time schedule of E06 A guess! • Very dependent on the K1.1-BR beam installation

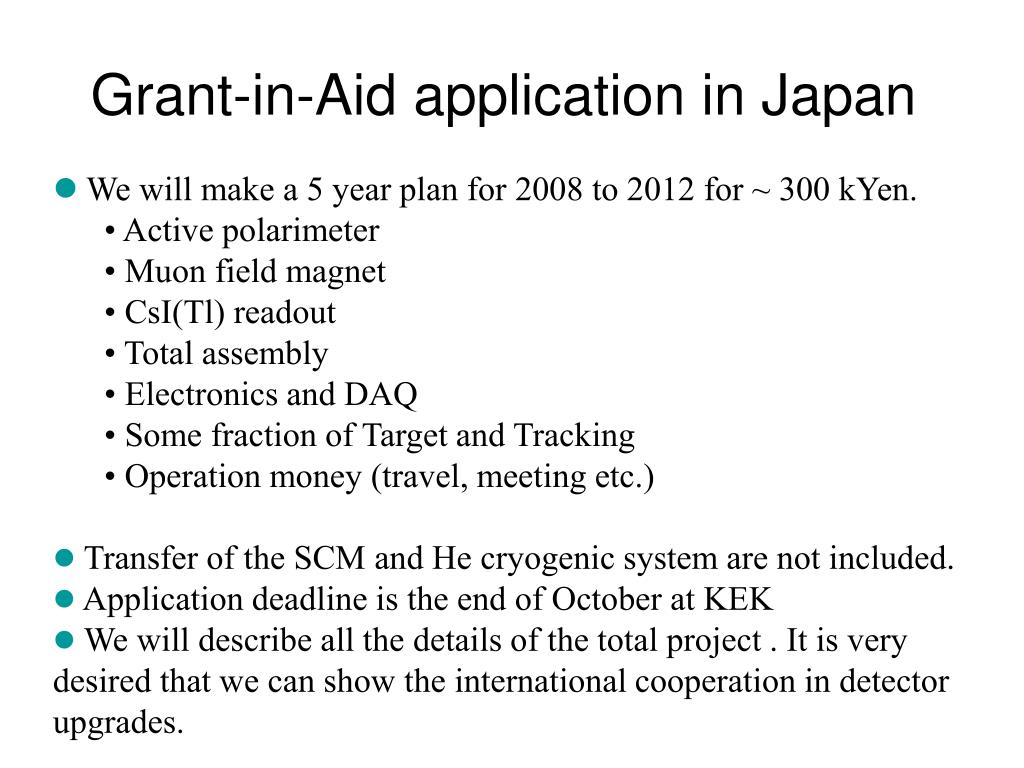

Grant-in-Aid application in Japan • We will make a 5 year plan for 2008 to 2012 for ~ 300 kYen. • Active polarimeter • Muon field magnet • CsI(Tl) readout • Total assembly • Electronics and DAQ • Some fraction of Target and Tracking • Operation money (travel, meeting etc.) • Transfer of the SCM and He cryogenic system are not included. • Application deadline is the end of October at KEK • We will describe all the details of the total project . It is very desired that we can show the international cooperation in detector upgrades.

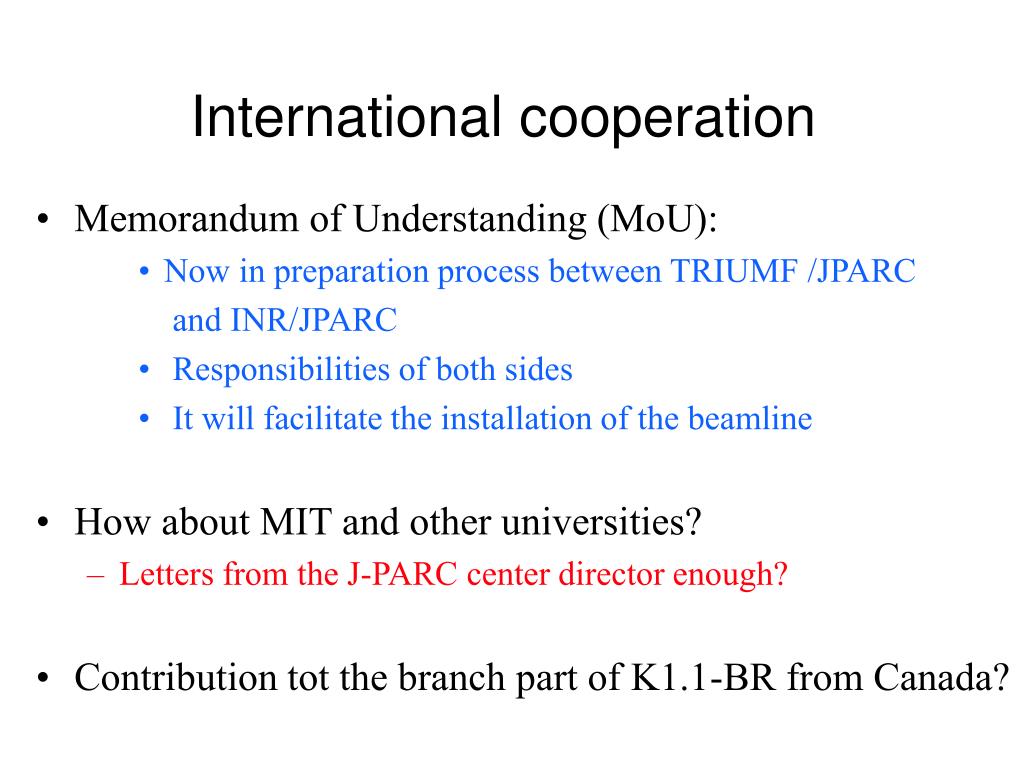

International cooperation • Memorandum of Understanding (MoU): • Now in preparation process between TRIUMF /JPARC and INR/JPARC • Responsibilities of both sides • It will facilitate the installation of the beamline • How about MIT and other universities? • Letters from the J-PARC center director enough? • Contribution tot the branch part of K1.1-BR from Canada?
Job assignments and schedule (1) • (1) K0.8 beamline element identification (J.Imazato)- Check of the preparation status by the Hadron Beamline Group- Check of available components- More precise cost estimate- Installation planning proposal# by next PAC • (2) E1120 analysis (Danielle Anderson, J. Imazato, M. Hasinoff)- Analysis with a Gaussian relaxation function- Finalizing result and report to TRIUMF# by Saskatoon (?) + TRIUMF deadline% TREK Technical Note No.5 • (3) Electronics summary (Y. Igarashi, S. Shimizu)- List-up of necessary developments and who and how- List-up of modules which we expect to obtain from the pool.- More precise cost estimate and time schedule# by Saskatoon and next PAC% TREK technical Note No.6 • (4) C0 and C1 GEM chamber (M. Kohl)- More detailed report of the FNAL test experiment- Clarification of rate capability- C0 cylindrical chamber conceptual picture# by Saskatoon% TREK Technical Note No.4

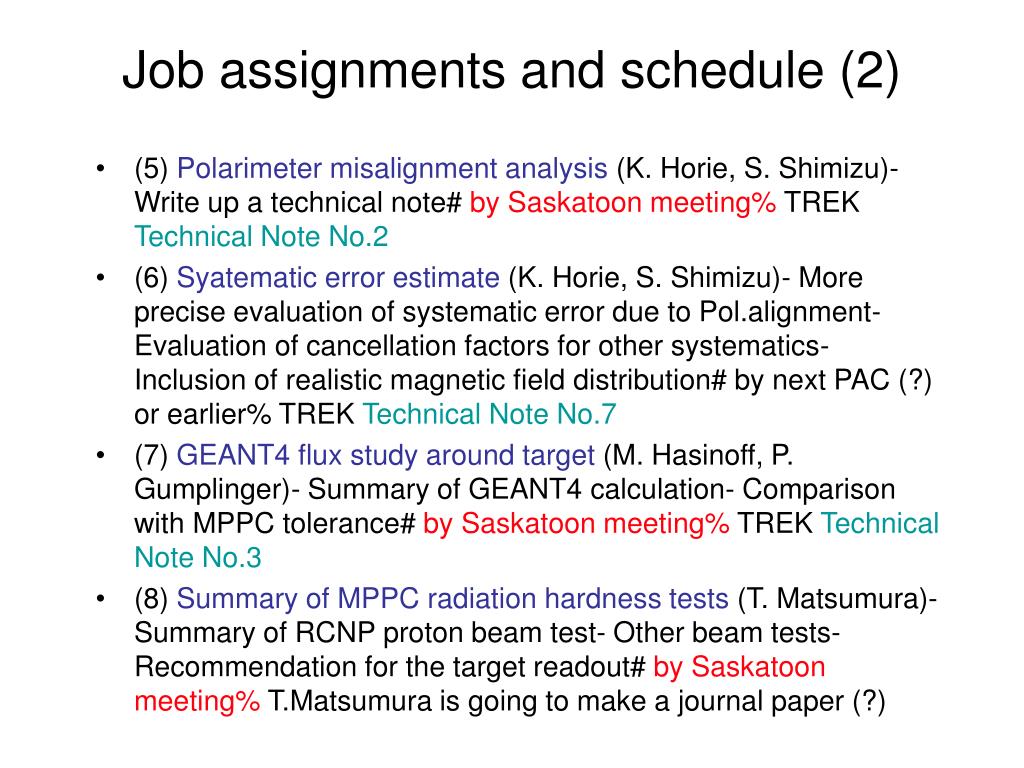

Job assignments and schedule (2) • (5) Polarimeter misalignment analysis (K. Horie, S. Shimizu)- Write up a technical note# by Saskatoon meeting% TREK Technical Note No.2 • (6) Syatematic error estimate (K. Horie, S. Shimizu)- More precise evaluation of systematic error due to Pol.alignment- Evaluation of cancellation factors for other systematics- Inclusion of realistic magnetic field distribution# by next PAC (?) or earlier% TREK Technical Note No.7 • (7) GEANT4 flux study around target (M. Hasinoff, P. Gumplinger)- Summary of GEANT4 calculation- Comparison with MPPC tolerance# by Saskatoon meeting% TREK Technical Note No.3 • (8) Summary of MPPC radiation hardness tests (T. Matsumura)- Summary of RCNP proton beam test- Other beam tests- Recommendation for the target readout# by Saskatoon meeting% T.Matsumura is going to make a journal paper (?)

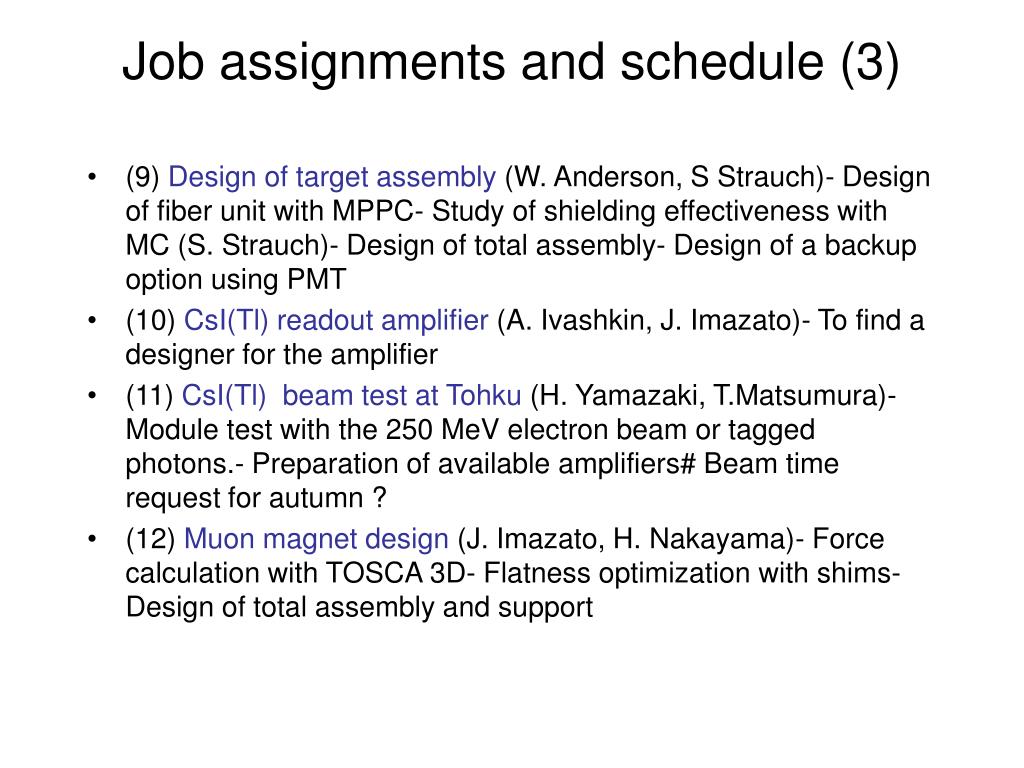

Job assignments and schedule (3) • (9) Design of target assembly (W. Anderson, S Strauch)- Design of fiber unit with MPPC- Study of shielding effectiveness with MC (S. Strauch)- Design of total assembly- Design of a backup option using PMT • (10) CsI(Tl) readout amplifier (A. Ivashkin, J. Imazato)- To find a designer for the amplifier • (11) CsI(Tl) beam test at Tohku (H. Yamazaki, T.Matsumura)- Module test with the 250 MeV electron beam or tagged photons.- Preparation of available amplifiers# Beam time request for autumn ? • (12) Muon magnet design (J. Imazato, H. Nakayama)- Force calculation with TOSCA 3D- Flatness optimization with shims- Design of total assembly and support

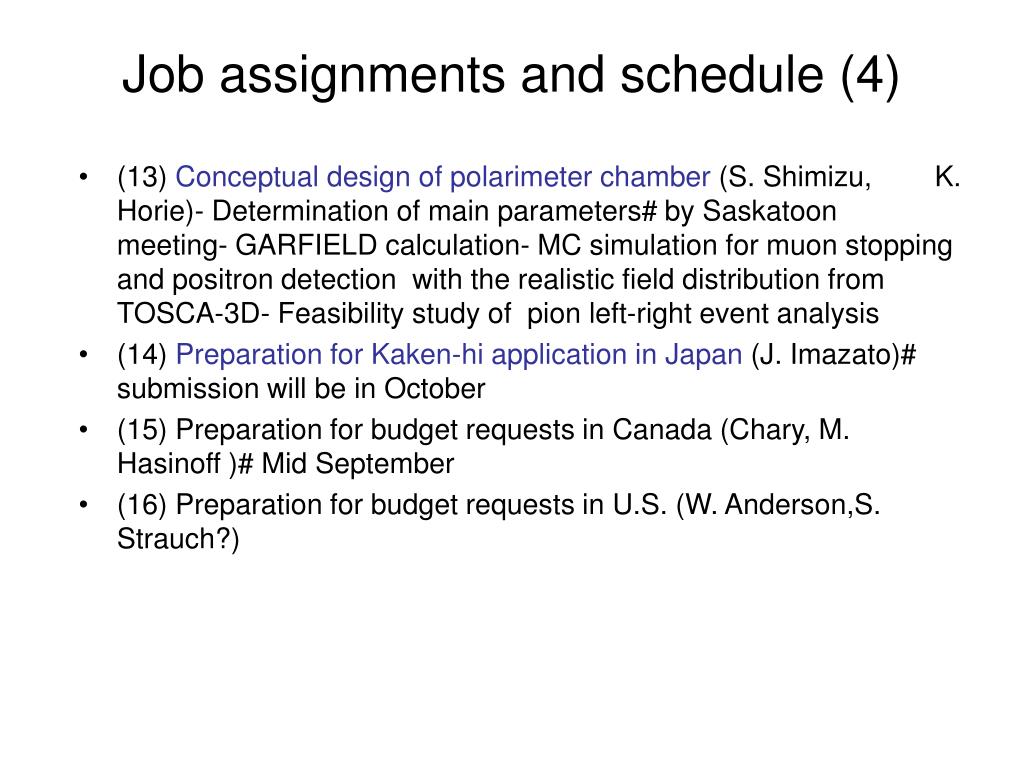

Job assignments and schedule (4) • (13) Conceptual design of polarimeter chamber (S. Shimizu, K. Horie)- Determination of main parameters# by Saskatoon meeting- GARFIELD calculation- MC simulation for muon stopping and positron detection with the realistic field distribution from TOSCA-3D- Feasibility study of pion left-right event analysis • (14) Preparation for Kaken-hi application in Japan (J. Imazato)# submission will be in October • (15) Preparation for budget requests in Canada (Chary, M. Hasinoff )# Mid September • (16) Preparation for budget requests in U.S. (W. Anderson,S. Strauch?)

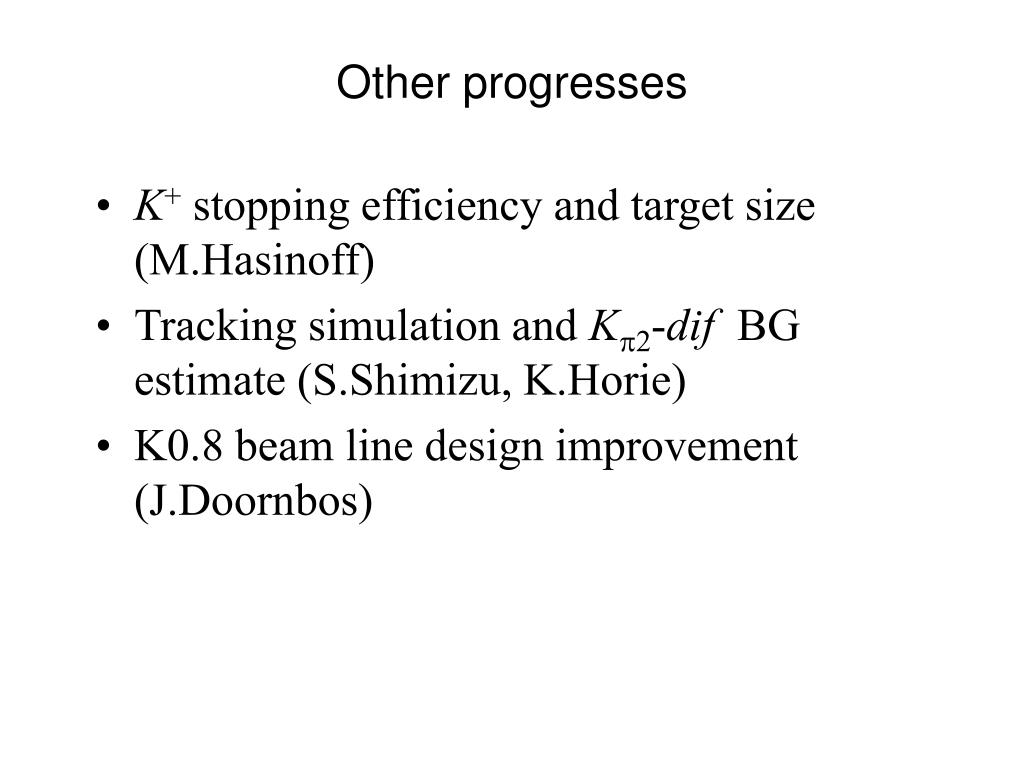

Other progresses • K+ stopping efficiency and target size (M.Hasinoff) • Tracking simulation and Kp2-dif BG estimate (S.Shimizu, K.Horie) • K0.8 beam line design improvement (J.Doornbos)

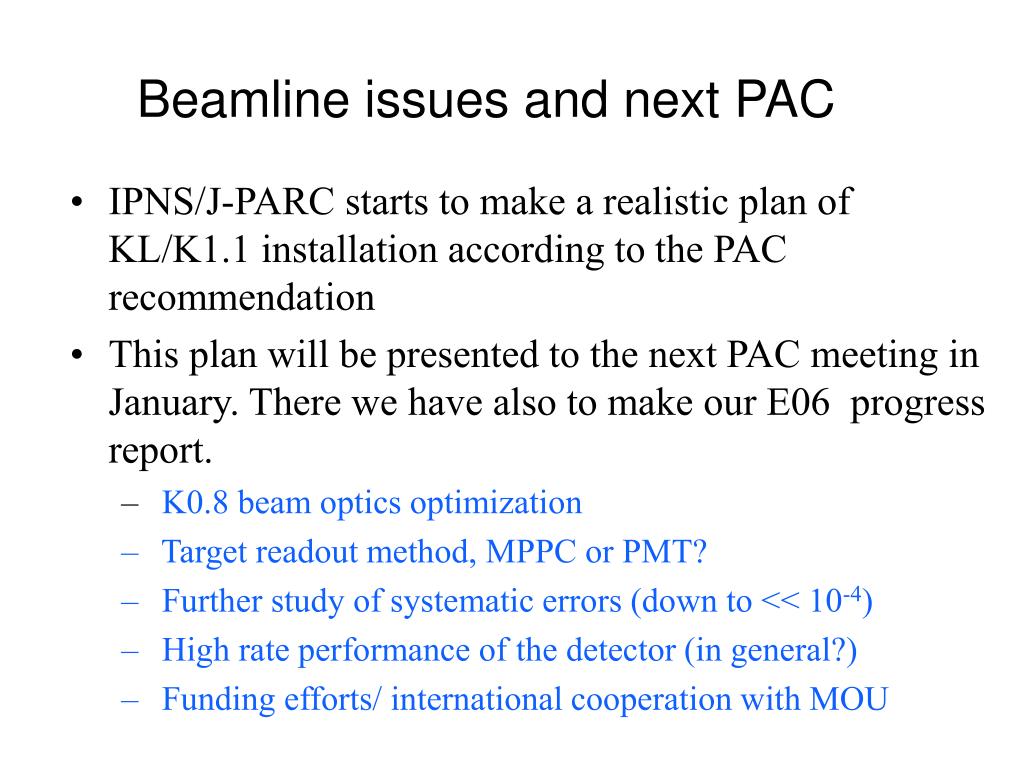

Beamline issues and next PAC • IPNS/J-PARC starts to make a realistic plan of KL/K1.1 installation according to the PAC recommendation • This plan will be presented to the next PAC meeting in January. There we have also to make our E06 progress report. • K0.8 beam optics optimization • Target readout method, MPPC or PMT? • Further study of systematic errors (down to << 10-4) • High rate performance of the detector (in general?) • Funding efforts/ international cooperation with MOU

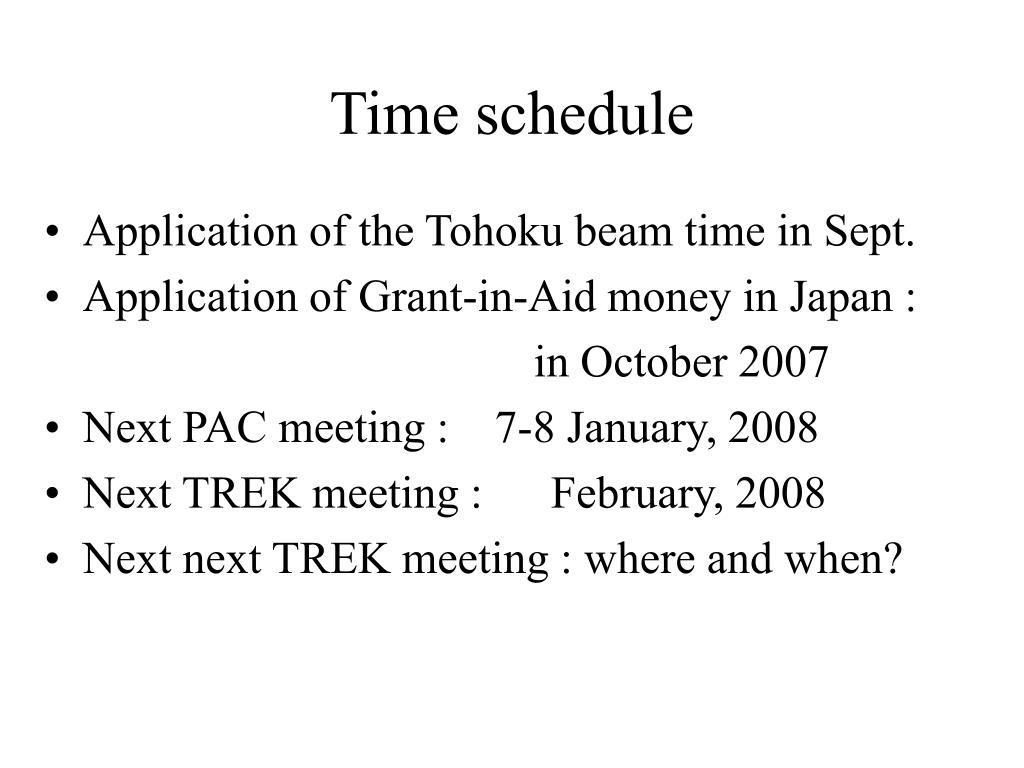

Time schedule • Application of the Tohoku beam time in Sept. • Application of Grant-in-Aid money in Japan : in October 2007 • Next PAC meeting : 7-8 January, 2008 • Next TREK meeting : February, 2008 • Next next TREK meeting : where and when?
