Organizational practices of knowledge mobilization by top NHS managers Davide Nicolini and Maja Korica IKON, Warwick Business School Southampton, March 11, 2011

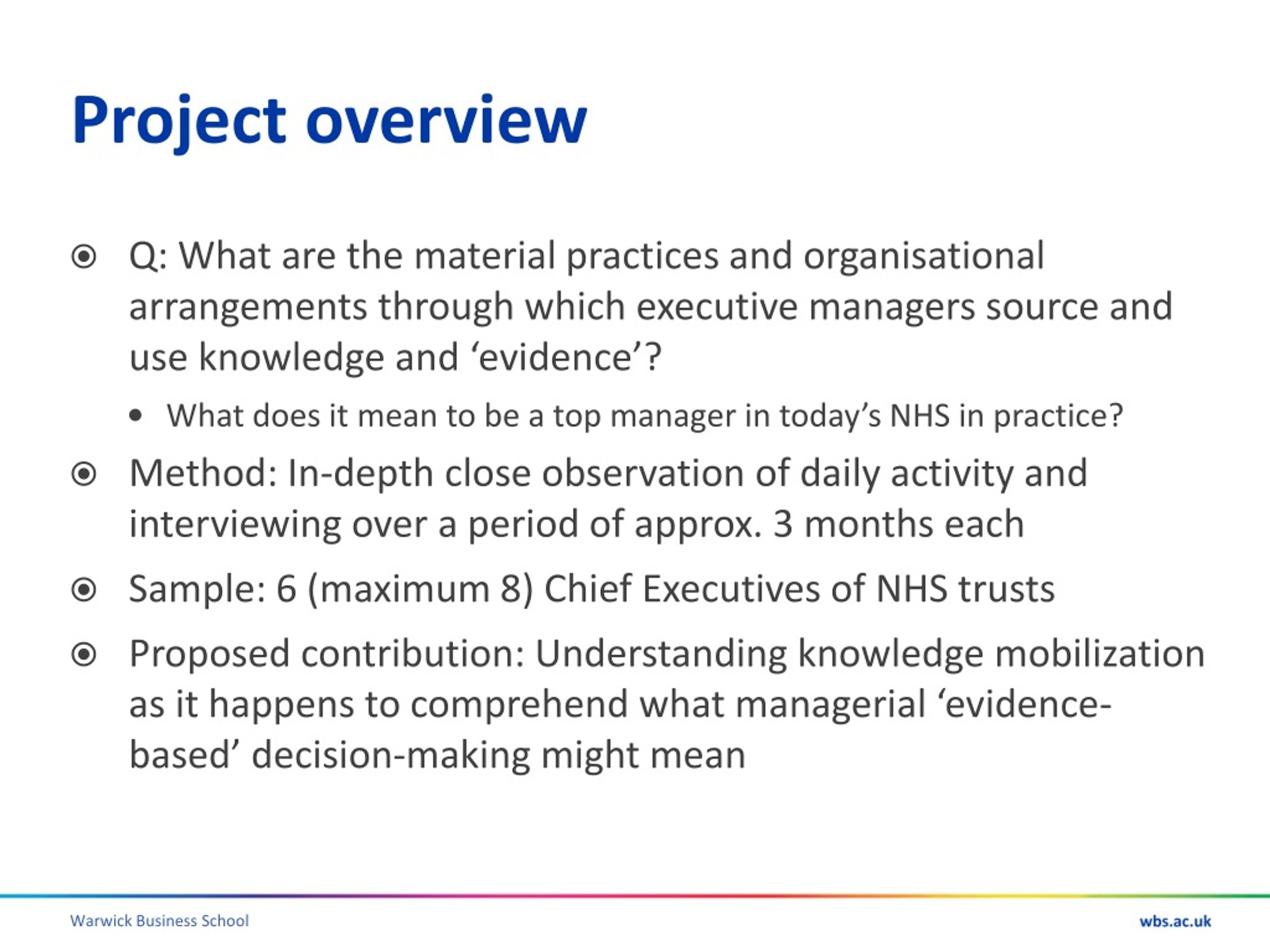

Project overview • Q: What are the material practices and organisational arrangements through which executive managers source and use knowledge and ‘evidence’? • What does it mean to be a top manager in today’s NHS in practice? • Method: In-depth close observation of daily activity and interviewing over a period of approx. 3 months each • Sample: 6 (maximum 8) Chief Executives of NHS trusts • Proposed contribution: Understanding knowledge mobilization as it happens to comprehend what managerial ‘evidence-based’ decision-making might mean
The team Maja Korica Warwick Business School Davide Nicolini Warwick Business School John Powell Warwick Medical school

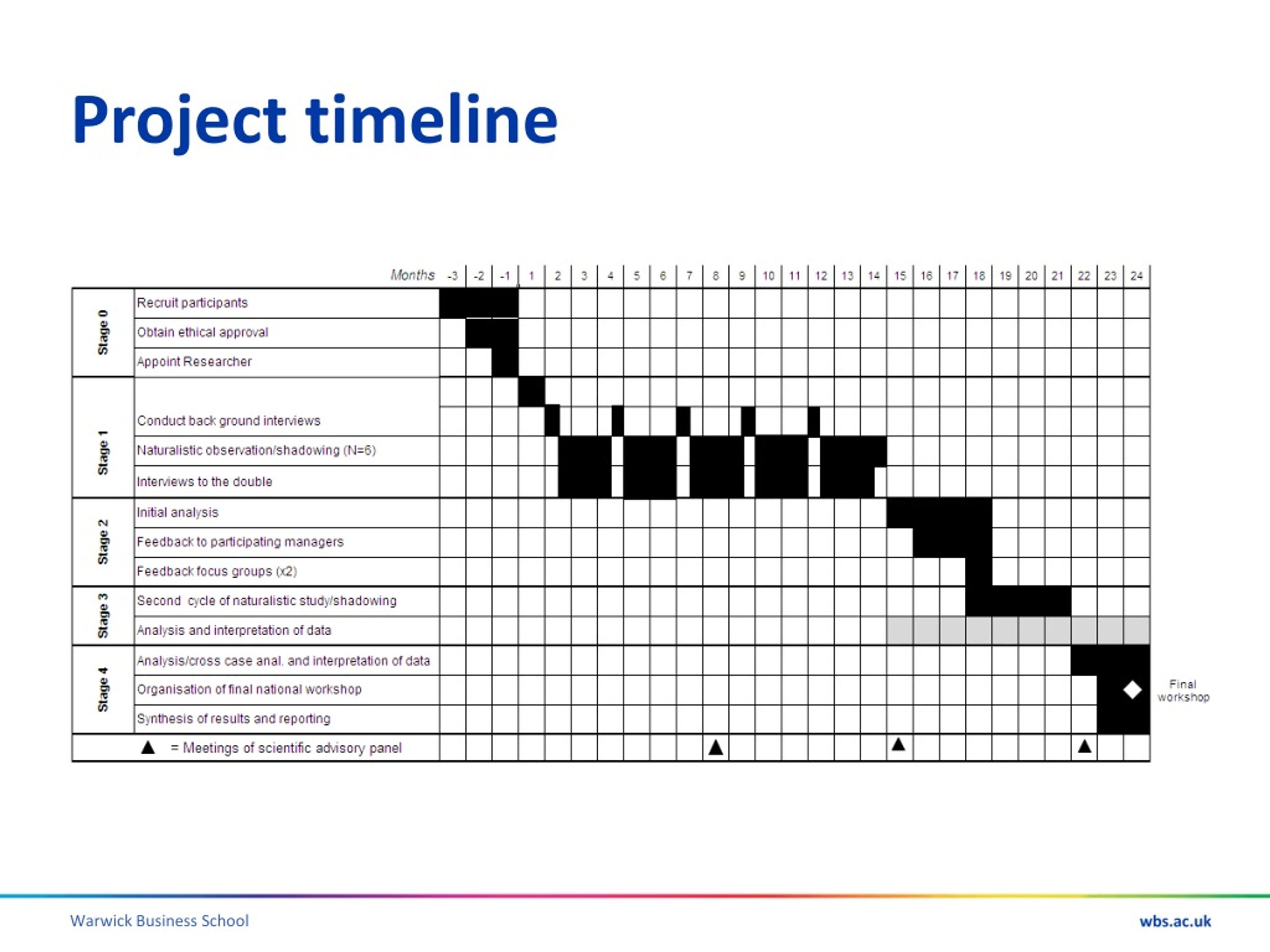

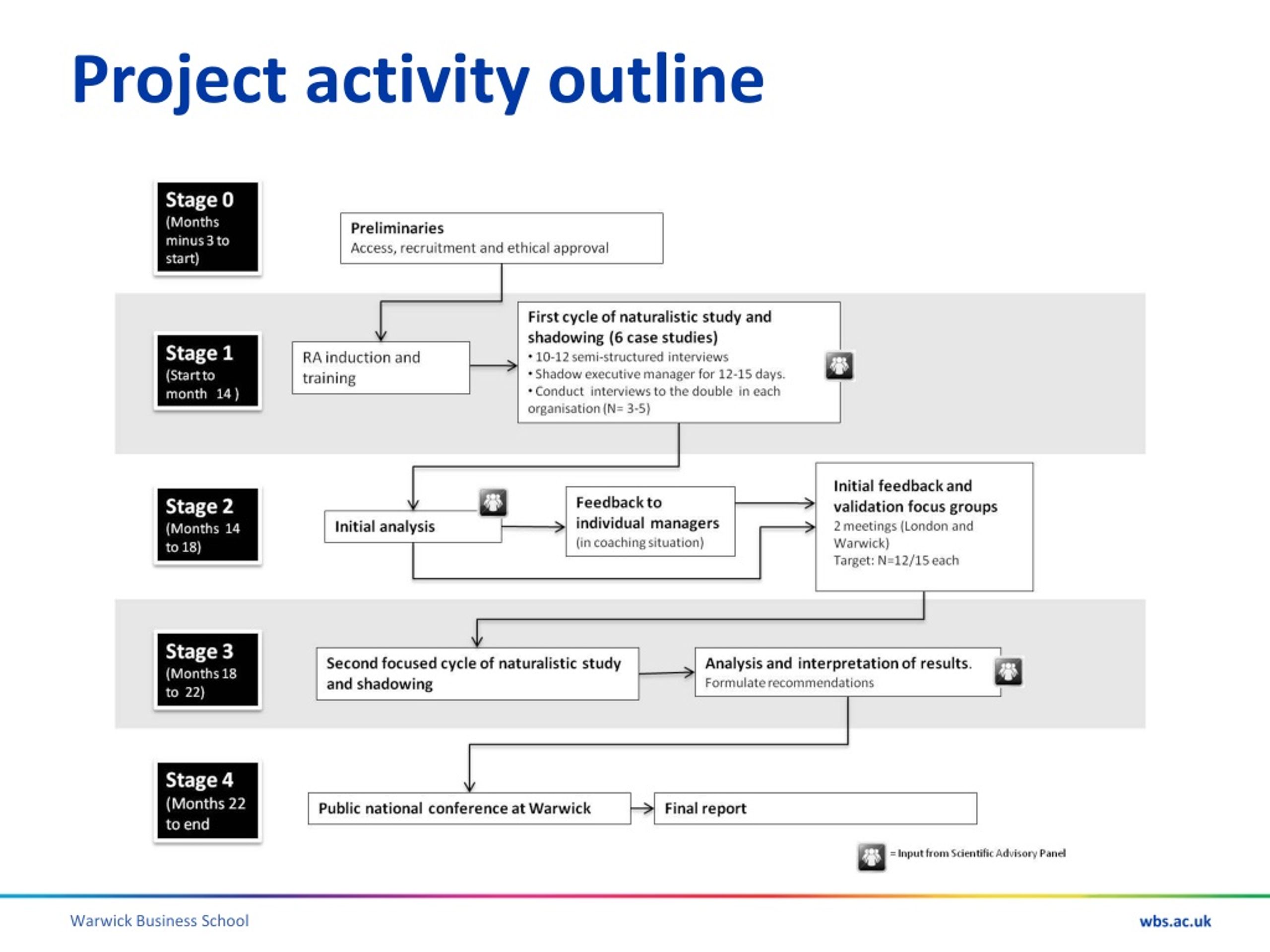

Project governance • Informal interaction through co-location • Fortnightly scheduled progress meetings, or Skype meetings (when in the field), between principal investigator and research associate • During analysis: Fortnightly analytical reports • Formal monthly meetings of the entire team • Meetings of the Scientific Advisory Panel

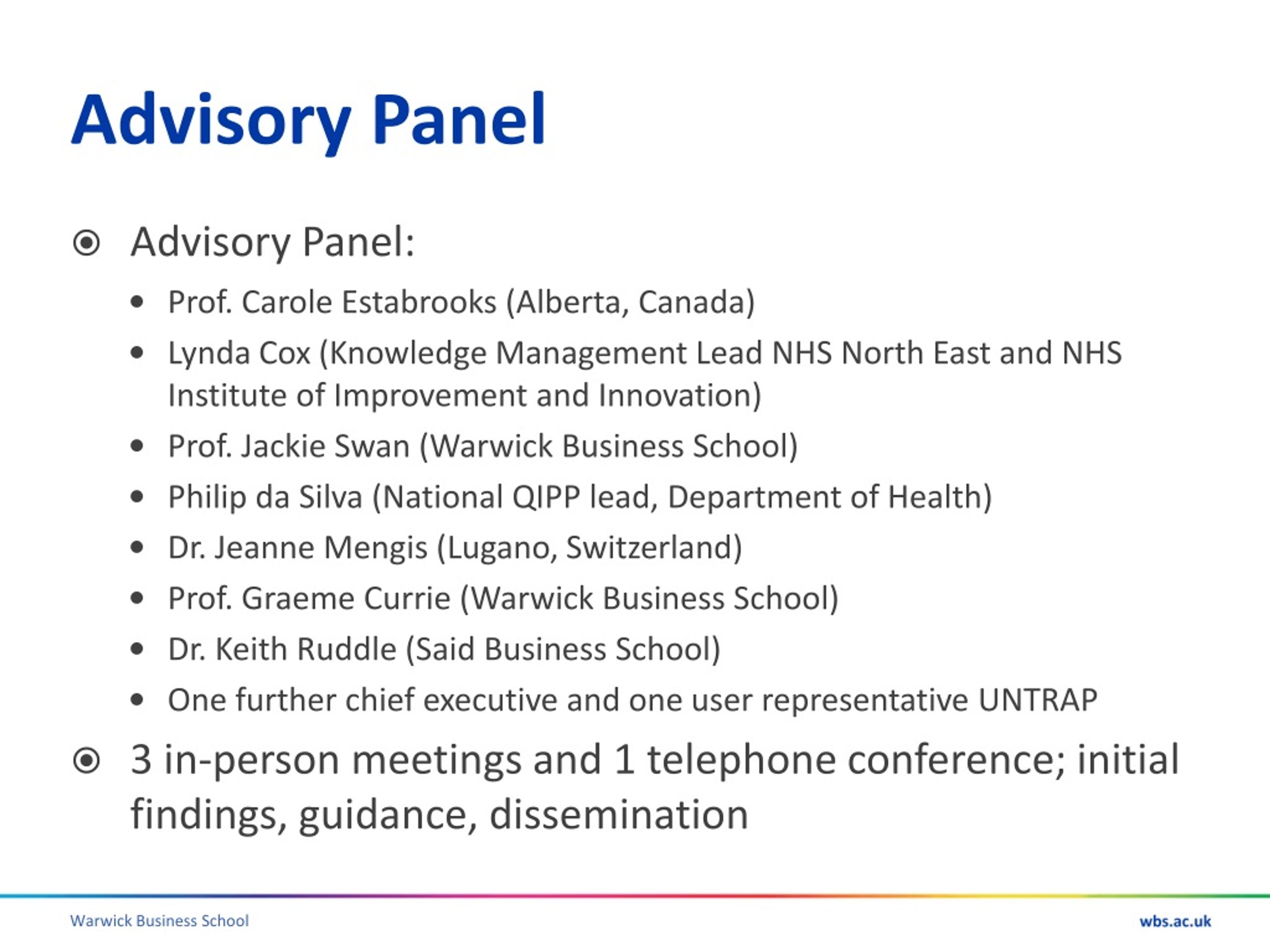

Advisory Panel • Advisory Panel: • Prof. Carole Estabrooks (Alberta, Canada) • Lynda Cox (Knowledge Management Lead NHS North East and NHS Institute of Improvement and Innovation) • Prof. Jackie Swan (Warwick Business School) • Philip da Silva (National QIPP lead, Department of Health) • Dr. Jeanne Mengis (Lugano, Switzerland) • Prof. Graeme Currie (Warwick Business School) • Dr. Keith Ruddle (Said Business School) • One further chief executive and one user representative UNTRAP • 3 in-person meetings and 1 telephone conference; initial findings, guidance, dissemination

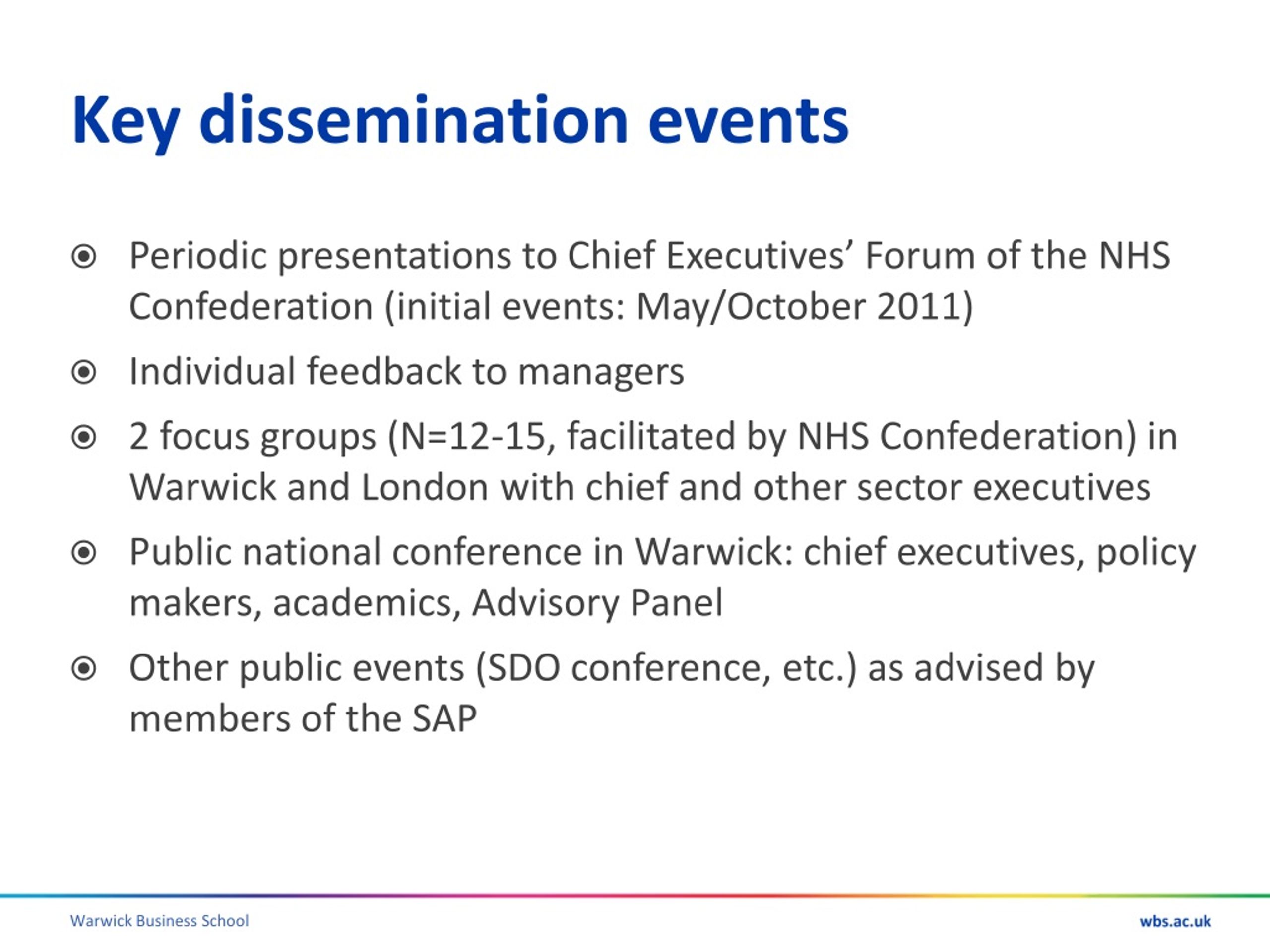

Key dissemination events • Periodic presentations to Chief Executives’ Forum of the NHS Confederation (initial events: May/October 2011) • Individual feedback to managers • 2 focus groups (N=12-15, facilitated by NHS Confederation) in Warwick and London with chief and other sector executives • Public national conference in Warwick: chief executives, policy makers, academics, Advisory Panel • Other public events (SDO conference, etc.) as advised by members of the SAP

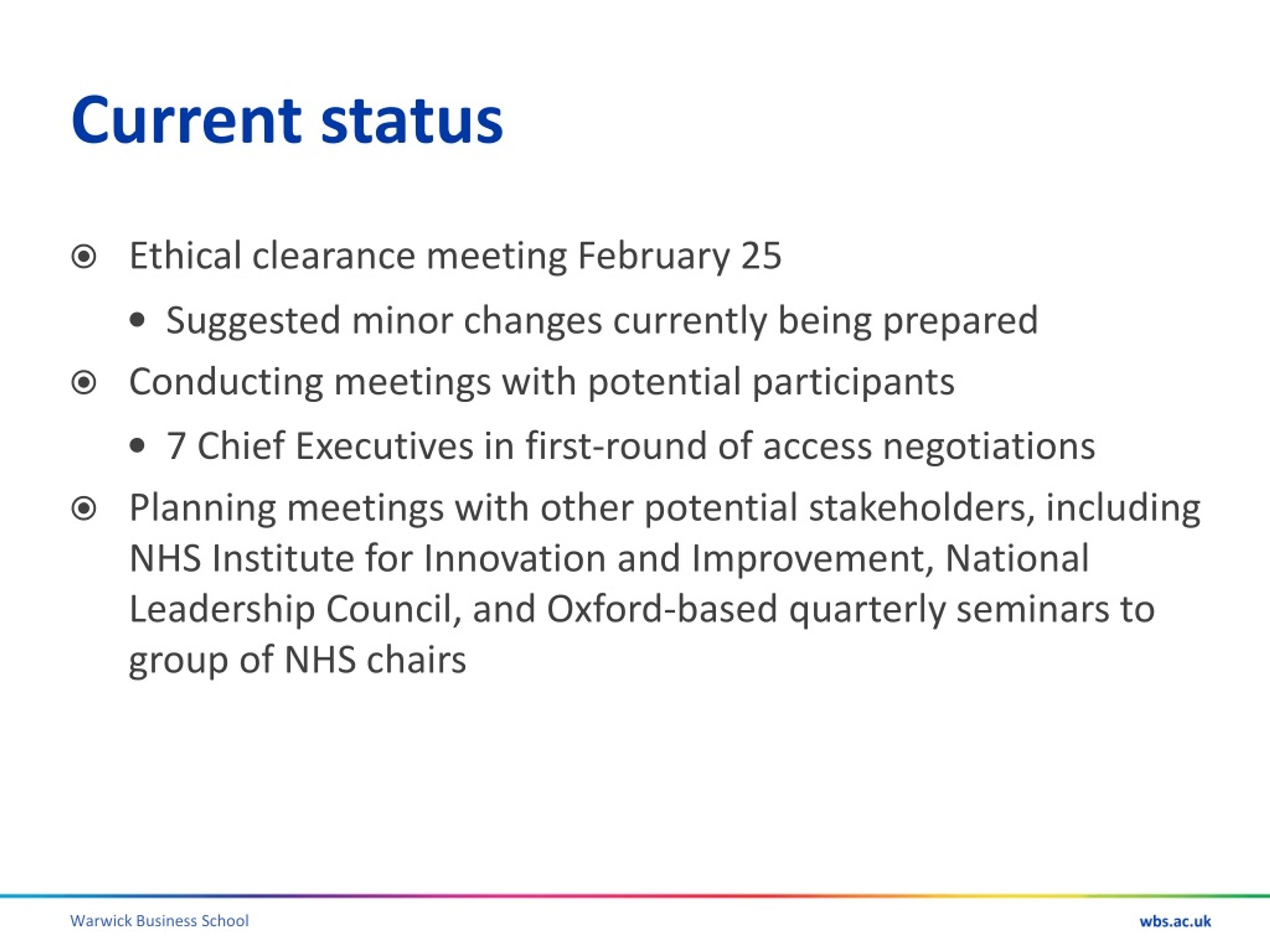

Current status • Ethical clearance meeting February 25 • Suggested minor changes currently being prepared • Conducting meetings with potential participants • 7 Chief Executives in first-round of access negotiations • Planning meetings with other potential stakeholders, including NHS Institute for Innovation and Improvement, National Leadership Council, and Oxford-based quarterly seminars to group of NHS chairs
