Implement IT: Project Control Using Baselines in Gantt Project

DESCRIPTION

Implement IT: Project Control Using Baselines in Gantt Project. Mark Sabroski. Listen to Slides. Click Here. Gantt Project Baselines. Input all the tasks with the “planned” or “expected” start/finish dates and durations as shown above. Task Properties. 2. Highlight task A

1 / 13

Download Presentation

Implement IT: Project Control Using Baselines in Gantt Project

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. Implement IT: Project Control Using Baselines in Gantt Project Mark Sabroski

  2. Listen to Slides Click Here

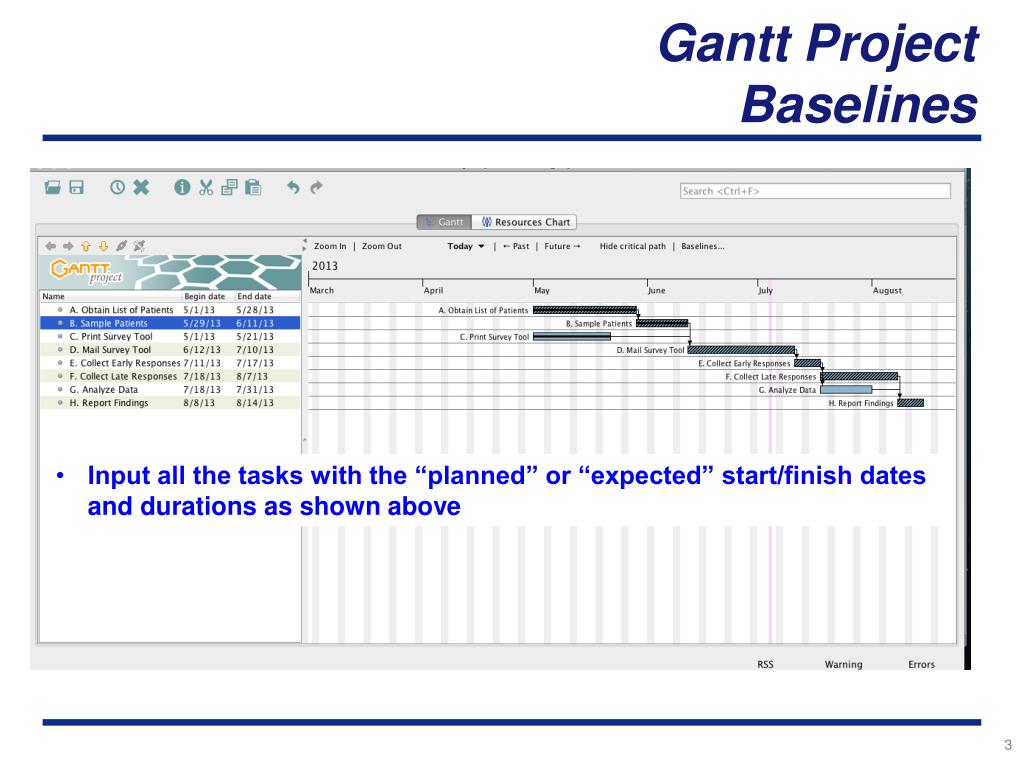

  3. Gantt Project Baselines • Input all the tasks with the “planned” or “expected” start/finish dates and durations as shown above

  4. Task Properties 2 Highlight task A Click the “properties” icon Confirm duration Input earliest begin date Input Progress = 100 (as this step is complete) Click “OK” 1 3 4 5

  5. Task Properties 2 Highlight task B Click the “properties” icon Confirm duration Input earliest begin date Input Progress = 100 (as this step is complete) Click “OK” 1 3 4 5

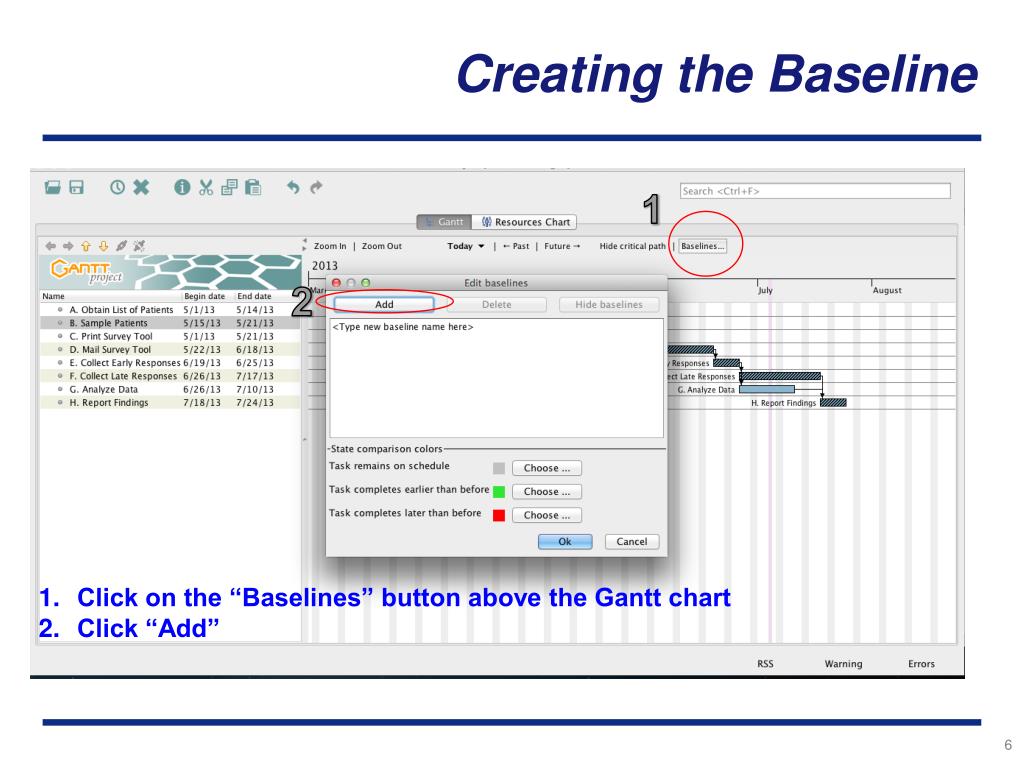

  6. Creating the Baseline 1 2 Click on the “Baselines” button above the Gantt chart Click “Add”

  7. Creating the Baseline 3 4 3. Input a name for your baseline (I named mine Baseline Test) 4. Click “Ok” * You have now set the original or planned or expected timeline as the Baseline for this project, next we’ll work on updating the “Actual” time

  8. Updating “Actual” Time 2 Highlight task A Click the “properties” icon Update duration to reflect actual time Do NOT change Do NOT Change Click “OK” 1 3 4 5

  9. Updating “Actual” Time 2 Highlight task B Click the “properties” icon Update duration to reflect actual time Do NOT change Do NOT Change Click “OK” 1 3 4 5

  10. Showing the Baseline & Actual Timeline 1 • You have now updated the project with the actual timeline • You’ll notice that steps ‘A’ and ‘B” are twice as long as the were in the baseline • 1. Click the “Baselines” button as you did before

  11. Showing the Baseline & Actual Timeline 1 2 • As before, this window will open • Select or highlight the baseline you created and named in the earlier steps • Click “OK”

  12. Final Look • This is what your final project will look like. • You’ll see the baseline times charted in red indicating that the project is taking longer than originally planned. • The critical path is highlighted by ‘greyed-out’ bars on the chart • The completed steps (A, B & C) are shown with a black line through the center of the bars.

  13. Questions?
