1 / 35

Using Simulated Annealing and Evolution Strategy scheduling capital products with complex product structure

Using Simulated Annealing and Evolution Strategy scheduling capital products with complex product structure. By: Dongping SONG Supervisors: Dr. Chris Hicks and Prof. Chris F. Earl Department of MMM Engineering University of Newcastle, Oct., 2000. Contents. Introduction

keahi
Download Presentation

Using Simulated Annealing and Evolution Strategy scheduling capital products with complex product structure

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript

  1. Using Simulated Annealing and Evolution Strategy schedulingcapital products with complex product structure By: Dongping SONG Supervisors: Dr. Chris Hicks and Prof. Chris F. Earl Department of MMM Engineering University of Newcastle, Oct., 2000.

  2. Contents • Introduction • Problem formulation • A discrete event-driven model • Simulated Annealing • Evolution Strategy • Case studies • Conclusions

  3. Introduction Production scheduling -- the allocation of resources over time to perform a collection of tasks (Baker, 1974). Two important points in scheduling: Sequencing -- in which order to perform tasks on resources Timing -- when to start and complete tasks

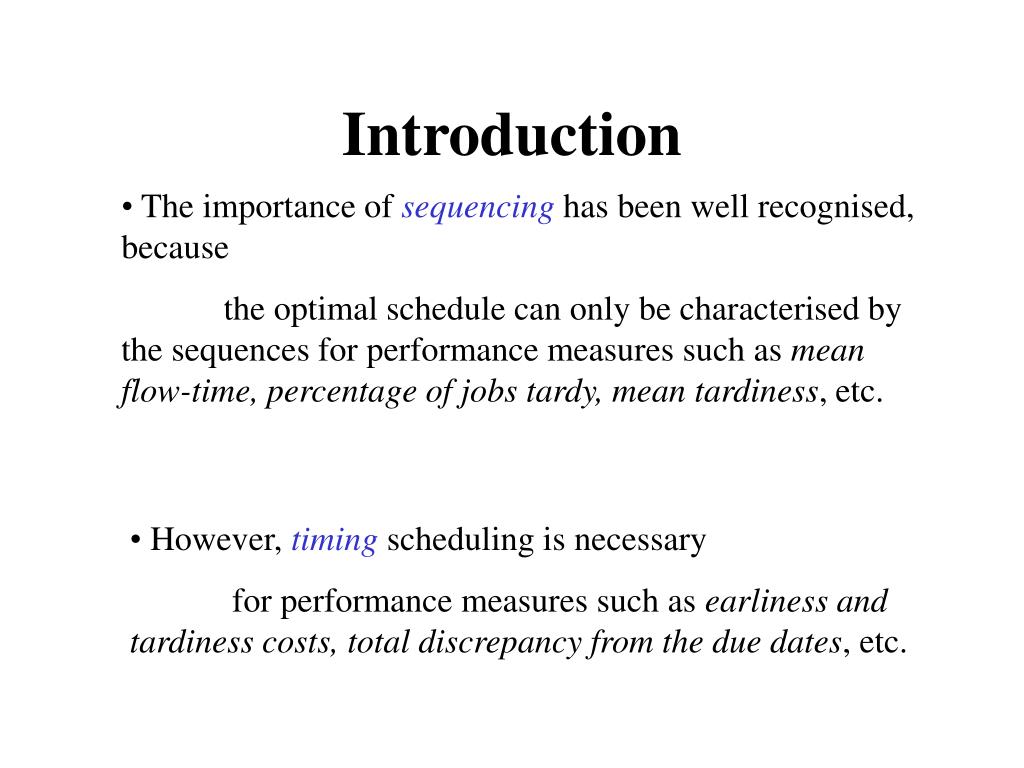

  4. Introduction • The importance of sequencing has been well recognised, because • the optimal schedule can only be characterised by the sequences for performance measures such as mean flow-time, percentage of jobs tardy, mean tardiness, etc. • However, timing scheduling is necessary • for performance measures such as earliness and tardiness costs, total discrepancy from the due dates, etc.

  5. Introduction - effect of timing Example 1. One machine with three independent jobs. Due dates Schedule A: Schedule B: Schedule C:

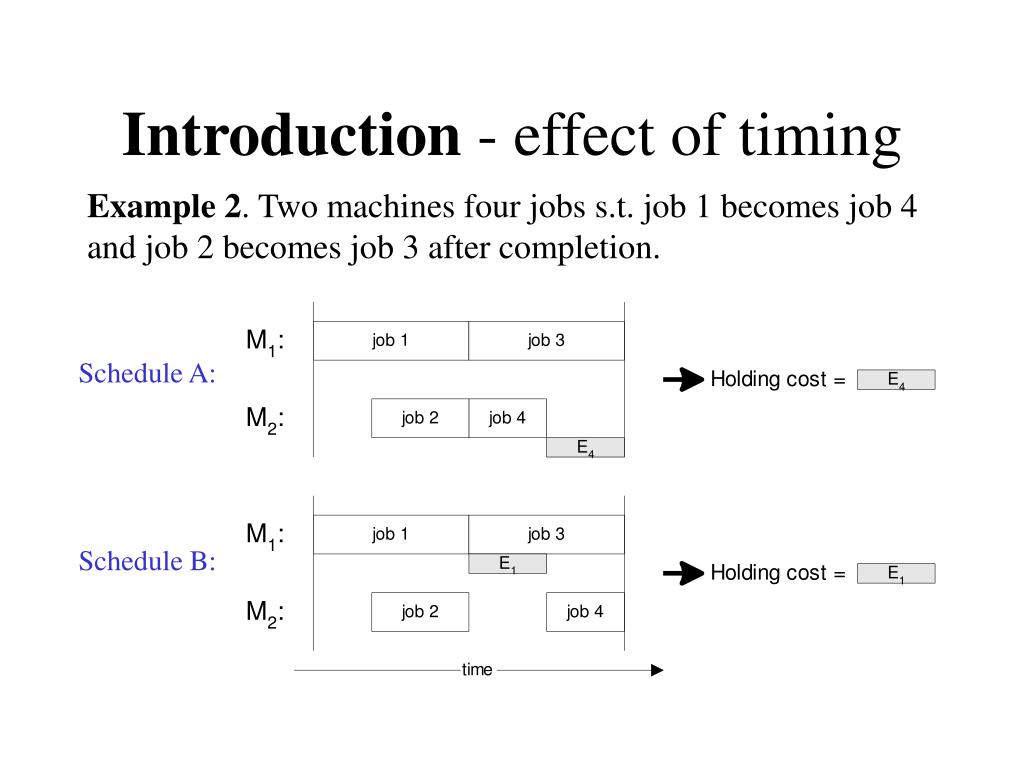

  6. Introduction - effect of timing Example 2. Two machines four jobs s.t. job 1 becomes job 4 and job 2 becomes job 3 after completion. Schedule A: Schedule B:

  7. Introduction - a capital product Complex product structure

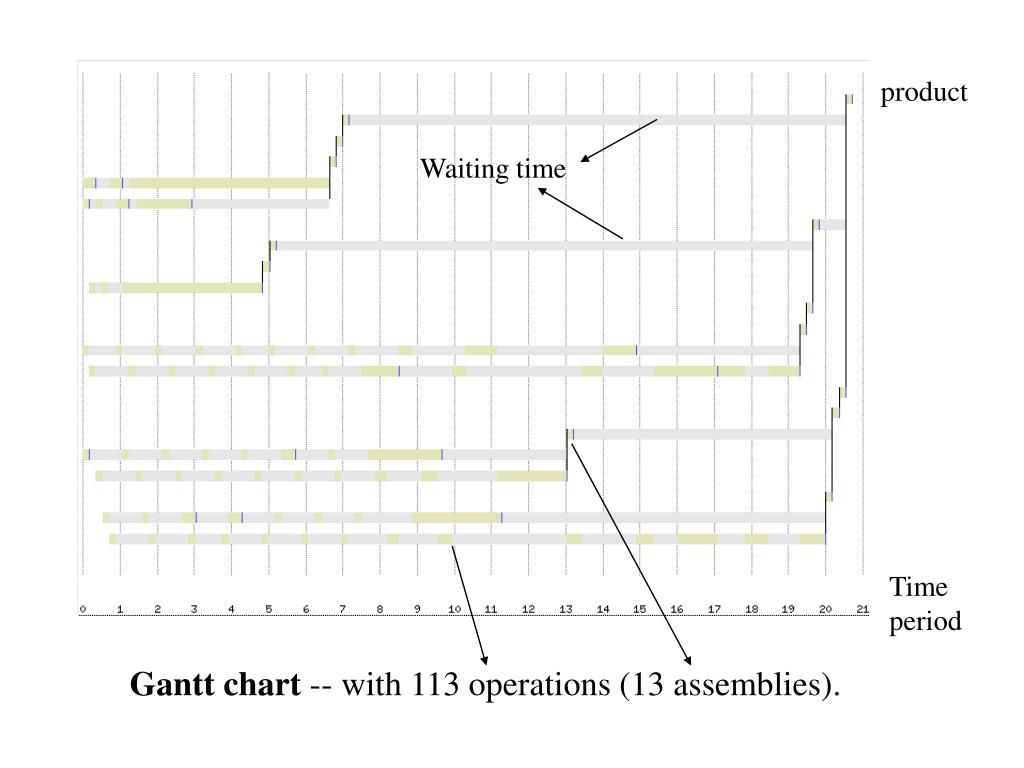

  8. product Waiting time Time period Gantt chart -- with 113 operations (13 assemblies).

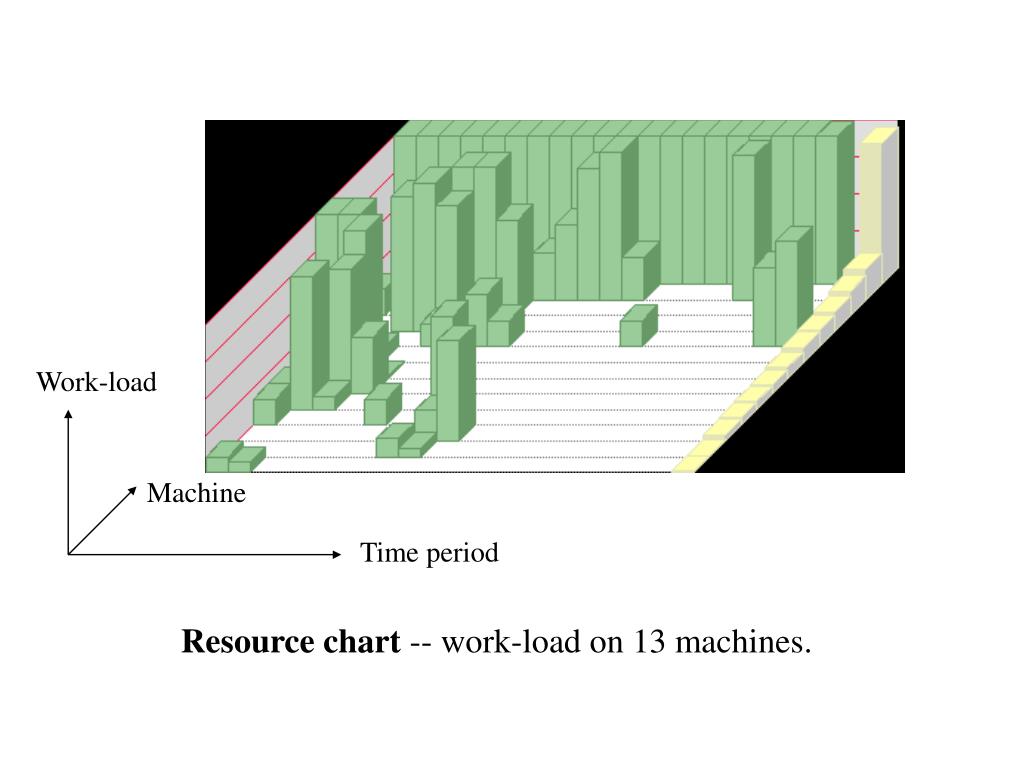

  9. Work-load Machine Time period Resource chart -- work-load on 13 machines.

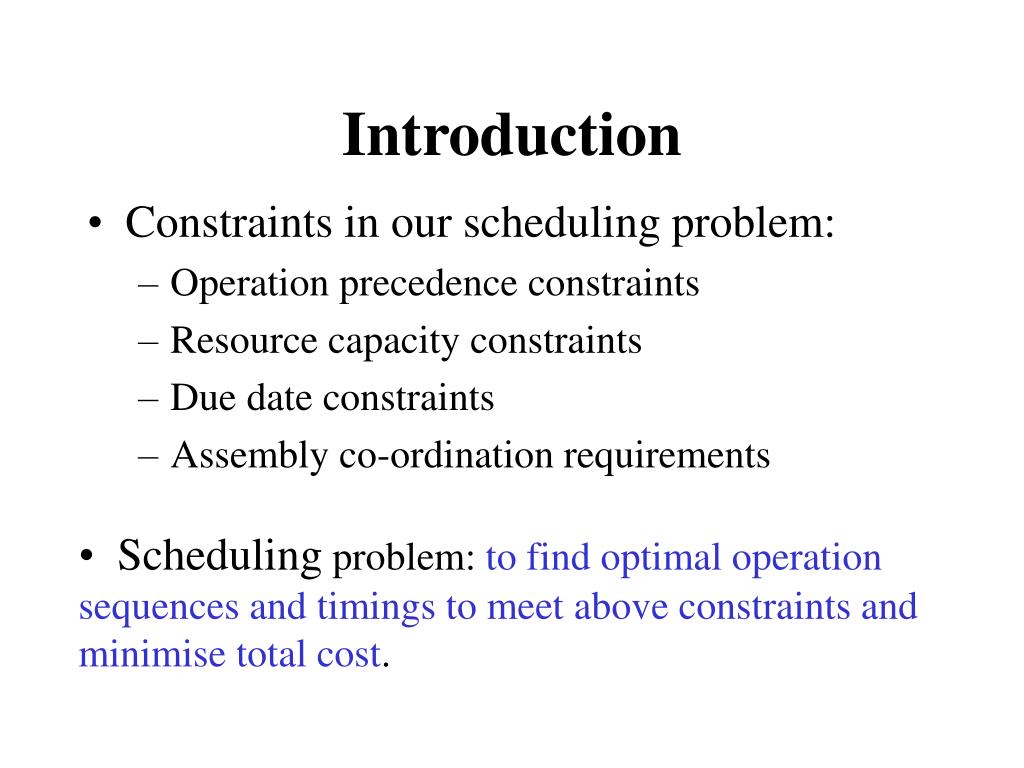

  10. Introduction • Constraints in our scheduling problem: • Operation precedence constraints • Resource capacity constraints • Due date constraints • Assembly co-ordination requirements • Scheduling problem: to find optimal operation sequences and timings to meet above constraints and minimise total cost.

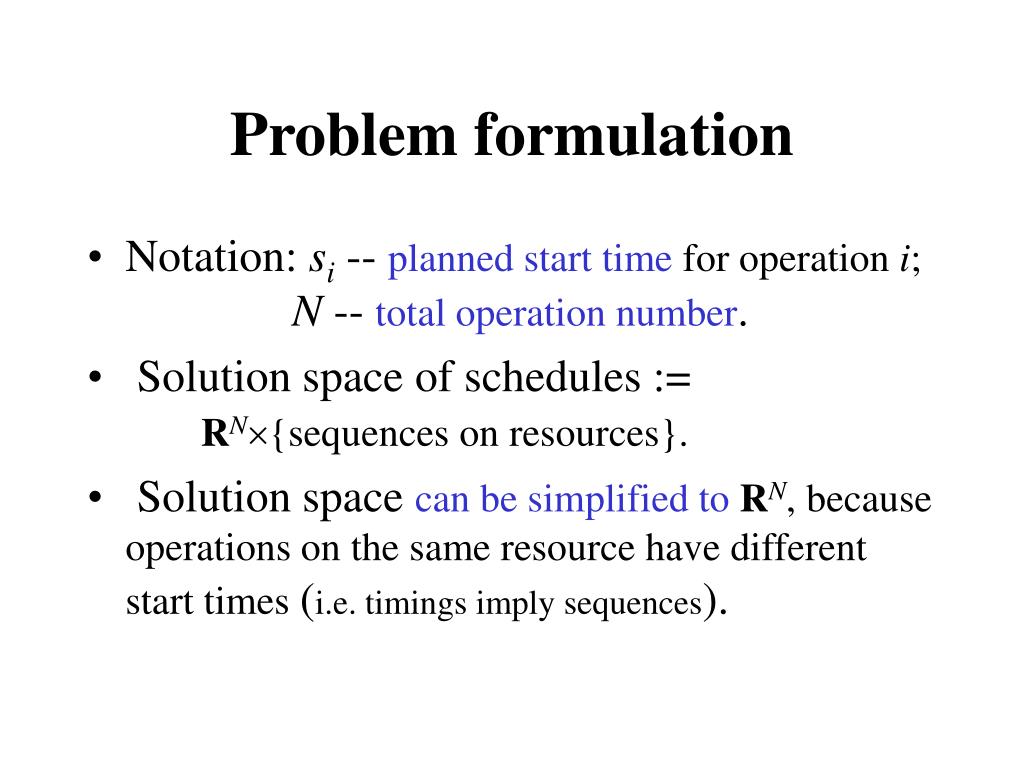

  11. Problem formulation • Notation: si -- planned start time for operation i;N -- total operation number. • Solution space of schedules := RN´{sequences on resources}. • Solution space can be simplified to RN, because operations on the same resource have different start times (i.e. timings imply sequences).

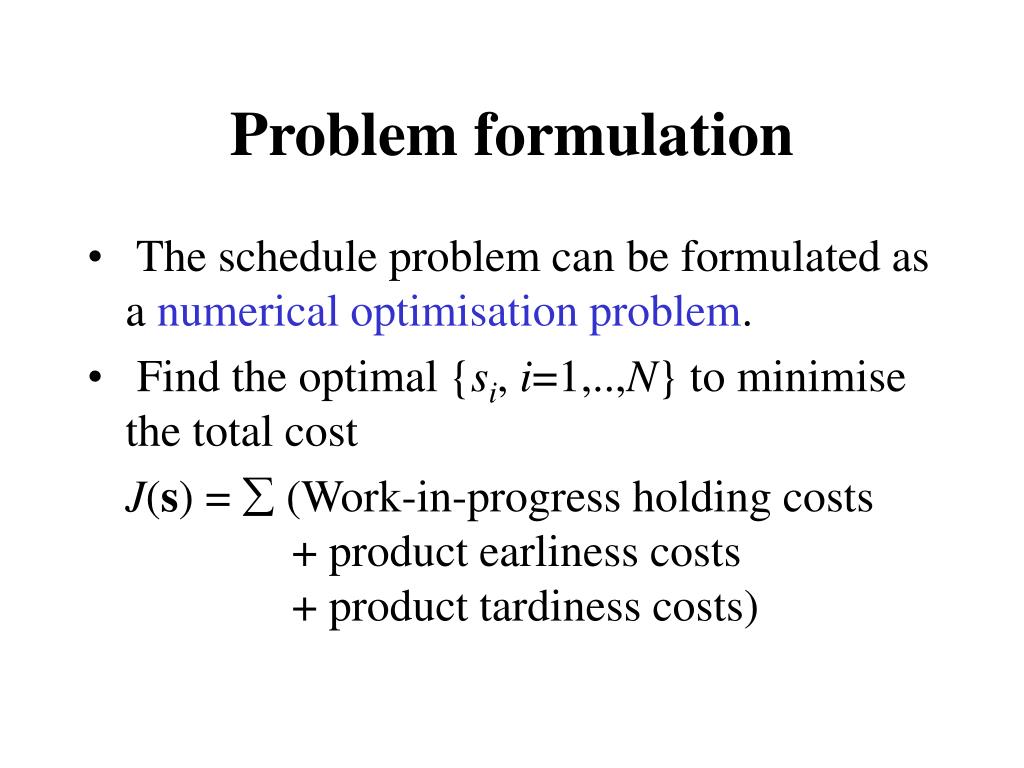

  12. Problem formulation • The schedule problem can be formulated as a numerical optimisation problem. • Find the optimal {si, i=1,..,N} to minimise the total cost J(s) = å (Work-in-progress holding costs + product earliness costs + product tardiness costs)

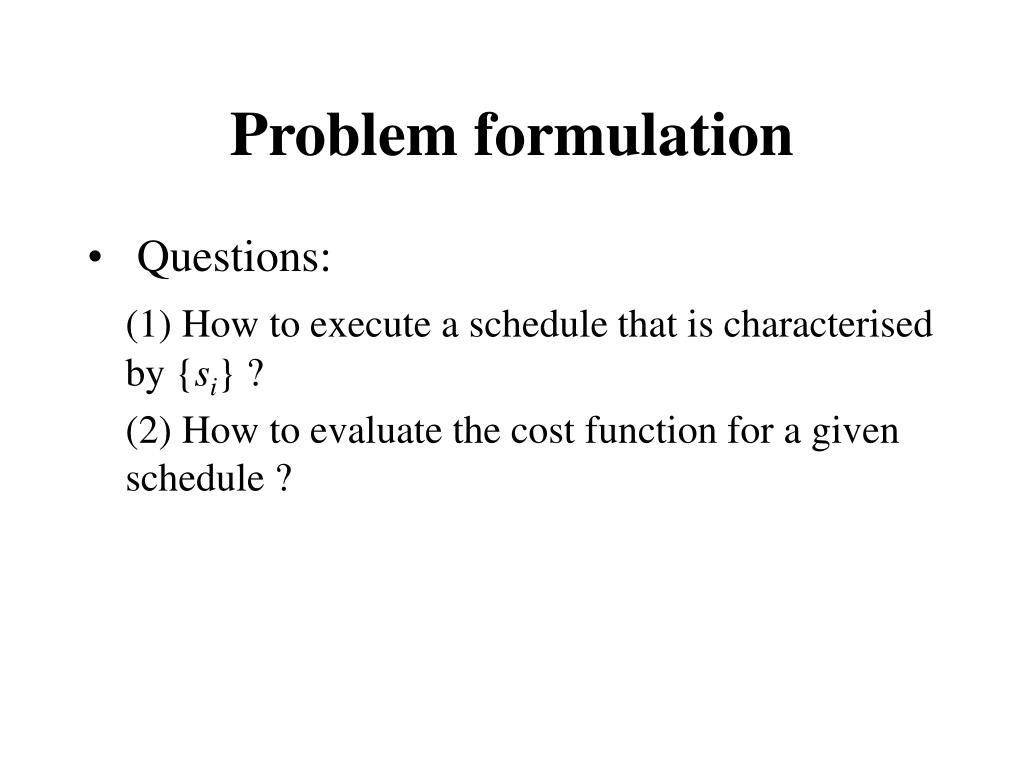

  13. Problem formulation • Questions: (1) How to execute a schedule that is characterised by {si} ? (2) How to evaluate the cost function for a given schedule ?

  14. Discrete event-driven model • Two types of events : • the start of an operation • the completion of an operation. • Two constraints to trigger the start events : • Physical constraints : an event cannot occur before all preceding events are completed. • Planning constraints : an operation cannot be started before its planned start time si.

  15. Discrete event-driven model The evolution of the system for a given schedule {si} can be described by: • If a resource is idle, an operation will be processed as soon as the physical and planning constraints are satisfied. • If there is a queue of operations ready for processing, the operation with the earliest siwill be processed first.

  16. Simulated Annealing • Neighbourhood of a solution -- by adding a random number to each si. • Outer loop -- cooling the temperature T until T=0. • Inner loop -- perform Metropolis simulation with fixed T to find equilibrium state.

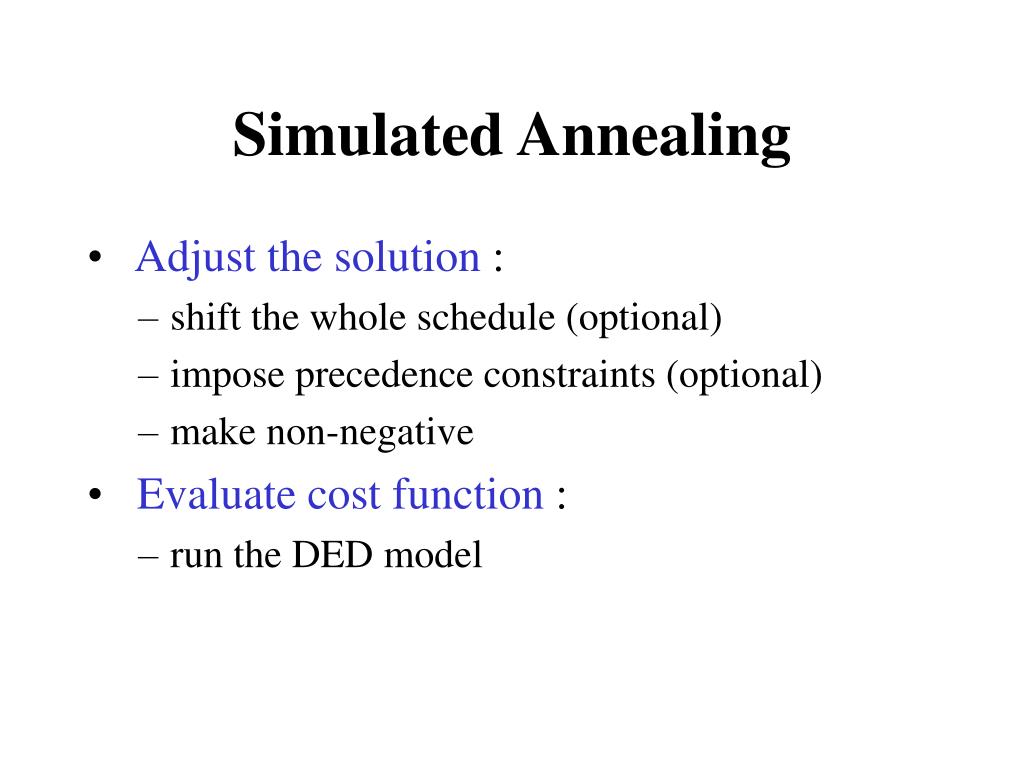

  17. Simulated Annealing • Adjust the solution : • shift the whole schedule (optional) • impose precedence constraints (optional) • make non-negative • Evaluate cost function : • run the DED model

  18. Simulated Annealing

  19. Evolution Strategy • Similarity of Genetic Algorithms and ES: • model organic evolution. • iterative scheme including “selection”, “crossover” and “mutation”. • Difference of GA and ES: • GA uses binary or string representations, suitable for combinatorial optimisation problem. • ES uses continuous variable, suitable for numerical optimisation problem.

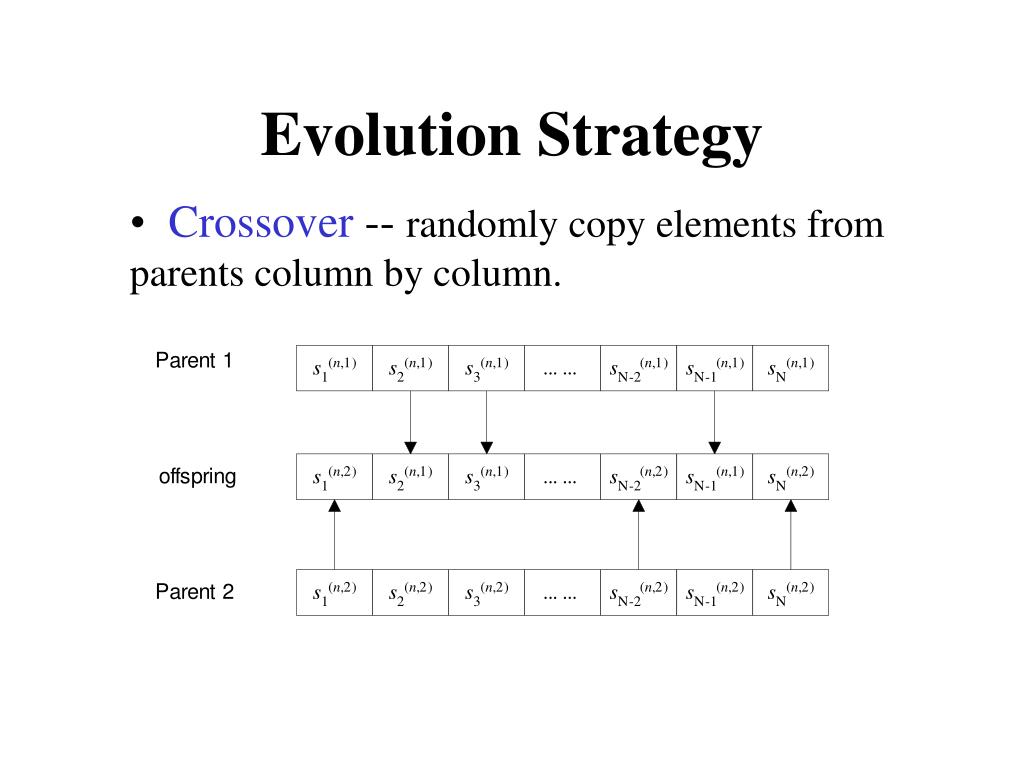

  20. Evolution Strategy • Crossover -- randomly copy elements from parents column by column.

  21. Evolution Strategy • Mutation -- add a random number from a Normal distribution to each element.

  22. Evolution Strategy • Adjust the solution : • shift the whole schedule (optional) • impose precedence constraints (optional) • make non-negative • Evaluate cost function -- run the DED model. • Selection -- choose a set of best offspring as parents for the next generation

  23. Evolution Strategy

  24. Case studies Characteristics of scheduling problems

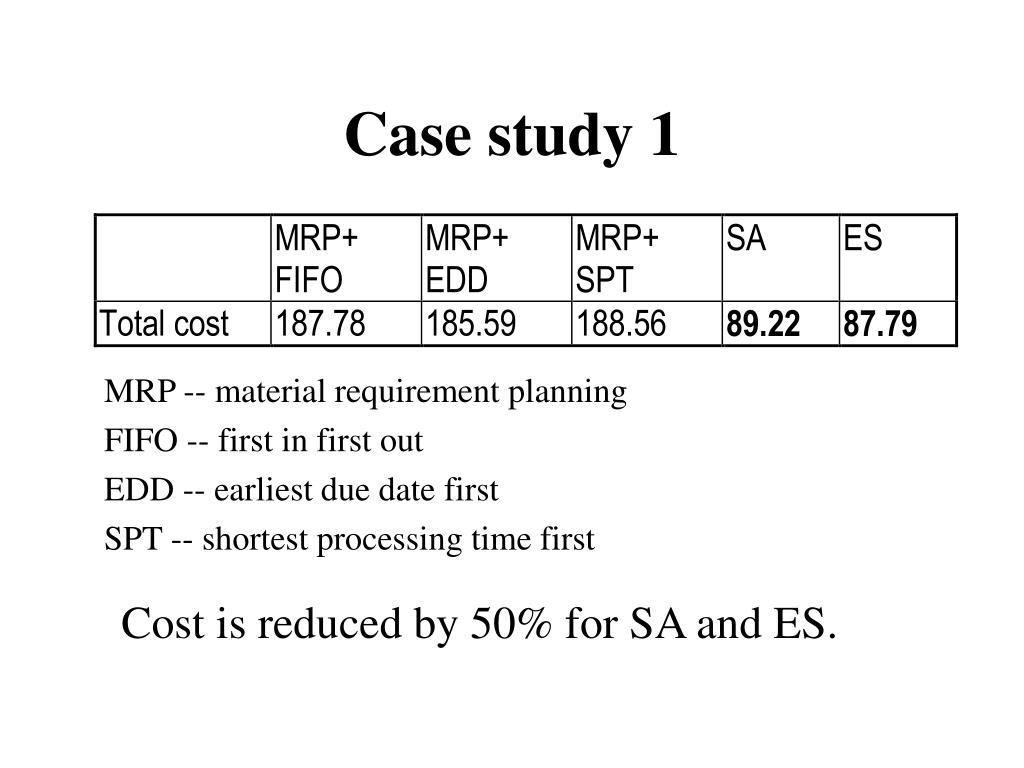

  25. Case study 1 MRP -- material requirement planning FIFO -- first in first out EDD -- earliest due date first SPT -- shortest processing time first Cost is reduced by 50% for SA and ES.

  26. Case study 1 -- cost v.s cpu Cost SA ES CPU(s) Total cost v.s. CPU time for SA and ES

  27. Case study 1 -- ES method Cost Maximum cost at each generation Maximum cost in all parents CPU(s) Minimum cost at each generation

  28. Case study 2 Cost is reduced by 50% for SA and ES.

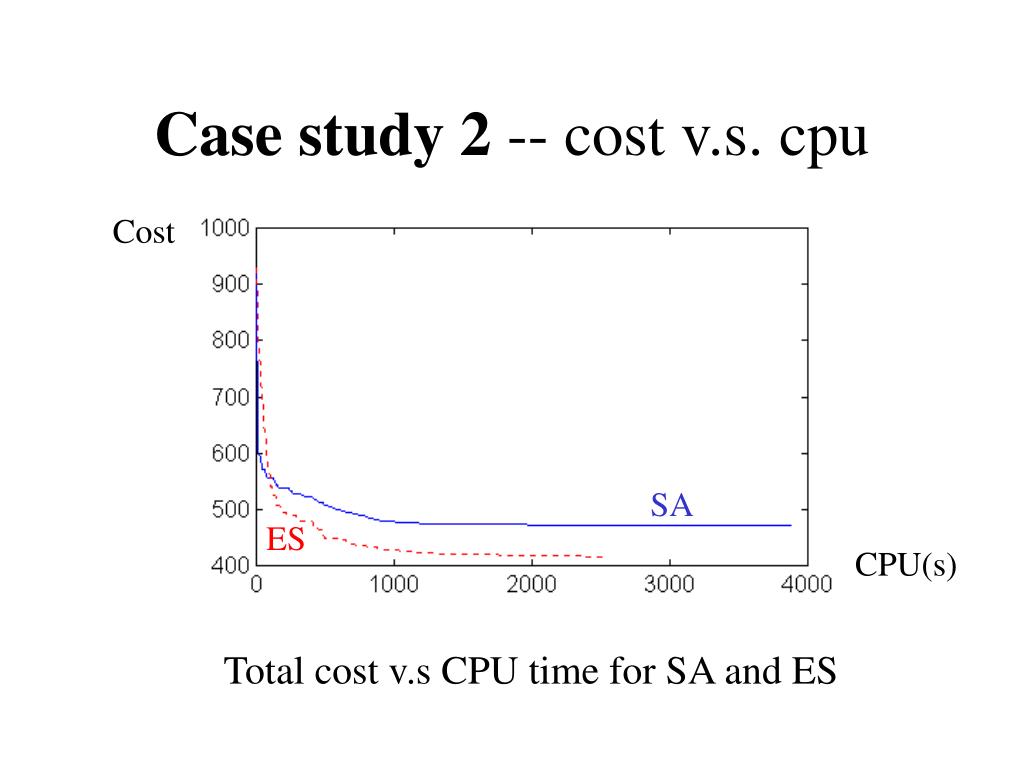

  29. Case study 2 -- cost v.s. cpu Cost SA ES CPU(s) Total cost v.s CPU time for SA and ES

  30. Case study 2 -- ES method Cost Maximum cost at each generation Maximum cost in all parents CPU(s) Minimum cost at each generation

  31. Conclusions • SA and ES can reduce total cost by 50% compared with MRP+dispatching rules. • ES is generally better than SA in both cost and CPU time. • ES is more robust to its initial parameter selection than SA.

  32. Conclusions • Suggestions for SA initial parameters: • T0 and step-size is taken from [d/N, 20*d/N]; • Temperature cooling rate > 0.5 and step-size reduction factors > 0.70; • No-improvement number at inner loop > N/2; • Suggestions for ES initial parameters: • Offspring population is from [N/2, 2*N]; • Parent population is 1/10 to 1/5 of offspring; • Initial standard deviation is from [d/N, 5*d/N].

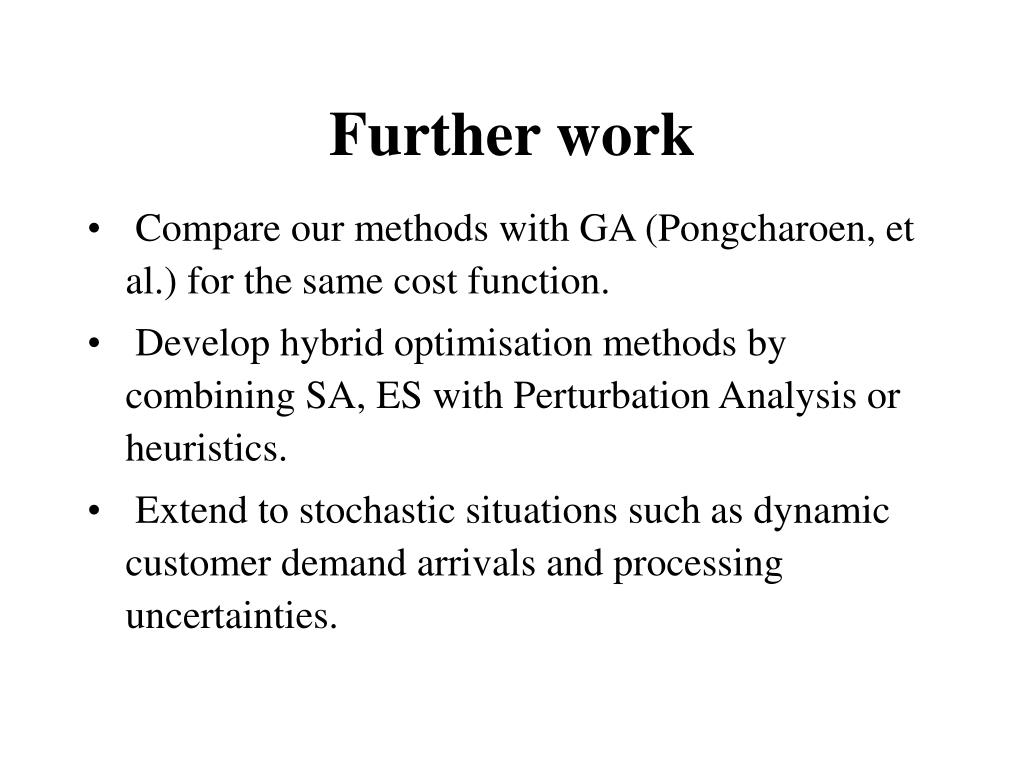

  33. Further work • Compare our methods with GA (Pongcharoen, et al.) for the same cost function. • Develop hybrid optimisation methods by combining SA, ES with Perturbation Analysis or heuristics. • Extend to stochastic situations such as dynamic customer demand arrivals and processing uncertainties.

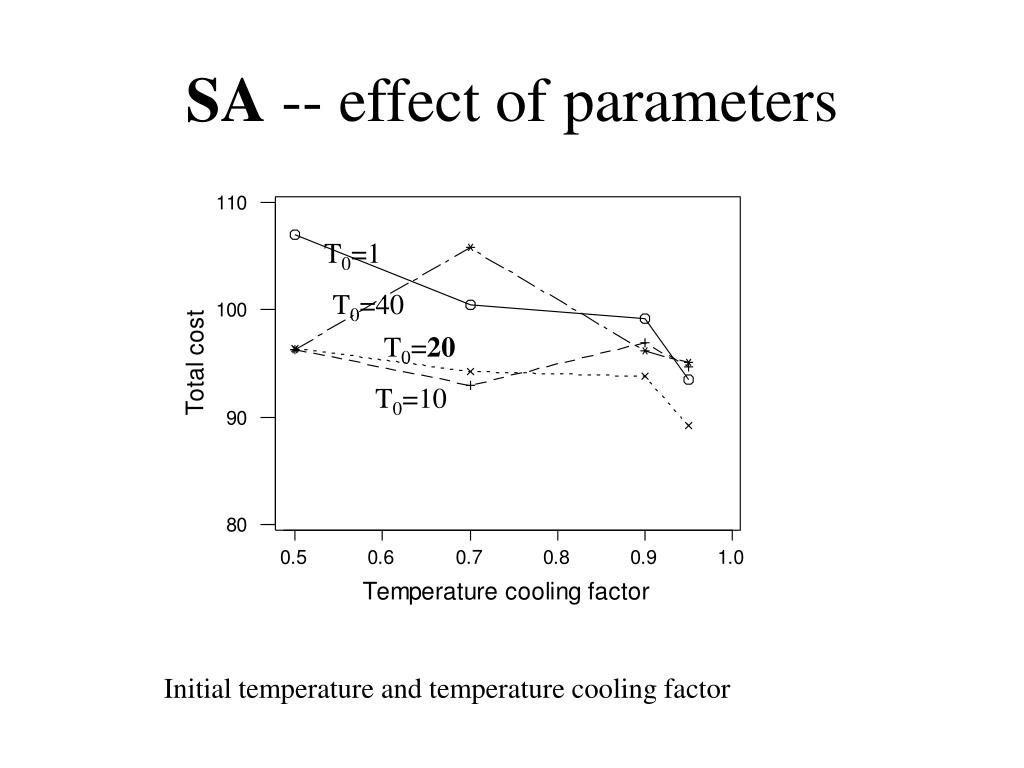

  34. SA -- effect of parameters T0=1 T0=40 T0=20 T0=10 Initial temperature and temperature cooling factor

  35. ES -- effect of parameters Solid-line : ON/GN=80/250 dashed-line: ON/GN=100/400 dotted-line: ON/GN=160/250 dash-dotted: ON/GN=200/200 Offspring Number(ON)/Generation Number(GN) and Standard deviation reduction factor
