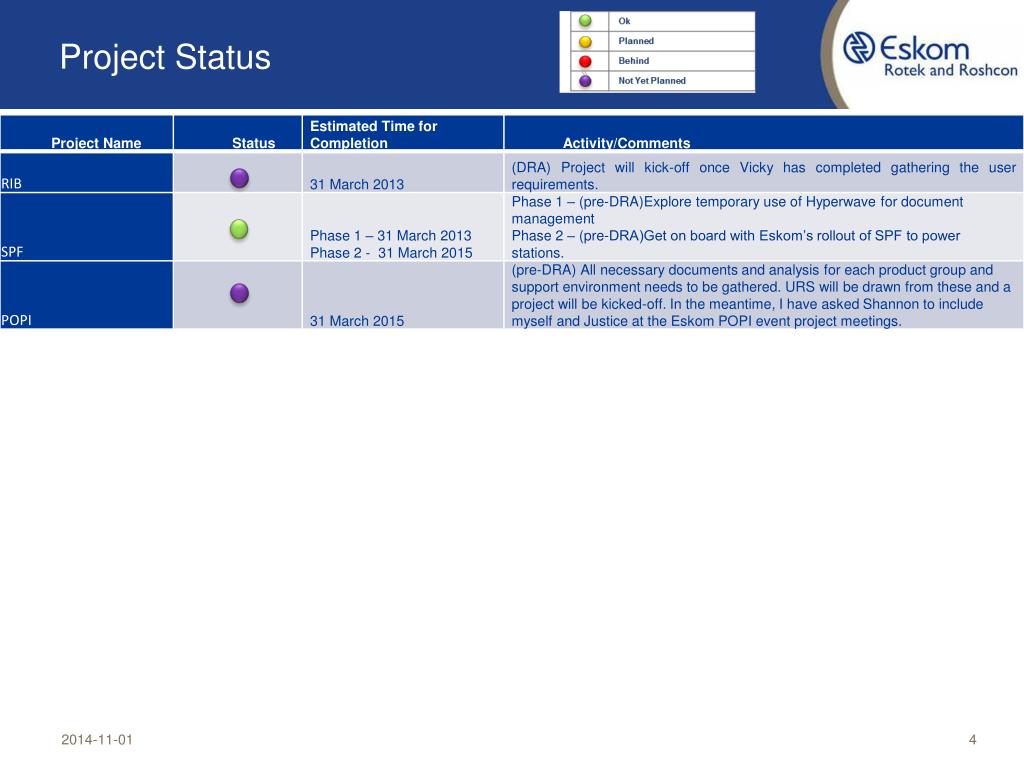

Information Management Portfolio Management Weekly Feedback. Created by: Nkekolo Manana Date: 18/10/2013. Project Status. Project Status…. cont. Project Status. Achievements / Highlights for the week. Attended the following meetings:
Information Management Portfolio Management Weekly Feedback
E N D
Presentation Transcript
Information ManagementPortfolio ManagementWeekly Feedback Created by: Nkekolo Manana Date: 18/10/2013

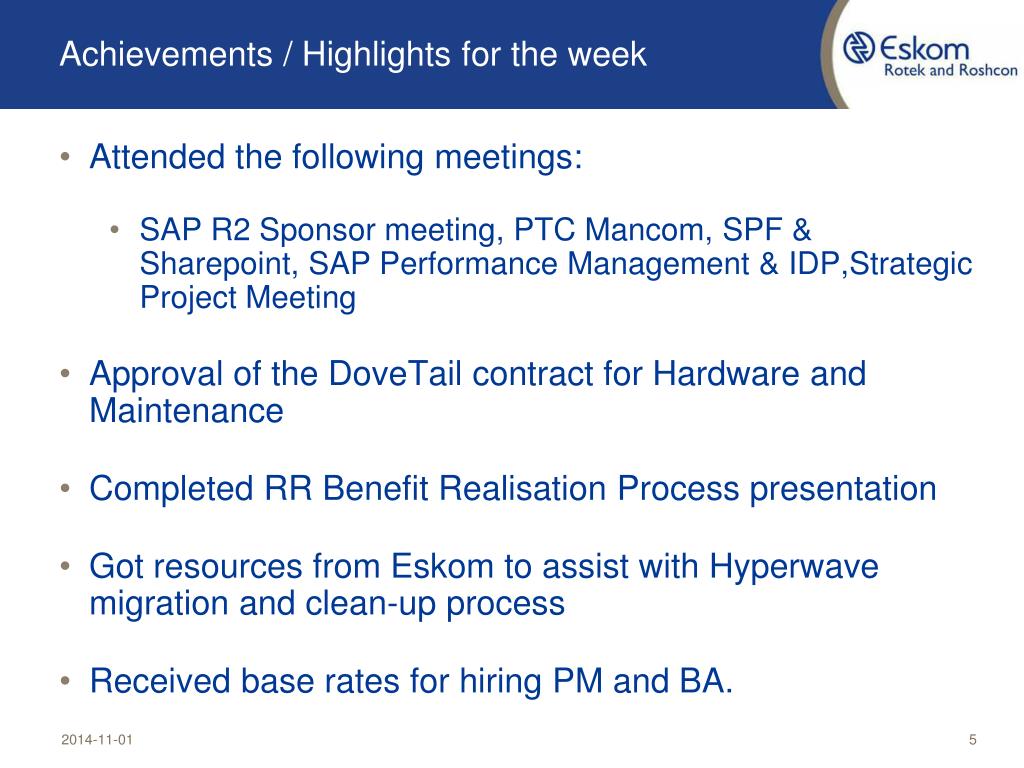

Achievements / Highlights for the week • Attended the following meetings: • SAP R2 Sponsor meeting, PTC Mancom, SPF & Sharepoint, SAP Performance Management & IDP,Strategic Project Meeting • Approval of the DoveTail contract for Hardware and Maintenance • Completed RR Benefit Realisation Process presentation • Got resources from Eskom to assist with Hyperwave migration and clean-up process • Received base rates for hiring PM and BA.

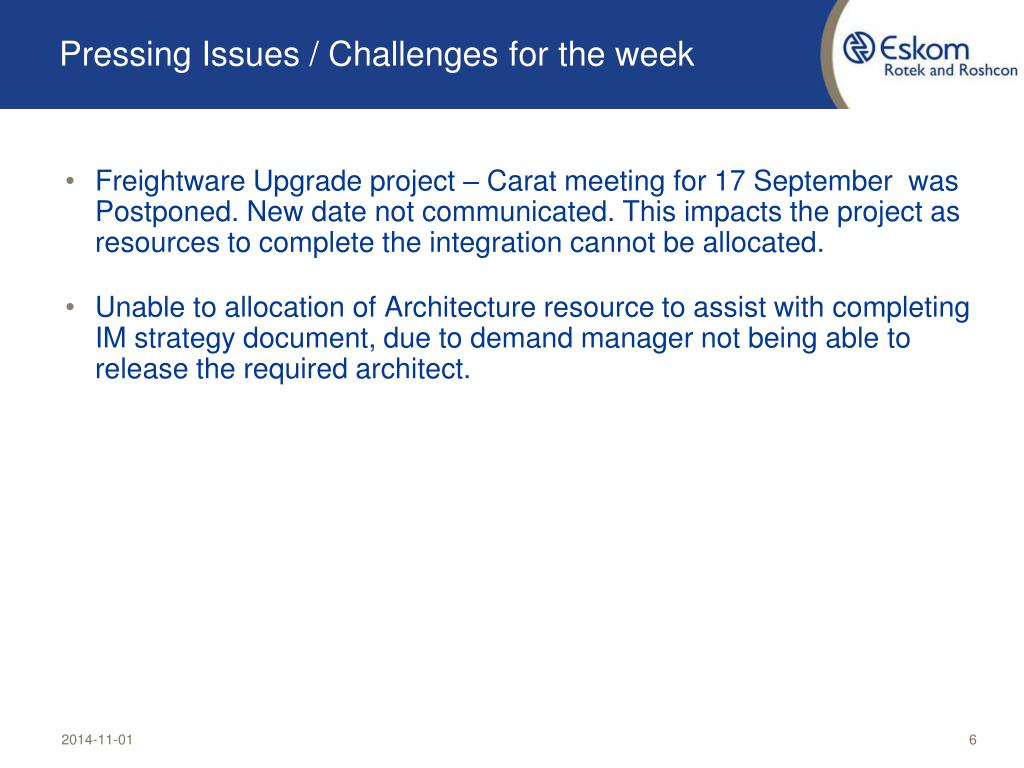

Pressing Issues / Challenges for the week • Freightware Upgrade project – Carat meeting for 17 September was Postponed. New date not communicated. This impacts the project as resources to complete the integration cannot be allocated. • Unable to allocation of Architecture resource to assist with completing IM strategy document, due to demand manager not being able to release the required architect.

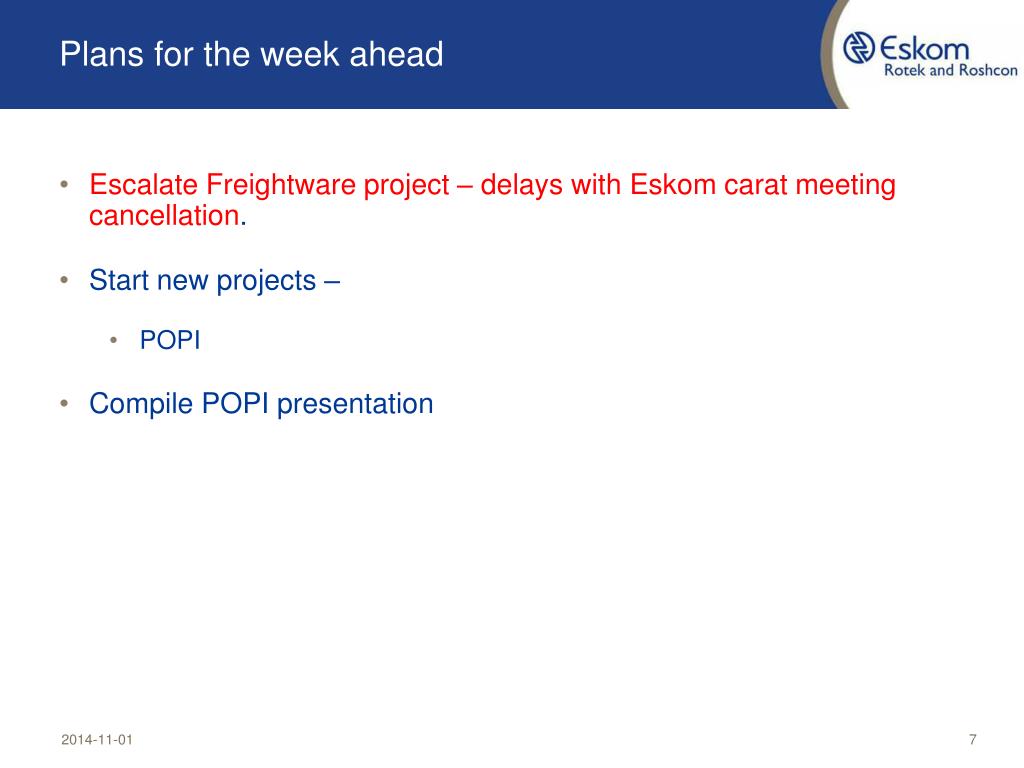

Plans for the week ahead • Escalate Freightware project – delays with Eskom carat meeting cancellation. • Start new projects – • POPI • Compile POPI presentation
