Wegmans Fresh Bread and Roll Scaling Area. Project Review II. Erik Webster Kate Gleason Cecilia Enestrom Grant Garbach Andrew Tsai. Project Timeline. DMAIC Strategy Define 12/1/2008 – 12/19/2008 Measure 12/15/2008 – 1/16/2009 Analyze 1/16/2009 – 2/20/2009 Improve 2/20/2009 – 4/10/2009
E N D
Wegmans Fresh Bread and Roll Scaling Area Project Review II Erik Webster Kate Gleason Cecilia Enestrom Grant Garbach Andrew Tsai

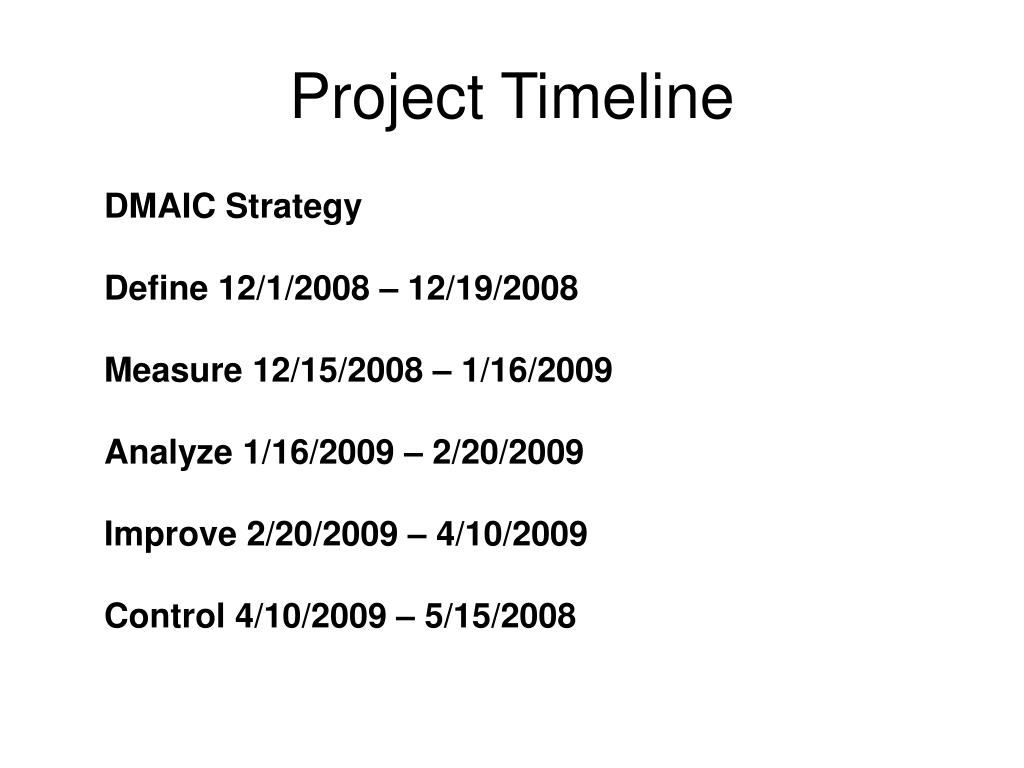

Project Timeline DMAIC Strategy Define 12/1/2008 – 12/19/2008 Measure 12/15/2008 – 1/16/2009 Analyze 1/16/2009 – 2/20/2009 Improve 2/20/2009 – 4/10/2009 Control 4/10/2009 – 5/15/2008
Ergonomics Background Information • Lifting tasks pose a high risk of injury to the production employees • 4.6% of injuries in the bakeshop can be attributed to the scaling operation • Accounted for 9.6% of the total committed charges resulting from workplace injuries to the Bake Shop in 2008 • Accounted for 21.32% of the total incurred costs resulting form workplace injuries to the Bake Shop in 2008 • The scaling project aims to reduce these costs by eliminating or manipulating lifting tasks that are not ergonomically acceptable

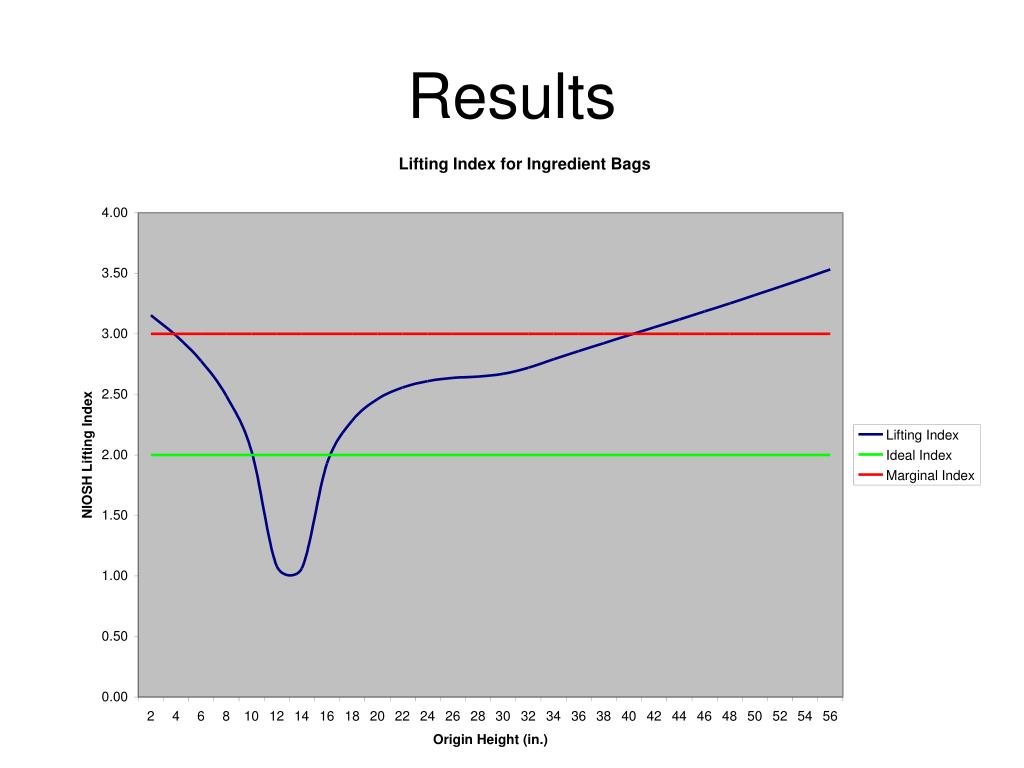

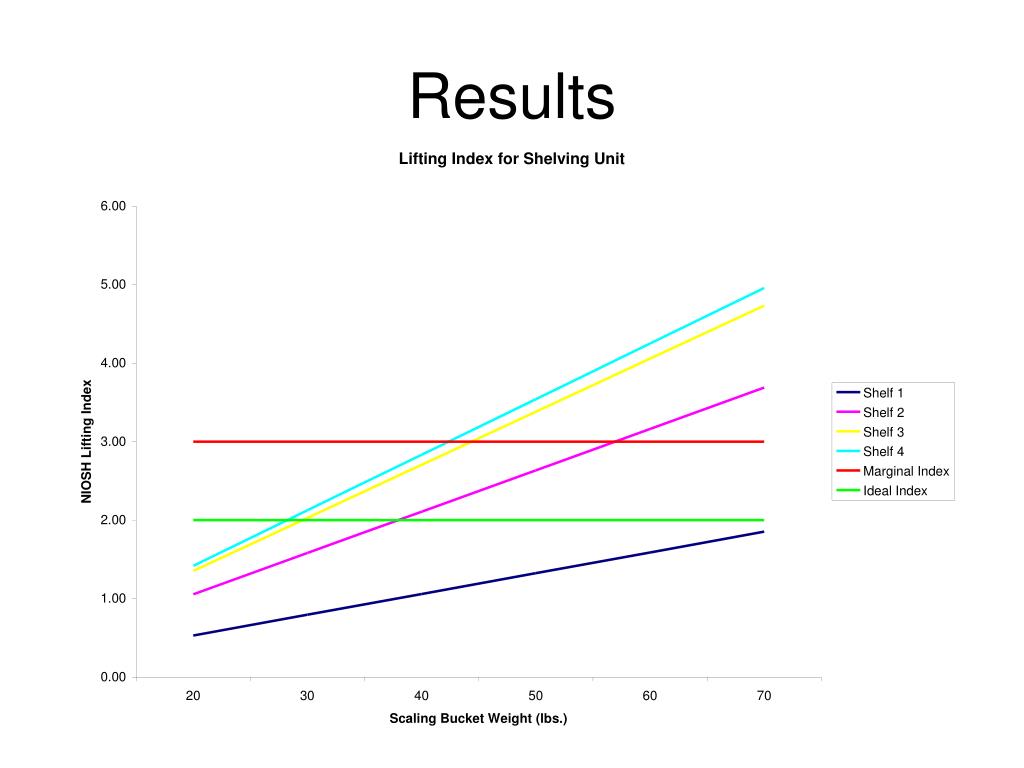

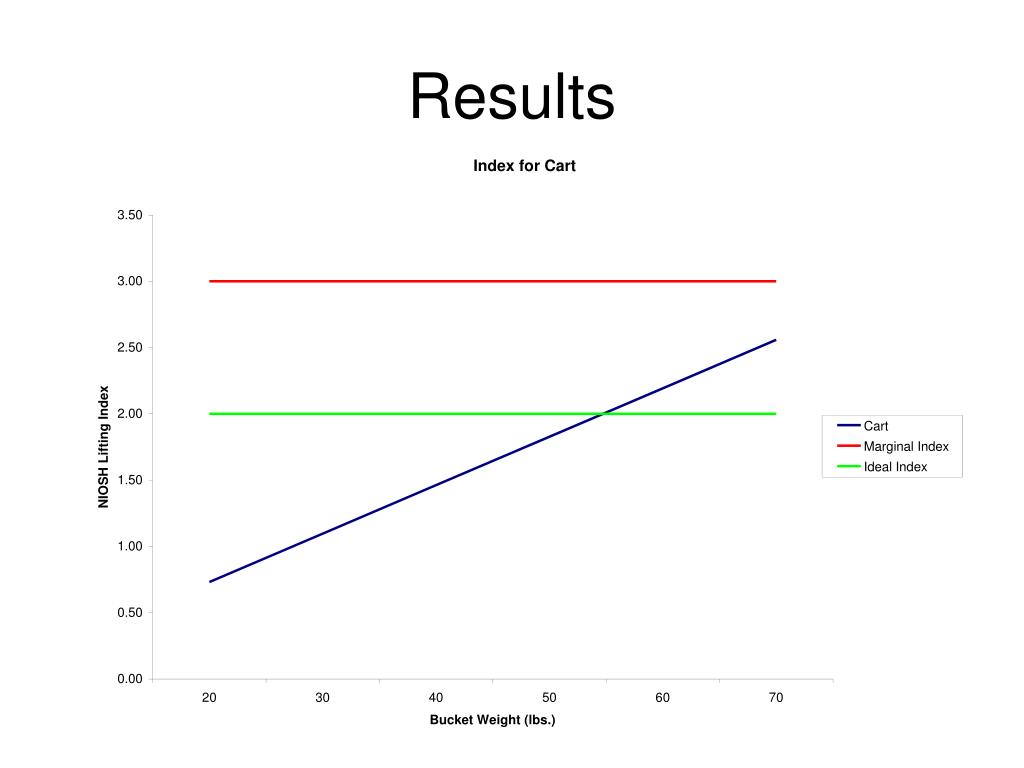

Objective and Methodology • Calculate the NIOSH Index for each lifting task • The NIOSH Index provides a guideline to evaluate potential lifting-related injuries that could result from the scaling operation • Index >2.00 poses an increased risk of injury to less capable workers • Index >3.00 poses a risk of injury to all workers

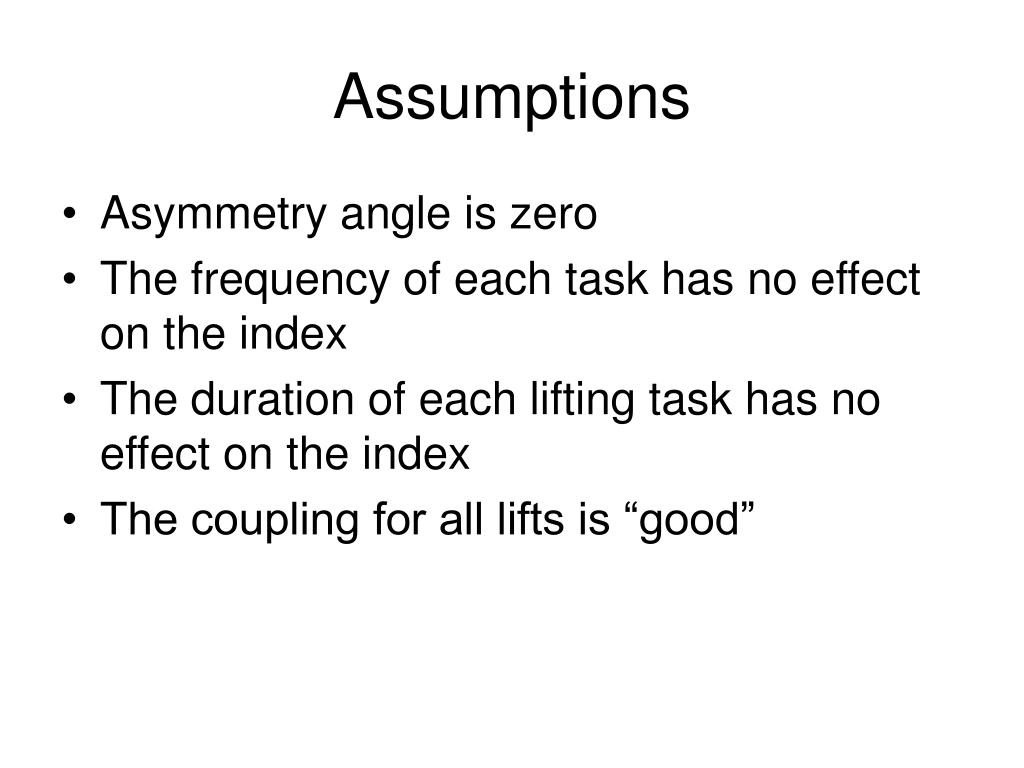

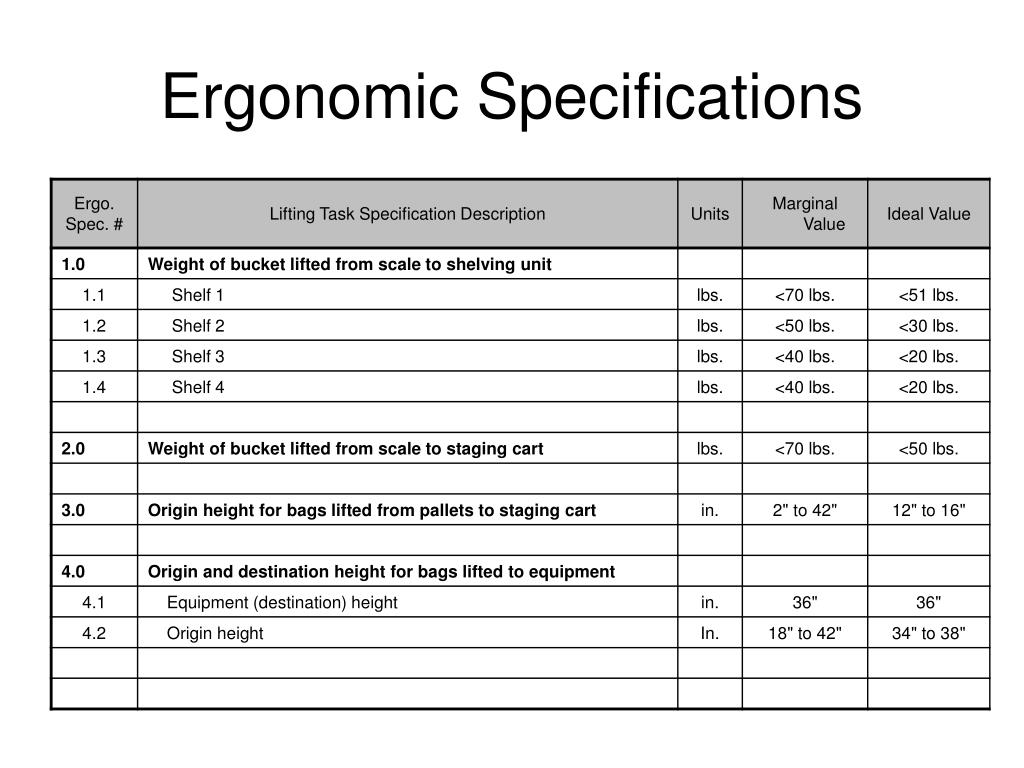

Assumptions • Asymmetry angle is zero • The frequency of each task has no effect on the index • The duration of each lifting task has no effect on the index • The coupling for all lifts is “good”

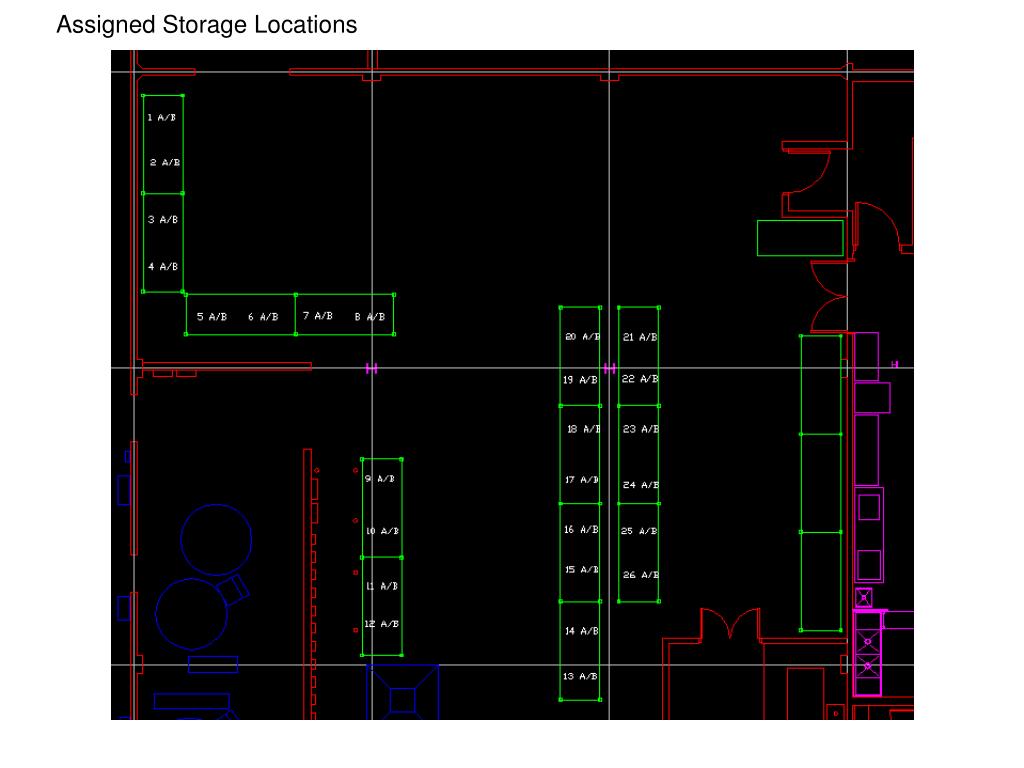

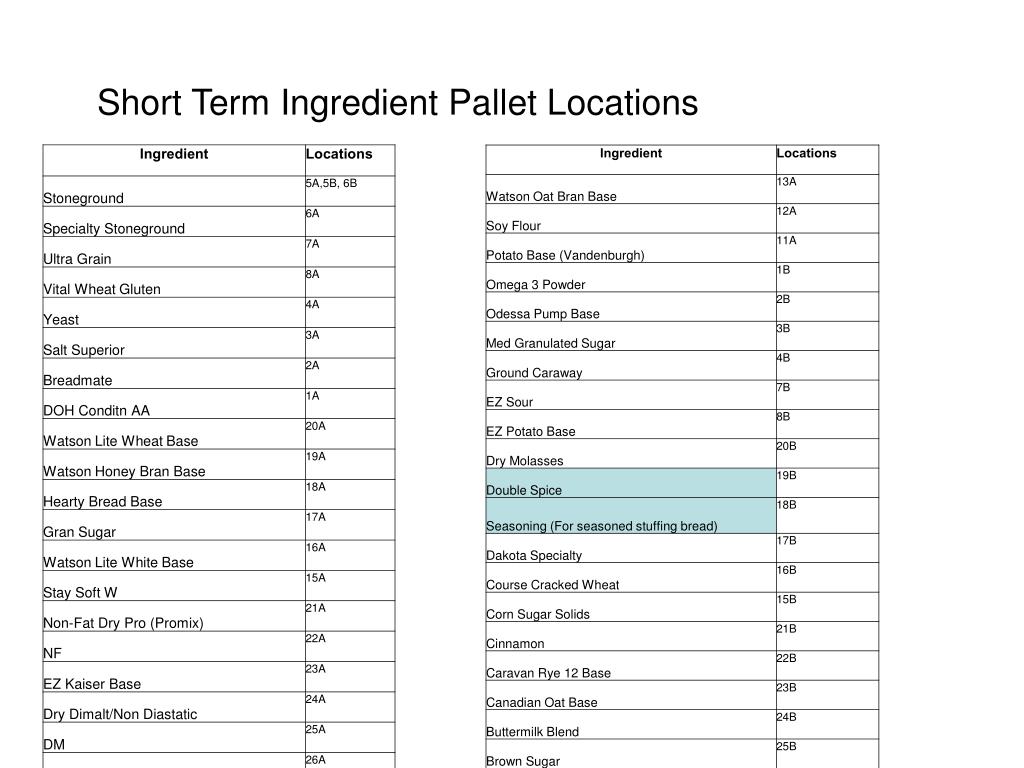

New Layout & Process Improvement Customer Needs • Area for short-term storage • Area for long-term storage • Relocate the scaling area into the current short-term storage room • AutoCAD drawing of improved layout • New process flow diagram

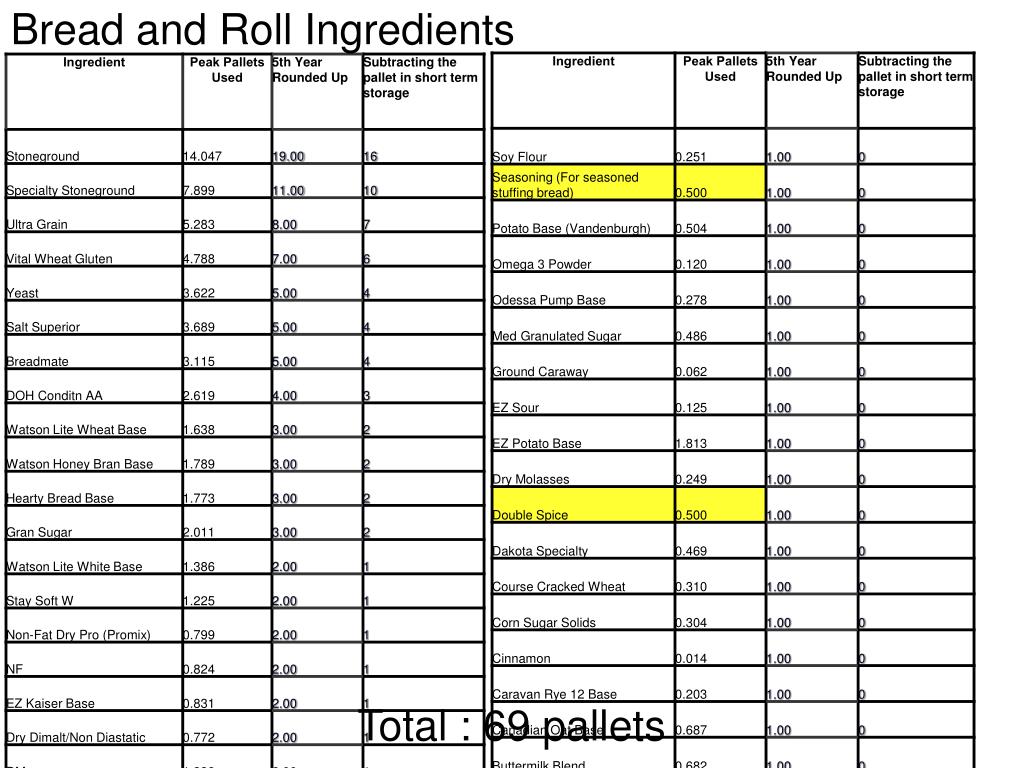

Bread and Roll Ingredients Total : 114 pallets
Bread and Roll Ingredients Total : 69 pallets

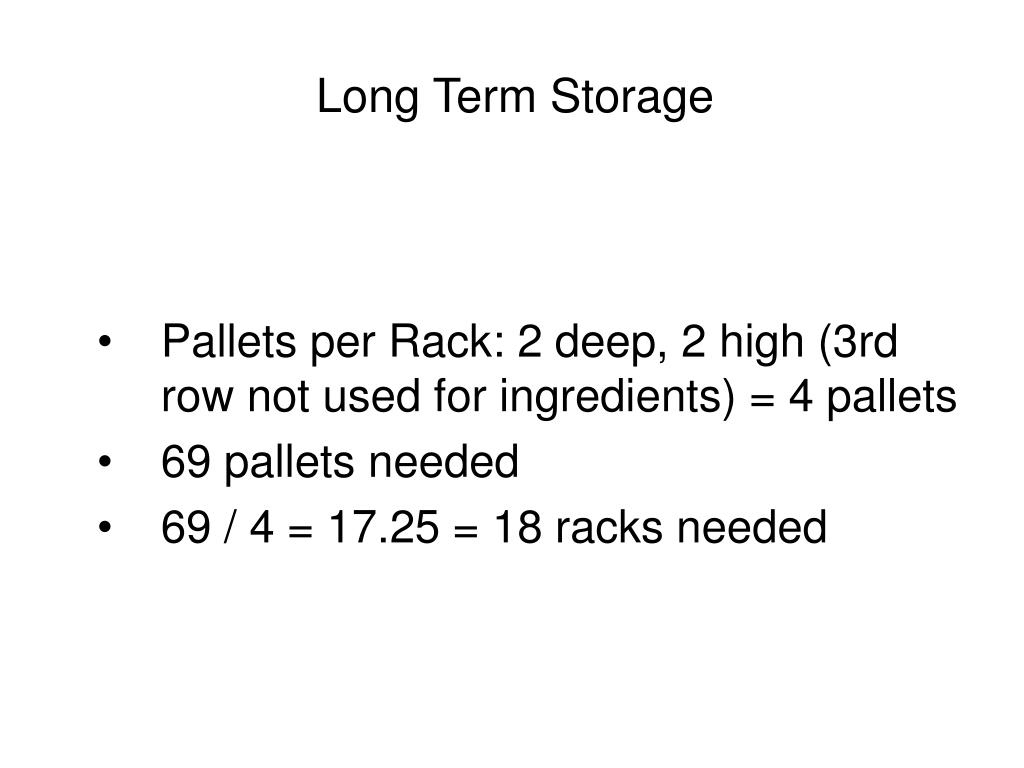

Long Term Storage • Pallets per Rack: 2 deep, 2 high (3rd row not used for ingredients) = 4 pallets • 69 pallets needed • 69 / 4 = 17.25 = 18 racks needed

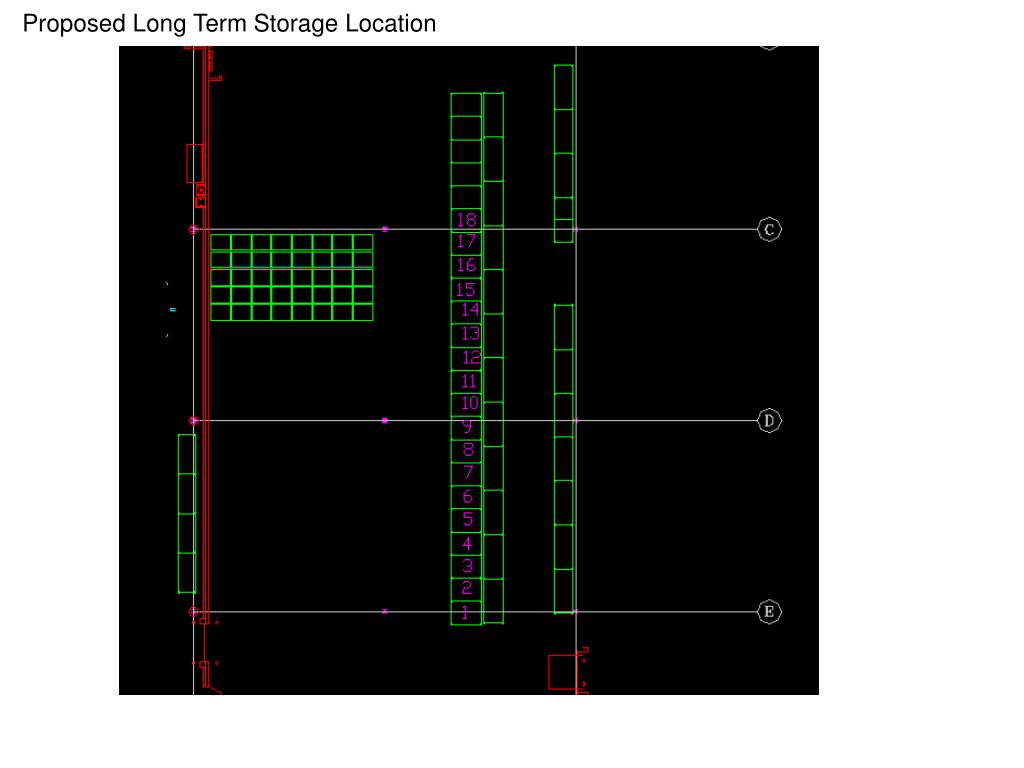

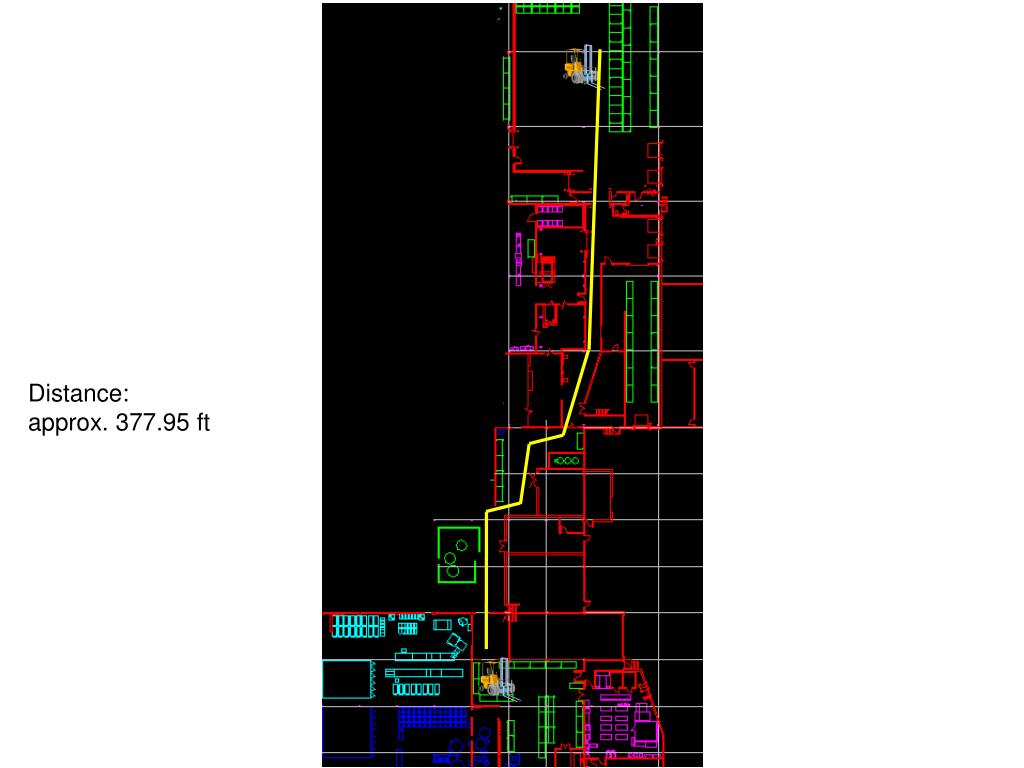

Distance: approx. 377.95 ft
Forklift Distance • Forklift Truck Speed: • 5 mph (440 feet per minute) • Distance to Long Term Storage: • 4535.4 inches (377.95 feet) • Calculation: • 377.95 / 440 = 0.859 minutes ( ~51.5 seconds)

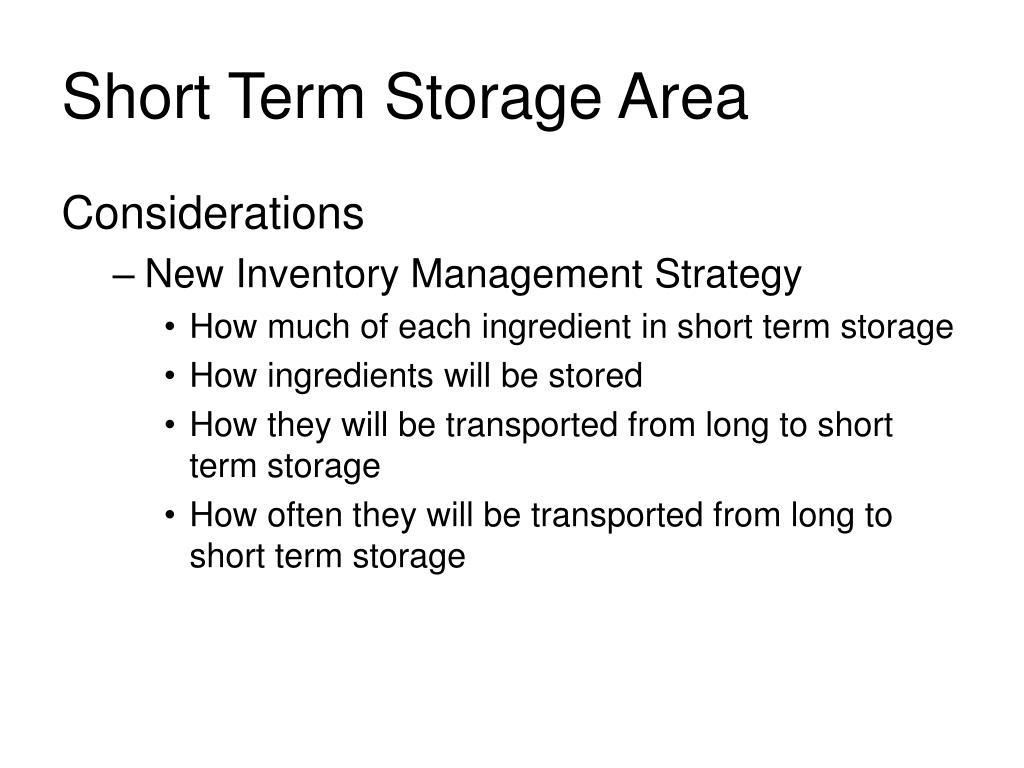

Short Term Storage Area Considerations • New Inventory Management Strategy • How much of each ingredient in short term storage • How ingredients will be stored • How they will be transported from long to short term storage • How often they will be transported from long to short term storage

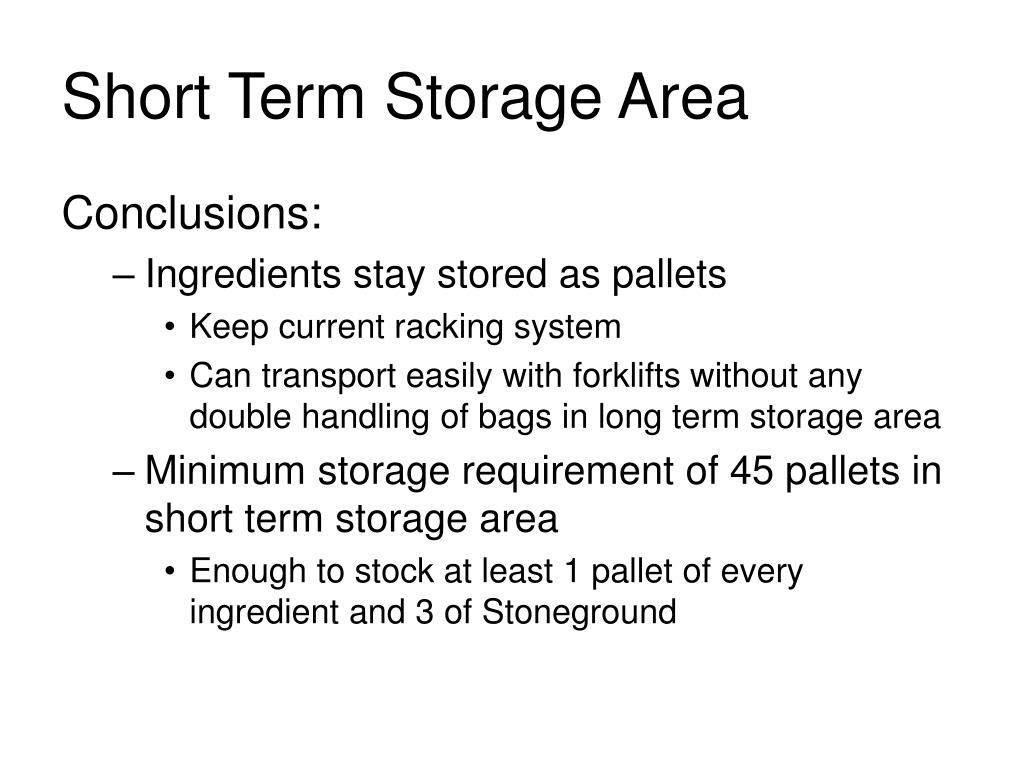

Short Term Storage Area Conclusions: • Ingredients stay stored as pallets • Keep current racking system • Can transport easily with forklifts without any double handling of bags in long term storage area • Minimum storage requirement of 45 pallets in short term storage area • Enough to stock at least 1 pallet of every ingredient and 3 of Stoneground
Short Term Storage Area Layout Implications: • Pallets per rack: 2 per row, 2 rows (not using third one) = 4 pallets • 45 pallets needed • 45 / 4 = 11.2 = 12 racks needed
Restocking Schedule Results • Restocking schedule was created for the first 10 weeks using daily percentage of individual ingredient storage used

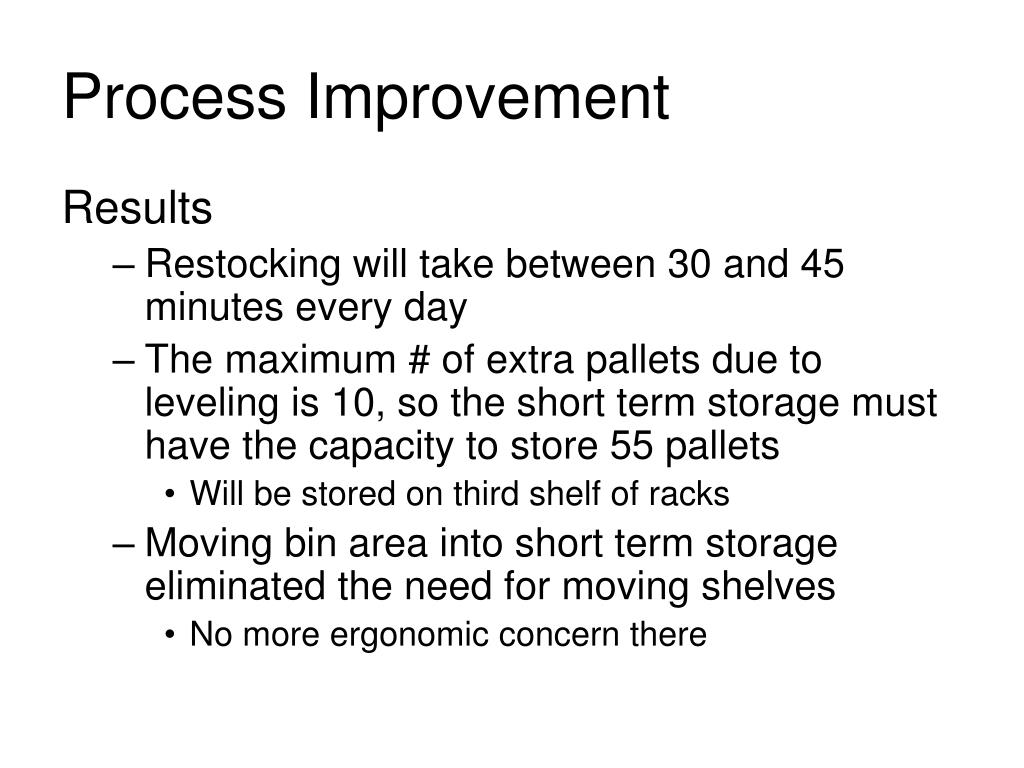

Process Improvement Results • Restocking will take between 30 and 45 minutes every day • The maximum # of extra pallets due to leveling is 10, so the short term storage must have the capacity to store 55 pallets • Will be stored on third shelf of racks • Moving bin area into short term storage eliminated the need for moving shelves • No more ergonomic concern there

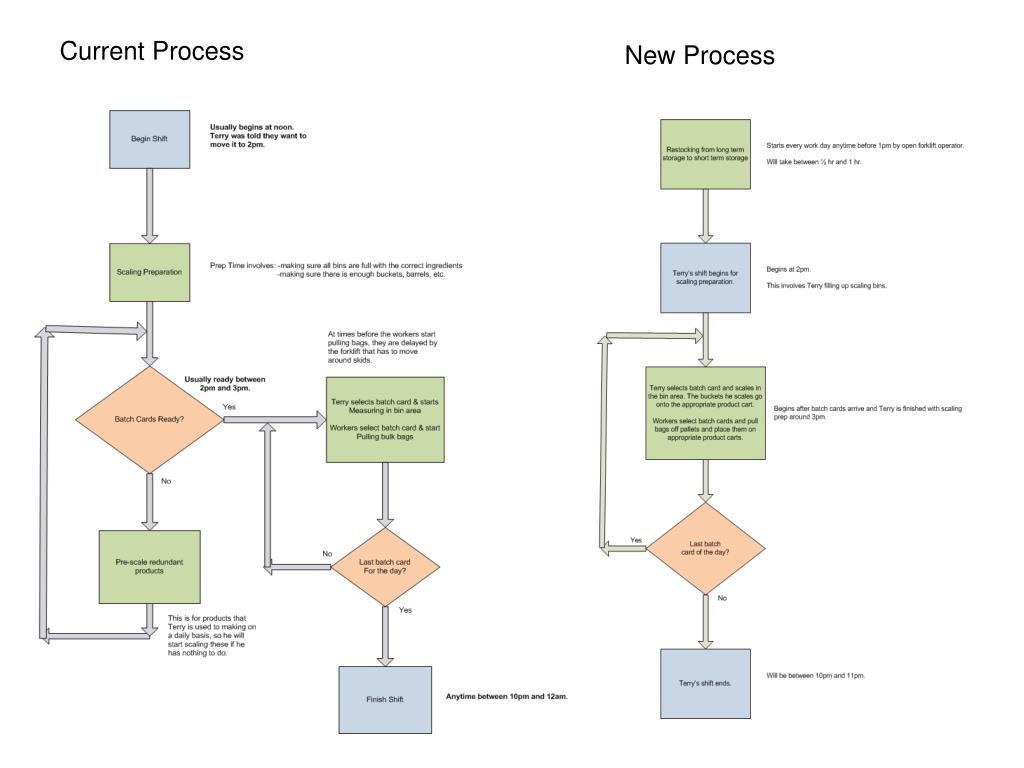

Current Process New Process
Process Improvement Major implications: • Restocking must be done before scaling starts at 2pm • No dead time between end of preparation and receiving batch cards • At least 35 minutes of walking time will be eliminated
Layout Design & Process Improvement Summary • Long term storage needs 18 racks • Short term storage area meets capacity requirements with bin area relocated into it • 30 to 45 minutes of restocking with a forklift every day before 2pm • Eliminates: • The worker’s walking and handling time by at least 45 minutes • The need for the worker to lift heavy bins to and from high shelves

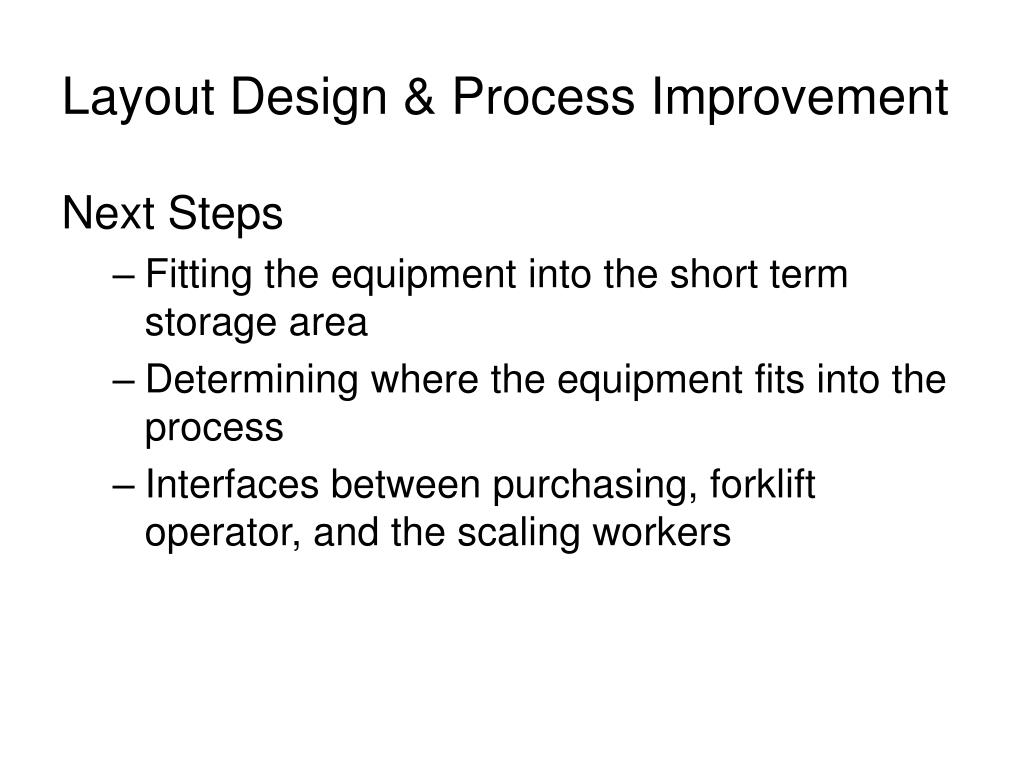

Layout Design & Process Improvement Next Steps • Fitting the equipment into the short term storage area • Determining where the equipment fits into the process • Interfaces between purchasing, forklift operator, and the scaling workers

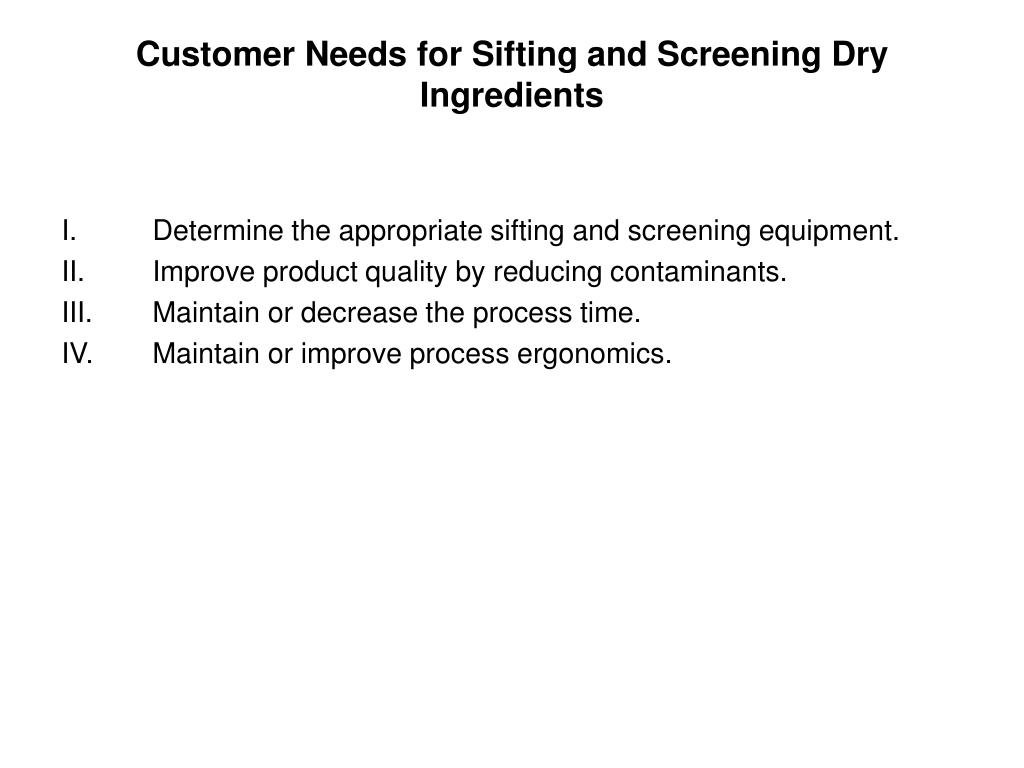

Customer Needs for Sifting and Screening Dry Ingredients I. Determine the appropriate sifting and screening equipment. Improve product quality by reducing contaminants. Maintain or decrease the process time. IV. Maintain or improve process ergonomics.
Specifications From Customer The equipment will use the 460 volts power source available at the Wegmans facility. This type of generic power source is the easiest to install in manufacturing facilities. The equipment will fit within a three-pallet size area to minimize the footprint to allow more room for short-term ingredient storage. The equipment will be mobile. This will allow the machine to be more adaptable for changing conditions. The equipment will meet OSHA standard for noise level under 85dB. The equipment should be washable and possible use of compressed air at 90 to 100 psi. The equipment will be able to handle the throughput of dry ingredients including the 5% annual growth rate for the next four years. The equipment will not have parts that will contaminate the product. Can be safely operated by workers without special protection. All parts are stainless steel food grade compatible. Screen size to be mesh 10. NEMA 4X approved electrical box

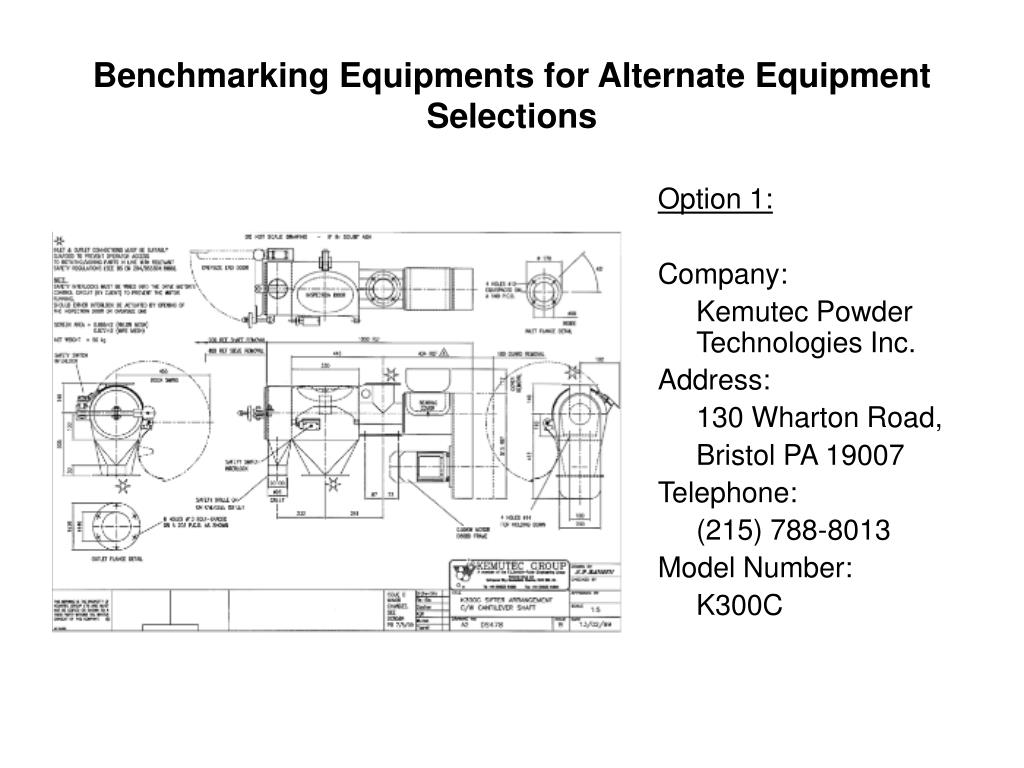

Benchmarking Equipments for Alternate Equipment Selections Option 1: Company: Kemutec Powder Technologies Inc. Address: 130 Wharton Road, Bristol PA 19007 Telephone: (215) 788-8013 Model Number: K300C

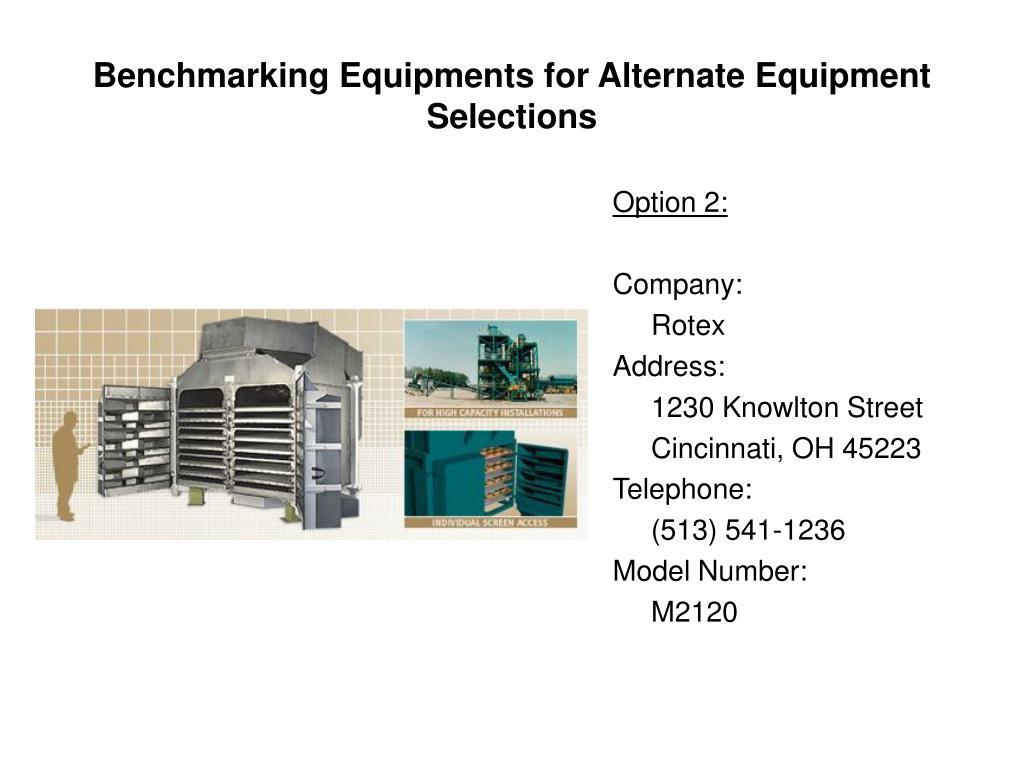

Benchmarking Equipments for Alternate Equipment Selections Option 2: Company: Rotex Address: 1230 Knowlton Street Cincinnati, OH 45223 Telephone: (513) 541-1236 Model Number: M2120
Benchmarking Equipments for Alternate Equipment Selections Option 3: Company: Minox Elcan Address: 325 Waverly Avenue Mamaroneck, NY 10543 Phone: (914) 381-7500 Fax: (914) 381-8500 Model Number: SXE Round

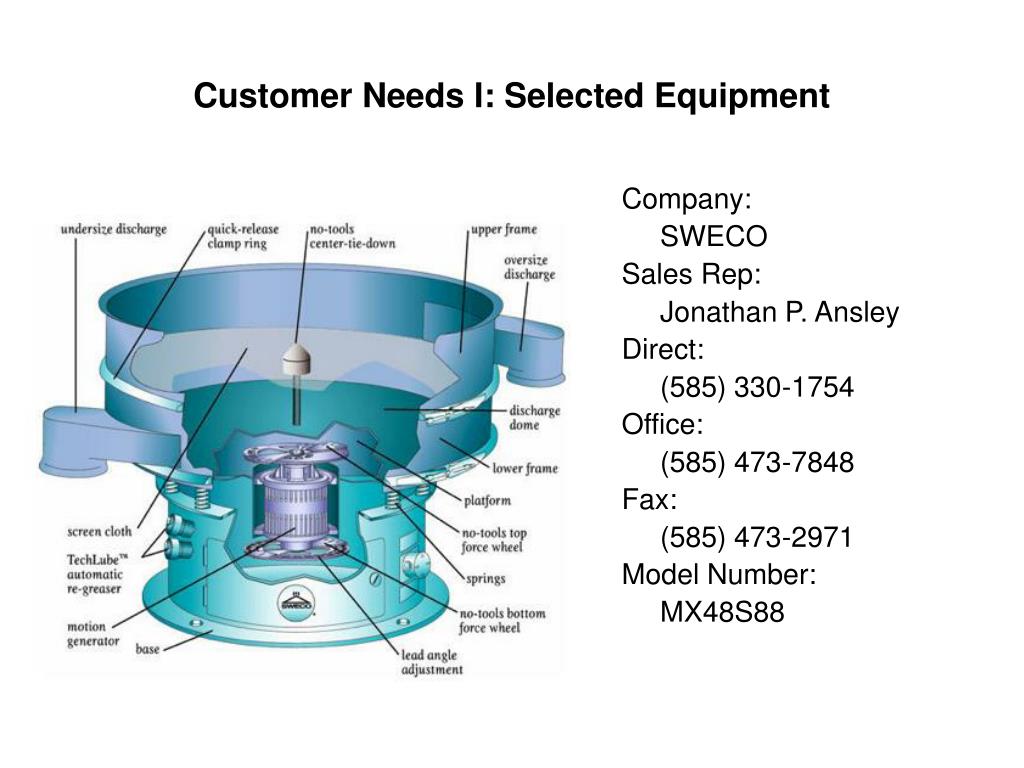

Customer Needs I: Selected Equipment Company: SWECO Sales Rep: Jonathan P. Ansley Direct: (585) 330-1754 Office: (585) 473-7848 Fax: (585) 473-2971 Model Number: MX48S88

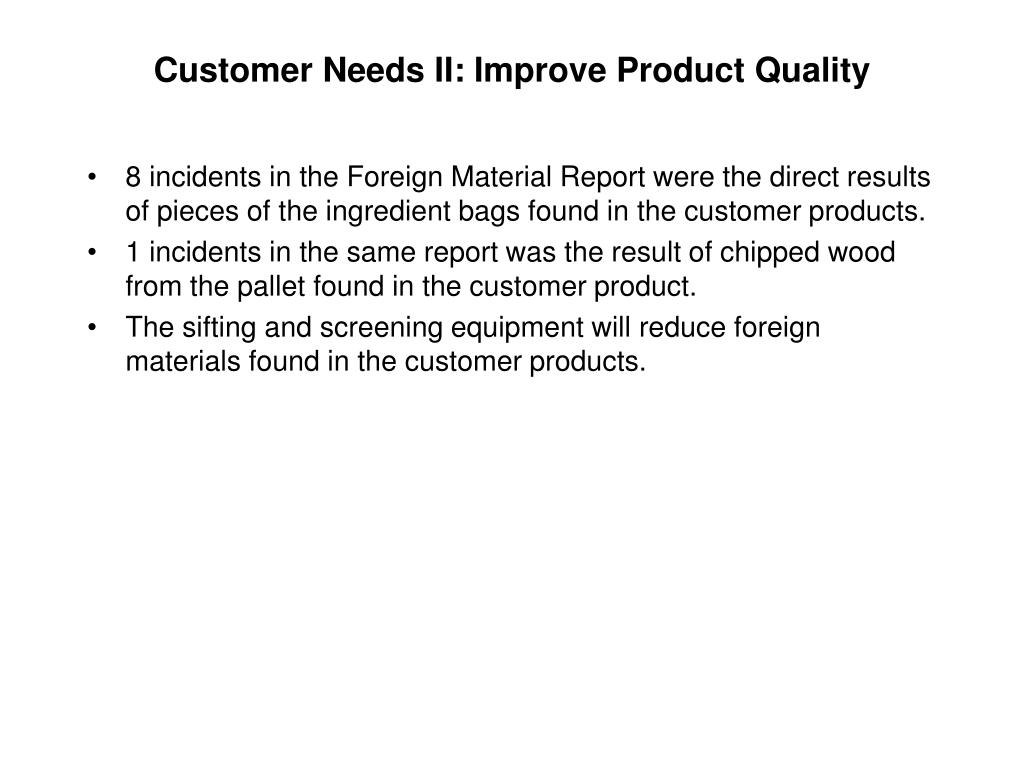

Customer Needs II: Improve Product Quality 8 incidents in the Foreign Material Report were the direct results of pieces of the ingredient bags found in the customer products. 1 incidents in the same report was the result of chipped wood from the pallet found in the customer product. The sifting and screening equipment will reduce foreign materials found in the customer products.

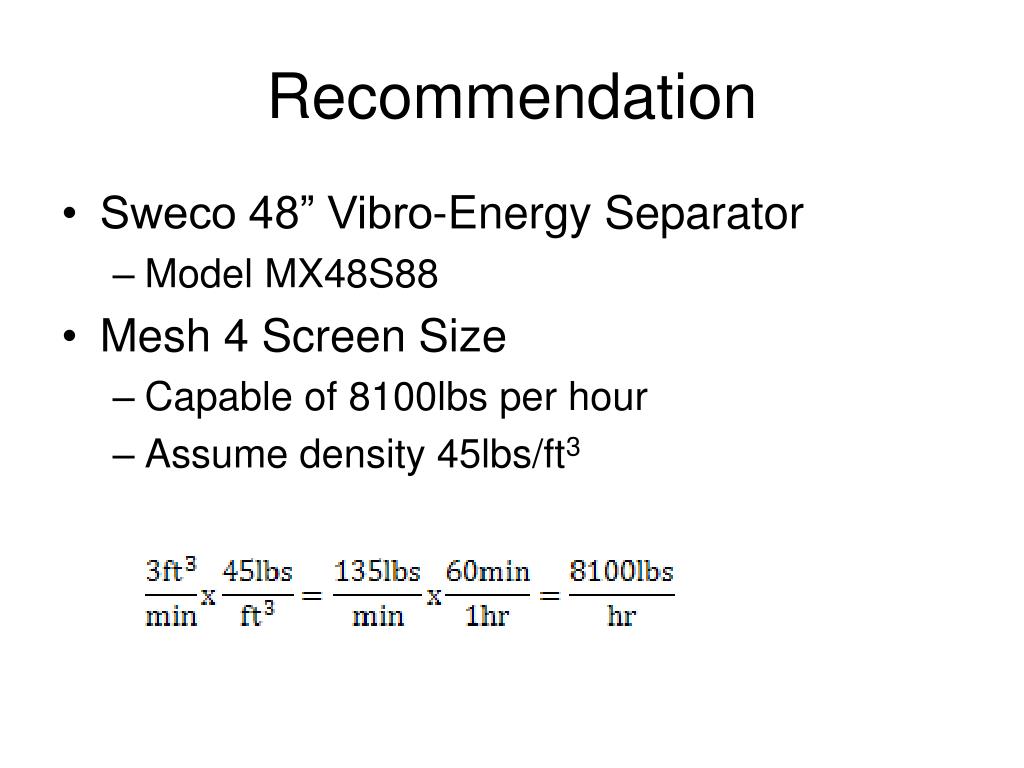

Recommendation Sweco 48” Vibro-Energy Separator Model MX48S88 Mesh 4 Screen Size Capable of 8100lbs per hour Assume density 45lbs/ft3
