Ko ç Un iversity. OPSM 405 Service Operations Management. Class 17: Wrap-up of process game Process Analysis. Zeynep Aksin zaksin @ku.edu.tr. Original process flowchart. M. M. P. C. P. M. M. C. Task times? Bottleneck? Resource utilization?
E N D
Koç University OPSM 405 Service Operations Management Class 17: Wrap-up of process game Process Analysis Zeynep Aksin zaksin@ku.edu.tr

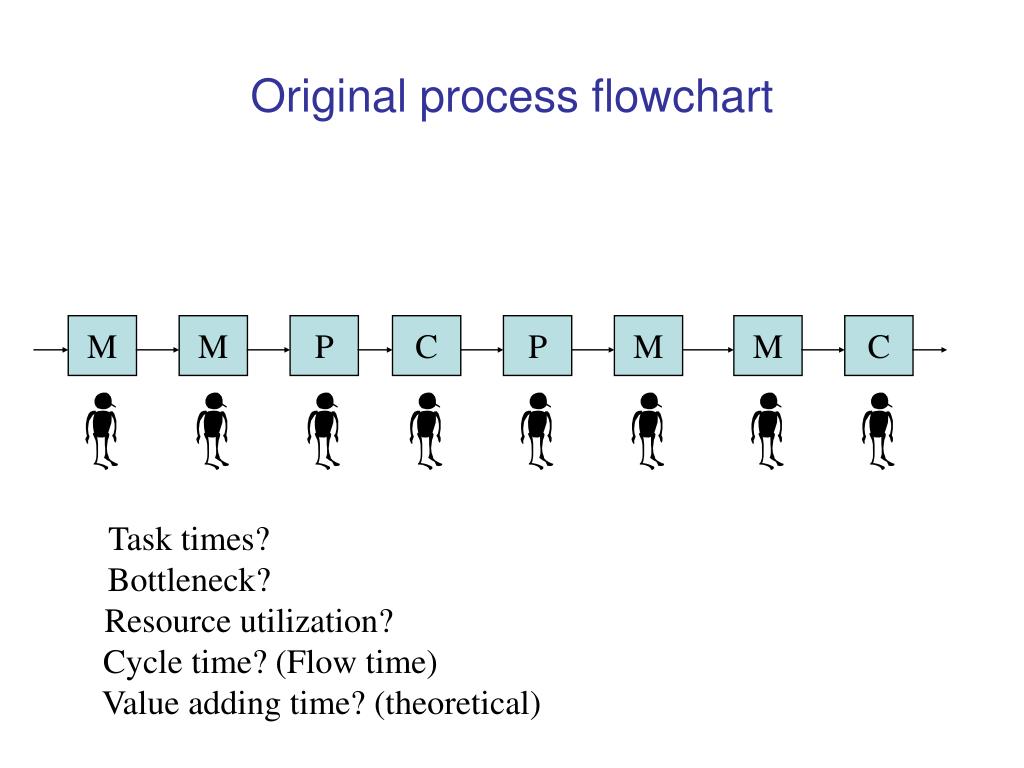

Original process flowchart M M P C P M M C Task times? Bottleneck? Resource utilization? Cycle time? (Flow time) Value adding time? (theoretical)

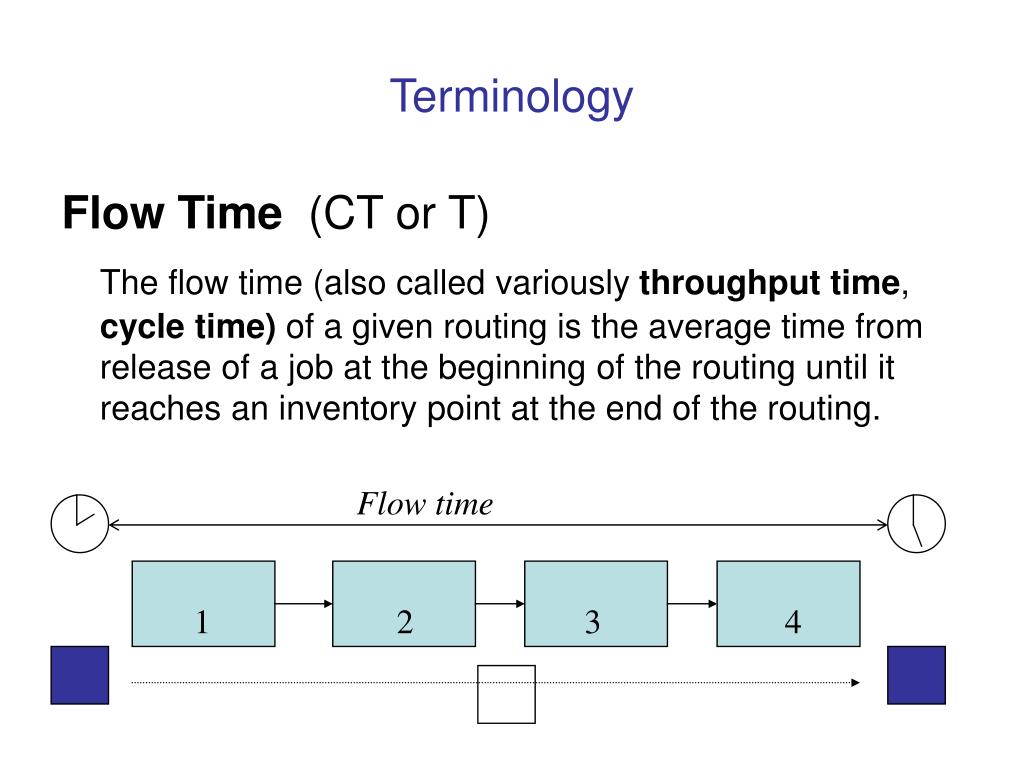

Terminology Flow Time (CT or T) The flow time (also called variously throughput time, cycle time) of a given routing is the average time from release of a job at the beginning of the routing until it reaches an inventory point at the end of the routing. Flow time 1 2 3 4
1 2 3 4 Terminology Throughput Rate (TH or R) The average output of a production process per unit time. At the firm level, it is defined as the production per unit time that is sold.

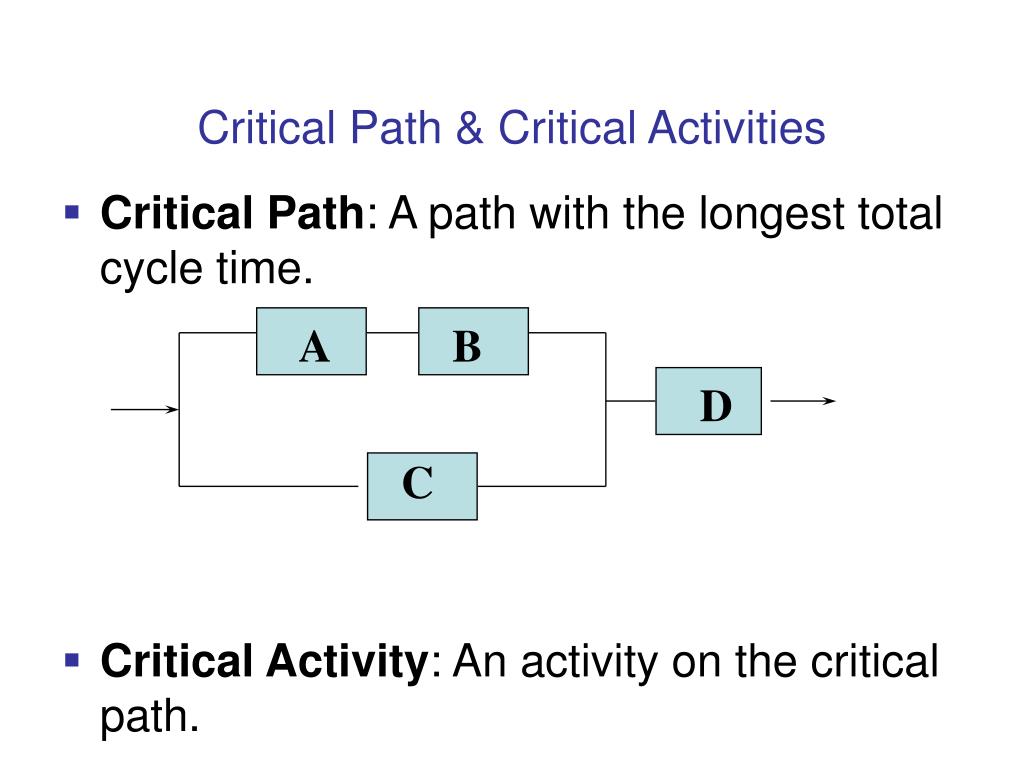

Critical Path & Critical Activities • Critical Path: A path with the longest total cycle time. • Critical Activity: An activity on the critical path. A B D C

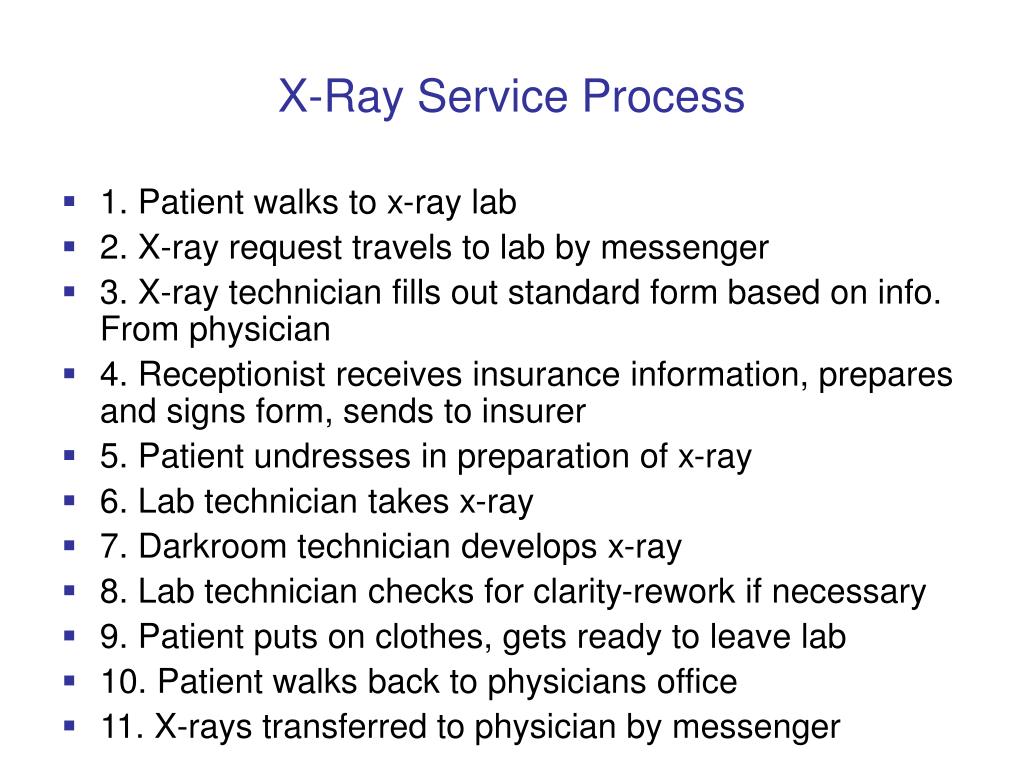

X-Ray Service Process • 1. Patient walks to x-ray lab • 2. X-ray request travels to lab by messenger • 3. X-ray technician fills out standard form based on info. From physician • 4. Receptionist receives insurance information, prepares and signs form, sends to insurer • 5. Patient undresses in preparation of x-ray • 6. Lab technician takes x-ray • 7. Darkroom technician develops x-ray • 8. Lab technician checks for clarity-rework if necessary • 9. Patient puts on clothes, gets ready to leave lab • 10. Patient walks back to physicians office • 11. X-rays transferred to physician by messenger
Example: X-Ray 3 7 1 2 9 10 6 12 7 75% 4 5 6 7 8 start end 5 3 2 3 25% 11 20 6 20 transport support Value added decision Measured actual flow time: 154 minutes

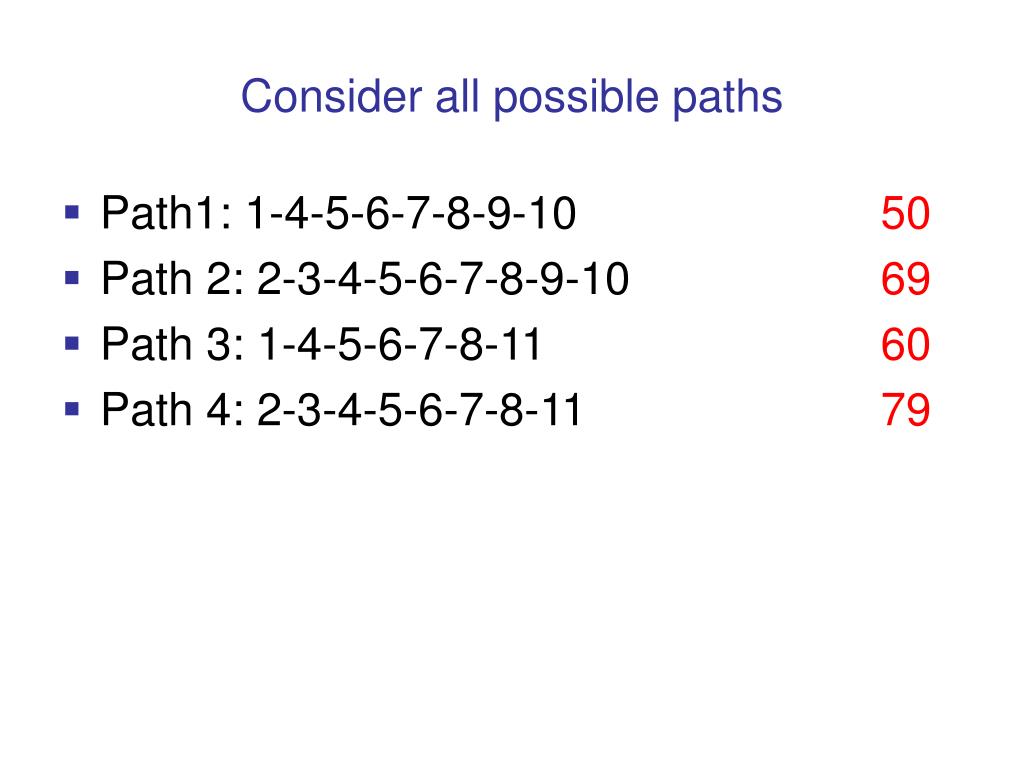

Consider all possible paths • Path1: 1-4-5-6-7-8-9-10 50 • Path 2: 2-3-4-5-6-7-8-9-10 69 • Path 3: 1-4-5-6-7-8-11 60 • Path 4: 2-3-4-5-6-7-8-11 79

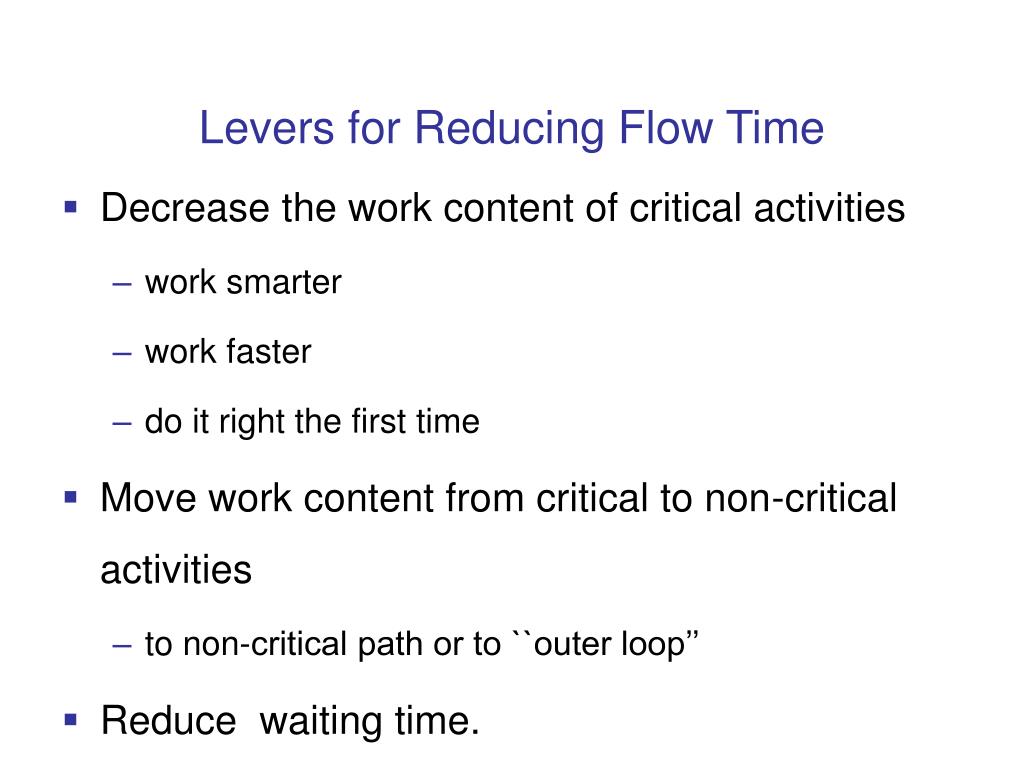

Levers for Reducing Flow Time • Decrease the work content of critical activities • work smarter • work faster • do it right the first time • Move work content from critical to non-critical activities • to non-critical path or to ``outer loop’’ • Reduce waiting time.

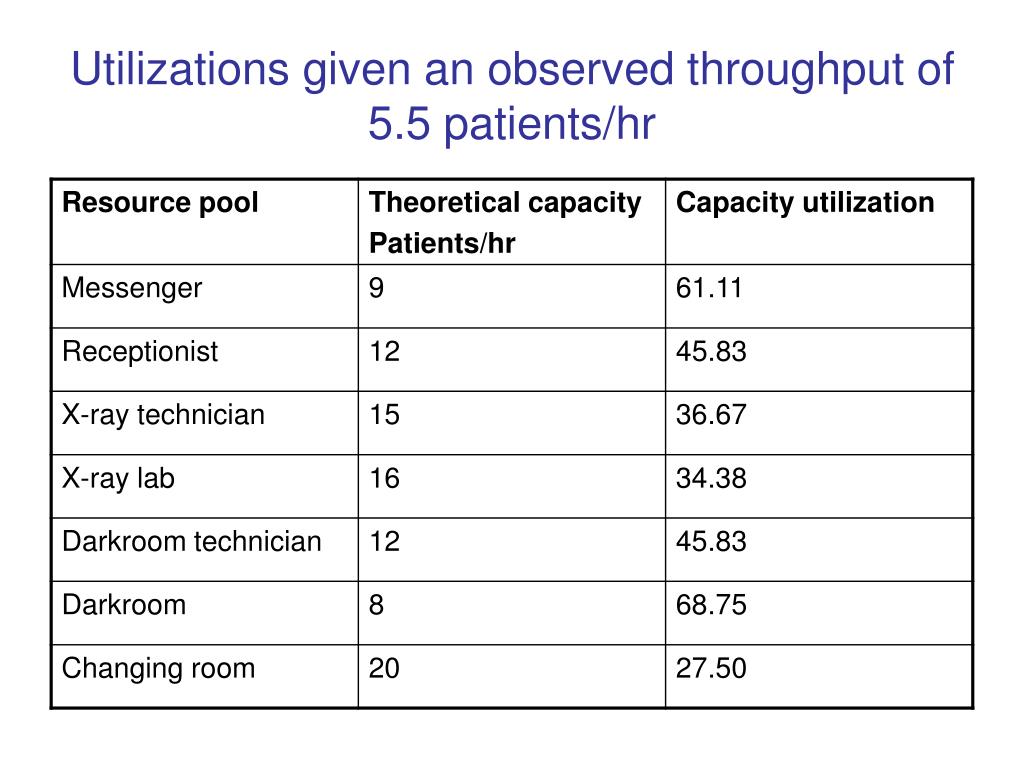

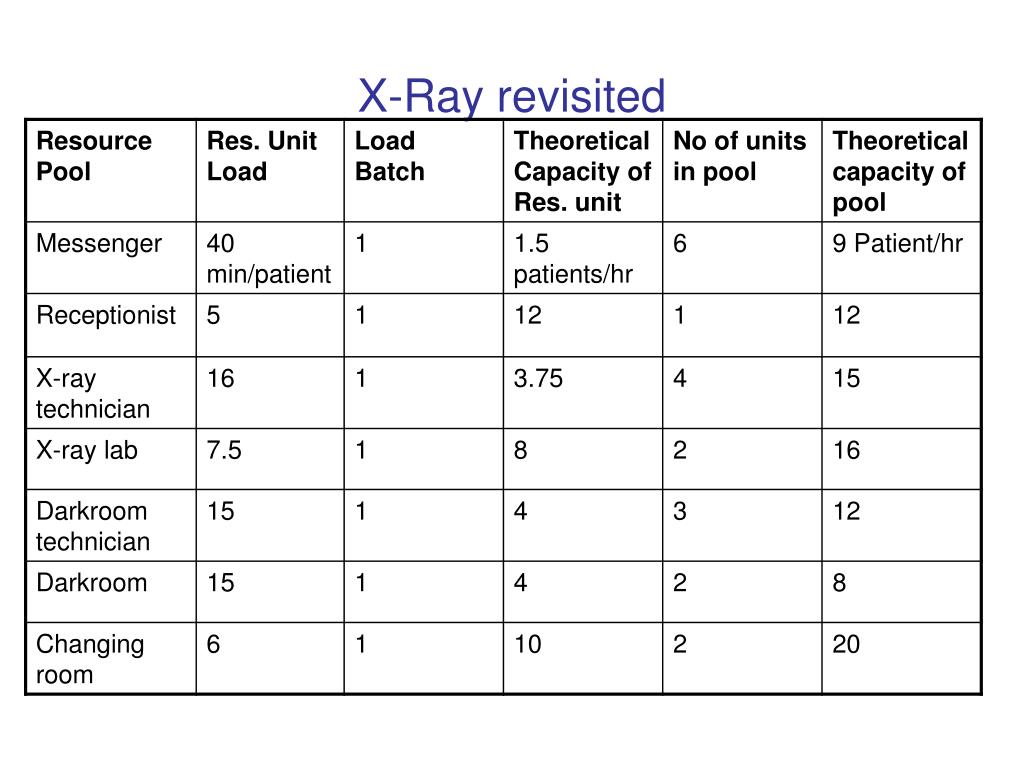

Utilizations given an observed throughput of 5.5 patients/hr
Levers for Increasing Process Capacity • Decrease the work content of bottleneck activities • work smarter • work faster • do it right the first time • change product mix • Move work content from bottlenecks to non-bottlenecks • to non-critical resource or to third party • Increase Net Availability • work longer • increase scale (invest) • increase size of load batches • eliminate availability waste
Structuring The Service Enterprise Example: Automobile’s Driver’s License Office License Renewal Times Activity Description Time (Sec) 1 Review application for correctness 15 2 Process and record payment 30 3 Check for violations and restrictions 60 4 Conduct eye test 40 5 Photograph applicant 20 6 Issue temporary license 30
Present Flow Diagram Activity Activity Activity Activity Activity Activity 6 120 30 4 90 40 5 180 20 2 120 30 1 240 15 3 60 60 /hr /hr /hr /hr /hr /hr sec sec sec sec sec sec Flow time: sec Throughput rate: per hour What happens if you hire one more employee? Activity flow rate per hour time (sec)
Proposed Flow Diagram Activity Activity 1,465 55 3 60 60 /hr /hr sec sec Activity Activity Activity 6 120 30 5 180 20 2 120 30 /hr /hr /hr sec sec sec Activity Activity 1,465 55 3 60 60 /hr /hr sec sec Flow time: sec Throughput rate: per hour
Activity Activity Activity Activity Activity Activity 1-522 165 1-522 165 1-522 165 1-522 165 1-522 165 1-522 165 /hr /hr /hr /hr /hr /hr sec sec sec sec sec sec Another Design Activity 6 120 30 /hr sec Flow time: sec Throughput rate: per hour

The role of task times: a balanced line • if task times are similar will have a balanced line • in the absence of variability (deterministic) complete synchronization is possible • in a balanced line idleness is minimized, though in the presence of variability full synchronization cannot be achieved
The role of task times: an unbalanced line • if average task times are different will have an unbalanced line • will have idleness • in unbalanced case, slowest task determines output rate • bottleneck is busy • idleness in other stages

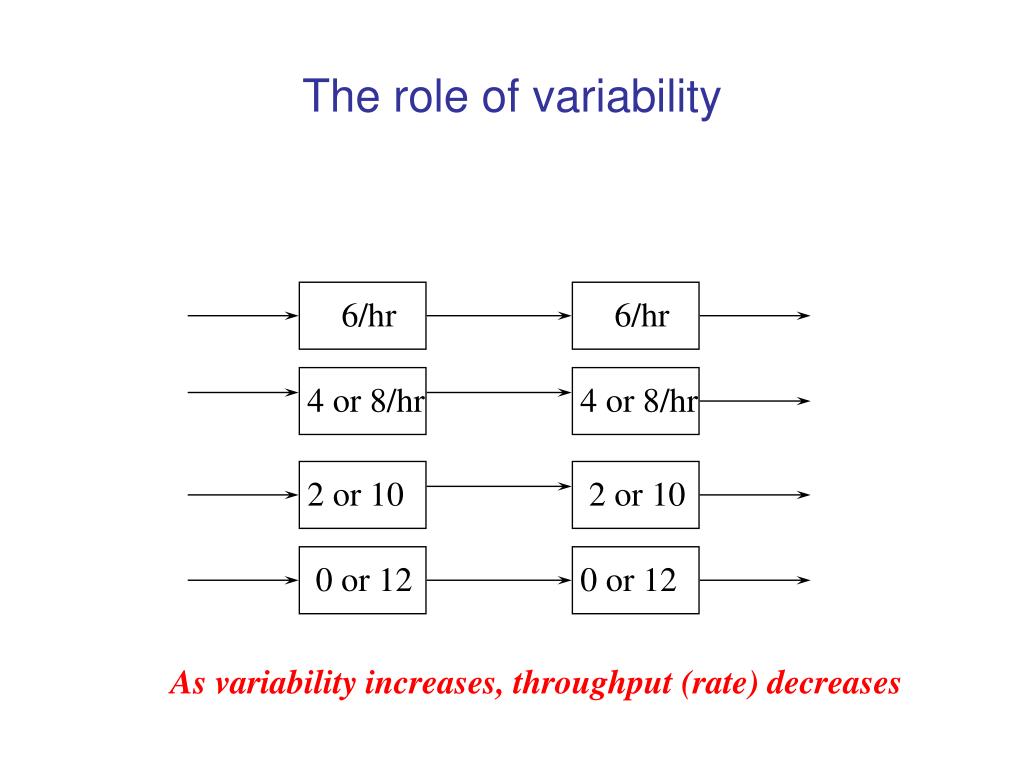

6/hr 6/hr The role of variability 4 or 8/hr 4 or 8/hr 2 or 10 2 or 10 0 or 12 0 or 12 As variability increases, throughput (rate) decreases

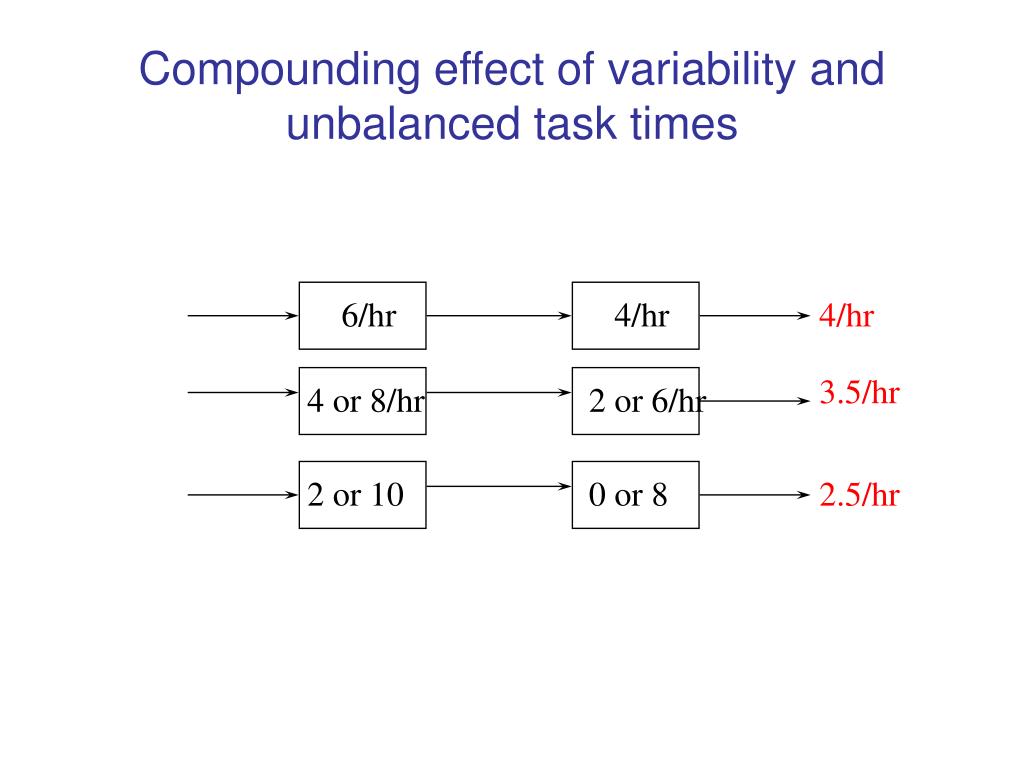

6/hr 4/hr Compounding effect of variability and unbalanced task times 4/hr 3.5/hr 4 or 8/hr 2 or 6/hr 2 or 10 0 or 8 2.5/hr

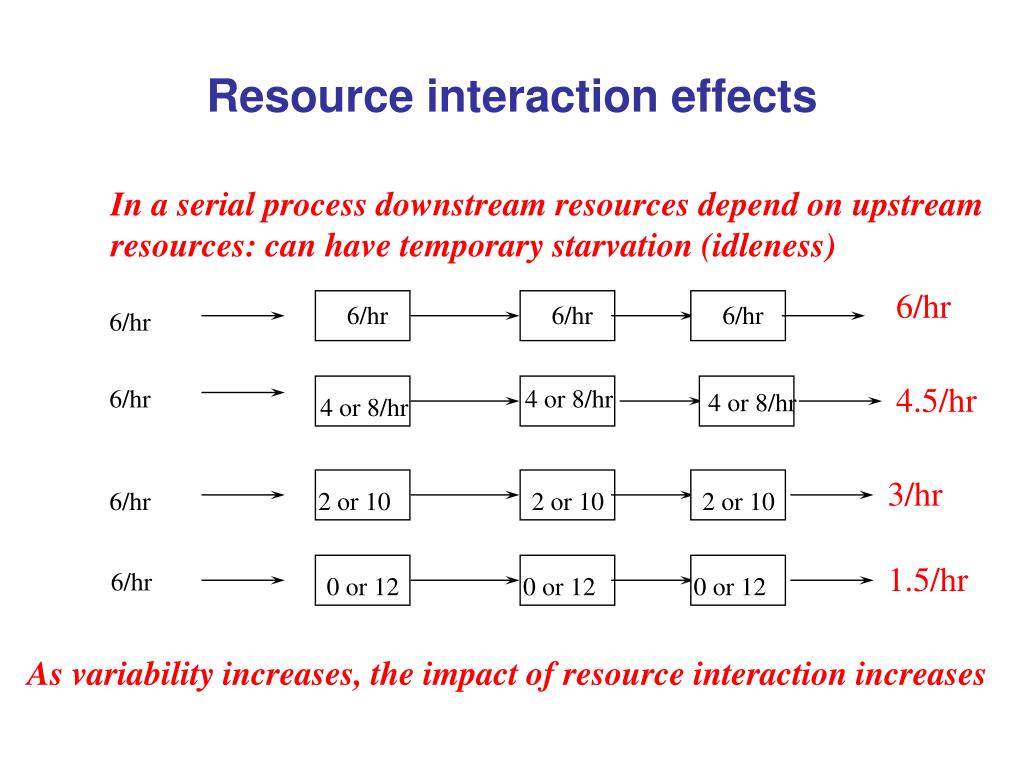

6/hr 6/hr 6/hr 2 or 10 2 or 10 0 or 12 0 or 12 Resource interaction effects In a serial process downstream resources depend on upstream resources: can have temporary starvation (idleness) 6/hr 6/hr 4.5/hr 6/hr 4 or 8/hr 4 or 8/hr 4 or 8/hr 3/hr 6/hr 2 or 10 1.5/hr 6/hr 0 or 12 As variability increases, the impact of resource interaction increases

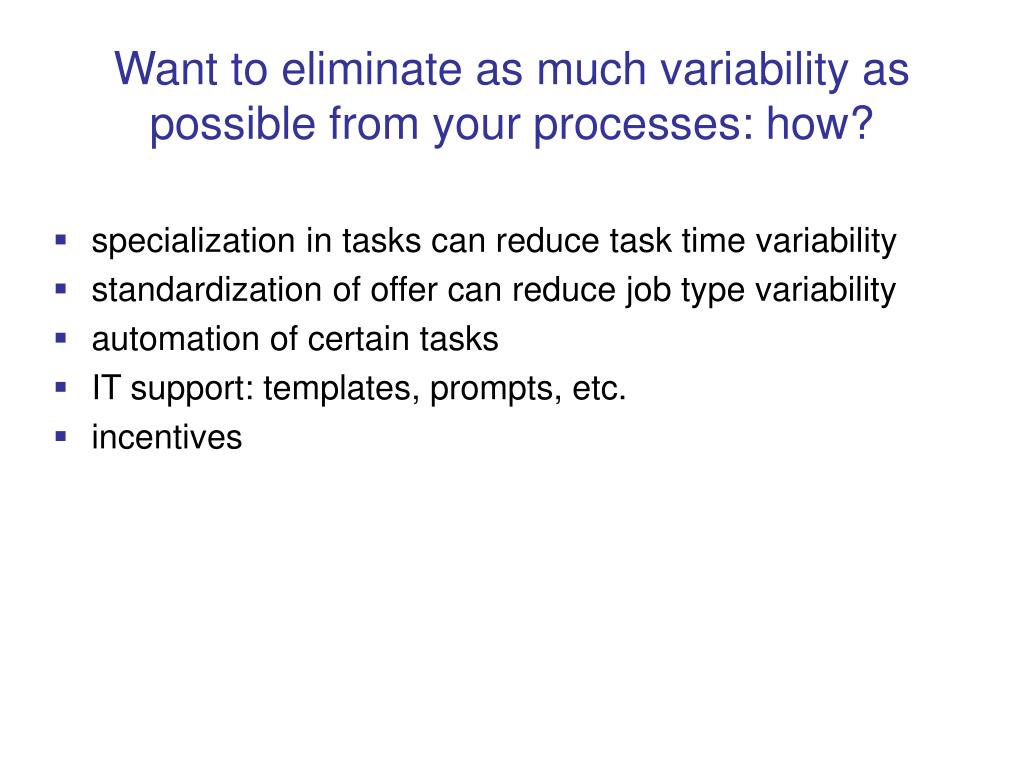

Want to eliminate as much variability as possible from your processes: how? • specialization in tasks can reduce task time variability • standardization of offer can reduce job type variability • automation of certain tasks • IT support: templates, prompts, etc. • incentives

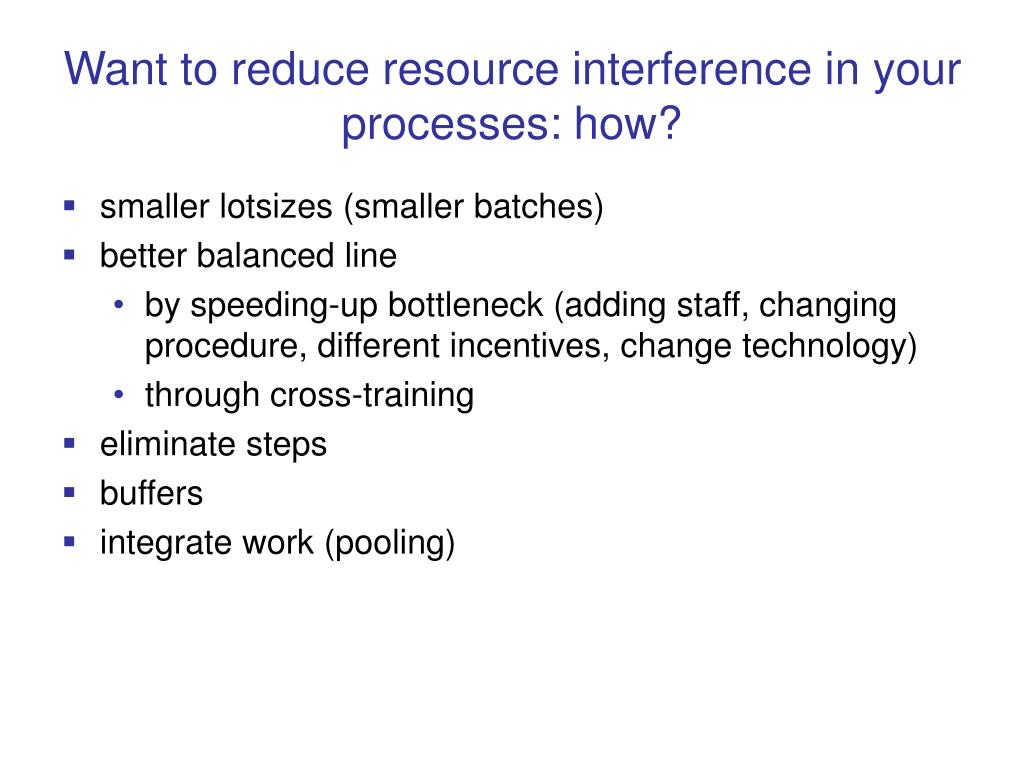

Want to reduce resource interference in your processes: how? • smaller lotsizes (smaller batches) • better balanced line • by speeding-up bottleneck (adding staff, changing procedure, different incentives, change technology) • through cross-training • eliminate steps • buffers • integrate work (pooling)
The impact of task integration (pooling) • balances utilization... • reduces resource interference... • ...therefore reduces the impact of temporary bottlenecks • there is more benefit from pooling in a high utilization and high variability process • pooling is beneficial as long as • it does not introduce excessive variability in a low variability system • the benefits exceed the task time reductions due to specialization
Examples of pooling in business • Consolidating back office work • Call centers • Single line versus separate queues
Summary of fundamental process principles • identify and eliminate bottlenecks • reduce as much variability as possible • eliminate handoffs, improve communication to minimize resource interference • for high utilization processes build-in more slack
