Cosmic ray data

DESCRIPTION

Cosmic ray data. T. Tsuboyama (KEK). Cosmic ray data. On 22 Dec. 2008 Beam stopped. On 28 Dec. Belle E-hut shutdown Only 72 hours data were taken. Jan 6-end March: Belle maintenance. (Forward End cap is opened.) Jan-March 2009 SVD cosmic ray data will be taken as long time as possible.

1 / 10

Download Presentation

Cosmic ray data

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. Cosmic ray data T. Tsuboyama (KEK)

  2. Cosmic ray data • On 22 Dec. 2008 Beam stopped. • On 28 Dec. Belle E-hut shutdown • Only 72 hours data were taken. • Jan 6-end March: Belle maintenance. (Forward End cap is opened.) • Jan-March 2009 • SVD cosmic ray data will be taken as long time as possible.

  3. DSSD production in HPK T. Tsuboyama (KEK)

  4. News • 25 Dec. 2008, I met with HPK engineers Yamamura, Sato and Inutsuka who has worked for the DSSD production for SVD1 and SVD2. • In fact they met Prof. Aihara (Tokyo) in advance and Aihara somehow convinced HPK that DSSD production is necessary for users and for HPK. • I will start discussion with them.

  5. Questions • They discarded the semiconductor machines for double sided process. They should buy several machines and modify them for double sided process. • Once they decide, there are no big technical problems. • Thomas and Markus told me that we should confirm • if they could use 300 mm thick, 6” diameter wafers. • what is the production capability (speed)

  6. Number of sensors (Markus) • Assuming 6” wafers can be used. • 2x12+ 3x12 + 4*24 + 5*24 = 276 • 300kyen * 276 =82800 kyen

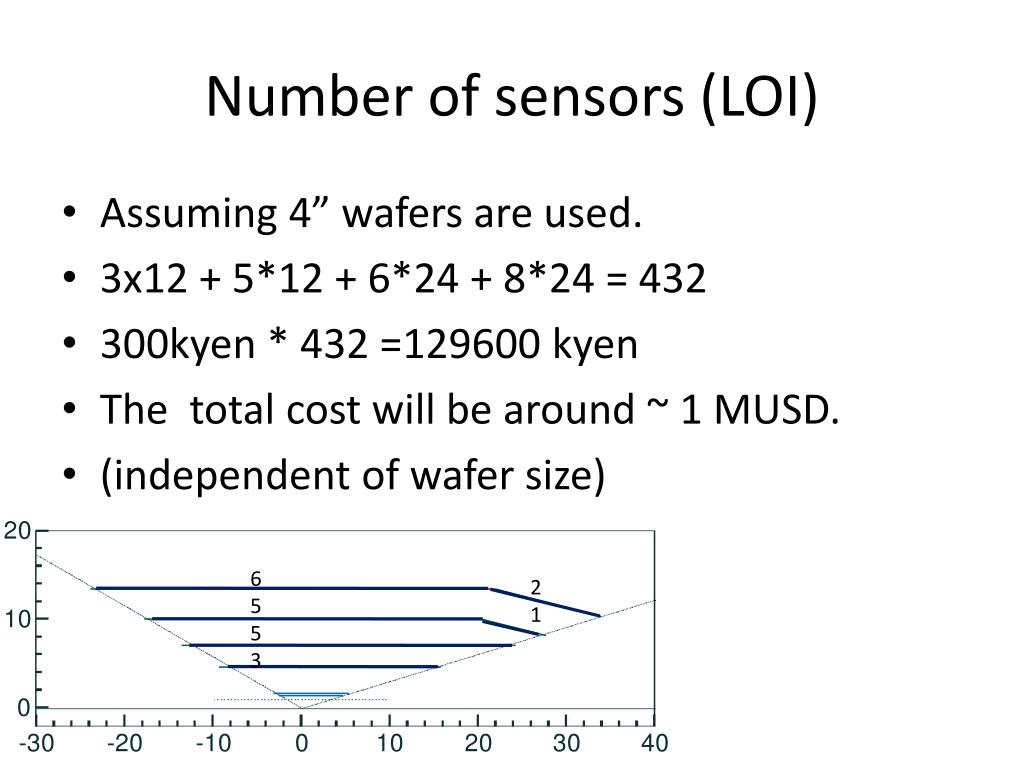

  7. Number of sensors (LOI) • Assuming 4” wafers are used. • 3x12+ 5*12 + 6*24 + 8*24 = 432 • 300kyen * 432 =129600 kyen • The total cost will be around ~ 1 MUSD. • (independent of wafer size) 6 5 5 3 2 1

  8. SVD construction schedule 7 Jan 2008 T. Tsuboyama (KEK)

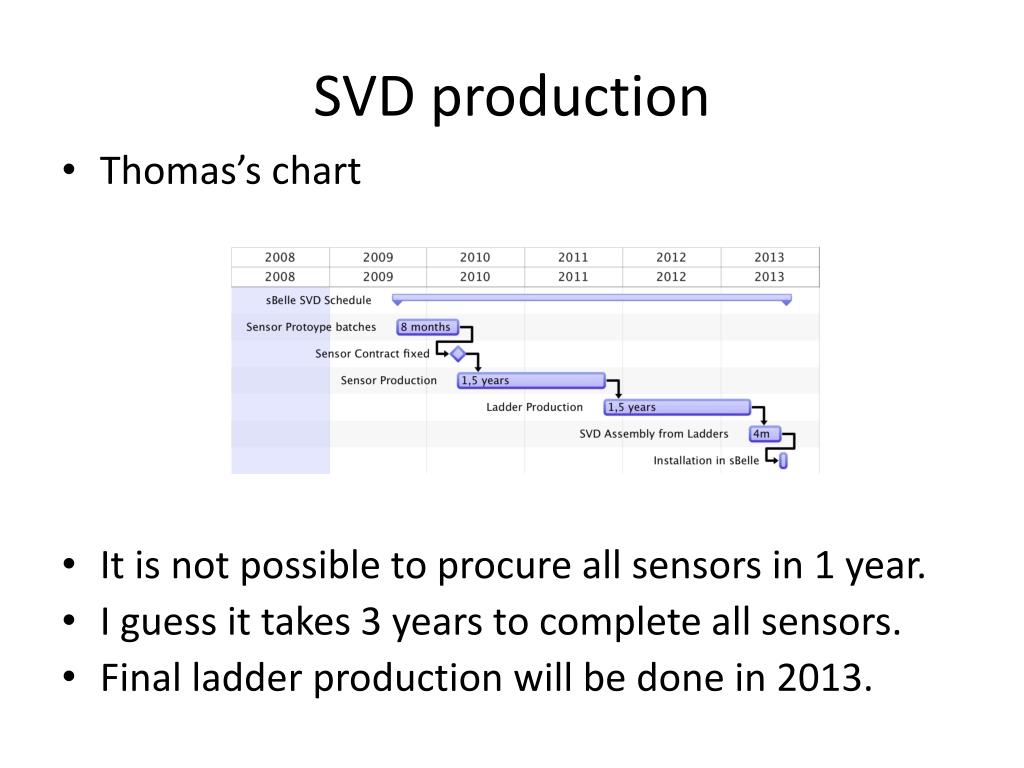

  9. SVD production • Thomas’s chart • It is not possible to procure all sensors in 1 year. • I guess it takes 3 years to complete all sensors. • Final ladder production will be done in 2013.

  10. SVD production • Thomas’s chart (modified) • 3 years for sensor production with some spares. • Final ladder production will be done in 2013. • 0.5-1 year system test before installation. • SVD and DEPFET installation should be done after we understand background conditions, e.g., 0.5 years. system test
