390 likes | 564 Views
Integrating Earned Value into the Management of Software Development Projects. Dan Brandon, Christian Brothers University.
E N D
Integrating Earned Value into the Management of Software Development Projects Dan Brandon, Christian Brothers University
Presented at Information Resources Management Association (IRMA) Annual International Meeting, June 1999, Hersey, PA, USA; Reprinted in “Managing Information Technology Resources in Organizations in the Next Millennium (ISBN: 1-878289-51-9)
Project Management & IT Management • “IT managers careers will rise and fall based on their ability to deliver high quality projects on time.” • J. I. Cash, Harvard Business School • Only 27% of software development projects succeed; another 33% are over budget (average cost overrun is 189%) and/or late and/or scaled back • Standish Group
Project Management Areas • Project Feasibility/Justification • Project Organization • Project Planning & Scheduling • Project Staffing • Project Tracking
Typical Project Scheduling (i.e. MS Project) • Indicate project start date (and any individual task start dates that cannot float) • Indicate tasks (WBS) and their resource requirements (how much of whose time) • Indicate Task Interdependencies • Indicate Milestones • Indicate resource availability; do resource “leveling” • Produce “baseline” schedule
Typical Top Level Software WBS • Requirements Definition • Overall Design • Detail Project Plan • External Design • Detail Design • Implementation • Integration • Internal Documentation • Training • Installation

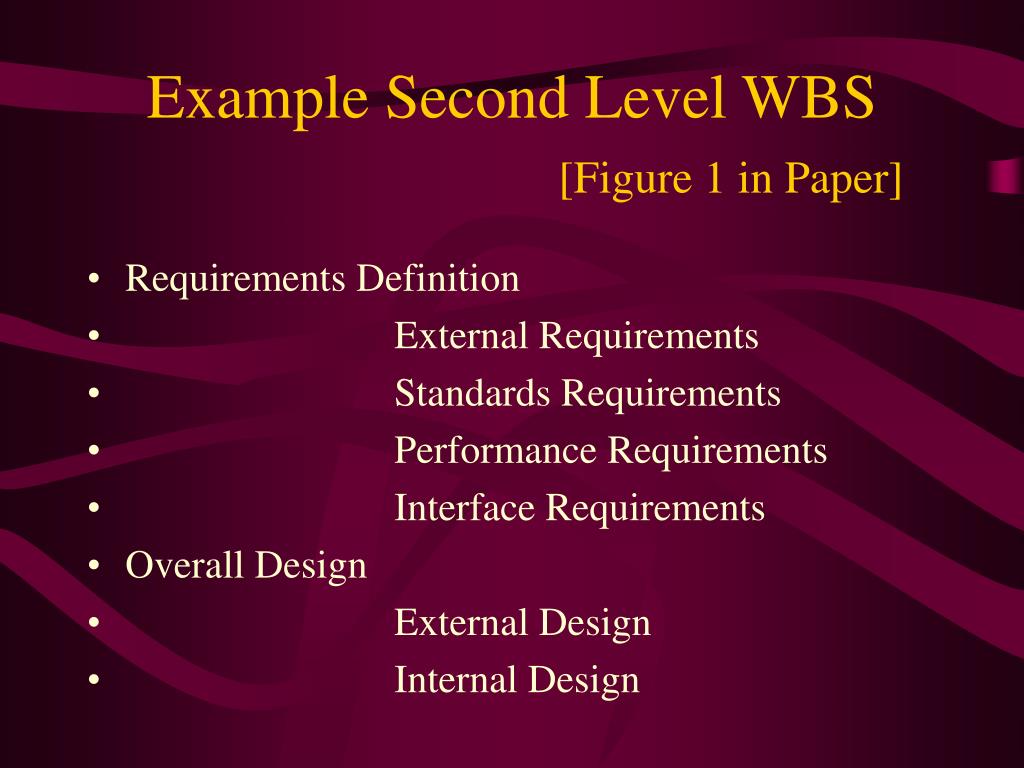

Example Second Level WBS[Figure 1 in Paper] • Requirements Definition • External Requirements • Standards Requirements • Performance Requirements • Interface Requirements • Overall Design • External Design • Internal Design
Project Cost Plan • Using a spreadsheet program or using a project scheduling program, • Develop a cost plan which indicates: • the cost for each task • when the cost is planned to be incurred • Software development is mostly labor cost • Figure 2 (shows top level cost Plan) • Figure 3 is a graphical representation
Jan Feb MarApr • Requirements Definition 10 5 • Overall Design 5 5 • Project Plan 5 5 • External Documentation 5 • Partial View of Plan • Monthly Cost 10 10 10 10 • Cumulative 10 20 30 40
Project Tracking • “Well done is better than well said.” • Benjamin Franklin (1706 - 1790)

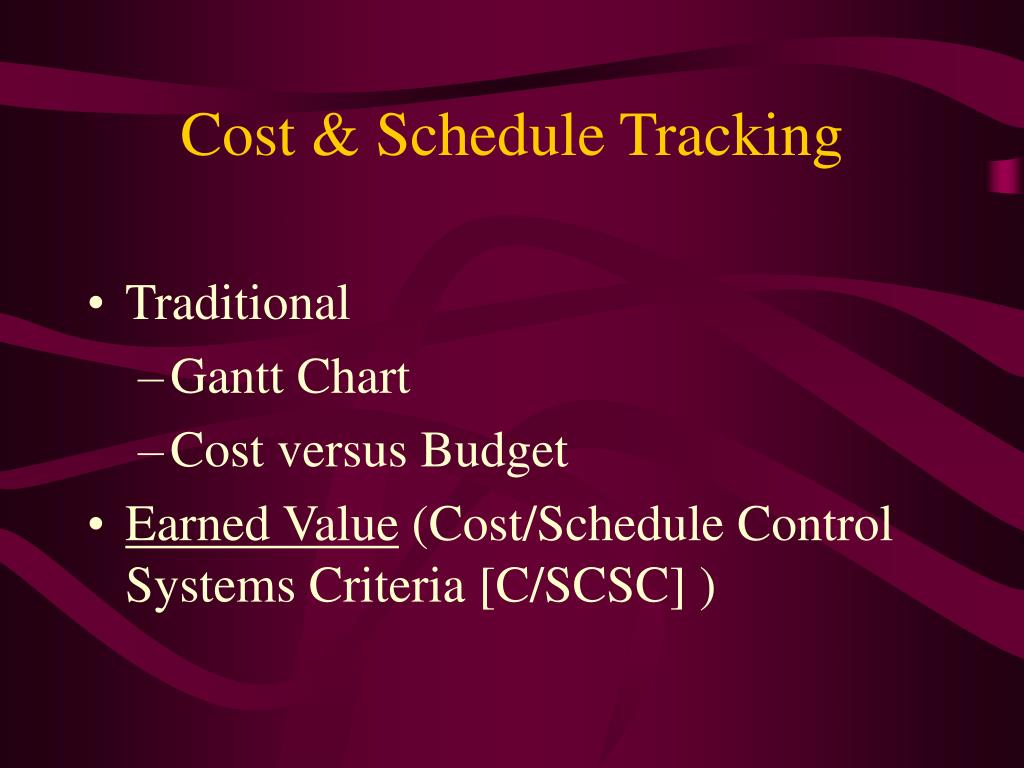

Cost & Schedule Tracking • Traditional • Gantt Chart • Cost versus Budget • Earned Value (Cost/Schedule Control Systems Criteria [C/SCSC] )
Typical Approach • Present reports to management: • Cost versus Budget (Planned Cost) • Figure 4 • Gantt Chart of Progress • Figure 5 • The example here is for project work thru July
From the information shown: • Are we in good shape on this project (i.e. ahead of, or behind schedule) ? • When can we expect to finish this project ? • What will be our cost at completion ? • Earned Value can answer these questions !
Earned Value • “Never mistake motion for action.” • Ernest Hemingway (1889 - 1961)
“One of the most underused cost management tools available for project managers is the earned value performance measurement concept” • Q. Fleming & M. Koppelman - Primavera Systems, Inc.
History of Earned Value • Been around in several forms since 1950’s • DoD required many contracts (those where the government was at risk for cost overruns) to use Earned Value (originally PERT/COST) • Earned value was a key concept in the 1967 DoD (Dept. of Defense) policy to which contractors had to comply called Cost/Schedule Control System Criteria (C/SCSC) • Revised in recent years by DoD to avoid “over implementation”
Now working very well in DoD (particularly Air Force, Army, ...) • Large body of statistical data available • Has its own Internet site in DoD • However use in private industry is still low: • No exposure to concepts • Don’t understand concepts • Don’t know how to effectively implement
Earned Value • A quantifiable way to express real cost and schedule variances • Work Plan - shows the budgeted cost associated with the project in time by task (work packet), rolled up to a particular level (the “reporting level”) of the WBS • Concepts: • Budgeted cost of work scheduled • Actual cost of work performed • Budgeted cost of work performed (EV)
BudgetedCost of Work Scheduled • A point on the planned cost (or budget) baseline representing the value of work planned (scheduled) as of a given point in time.

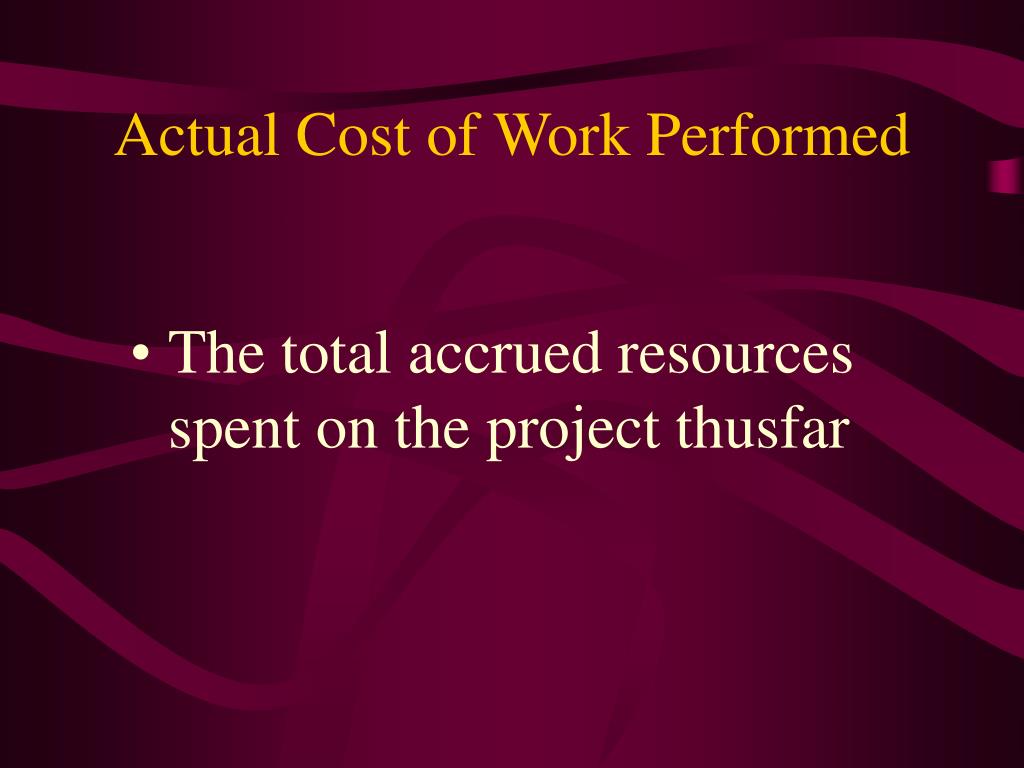

Actual Cost of Work Performed • The total accrued resources spent on the project thusfar
Budgeted Cost of Work Performed • Same as “Earned Value” • A point on the planned cost (budget) baseline representing the budgeted value for work completed as of a point in time. • Determined by looking at each task initiated, the planned cost for that task, and the amount of that task completed (% complete) -- Figure 5 in paper

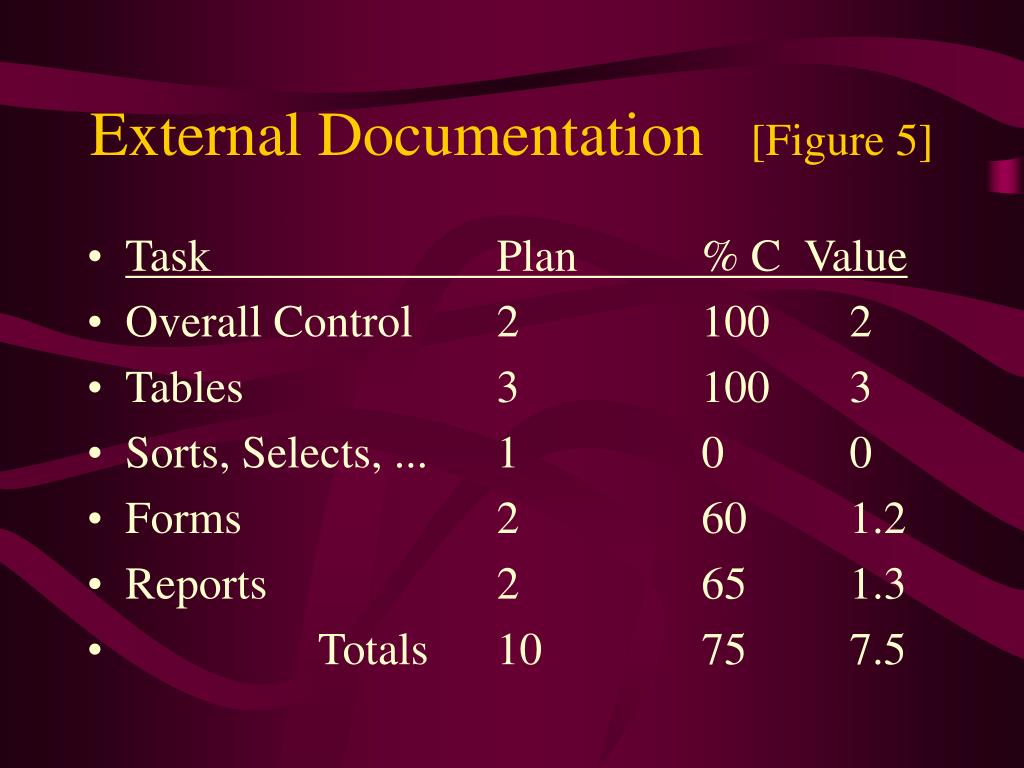

External Documentation [Figure 5] • Task Plan % C Value • Overall Control 2 100 2 • Tables 3 100 3 • Sorts, Selects, ... 1 0 0 • Forms 2 60 1.2 • Reports 2 65 1.3 • Totals 10 75 7.5

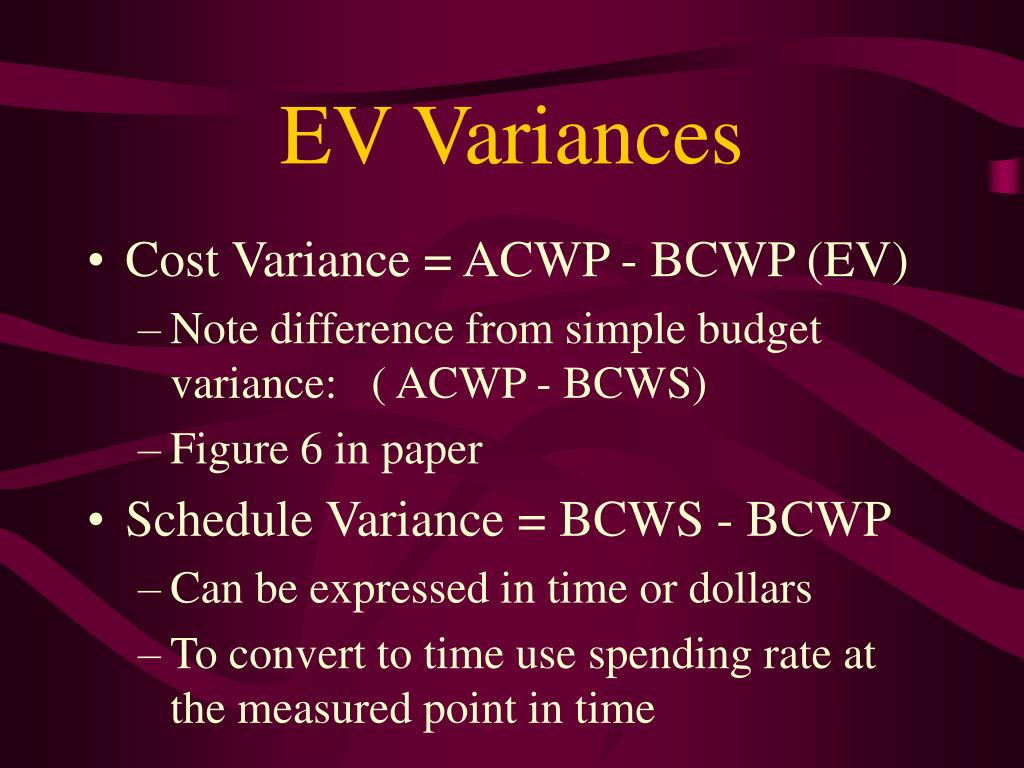

EV Variances • Cost Variance = ACWP - BCWP (EV) • Note difference from simple budget variance: ( ACWP - BCWS) • Figure 6 in paper • Schedule Variance = BCWS - BCWP • Can be expressed in time or dollars • To convert to time use spending rate at the measured point in time
We can clearly see from the graph that we are over cost not under cost: • ACWP - BCWP is positive • Even though budget variance (ACWP - BCWS) is negative (under budget) !!! • We can also se that we are behind schedule; we should have been at this point several weeks ago ! • Formulas here have sign reversed from PMI PMBOK versions

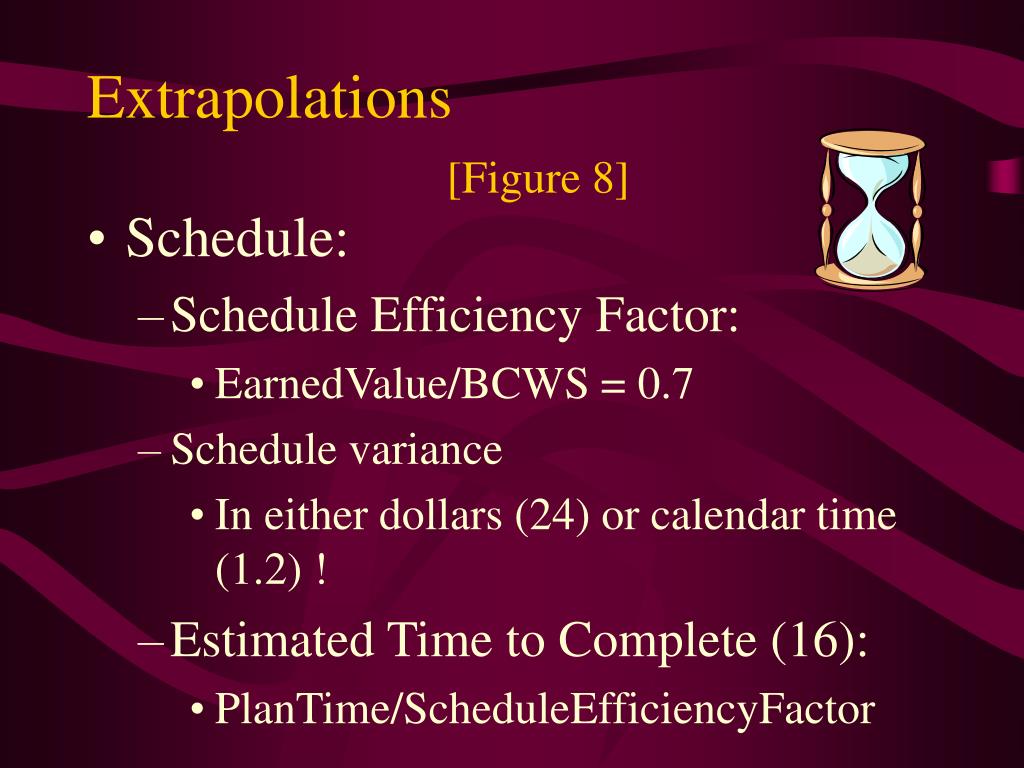

Extrapolations[Figure 8] • Schedule: • Schedule Efficiency Factor: • EarnedValue/BCWS = 0.7 • Schedule variance • In either dollars (24) or calendar time (1.2) ! • Estimated Time to Complete (16): • PlanTime/ScheduleEfficiencyFactor
Cost: • Cost Efficiency Factor: • EarnedValue/ACWP = 0.9 • Estimated Cost at Completion (EAC): • PlanCost/CostEfficiencyFactor = 211
Effective Use of Earned Value in IT • Proper Task Level Specification • Meaningful Percent Complete Reporting • “Non-Intrusive” Tracking Systems • Accurate and Timely Cost Data • Integration with SEI’s CMM • TQM vs Individual Performance Evaluation
Task Level • General rule for application software development - smaller of • one manweek’s effort • individual component (screen, report, memu,...) • Important to match to accounting and/or timekeeping frequency !!
Percent Complete Reporting • Keep it simple ! • Common method (weighted milestone): • Not started zero • Working on it 50% • Finished 100% • Trade off in ease of reporting versus accuracy of reporting

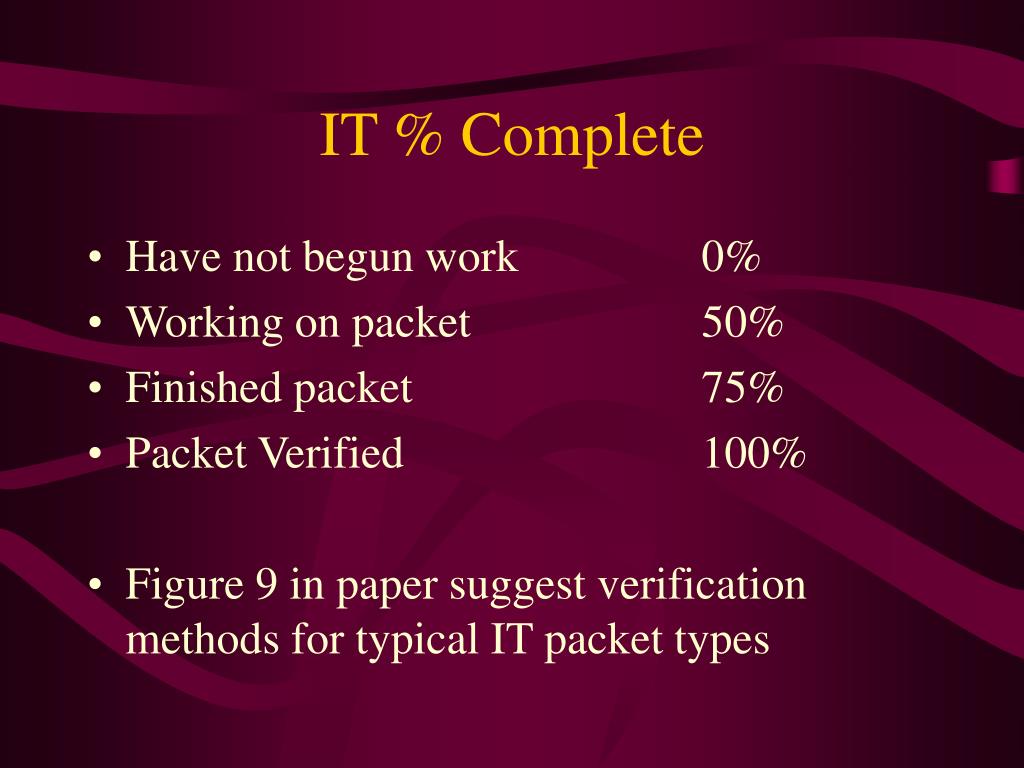

IT % Complete • Have not begun work 0% • Working on packet 50% • Finished packet 75% • Packet Verified 100% • Figure 9 in paper suggest verification methods for typical IT packet types
Integration with SEI’s CMM • Software Engineering Institute’s Capability Maturity Model (for software) • Level 2 (Repeatable) mainly concerns project management; key process areas: • Software Project Planning • Software Project Tracking and Oversight • “The project’s software effort and cost are tracked, and corrective actions are taken as necessary.”

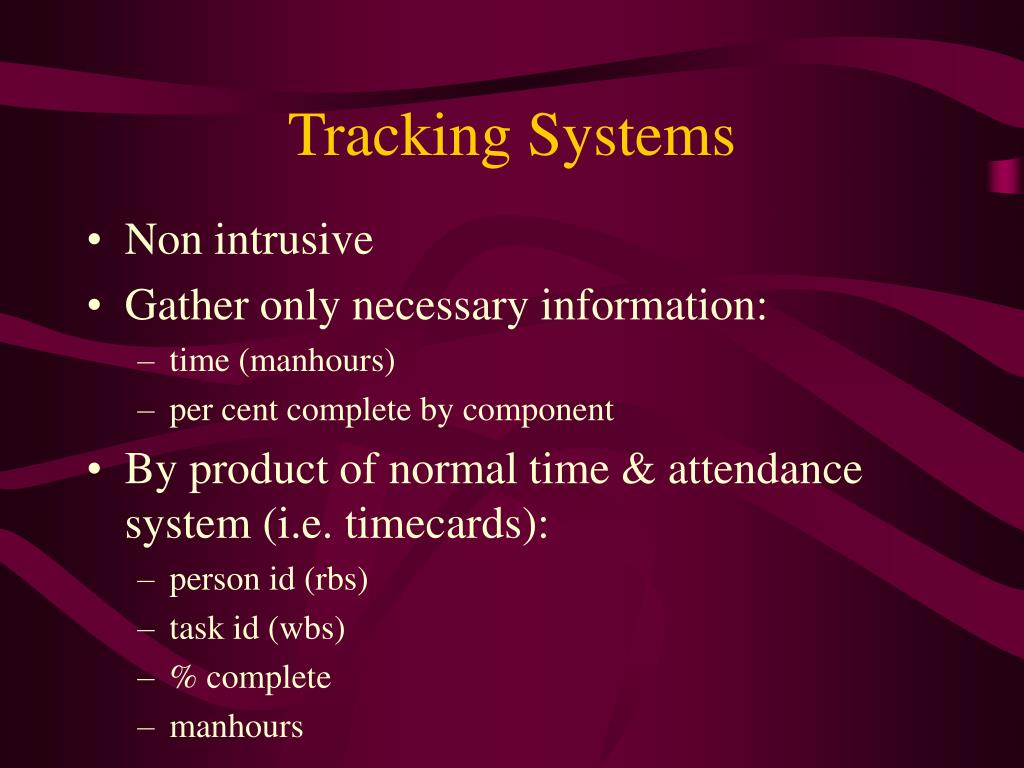

Tracking Systems • Non intrusive • Gather only necessary information: • time (manhours) • per cent complete by component • By product of normal time & attendance system (i.e. timecards): • person id (rbs) • task id (wbs) • % complete • manhours
Timely and Accurate Cost Data • Note that EV schedule variances do not need actual costs • Getting necessary and timely cost data from G/L, even at top level of WBS may not be possible • Need to “feedward” cost data based upon regular (i.e. weekly) time card and other input: • Base Earned Value on hours instead of dollars • Or base cost on hours times a category “rate” for each type of employee (ie Programmer II); using actual rates is also possible but probably is both a maintenance problem and confidentially problem).

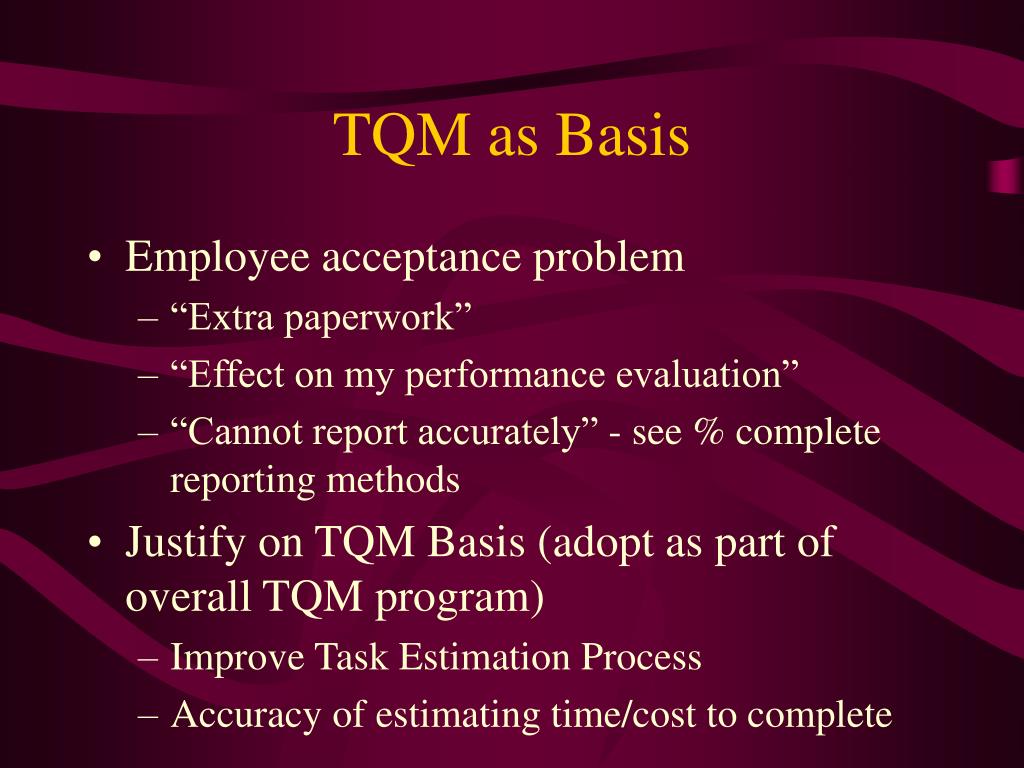

TQM as Basis • Employee acceptance problem • “Extra paperwork” • “Effect on my performance evaluation” • “Cannot report accurately” - see % complete reporting methods • Justify on TQM Basis (adopt as part of overall TQM program) • Improve Task Estimation Process • Accuracy of estimating time/cost to complete
“If you can’t measure it, you can’t manage it”.........Peter Drucker (TQM Guru) • Project Management Institute - www.pmi.org
