openETCS : An evolution to formalized specification for non-interpretable application
150 likes | 301 Views
openETCS : An evolution to formalized specification for non-interpretable application. openETCS@ITEA2 Project. Klaus-Rüdiger Hase. Istanbul, 01-03.04.2014. Objectives and major expected Outcomes. 1. Objectives. Model based Development F ramework. Software Tools. Set of. Tools. 2. 3.
openETCS : An evolution to formalized specification for non-interpretable application
E N D
Presentation Transcript
openETCS: An evolution to formalized specification for non-interpretable application openETCS@ITEA2 Project Klaus-Rüdiger Hase Istanbul, 01-03.04.2014
Objectives and major expected Outcomes 1 Objectives Model based Development Framework Software Tools Set of Tools 2 3 Formal Specification Reference Unit 2014: openETCS Open License Terms apply
ETCS EVC EVC EVC Vehicle Equipment 2 Vehicle Equipment 4 Vehicle Equipment 1 SRS “Prosa” Open Formal Specification openETCS Human Factor Human Factor Human Factor Human Factor Linus’ Law: “Many eyes make all bugs shallow” EVC Vehicle Equipment 3 2014: openETCS Open License Terms apply

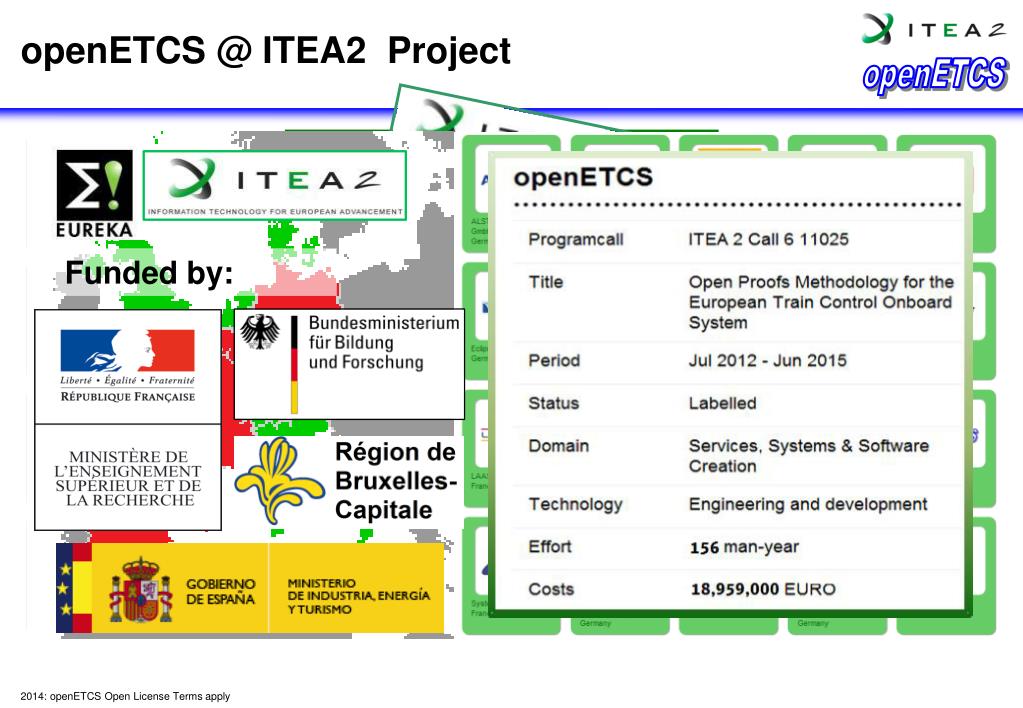

Prepare Project Management / Governance openETCS @ ITEA2 Project ITEA2Project Phases I (2011) II (2012-2013) III (2014-2015) VI (2016-2020) Organization Fundedby: openETCS Foundation e.V. openETCS Option Call M1 M2 M3 M4 M5 M6 Basics SW Tools (semi) Formal Specification Interfaces: STI / API Implemen-tation openETCS Reference OBU „Track Use Cases“ TCSim Prototype openETCS@ITEA2-Projekt 2014: openETCS Open License Terms apply

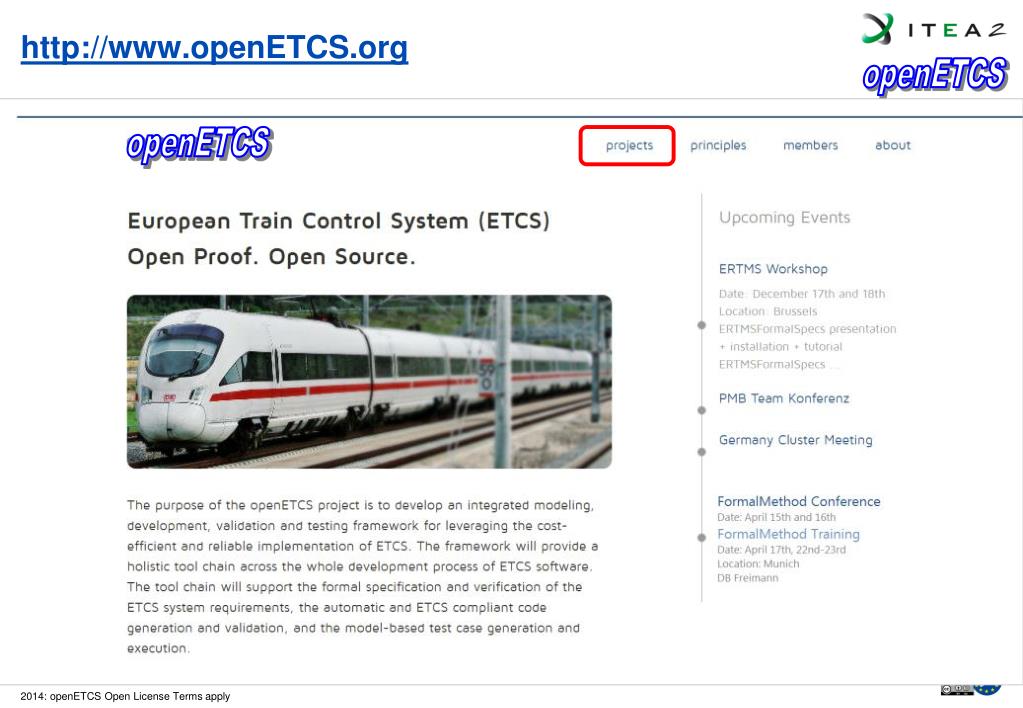

https://github.com/openETCS http://www.openETCS.org openETCS openETCS 2014: openETCS Open License Terms apply
Results D7.1 Results Tools Chain 2014: openETCS Open License Terms apply

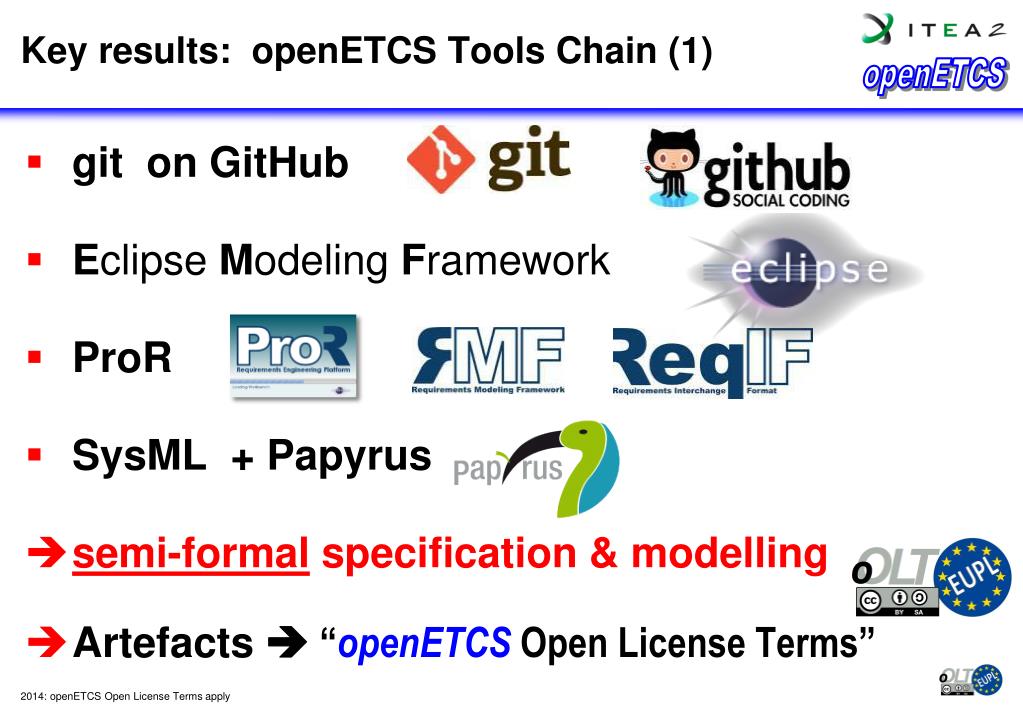

Key results: openETCS Tools Chain (1) • git on GitHub • Eclipse Modeling Framework • ProR • SysML + Papyrus • semi-formal specification & modelling • Artefacts “openETCS Open License Terms” 2014: openETCS Open License Terms apply
Key results: openETCS Tools Chain (2) • Result of our OSS Tools “Market” research: • SysML- compatible strict formal Tools not yet in OSS • “Formal Spec.” & “Ref. OBU SW” cannot wait ! • Start with SCADE input from Papyrus • Certified for CENELEC EN50128 SIL 4 development • Widely accepted in industry (avionics, rail, process control) • “Lustre”: Synchronous data flow programming language • Migration plan CSS OSS via 2014: openETCS Open License Terms apply
Long Term Availability of Software Tools? German ATP System (PZB): 1934 … 2050 ? TOPCASED sustainability thanks OSS Members of the Eclipse Foundation >100Years Very Long Term Support ? 78 Years Average Life Time forClosed Tools: ~ 10 Y ! 2014: openETCS Open License Terms apply

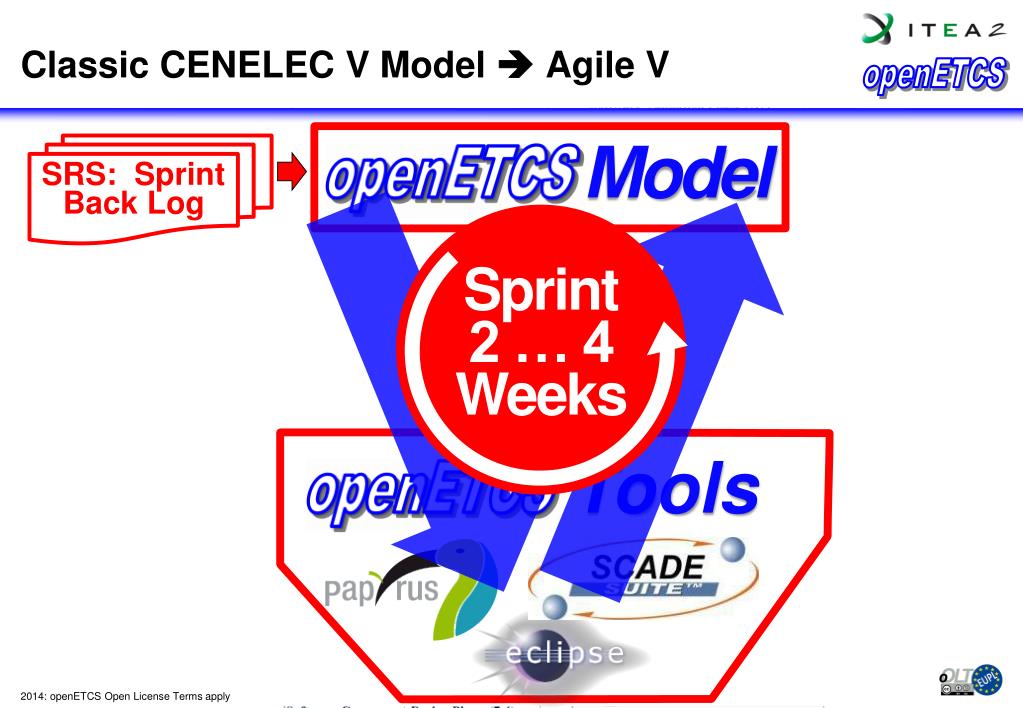

ProcessInnovation SRCUM SCRUM CENELEC EN 50128 V Model & Role Model Phase Models ETCS OBU SW SIL 4 Software Development Agile vs. Waterfall & V-Model: 30% … 80% R&D Savings Sprint2 … 4 Weeks Incremental step by step development in 2-4 weeks sprints by self-managed teams. ~45% probability of projects failing 2014: openETCS Open License Terms apply
Classic CENELEC V Model Agile V Project Initialization & Monitoring Model EN 50128:2011 - 23 - SRS: Sprint Back Log Sprint2 … 4 Weeks Design Rules Tools 2014: openETCS Open License Terms apply
HW EVC Vehicle Equipment “openIT4SR” Follow-up Project Outlook openETCS + open Corridor Legacy Systems Parameters • SW building blocks: • ETCS • ETCS+ • ETCS+ • ETCS+ • (Corridor Package) • PZB • PZB+ATB • PZB+ATB+SCMT PZB SCMT ATB otherclassB openETCS API FFFIS openSTM 2014: openETCS Open License Terms apply

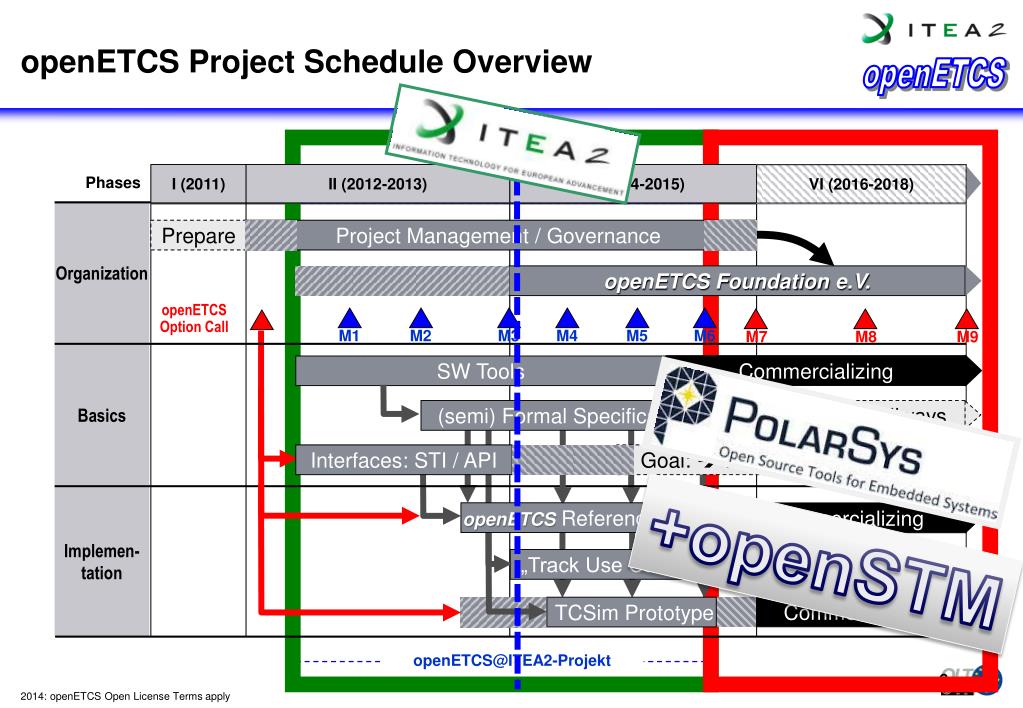

Prepare Project Management / Governance M7 M8 M9 openETCS Project Schedule Overview Phases I (2011) II (2012-2013) III (2014-2015) VI (2016-2018) Organization openETCS Foundation e.V. openETCS Option Call M1 M2 M3 M4 M5 M6 Basics Commercializing SW Tools (semi) Formal Specification ERA, EUG, Railways Interfaces: STI / API Goal: New Industrial Standard Implemen-tation openETCS Reference OBU Commercializing +openSTM „Track Use Cases“ Adoption ERTMS Users Gr. Commercializing TCSim Prototype openETCS@ITEA2-Projekt 2014: openETCS Open License Terms apply

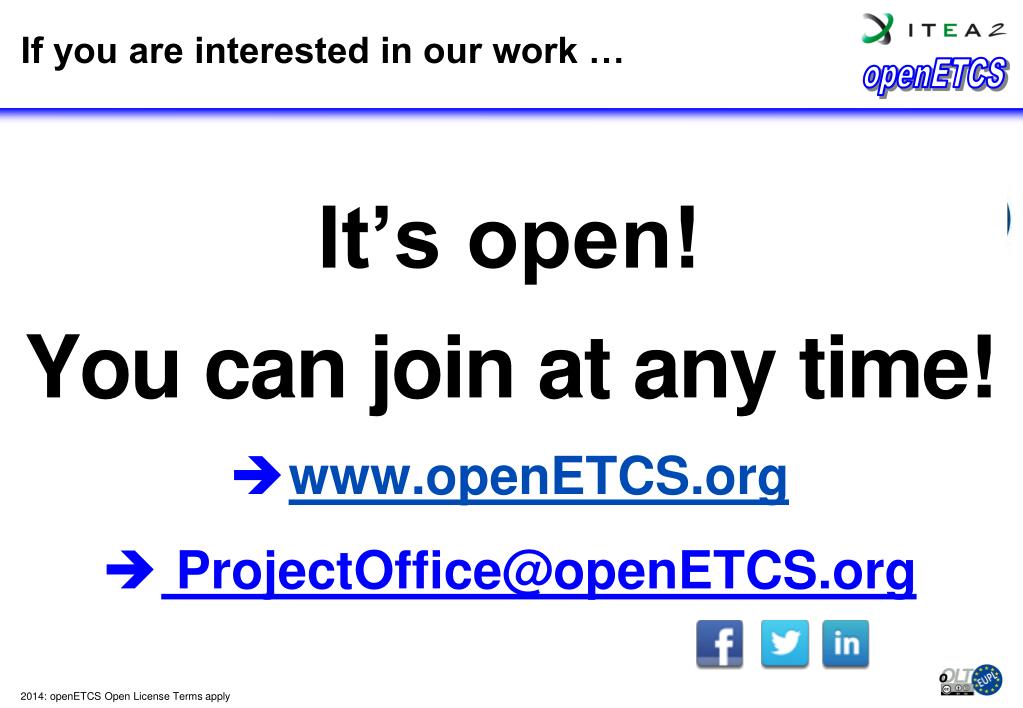

That was it … If you are interested in our work … • It’s open! • You can join at any time! • www.openETCS.org • ProjectOffice@openETCS.org • Thank you very much for your attention. 2014: openETCS Open License Terms apply
