420 likes | 597 Views
SAN ANTONIO RIVER IMPROVEMENTS PROJECT April 2006. Project Limits. Project Partners. City of San Antonio – Provides project funding for project amenities (i.e.. Sidewalks, Landscaping, Lighting, etc.) and recreation. San Antonio Water System is providing funding for utility relocation
E N D

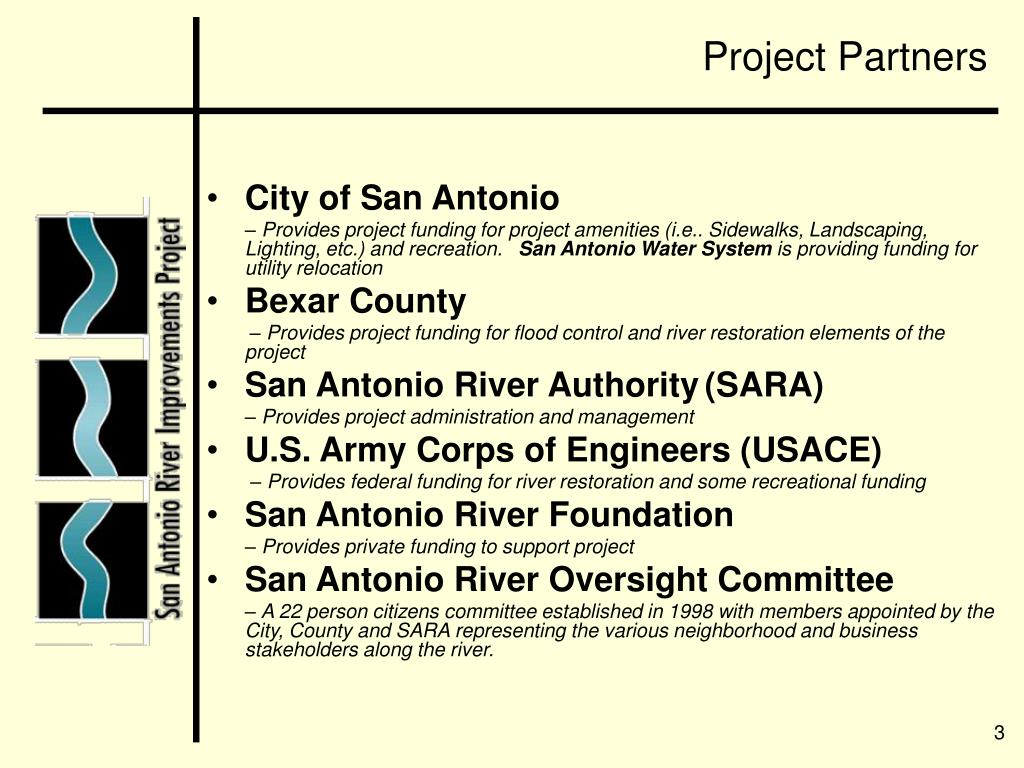

Project Partners • City of San Antonio – Provides project funding for project amenities (i.e.. Sidewalks, Landscaping, Lighting, etc.) and recreation. San Antonio Water System is providing funding for utility relocation • Bexar County – Provides project funding for flood control and river restoration elements of the project • San Antonio River Authority(SARA) – Provides project administration and management • U.S. Army Corps of Engineers (USACE) – Provides federal funding for river restoration and some recreational funding • San Antonio River Foundation – Provides private funding to support project • San Antonio River Oversight Committee – A 22 person citizens committee established in 1998 with members appointed by the City, County and SARA representing the various neighborhood and business stakeholders along the river.
Project Benefits • Ecosystem Restoration – The changes proposed will increase water quality and the quantity and diversity of plant and animal species. • Flood Reduction – Project will maintain or decrease the elevation of the 100 year floodplain. • Quality of Life – Add to San Antonio’s unique charm and make the city more attractive to residents, visitors, and businesses and provide enhanced recreational opportunities along an expanded linear park system. • Cultural connections – Linking people, neighborhoods and cultural resources and celebrating the historical connection of the river to four of the five historic missions in the San Antonio Missions National Historical Park. • Economic Development – Promote business development along and adjacent to the river. Improvements will also enhance tourism.
Preliminary Design Completed 2004 Concept Design Completed 2001 Final Design Under Way Construction Phase Beginning in 4th Quarter 2006 Project Development Process
Current Project Estimate October 2005Presented in Million Dollars (inflated) * Based on GRR preliminary estimates reflecting USACE District initial planning and feasibility. The project budget includes a higher estimated cost for inflation over the life of the project than reflected in the GRR. USACE will further refine construction cost estimates during final design phase.

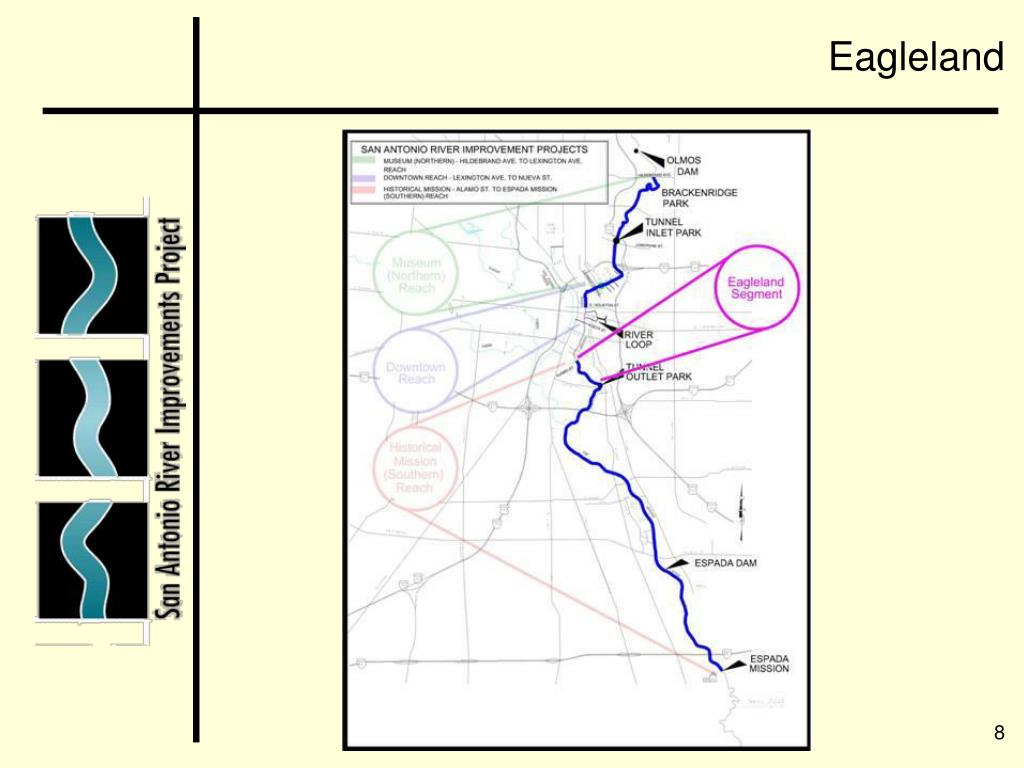

Eagleland Project Before Completion of Phase I
Mission Reach Proposed USACE project limits
Ecosystem Restoration Existing River Channel Currently, a riverine system does not exist within the Mission Reach. The riparian habitat is non-existent and the aquatic habitat suffers sever degradation, largely due to the absence of a functioning riparian corridor. Current riverine system rates a 1.2* (based on scale with 1 as extremely degraded and 10 as pristine) *Per US Army Corps of Engineers Study
Ecosystem Restoration • Proposed River Channel • Through geomorphic and sediment transport analysis a more stable and natural river channel will be produced. • Requires the acquisition of 128 acres of adjacent land • Requires the excavation of 2.7 million cubic yards of soil Proposed project riveine system rates an 8.2* (based on scale with 1 as extremely degraded and 10 as pristine) *After 50 year maturity period per US Army Corps of Engineers Study
Project Vision • Historical Mission Reach at Ashley Road (looking North) Proposed Existing
Project Vision • Historical Mission (Southern) Reach at Loop 410 South Proposed Existing

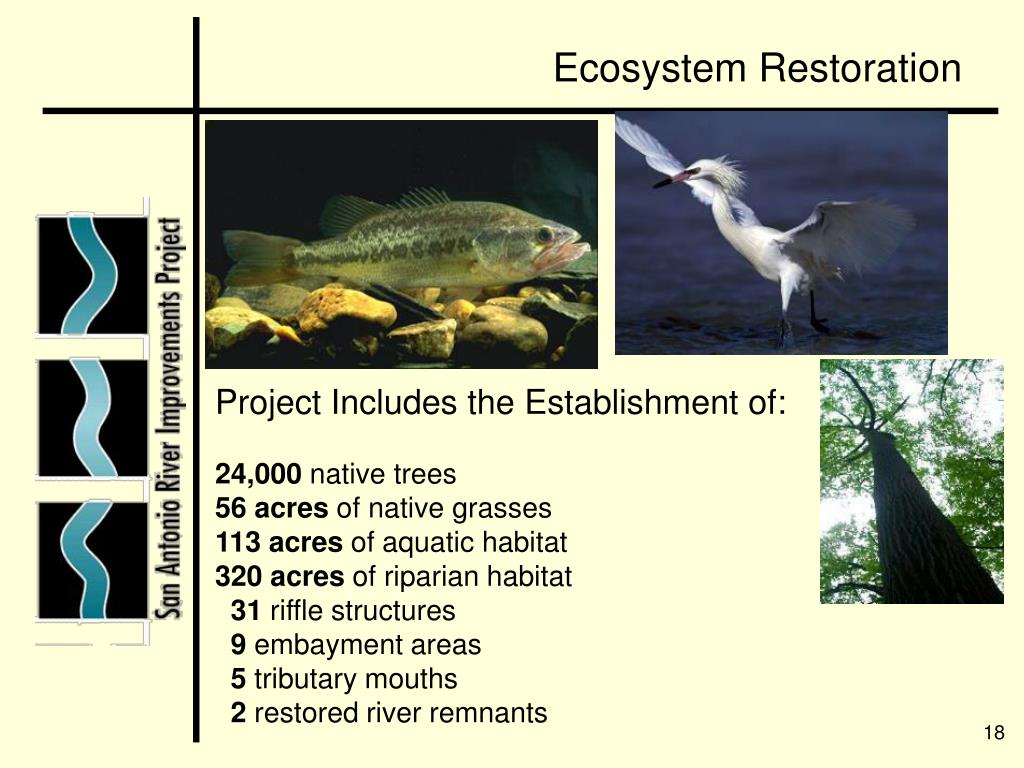

Ecosystem Restoration Project Includes the Establishment of: 24,000 native trees 56 acres of native grasses 113 acres of aquatic habitat 320 acres of riparian habitat 31 riffle structures 9 embayment areas 5 tributary mouths 2 restored river remnants
Improved Human Habitat Basic recreational components are publicly funded. Shade Pavilion
Cultural Connections Mission Portals • Mission Portals provide links to 4 of the 5 Missions located along the Mission Reach. • Privately funded
Scenic Overlooks Privately Funded
Project Status Report • Mission Reach • 30% Final Design due June 2006 • SARA and USACE finalizing Project Cooperation Agreement to support completion of design and construction • USACE finalizing agreement with National Parks Service for land transaction • Working to secure federal funding for construction
Mission Reach Construction Phasing Mission Reach Segment 1: Lone Star to San Pedro Creek: Mid 2007 through Mid 2009 Mission Reach Segment 2: San Pedro Creek to San Juan Diversion: Early 2008 through Early 2010 Mission Reach Segment 3: San Juan Diversion to Espada Dam: Late 2009 through Early 2011 Mission Reach Segment 4: Espada Dam to Mission Espada: Mid 2010 through Early 2012
Museum (Northern) Reach at Brooklyn Ave. Project VisionMuseum Reach: Urban Segment Proposed Existing
Privately Funded Amenities Publicly Funded Privately Funded Amenities Channel Improvements Museum ReachUrban Segment Scenario “G” Typical Channel Section PubliclyFunded PubliclyFunded
Museum ReachExisting Conditions Near Brooklyn Street

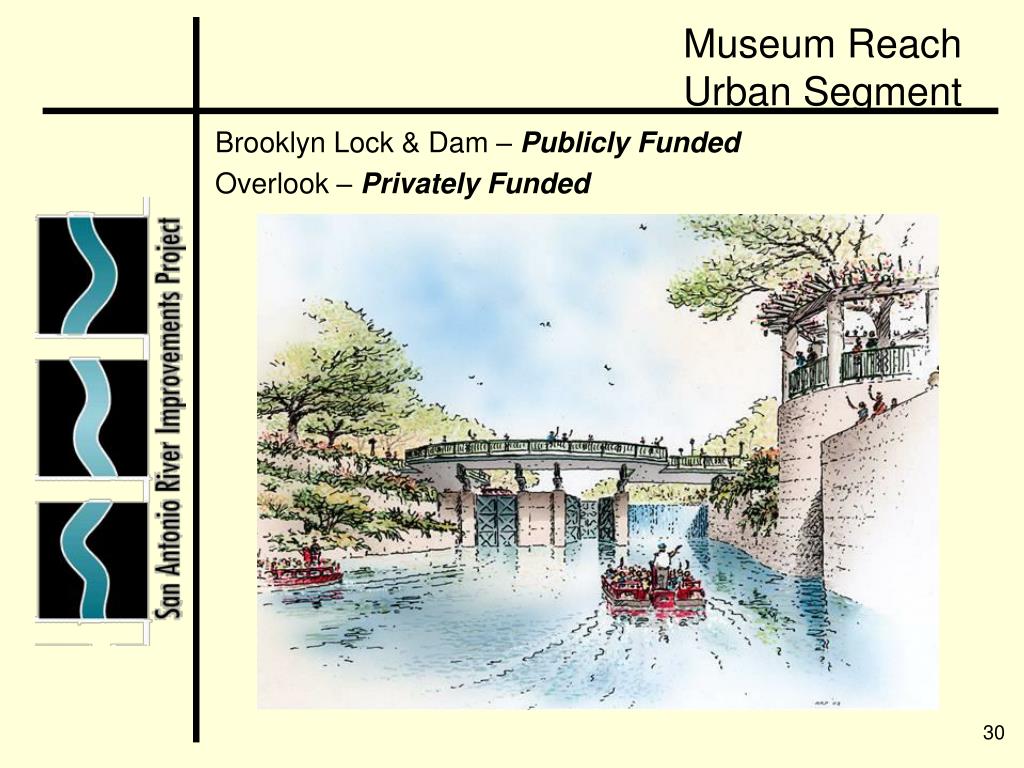

Museum ReachUrban Segment Brooklyn Lock and Dam – Publicly Funded
Museum ReachUrban Segment Brooklyn Lock & Dam – Publicly Funded Overlook – Privately Funded
Museum ReachPedestrian Crossing Roy Smith Street – Requires Private Funding
Museum Reach Urban Segment Restored Steel Truss Bridge – Privately Funded

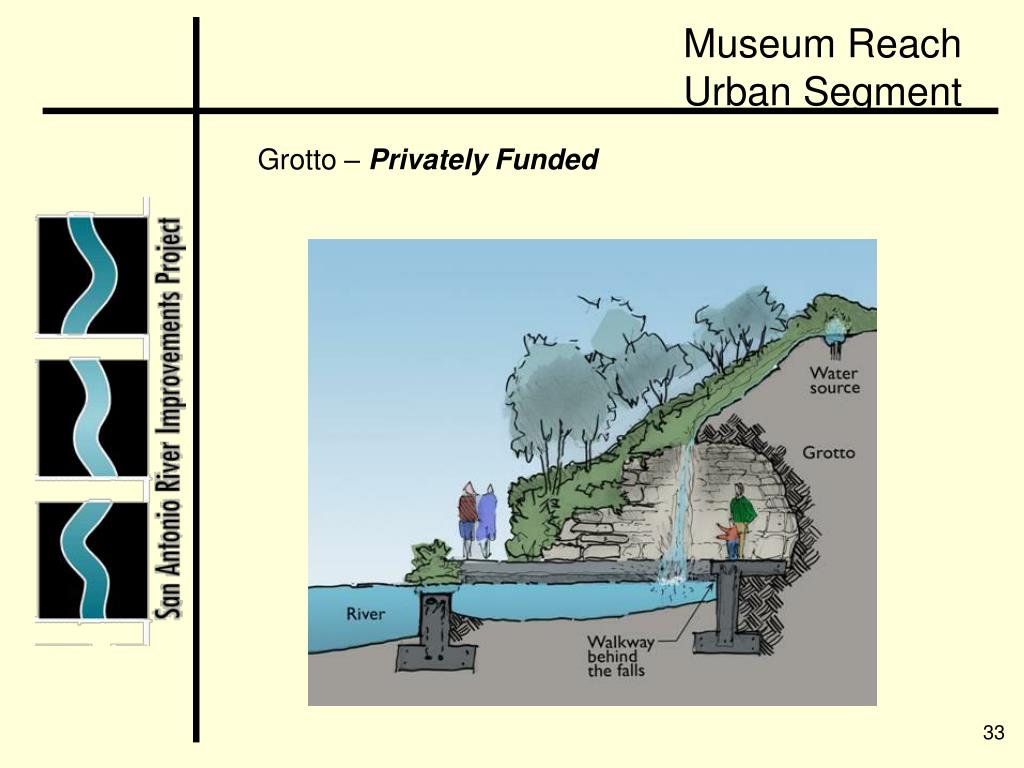

Museum ReachUrban Segment Grotto – Privately Funded
Museum ReachTurning Basin Near Grayson – Requires Private Funding
Museum ReachTurning Basin Near Grayson – Requires Private Funding
Museum ReachUrban Segment • Items to be Privately Funded • Sidewalks & Stairs • Overlooks • Landscaping • Irrigation • Islands • Marshes • Lighting • Emergency Call Boxes • Safe Harbor • Boat Ramp • Accessible Ramps • Benches & Trash Cans • Signage • Water Features • Roy Smith Bridge • Art

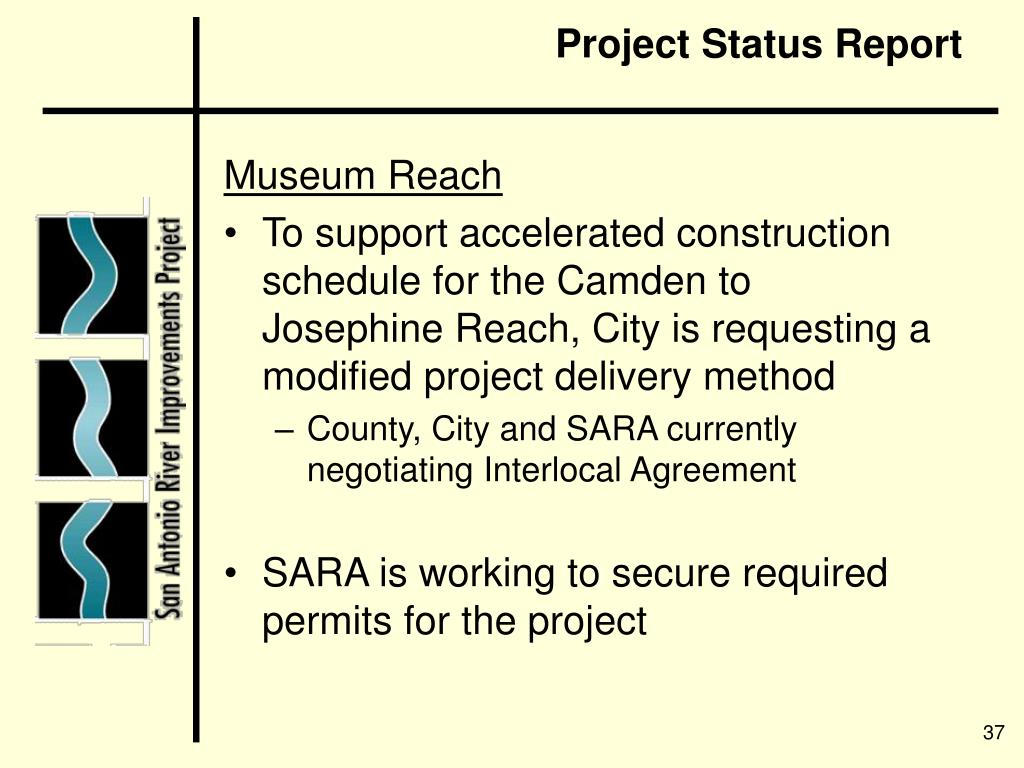

Project Status Report Museum Reach • To support accelerated construction schedule for the Camden to Josephine Reach, City is requesting a modified project delivery method • County, City and SARA currently negotiating Interlocal Agreement • SARA is working to secure required permits for the project

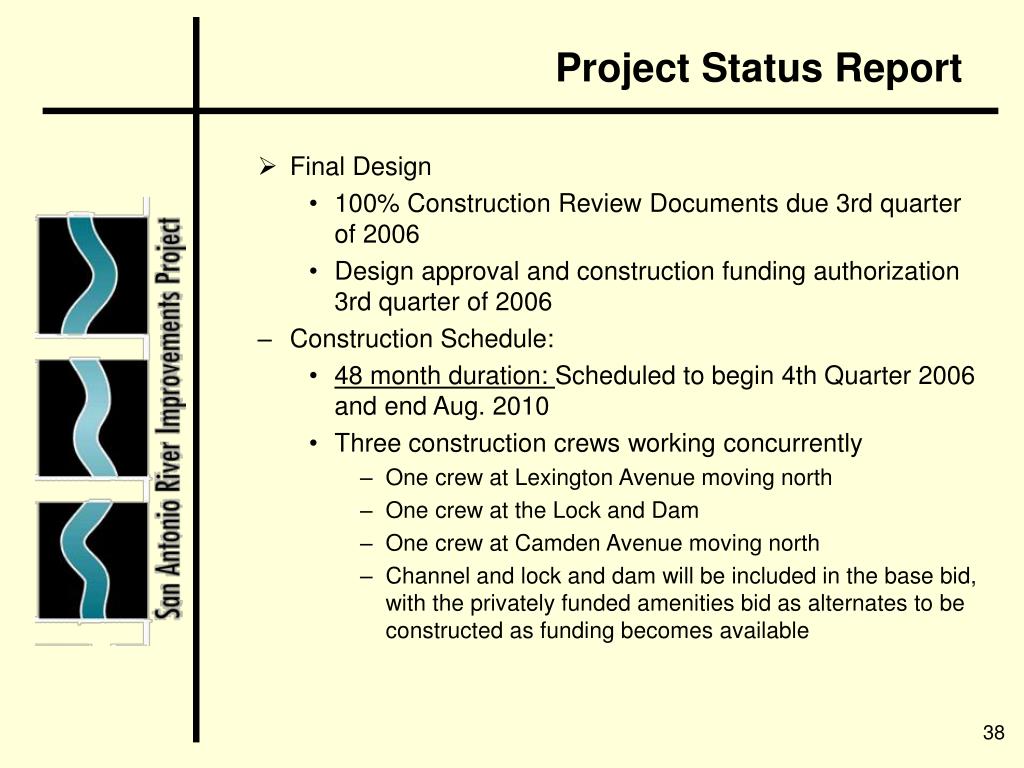

Project Status Report • Final Design • 100% Construction Review Documents due 3rd quarter of 2006 • Design approval and construction funding authorization 3rd quarter of 2006 • Construction Schedule: • 48 month duration: Scheduled to begin 4th Quarter 2006 and end Aug. 2010 • Three construction crews working concurrently • One crew at Lexington Avenue moving north • One crew at the Lock and Dam • One crew at Camden Avenue moving north • Channel and lock and dam will be included in the base bid, with the privately funded amenities bid as alternates to be constructed as funding becomes available
