cost benefit analysis on the david lawrence convention center

Cost Benefit Analysis on the David Lawrence Convention Center

Presented by: Jie Hu, Dontai Johnson, Mike Niemeyer, Jin Wang

assumptions guiding entire analysis
Assumptions Guiding Entire Analysis
  • Costs and benefits are different from that of the former Convention Center
  • Impact of new hotel not included
  • Estimating 19 year life span for new center (old center: 1981-2000)
  • Started analysis in 1999 when funding secured and ended in 2020
  • Debt service costs extended to 2035

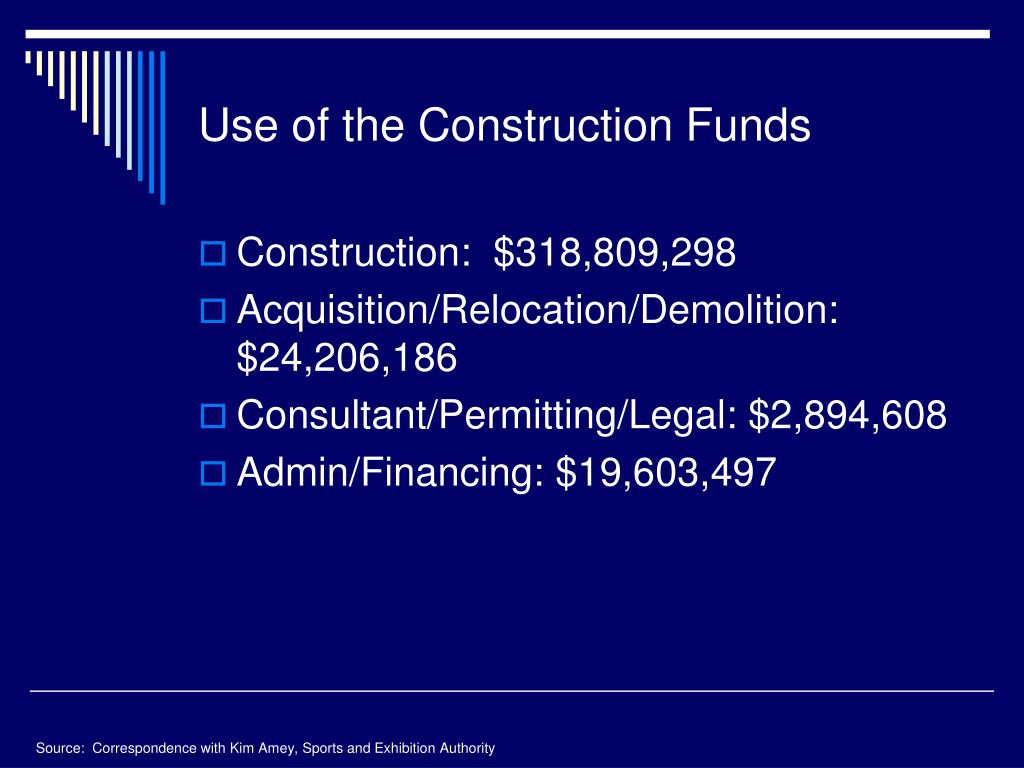

use of the construction funds
Use of the Construction Funds
  • Construction: $318,809,298
  • Acquisition/Relocation/Demolition: $24,206,186
  • Consultant/Permitting/Legal: $2,894,608
  • Admin/Financing: $19,603,497

Source: Correspondence with Kim Amey, Sports and Exhibition Authority

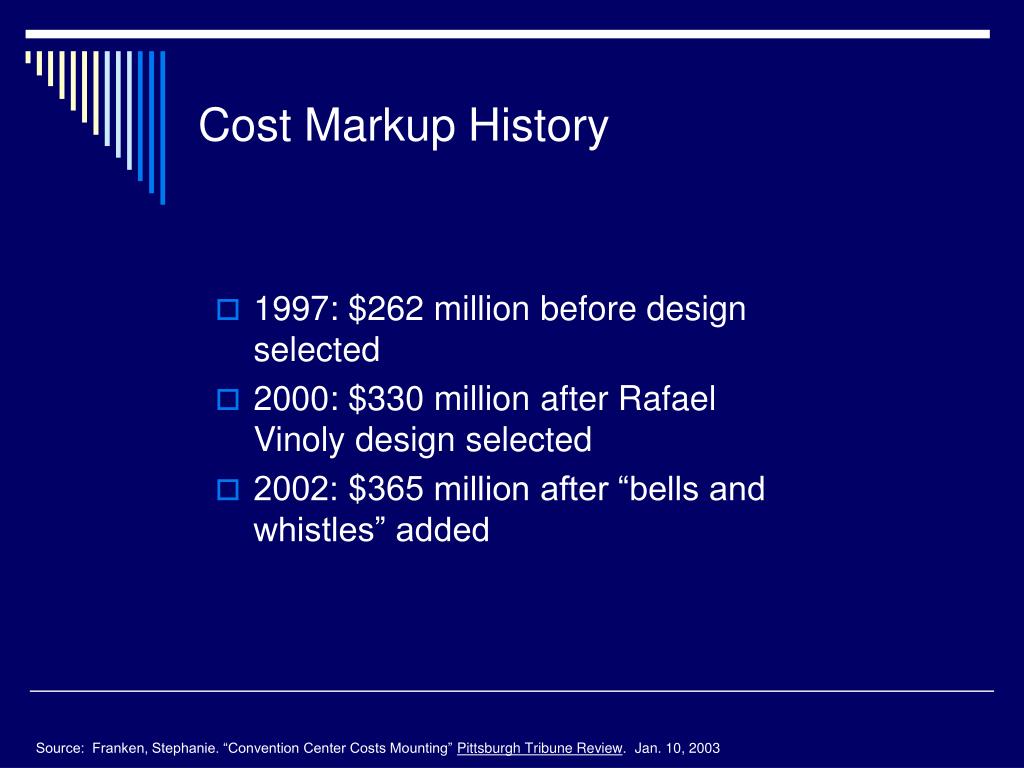

cost markup history
Cost Markup History
  • 1997: $262 million before design selected
  • 2000: $330 million after Rafael Vinoly design selected
  • 2002: $365 million after “bells and whistles” added

Source: Franken, Stephanie. “Convention Center Costs Mounting” Pittsburgh Tribune Review. Jan. 10, 2003

bells and whistles crank up costs
“Bells and Whistles” Crank Up Costs

Source: Franken, Stephanie. “Convention Center Costs Mounting” Pittsburgh Tribune Review. Jan. 10, 2003

sensitivity analysis parameters
Sensitivity Analysis Parameters
  • Used the OMB discount rate of 7%
  • Used a Time Declining rate as follows:

1999-2004: 4%

2005-2023: 3%

2024-2035: 2%

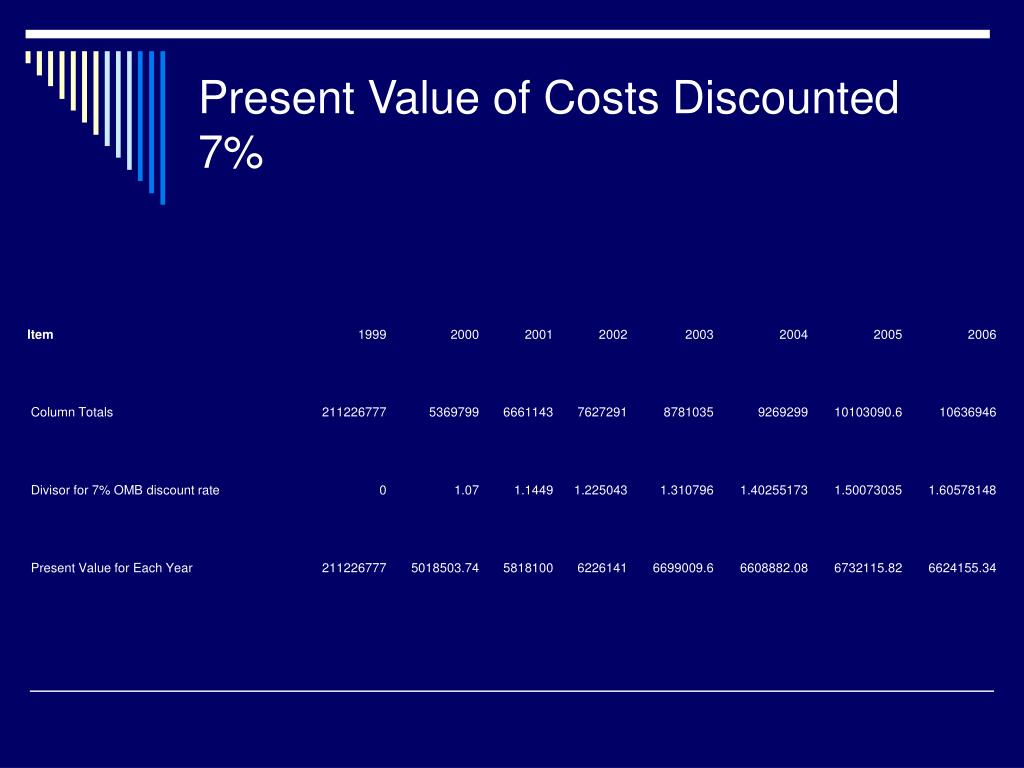

present value of costs discounted 7 cont
Present Value of Costs Discounted 7% (cont)

Present Value of Costs => $372,926,556.10

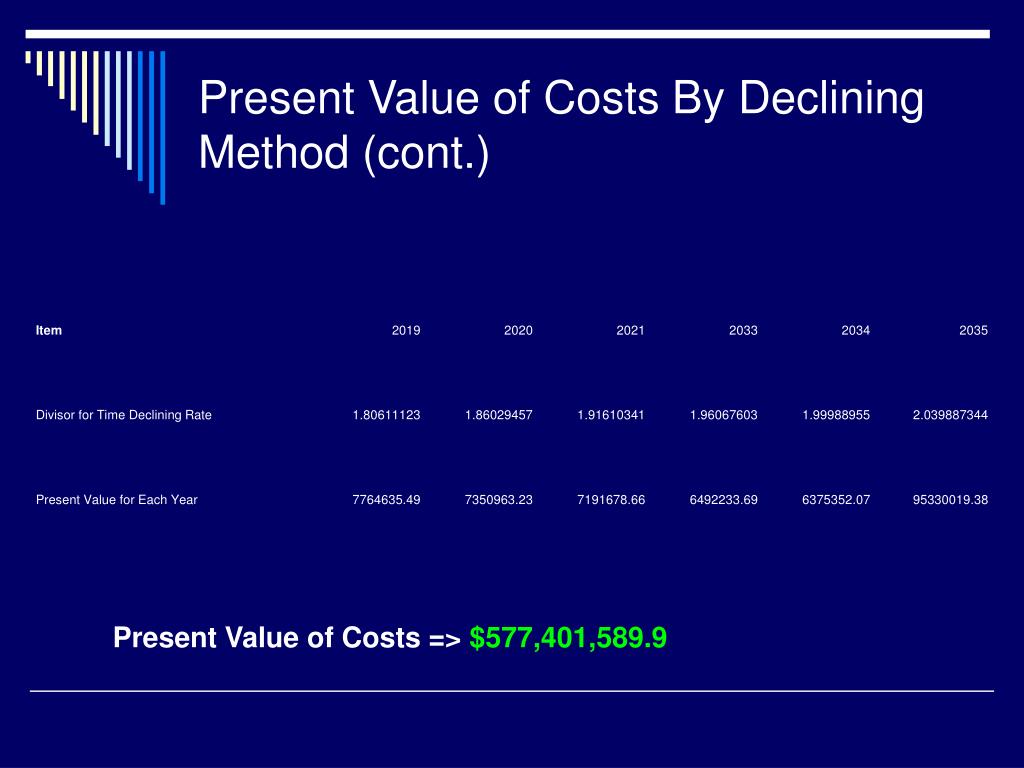

present value of costs by declining method cont
Present Value of Costs By Declining Method (cont.)

Present Value of Costs => $577,401,589.9

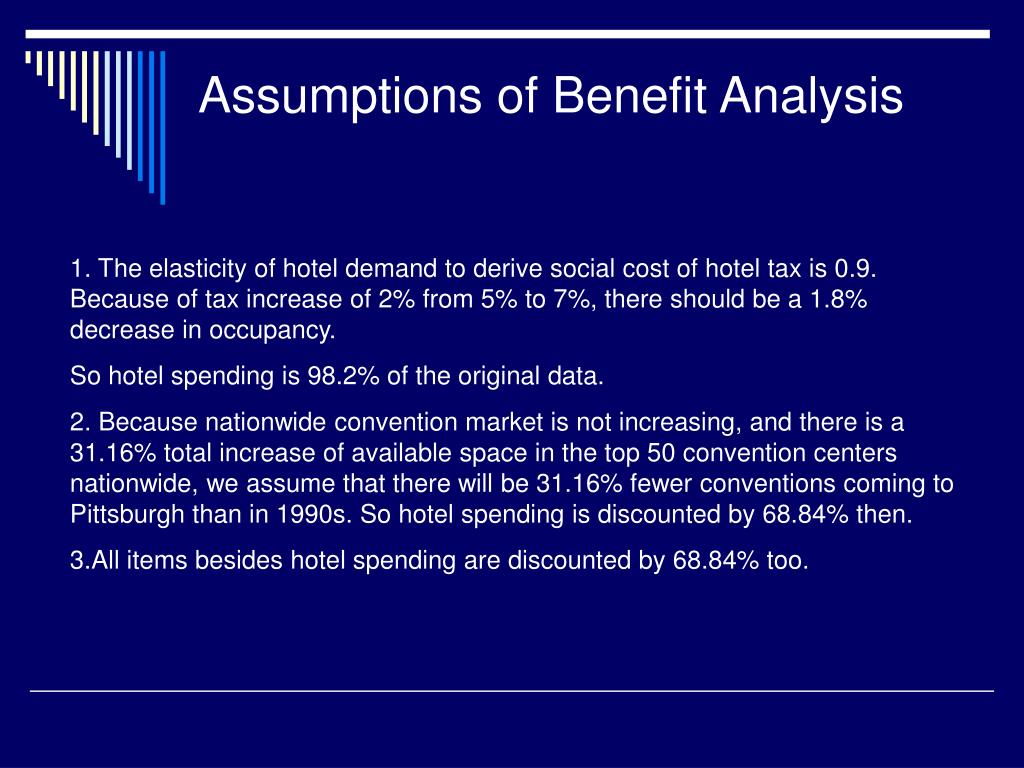

assumptions of benefit analysis
Assumptions of Benefit Analysis

1. The elasticity of hotel demand to derive social cost of hotel tax is 0.9. Because of tax increase of 2% from 5% to 7%, there should be a 1.8% decrease in occupancy.

So hotel spending is 98.2% of the original data.

2. Because nationwide convention market is not increasing, and there is a 31.16% total increase of available space in the top 50 convention centers nationwide, we assume that there will be 31.16% fewer conventions coming to Pittsburgh than in 1990s. So hotel spending is discounted by 68.84% then.

3.All items besides hotel spending are discounted by 68.84% too.

construction job benefits
Construction Job Benefits

Construction worker’s annual salary => $43,981.60

Number of workers from 2000 to 2003 => 200

Total benefits at 7% Rate => $24,761,991.31

Total benefits at Time Declining Rate => $26,290,371.56

Source: http://ci.ftlaud.fl.us/jobs/01_positions/67-559-07.pdf

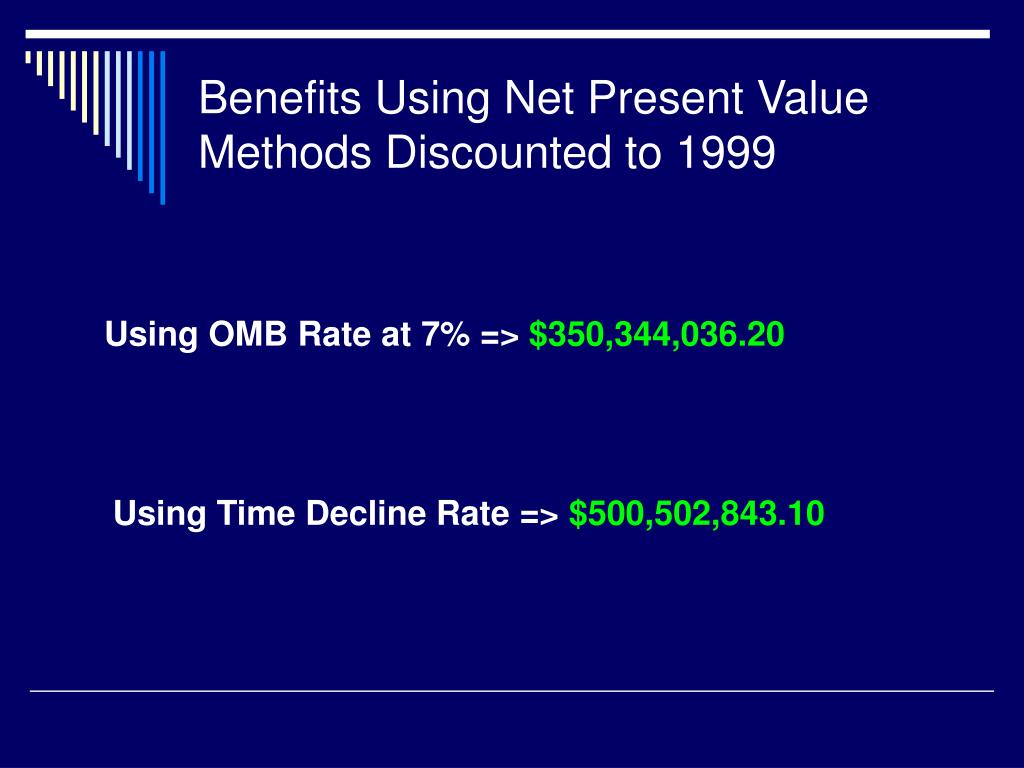

benefits using net present value methods discounted to 1999
Benefits Using Net Present Value Methods Discounted to 1999

Using OMB Rate at 7% => $350,344,036.20

Using Time Decline Rate => $500,502,843.10

grand total with omb rate discounting
Grand Total with OMB Rate Discounting

Benefits: 350,344,036

Costs: 372,926,556

-22,582,520

-

grand total with time decline rate discounting
Grand Total with Time Decline Rate Discounting

Benefits: 500,502,843

Costs: 577,401,589

-76,898,746

-

how does a city save face
How Does a City Save Face?

“Often there’s additional public investment to try to save the convention center that was supposed to save downtown. The quest to redeem a non-functioning convention center often ends up putting the public sector into the hotel business.”

-Heywood Sanders, Ph.D., University of Texas-San Antonio
