控制采集各系统准备状态汇报

控制采集各系统准备状态汇报. 总控组 采集组 PCS 组. 总控调试记录 时间节点. 8.14 ~ 8.21 总控内部调试 < 检测、维修、调试 > 放电程序运行正常,安全联锁系统检测,触发通道检测,大屏幕显示均正常。炮号服务器更新正常。总控系统内部网络通信流畅。 8.22 七室内部联调 < 联调 > 总控与采集, PCS 内部系统联调,触发通道测试正常,安全联锁功能正常。. 8.24 真空调试 < 调试 >

elvina
Download Presentation

控制采集各系统准备状态汇报

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. 控制采集各系统准备状态汇报 总控组 采集组 PCS组

  2. 总控调试记录时间节点 • 8.14 ~ 8.21 总控内部调试 < 检测、维修、调试 > • 放电程序运行正常,安全联锁系统检测,触发通道检测,大屏幕显示均正常。炮号服务器更新正常。总控系统内部网络通信流畅。 • 8.22 七室内部联调 < 联调 > • 总控与采集,PCS内部系统联调,触发通道测试正常,安全联锁功能正常。

  3. 8.24 真空调试 < 调试 > 总控与真空测试,测试正常,炮号接收无误。另新增真空系统两个发送炮号地址,UDP协议发送,经测试接收炮号正常。 8.29 极向场联调 < 联调 > 经网络检查,极向场网络恢复正常,与总控通信流畅。总控带极向场,与PCS、采集系统联调,触发正常,炮号服务器工作正常,PCS、采集也能正常工作,放电过程能做正确走下去。TS测试:炮号以及触发正常。 9.4 东华系统测试 < 调试 > 总控与东华测试,炮号、触发检查,调试正常。

  4. 采集准备时间节点 • 8.13~8.17 • 对采集机硬件进行调试,包括电源,放大器,连接线,采集板卡,采集机 • 将HT7采集网络合并到新的采集网络,对采集机与服务器之间的通信进行调试 • 8.20~8.24 • 对采集程序进行调试 • 使用标准信号对所有通道进行测试 • 与总控进行联调

  5. 采集机状态 • 共有15台采集机器 • 2台DAQ2204,3台DAQ2206(采样率10K~50KHz) • 9台NPCI(采样率250KHz) • 1台PXI2022(采样率250KHz) 注:因为部分NPCI采集卡老化,替换成PXI2022。 • 总通道数609 • 所有采集机经过内部测试,可以正常运行

  6. 服务器网络状态 • 根据前段时间服务器和网络的更新状态,对HT7数据接受模块和访问模块进行全面的修改,对HT7采集数据库进行了更新 • HT7采集系统的网络统一合并到更新过的采集网中 • 采集系统内部测试已经完全正常,通过EastSCOPE可以正常查看数据

  7. PCS联调结果 • 上两周PCS完成了自身系统恢复和调试,PCS专用采集机工作正常,采集数据传输正确。并与总控系统、极向场系统进行了联调,目前PCS接受炮号、触发等一切正常,发送给极向场的控制命令正常,充气通路正常,目前PCS已达到随时放电的要求。

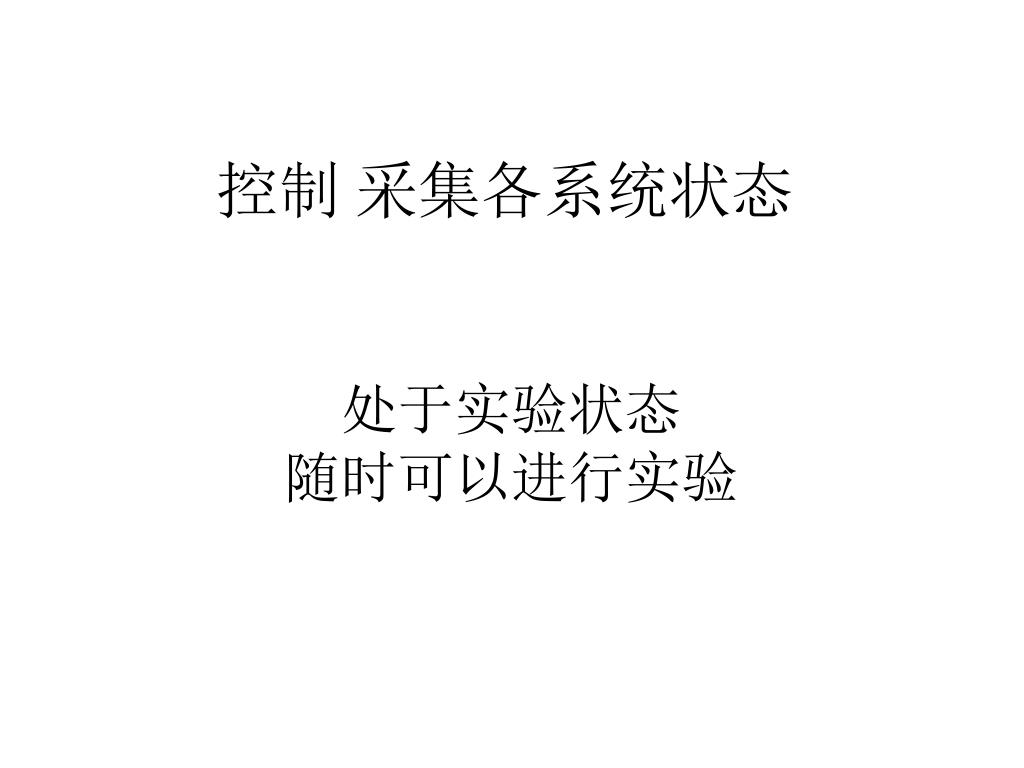

  8. 控制 采集各系统状态 处于实验状态 随时可以进行实验
