  1. PRD-13 Project Report Software Engineering Courses Teaching Aided Website

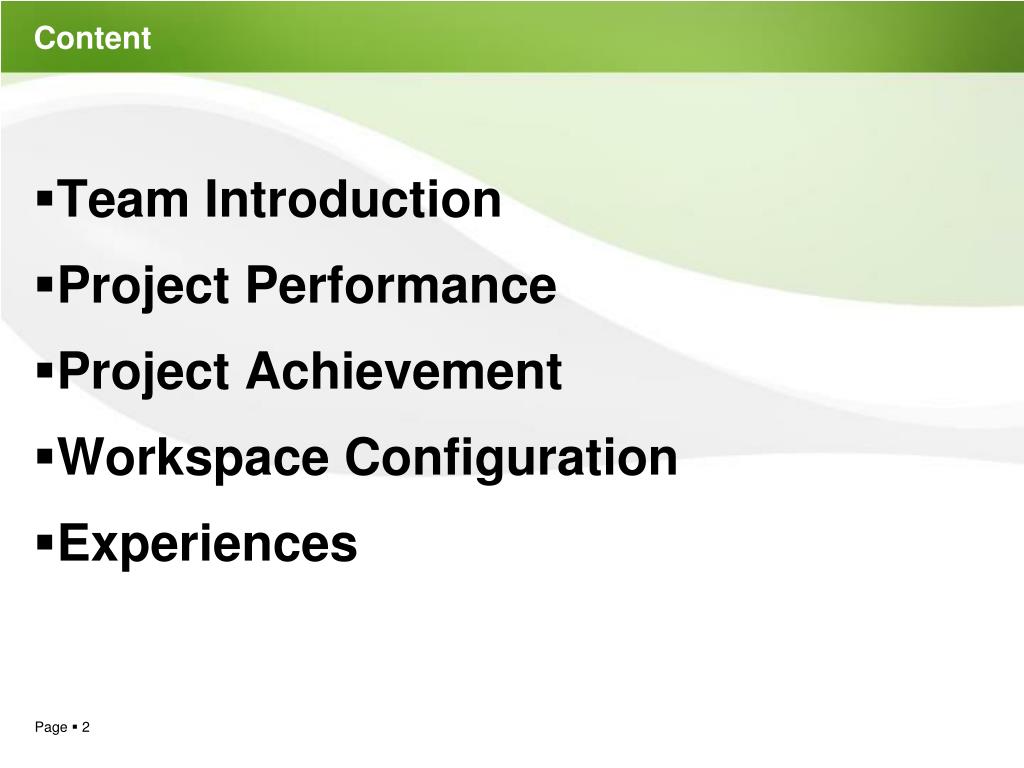

  2. Content • Team Introduction • Project Performance • Project Achievement • Workspace Configuration • Experiences

  3. Team Introduction

  4. Team Introduction--- Team Organization • Team Leader: Xin TAN • Team Members: Azhu LIU Shan WU Shengpeng LIU Sizhao SHANG Ting ZHANG Xinxin HUANG Yifan ZHAO

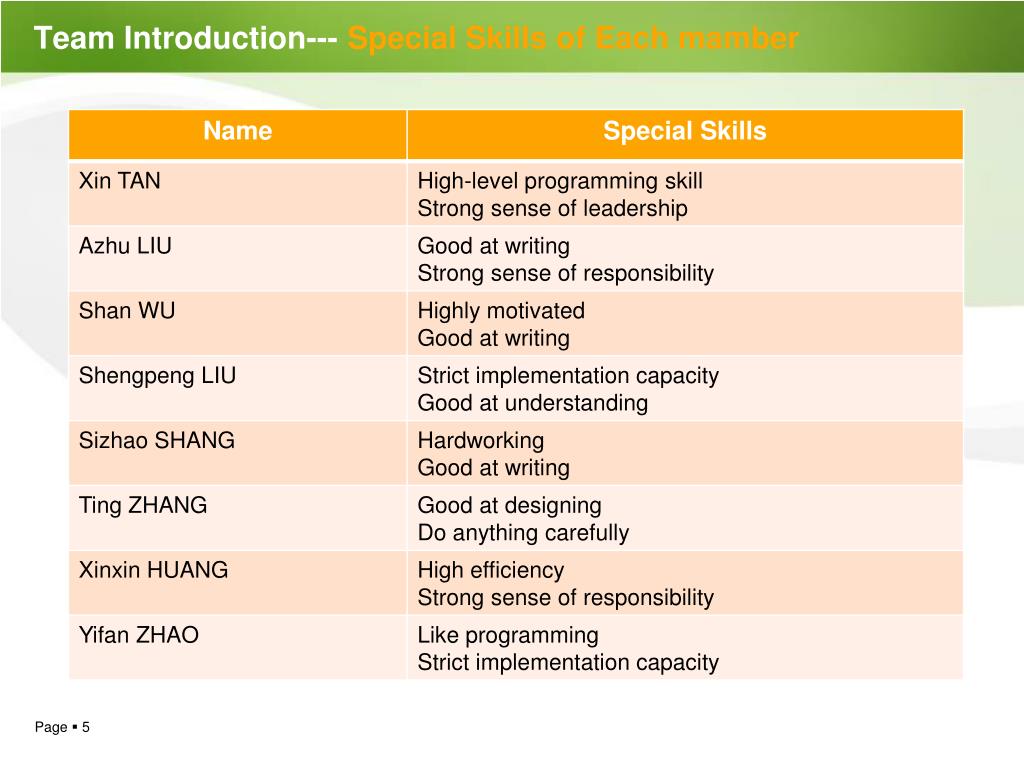

  5. Team Introduction--- Special Skills of Each mamber

  6. Project Performance

  7. Content • 1. Team Introduction • 2. Project Performance • 3. Project Achievement • 4. Workspace Configuration • 5. Experiences

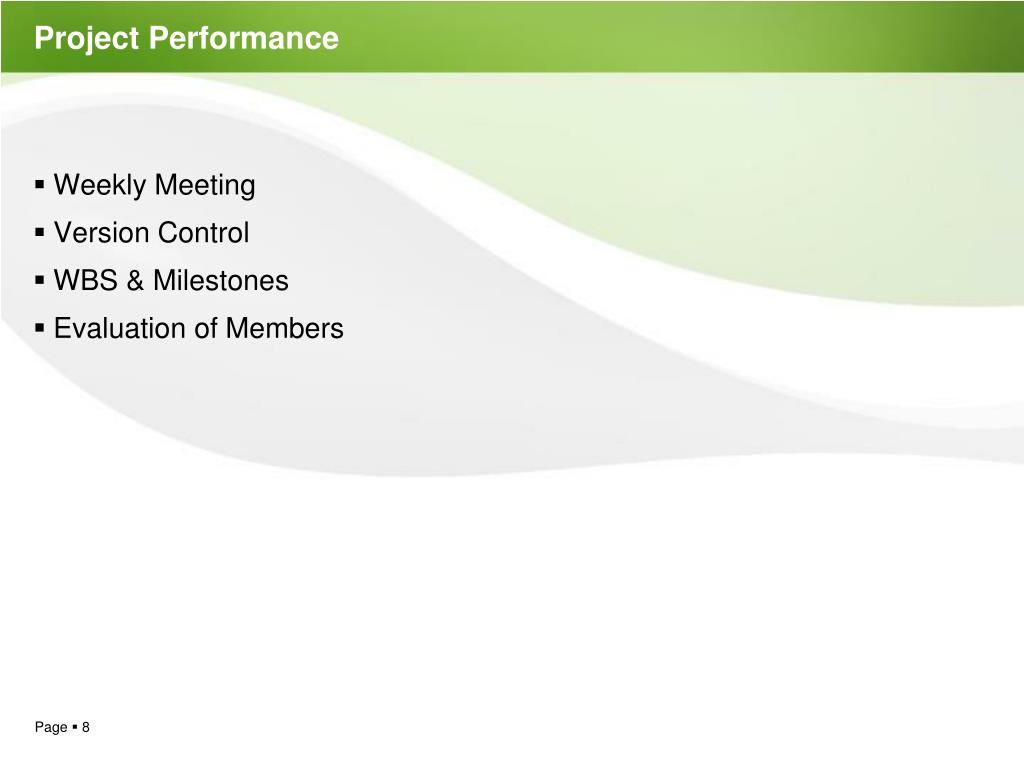

  8. Project Performance • Weekly Meeting • Version Control • WBS & Milestones • Evaluation of Members

  9. Project Performance---Weekly Meeting Time: 2:00 pm every Saturday Place: Dormitory No. 30, Yuquan Campus Duration: 1-2 hours Participants: All team members Targets: 1. Conclude previous work 2. Solve untackled problem 3. Assign tasks in the following stage Other Methods for communication: QQ Discussion Group

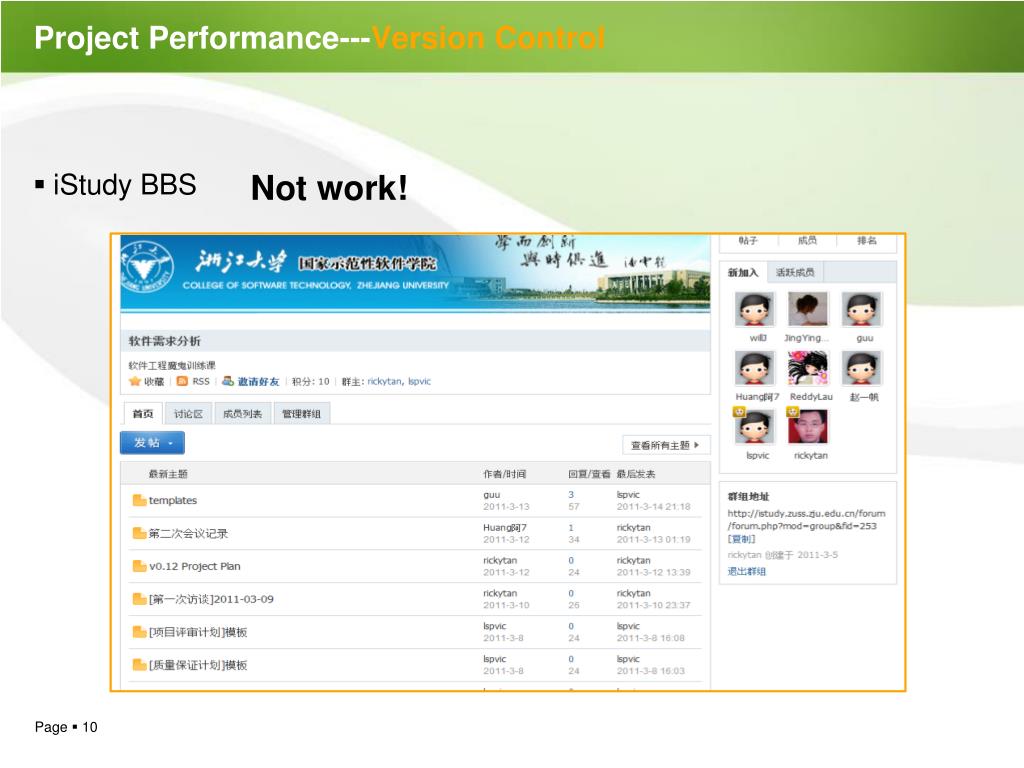

  10. Project Performance---Version Control Not work! • iStudy BBS

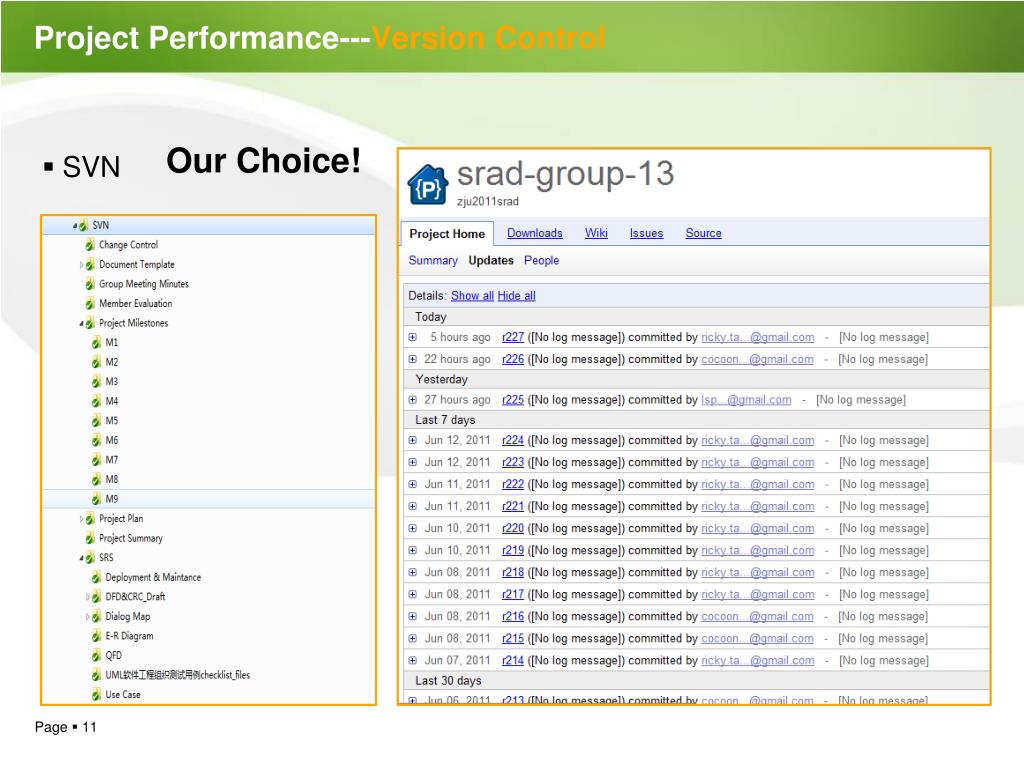

  11. Project Performance---Version Control Our Choice! • SVN

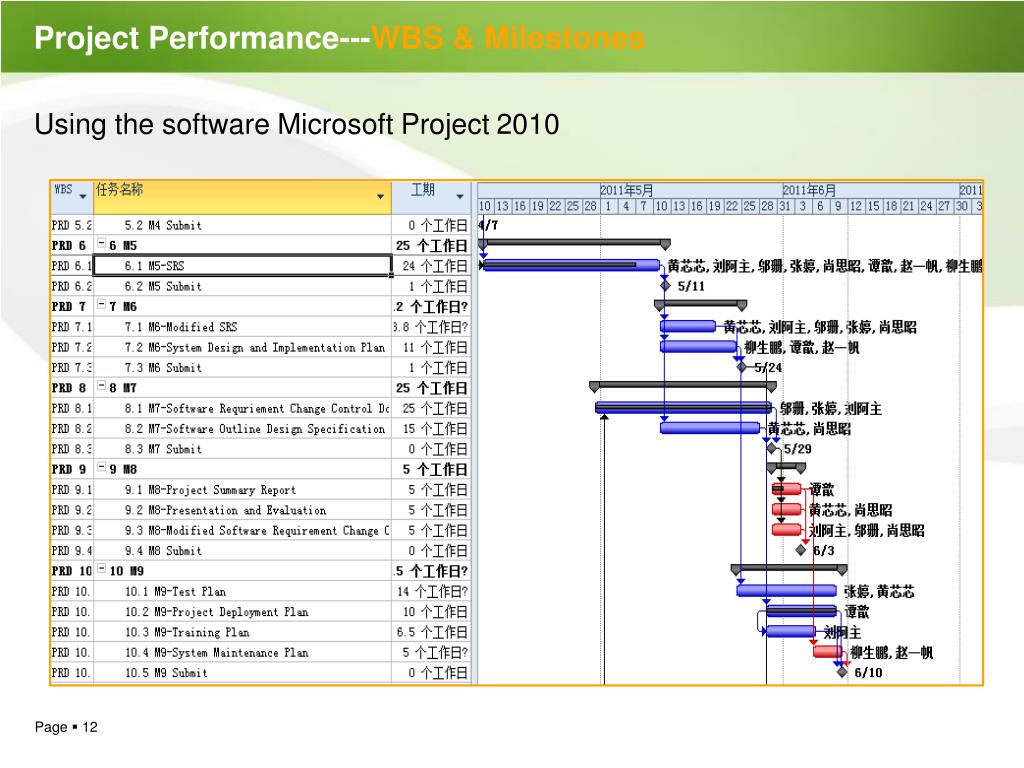

  12. Project Performance---WBS & Milestones Using the software Microsoft Project 2010

  13. Project Performance---Evaluation of Members

  14. Project Achievement

  15. Project Achievement --- Milestone M 2 M5 M1 M3 M 4 Project Chapter & Project Plan 3.18 ~ 4.1 Requirement Engineering Plan 2.25 ~ 3.11 Project Feasibility Analysis 3.10 ~3.18 Modified Requirement Engineering Plan 3.11 ~4.7 SRS 4.11 ~ 5.12 M 6 M 8 M7 Modified SRS & System Design and Implementation 5.12 ~5.27 Software Requirement Change Control & Outline Design Specification 5.30 ~ 6.2 Project Summary Report & Presentation 6.3 ~6.9 M9 Test Plan & Project Deployment & Training Plan & System Maintenance Plan 5.27 ~ 6.16

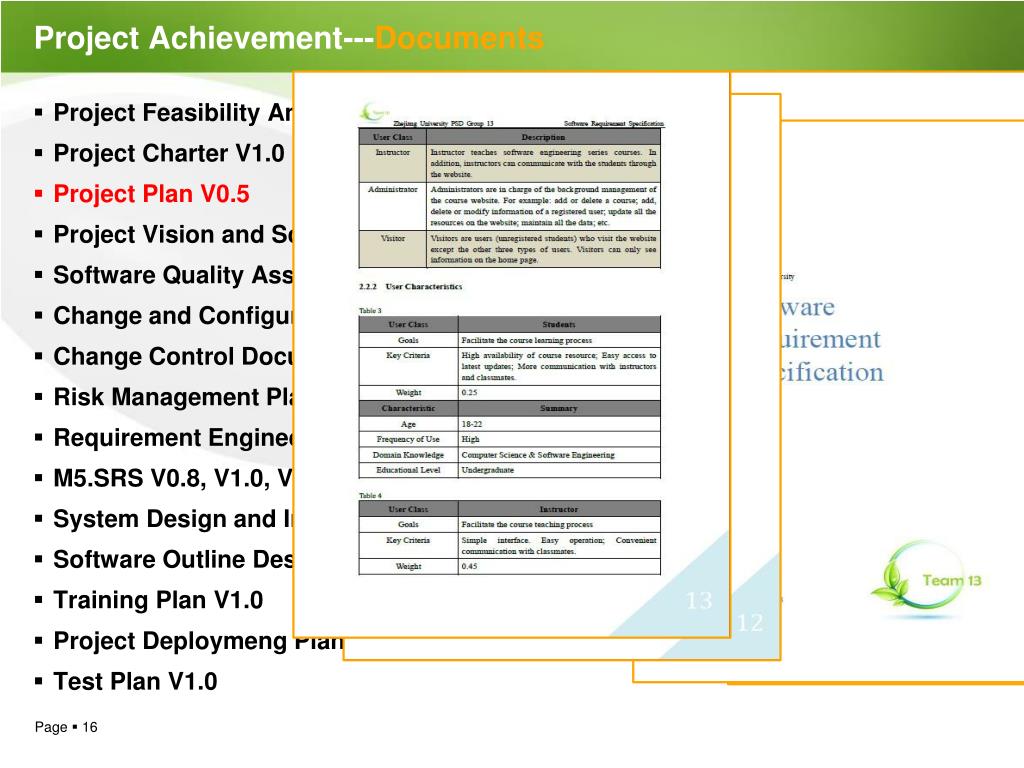

  16. Project Achievement---Documents • Project Feasibility Analysis Report V0.1 • Project Charter V1.0 • Project Plan V0.5 • Project Vision and Scope V1.0 • Software Quality Assurance Plan • Change and Configuration Management Plan • Change Control Document V1.0 • Risk Management Plan • Requirement Engineering Plan V1.0 • M5.SRS V0.8, V1.0, V1.1 • System Design and Implementation Plan V1.0 • Software Outline Design Specification V1.0 • Training Plan V1.0 • Project Deploymeng Plan V1.0 • Test Plan V1.0

  17. Project Achievement---Website Prototype

  18. Project Crisis---Problems • Some of the documents were submitted after deadline. • Some of the documents were submitted with unfinished state. • The documents were of low quality. • Every member didn’t know what he should do and what others were doing. • Some of the members were always busy while others were unoccupied. • All the members didn’t know that our project was out of schedule.

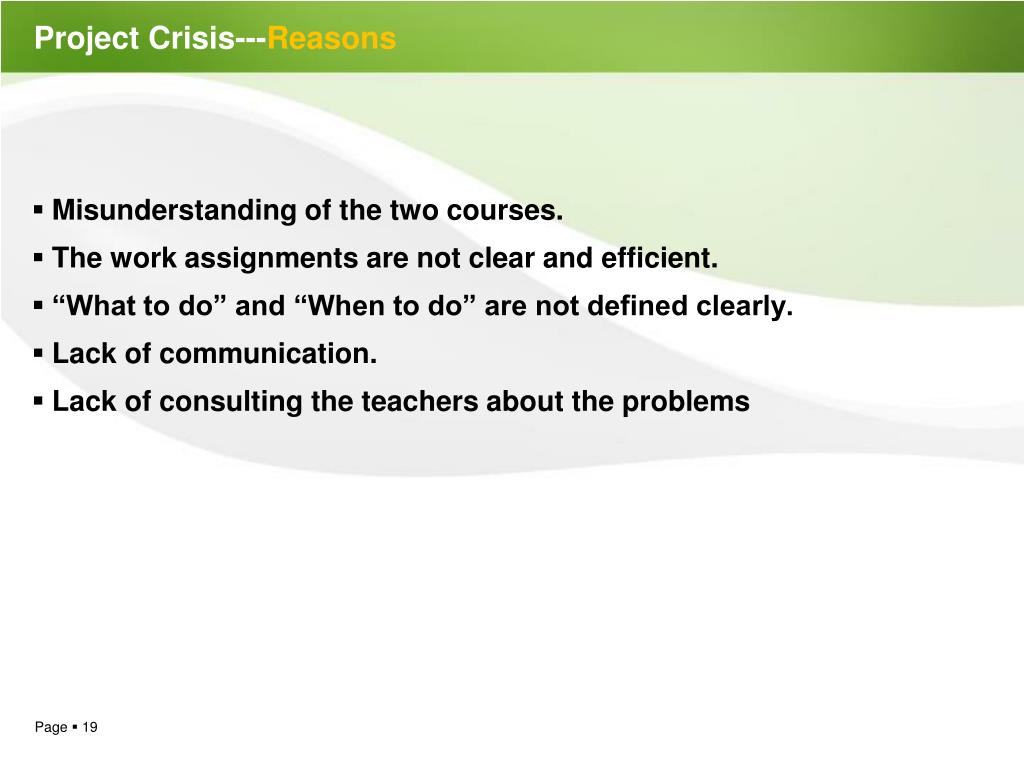

  19. Project Crisis---Reasons • Misunderstanding of the two courses. • The work assignments are not clear and efficient. • “What to do” and “When to do” are not defined clearly. • Lack of communication. • Lack of consulting the teachers about the problems

  20. Project Crisis---Solutions • Send an e-mail to the teachers to illustrate the situation • Task-responsible system • More communication

  21. Experiences

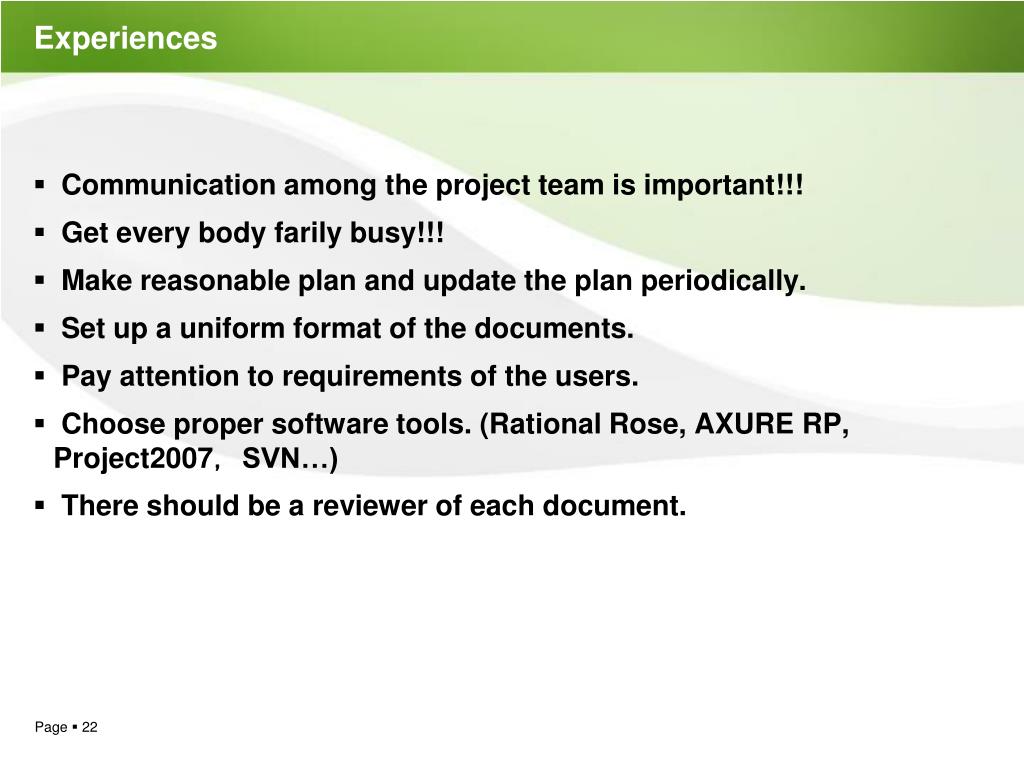

  22. Experiences • Communication among the project team is important!!! • Get every body farily busy!!! • Make reasonable plan and update the plan periodically. • Set up a uniform format of the documents. • Pay attention to requirements of the users. • Choose proper software tools. (Rational Rose, AXURE RP, Project2007,SVN…) • There should be a reviewer of each document.

  23. END Thank you!!!
