  1. The Central Project Central University – A/E/C Engineering Building ARCHITECTURE Joy Liu, Cal-Berkeley ENGINEERING Norm Faris, Stanford CONSTRUCTION Tim Kolaya, Georgia Tech OWNER Alex Barron, Stanford

  2. Site Context • Central University Engineering School • Location: • Los Angeles Metropolitan Area • Busy urban location / heavy traffic • Seismic Concerns – San Andreas Fault (8 km) • Warm Climate • High Ground Water Level

  3. Site Plan

  4. Designs & Decision Matrix New Design1: Flying Eagle 1st Fl. 2nd Fl. 3rd Fl. New Design 2: Pouring Stream 2nd Fl. 3rd Fl. 1st Fl.

  5. Architect Vision of 2015 • Awareness in Green Design for Sustainable Architecture • Better and cheaper materials ex. low-e glass Design Focus • Roof design • Poetic experience in space • Privacy measure • Green Design development

  6. Pouring Stream- 1st Floor N

  7. Pouring Stream- 2nd Floor N

  8. Pouring Stream- 3rd Floor N

  9. Evaluation

  10. Revised Roof Keep Rain out Roof Design Ceiling Fans • Average Wind Breeze between 10-15 miles per hour (direction N or W) • Average Seasonal Rain Fall 14.77 inches Air ventilation OldRoof N

  11. Sections Section B A B B Section A A

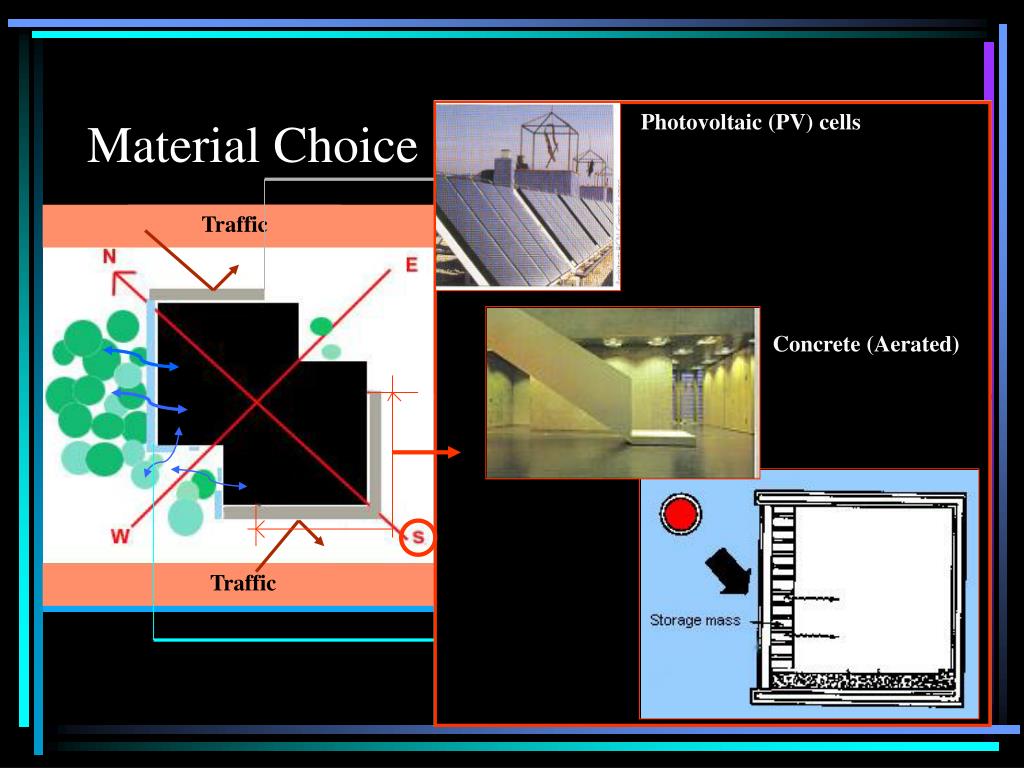

  12. Photovoltaic (PV) cells Concrete (Aerated) Material Choice Traffic Traffic

  13. 3D Model

  14. STRUCTURAL MODEL DUAL LATERAL SYSTEM: SHEARWALLS AND PERIMETER STEEL SMRF COMPOSITE GRAVITY SYSTEM: CONCRETE SLAB w/ STEEL BEAMS

  15. ANALYSIS – DESIGN & LOADING DESIGN USING UBC ’97 CRITERIA • LOADING CRITERIA • BASE SHEAR: V = 510 KIPS • NEAR SOURCE EFFECTS • DUAL SYSTEM: R = 8.5 • DL (TYPICAL) = 70PSF • DL (AUDITORIUM) = 90PSF • LL (CLASSROOM) = 50PSF • LL (CORRIDORS) = 80PSF SHEARWALL AND STEEL SMRF DESIGN: 100% BASE SHEAR TO WALLS 25% TO FRAMES (BACK-UP) DYNAMIC NONLINEAR LATERAL ANALYSIS - VERIFICATION (ETABS) - ’97 RESPONSE SPECTRA TORSIONAL EFFECTS 100% V + TORSIONAL RESISTANCE 13% V 13% V V TORSIONAL RESISTANCE GRAVITY PATH

  16. FOUNDATION MAT FOUNDATION @ UTILITY DESIGN CRITERIA: - 5 KSF BEARING • SANDY SOIL • WATER DEPTH = 15FT 8” 12” 3’-0” X 3’-0” @ MRF MRF FTGS: 7’-6” X 7’-6” GRAVITY SPREAD FTGS: 6’-0” X 6’-0” 1st FLOOR S.O.G. – 4” w/ #4 @18” O.C. AUDITORIUM S.O.G – 6” w/ #4 @ 12 O.C. 2’-6” X 6’-0” CONT. FTG. WITH 3’-6”SHEAR KEY

  17. 1ST FLOOR (ARCHITECTURAL CONTEXT) RESTROOMS AND ‘WET WALL’ LAB & LARGE CLASSROOM AUDITORIUM w/ PRECAST RISERS JOINING 2ND FLOOR. SMRF COLUMNS: W14 X 61 SMRF BEAMS: W21 X 62 SMALL CLASSROOMS SHEARWALLS: 8” W/ BOUNDARY ZONES TYPICAL GRAVITY COLUMN: W8X31

  18. 2ND FLOOR (ARCHITECTURAL CONTEXT) RESTROOMS AND ‘WET WALL’ LABS SMRF BEAMS: W18 X 60 STUDENT OFFICES SEMINAR COMPUTER ROOM

  19. 3RD FLOOR (ARCHITECTURAL CONTEXT) RESTROOMS AND ‘WET WALL’ LONG SPAN PRE-FAB TRUSSES LOUNGE TS 6X6 FACULITY OFFICES ATRIUM CHAIR OFFICE

  20. EXTERIOR CANTILEVER STAIR DESIGN STIFFENER PLATES IN COLUMN – TYPICAL. EMBEDDED PLATE W/ SHEAR STUDS AND DOWEL ANCHORS INTO WALL W14 WELD TS10X6 TO COLUMN FLANGE WELD TS10 X 6 TO EMBEDDED PLATE 2” SLAB ON 3” DECK OVER C6X13, STUD WELDED TS 10 X 6 CANTILEVER C10 BEAM w/ BENT RISERS FILLED w/ 2” CONCRETE 6’ X 8’ LANDING

  21. E – DESIGN TO BE INTEGRAL WITH MAIN STRUCTURE. C – DIFFICULTY IN ERECTION AND STABILITY DURING CONSTRUCTION. A – STAIRS TO HAVE CLADDING. E – DESIGN. E – MENTOR ADVISE TO SEPARATE STAIR FROM MAIN SYSTEM. C – COST AND ERECTION PROCEDURES – POSSIBLE IMPLICATIONS. A – HEADROOM CONSTRAINTS. C – COST. A – ISSUES w/ CLADDING. CENTRAL TEAM – ITERATIONSA-E-C EXTERIOR STAIR SYSTEM A E A – STAIRS THAT PROVIDE EXPRESSION TO THE STRUCTURE. C

  22. ATRIUM – CONSTRAINTS AND DESIGN (4) #5 IN ADDITION TO #4 BARS TO ATTAIN RIGID DIAPHRAGM ACTION. TYPICAL BEAMS – W10 X 26 IN COMPOSITE ACTION. 3/8” BENT PLATE w/ ½” D.B.A. @ 18” O.C., WELD PLATE TO CENTER BEAM 12” CL BEAM TO EDGE (3) #5 CENTERED OVER BEAM IN SLAB. SLAB EDGE DETAIL 20’ X 44’ OPENING W14 BOLTED TO PLATE AT TOP OF COLUMN. CAN TILEVER W14

  23. Adjusted Budget - $3,500,000 Initial Estimate - $3,200,000 Final Project Cost - $3,378,000 Budget & Cost

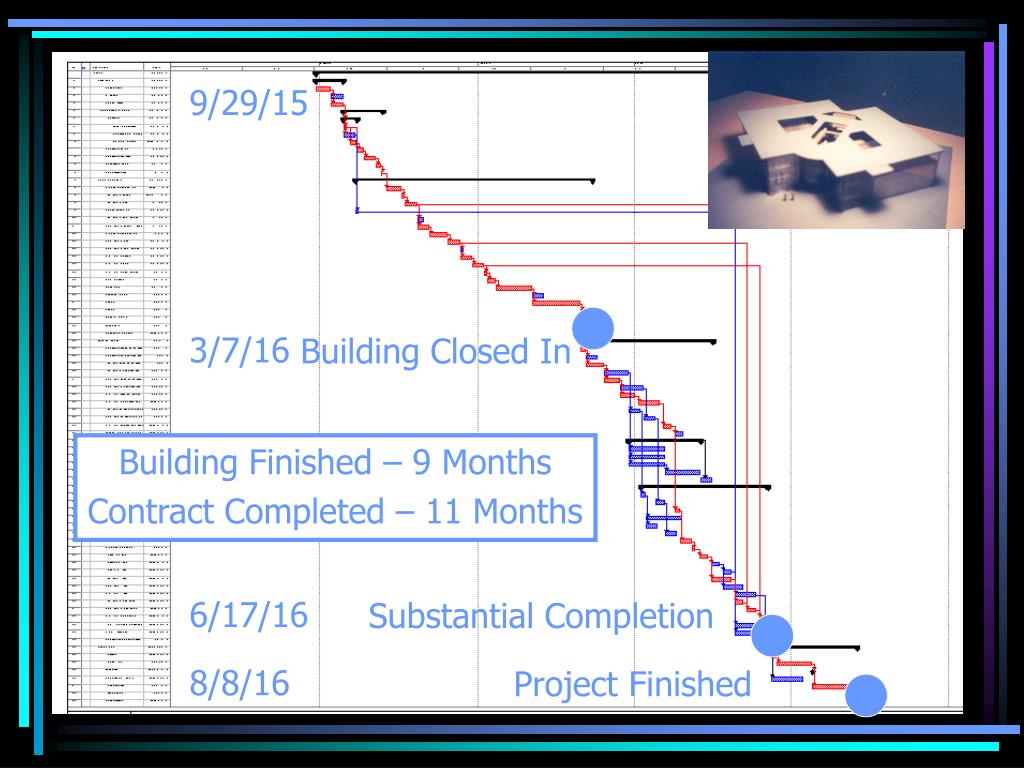

  24. 9/29/15 3/7/16 Building Closed In 6/17/16 Substantial Completion 8/8/16 Project Finished Construction Schedule Building Finished – 9 Months Contract Completed – 11 Months

  25. Construction Sequencing

  26. Equipment Selection • 150 Ton Crawler • Hydraulic Hammer • Backhoe Loader / Front-end Loader • Welding Machines • Hydraulic Excavator • Cement Mixers / Dump Trucks / various others…

  27. DEMANDS: • COOLING CAPACITY - 90 TONS • AIR VOLUME – 35,000 CFM • MAIN AIR DUCTS – 20 FT2 • FRESH AIR LOUVERS – 80 FT2 • EXHAUST AIR LOUVERS – 70 FT2 MEP SCHEMATIC (BACK) VERTICAL DISTRIBUTION THRU ‘WET WALLS’ 8’ X 8’ HYDRAULIC ELEVATOR w/ 6’ MECHANICAL PIT FOR SERVICE. 2ND & 3RD DISTRIBUTION THRU LONG SPAN TRUSSES. 3RD FLOOR DISTRIBUTION 2ND FLOOR DISTRIBUTION 1ST FLOOR DISTRIBUTION MAIN UNITS BELOW AUDITORIUM RISERS UTILITY BASEMENT – PUMPS, MAIN SERVICES, COMMUNICATION, ELEVATOR MOTOR, OUTFLOW.

  28. E – DESIGN OF SPACE TO ENSURE ALL MACHINARY WILL FIT. A – UTILIZE SPACE BELOW RISERS IN AUDITORIUM. A – ISSUES WITH SOUND – USE OF INSULATION AND SOUND PROOFING. E – FRESH AIR AND EXHAUST LOUVERS – LESS IMPLICATION ON STRUCTURE. C – EASY REPLACEMENT/AXCESS - FIRE SYSTEMS EASILY INTEGRATED. C – COST OF SOUND PROOFING MATERIAL VS. EXCAVATION. E – MINIMIZE PENETRATION IN BEAMS AND SHEARWALLS. C – INPUT ON COST FOR BEAM PENETRATIONS AND WALL BLOCK-OUTS. A – PLACE DUCTS PERPENDICULAR TO BEAMS ALONG WALLS AND THOSE PARALLEL TO BEAMS BETWEEN THE SPANS.. CENTRAL TEAM – ITERATIONSA-E-C MEP SYSTEMS – LOCATION & DISTRIBUTION INITIALLY LOCATE ALL SYSTEMS IN BASEMENT. C – LARGE COSTS FOR EXCAVATION – DIFFICULT AXCESS. DISTRIBUTION OF VERTICAL AND HORIZONTAL DUCTS TO ROOMS VERSUS HEADROOM . A – MAXIMIZE HEADROOM – REDUCED RESTROOM SIZE AND PROVIDED ‘WET WALLS’

  29. CENTRAL TEAM - INTERACTION • MSN MESSENGER • GROUP MEETINGS • ‘QUICK QUESTIONS’ • ‘INSTANT’ • PBL DISCUSSION FORUM • DOCUMENT / STORE • SET – UP MEETINGS • POST QUESTIONS • NETMEETING • SHARING PROGRAMS • A & E COMMUNICATION

  30. CENTRAL TEAM - PROCESS • A – INITIATED MAIN DESIGN CONCEPTS – VERY EFFECTIVE IN COMMUNICATING CHANGES AND IDEAS. • E – DEVELOPED MOST QUESTIONS & ISSUES IN THE DESIGNS. • C – PROVIDED DIRECTION IN MEETINGS & ON STEPS TO TAKE. • A – ABILITY TO CONCEPTUALIZE ‘E & C’ REQUIREMENTS. • E – ATTEMPT TO MAINTAIN ARCHITECTURAL CONCEPT IN STRUCTURAL LAYOUT & EFFECTIVELY MINIMIZE COST AND ERECTION DIFFICULTIES. • C – CONSISTENTLY EXPRESSED SCHEDULE & COST IMPLICATIONS FOR ALL ITERATIONS AND PHASES OF DESIGN.

  31. CENTRAL TEAM – WHAT WE LEARNED? • E • BETTER UNDERSTANDING OF THE REQUIREMENTS OF BOTH THE ARCHITECT AND CONSTRUCTION MANAGER. • ACCOMPLISHED GOAL OF BEING ABLE TO GET INVOLVED WITH THE ARCHITECT EARLY IN THE DESIGN PHASE. • MORE EFFICIENT IN THE USE OF TECHNOLOGOICAL TOOLS AS A MEANS OF COMMUNICATION. • C • BETTER INVOLVEMENT WITH THE ARCHITECT AND ENGINEER ON THE FRONT-END OF THE PROJECT DESIGN AND DEVELOPMENT PROCESS. • MORE CONSISTENT NOTIFICATION OF TEAM MEMBERS OF PROGRESS ON THE PROJECT AND NEEDS FROM OTHERS. • TECHNOLOGY CAN BE A HUGE BARRIER IF YOU FAIL TO TAKE ADVANTAGE OF IT AND A TREMENDOUS AIDE IF YOU MAKE EFFECTIVE USE OF IT! • A • BETTER UNDERSTANDING ABOUT ENGINEER AND CONSTRUCTION MANAGER’S CONSTRAINT AND ABLE TO INTEGRATE INTO THE DESIGN PROCESS • MORE FREQUENT NOTIFICATION TO THE TEAM MEMBERS ABOUT THE PROCESS AND QUESTIONS.

  32. CENTRAL TEAMTHANK YOU • WE WOULD LIKE TO EXTEND OUR GREATEST APPRECIATION TO THE FOLLOWING PEOPLE: • MR. GREG LUTH – KL&A • BROOK BARRET - DPR • PAUL CHINOWSKY – GEORGIA TECH. • PROF. MIKE MARTIN –BERKELEY • HUMBERTO CAVALLI- BERKEELY • DAVID BENDET-MBT • PROF. BOB TATUM - STANFORD • PROF. HELMUT KRAWINKLER - STANFORD • RENATE FRUCHTER • …. AND OF COURSE FELLOW STUDENTS.

  33. The Central Project QUESTIONS?

  34. CENTRAL TEAM – WHAT WE LEARNED? • E • BETTER UNDERSTANDING OF THE REQUIREMENTS OF BOTH THE ARCHITECT AND CONSTRUCTION MANAGER. • ACCOMPLISHED GOAL OF BEING ABLE TO GET INVOLVED WITH THE ARCHITECT EARLY IN THE DESIGN PHASE. • MORE EFFICIENT IN THE USE OF TECHNOLOGOICAL TOOLS AS A MEANS OF COMMUNICATION.

  35. CENTRAL TEAM – WHAT WE LEARNED? • C • BETTER INVOLVEMENT WITH THE ARCHITECT AND ENGINEER ON THE FRONT-END OF THE PROJECT DESIGN AND DEVELOPMENT PROCESS. • MORE CONSISTENT NOTIFICATION OF TEAM MEMBERS OF PROGRESS ON THE PROJECT AND NEEDS FROM OTHERS. • TECHNOLOGY CAN BE A HUGE BARRIER IF YOU FAIL TO TAKE ADVANTAGE OF IT AND A TREMENDOUS AIDE IF YOU MAKE EFFECTIVE USE OF IT!
