Bangladesh Progress of Flood Reconstruction Programmes. Presented by Ahmadul Hassan Division Head, R & D and Training/ Water Resources Planner E-mail: ahassan@cegisbd.com. Center for Environmental and Geographic Information Services (CEGIS) Dhaka, Bangladesh. Geographical Context.
E N D
Bangladesh Progress of Flood Reconstruction Programmes Presented by Ahmadul Hassan Division Head, R & D and Training/ Water Resources Planner E-mail: ahassan@cegisbd.com Center for Environmental and Geographic Information Services (CEGIS) Dhaka, Bangladesh
Geographical Context • Climate: • Pre-monsoon : March –May • Monsoon: June – September • Pos-monsoon: October - November • Dry season: December – February • Average Annual Rainfall: 2200-2500 mm • Average temperature : 25 – 35 oc (falls below 10 oc in winter) • Topography: • Largest delta in the world • 80% area is the floodplains of three major rivers (Ganges, Brahmaputra and Meghna) • Hilly area is 12 % and terrace area is 8% • Land elevation varies from –3 to 90 m MSL • More than 50% of the flood plain within 5 m MSL
Floods in Bangladesh Types : • Flash flood: • Rainfed flood • River flood • Flood due to storm surges Flood Classification and Probability of Occurrence

Floods in Bangladesh • More frequent extreme flood • Higher economic loss • More macro and micro infrastructure damage
Flood Measures Goal: Poverty reduction Objectives: Food security- more cereal productions, culture fisheries and reduce damages Safety – protect micro and macro investments Structural Measures: - Three types: Flood Control, Drainage and Irrigation - From 1960, about 684 numbers of large, medium and small flood control projects. - Protects 5.9 million ha out of 8 million ha flood vulnerable area - Total investment about US$ 4 billion Non- Structural Measures: - Flood zoning – difficult to implement - Flood Insurance – Currently initiated by NGOs and GOs - Early warning – FFWC forecast with 3 days lead time and planning to increase upto 10 days lead time for more preparedness at all levels Implementing Agency Medium to large : BWDB, Ministry of Water Resources Small: LGED, Ministry of Local Government Implementing Agency Early Warning : FFWC/ BWDB
Flood 2004 Causes - Flash flood (April): 70% excess rainfall in Northeastern region and 33% excess rainfall in Southeastern region. Sylhet, Sunamganj and Chittagang areas are affected - Flood due to storm surge (May 17-19): Chittagang coastal area is affected - River flood (July): Brahmaputra and Meghna basins received 30 %and 42% excess rainfall. River stage of Meghna at Chandpur remained 1.1 m high from danger level for 45 days. 38% area (39 districts) was very severely flooded. - Rainfed flooding (September 12 – 17): Unexpected torrential rain flooded 12 districts Figure: FFWC Model generated flood inundation map
Flood Damage in 2004 • Damages of Flood Control Structures • BWDB’s Initial Assessment: 6.08 billion Taka • BWDB’s assessment by Consultants: 7.8 billion Taka (US$
Flood Reconstruction Programmes Flood Damage CategoryI Flood protection embankments/ road II Irrigation canals / Drainage channels III Structures ( Water regulators, sluice, irrigation inlets, etc. IV River training / town protection works V Others (Guard shed, pump house, etc.) Flood Damage Priority
Emergency Reconstruction Programmes for Flood 2004 Total No. of Projects: 201 ABD funded: 185 GOB funded: 16 ADB financed project: Emergency Flood Damage Rehabilitation Project (component D) ABD and GOB provides 42. 8 m USD Project Duration: 3 years Short Term and Mid Term programmes are waiting for fund
Non-structural Measures Early Warning Implementing Agency: FFWC Coverage: 60% of river floodplain (52 locations) Lead Time: 72 houres Produce: Flood buletine and warning message Dissemination media: website, fax, mobile Plan: - Increase lead time upto 10 days - Extent coverage area upto village - Package EW more usefull and response oriented ADB considering this project called ‘Strengthening EWS in Bangladesh

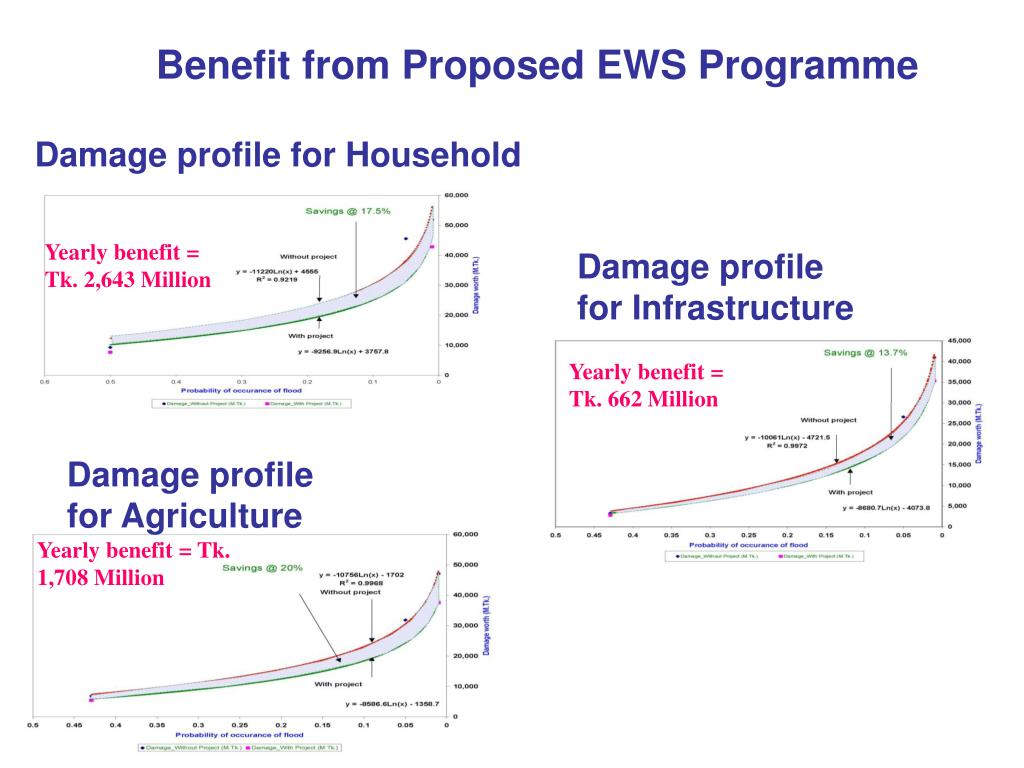

Benefit from Proposed EWS Programme Damage profile for Household Yearly benefit = Tk. 2,643 Million Damage profile for Infrastructure Yearly benefit = Tk. 662 Million Damage profile for Agriculture Yearly benefit = Tk. 1,708 Million
Conclusion • Protective structure not well maintained due to lack of O & M fund. 2.5 % normally allocated but reality 1- 1.5 % really used for maintenance. • Flood control embankments, if not maintained beyond 5-10 years, become vulnerable to extreme floods • Beneficiaries are not made responsible for maintaining and managing the structures. • No well accepted Damage Assessment Procedure in place • EW messages are not fully utilized by infrastructure managers • In addition to maintaining existing flood control measures, EWS can be utilize to reduce damage as well as O & M cost
Recommendations • Increase O & M fund. • Protective structure should be regularly maintained and regular inspection should carried out to ensure regular maintenance • Small flood management project should be managed by the stakeholders. • Medium and Large flood management projects should be managed by both BWDB and stakeholders. • End-to-End EWS with sufficient lead time should be taken up by the government.
