  1. A&D High Tech Project Team 2: Yusuf Akkoca Tom Bloom Karen DeltonShweta Hire Eric Johnson David Mahzonni

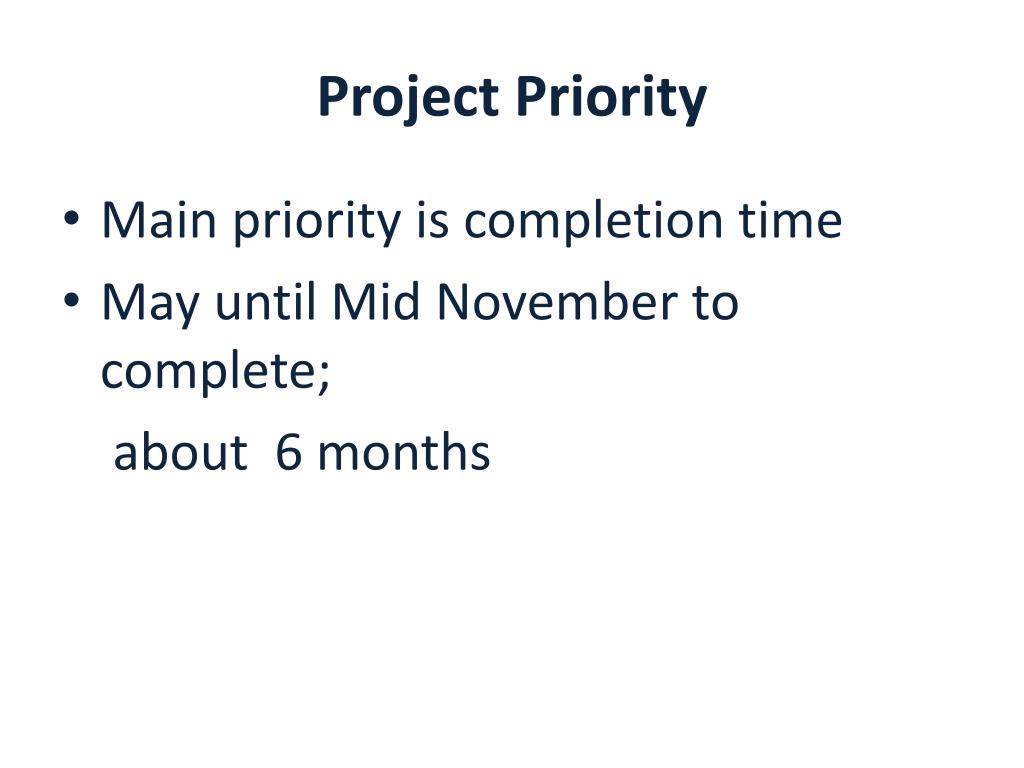

  2. Project Priority • Main priority is completion time • May until Mid November to complete; about 6 months

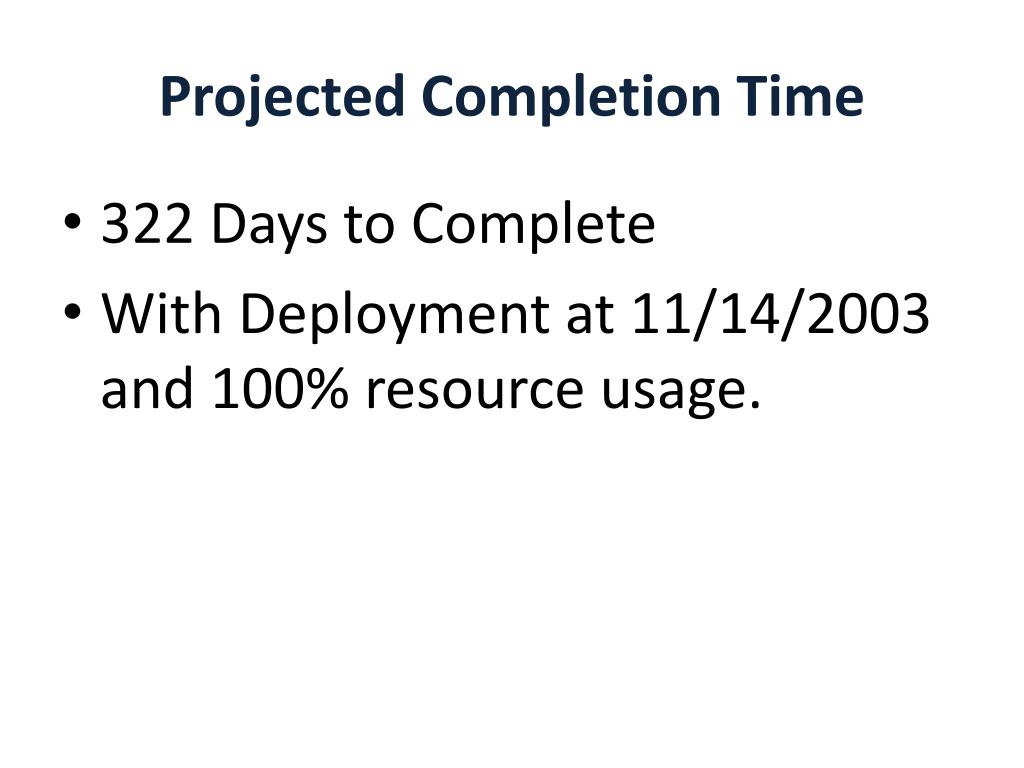

  3. Projected Completion Time • 322 Days to Complete • With Deployment at 11/14/2003 and 100% resource usage.

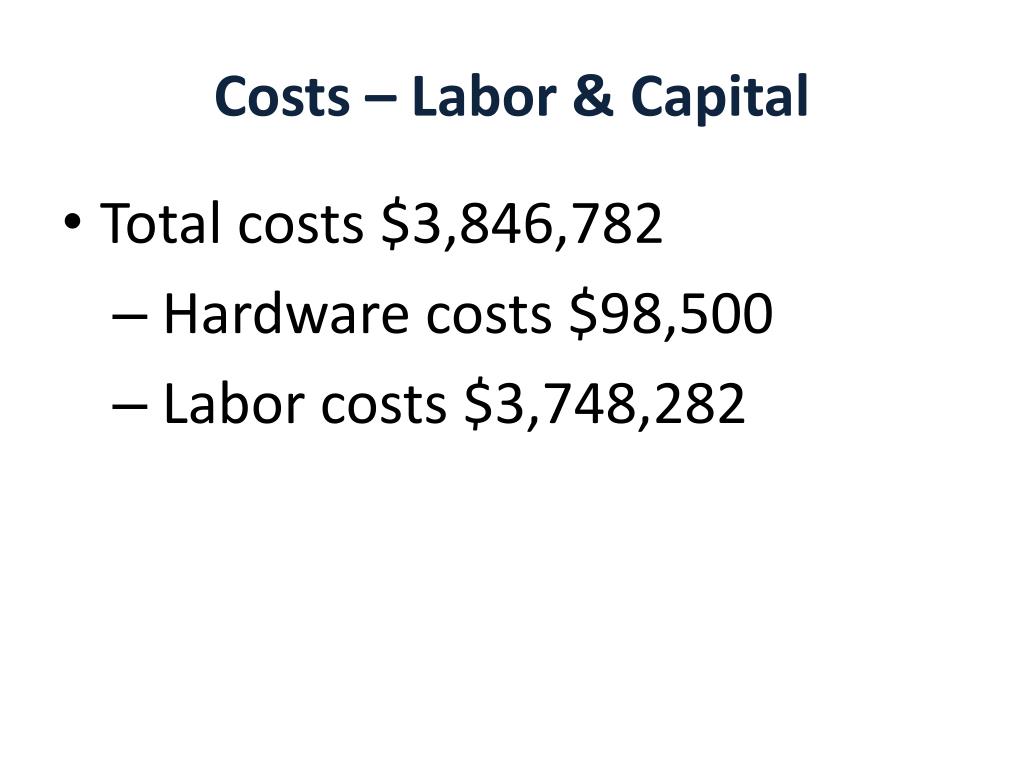

  4. Costs – Labor & Capital • Total costs $3,846,782 • Hardware costs $98,500 • Labor costs $3,748,282

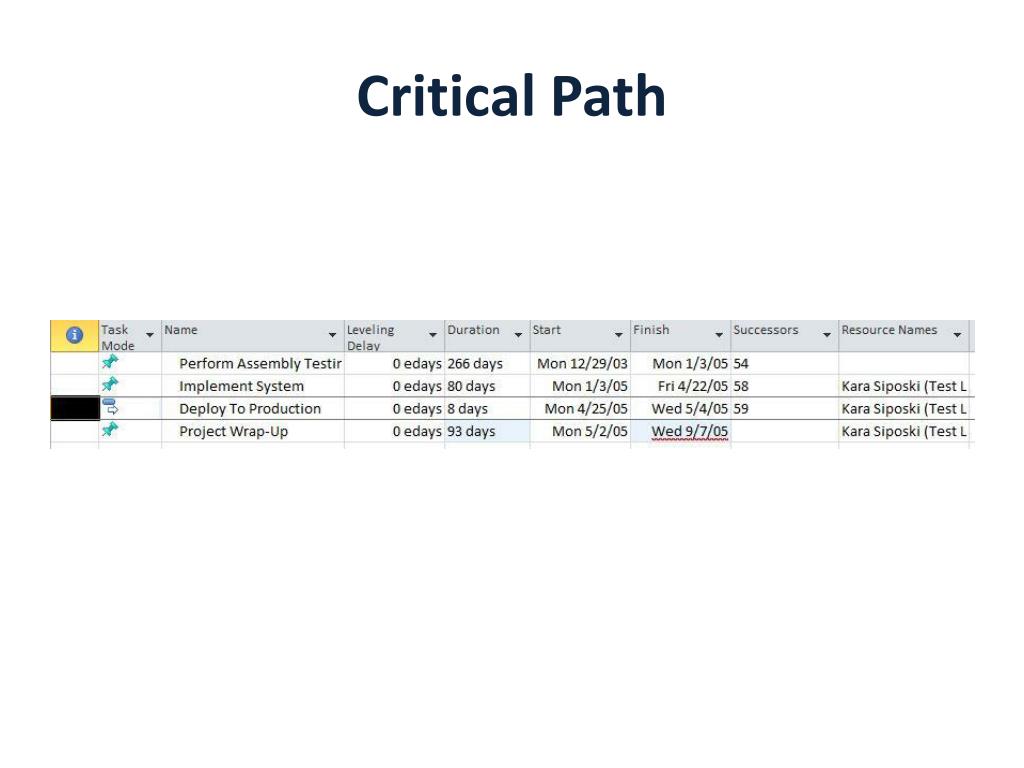

  5. Critical Path

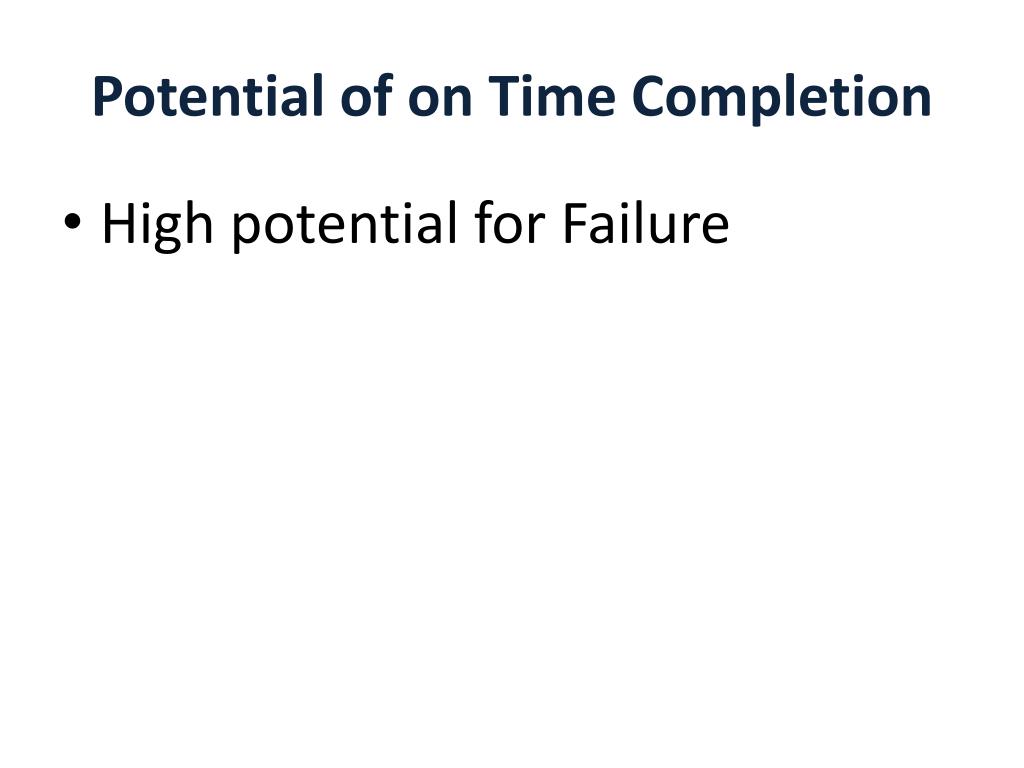

  6. Potential of on Time Completion • High potential for Failure

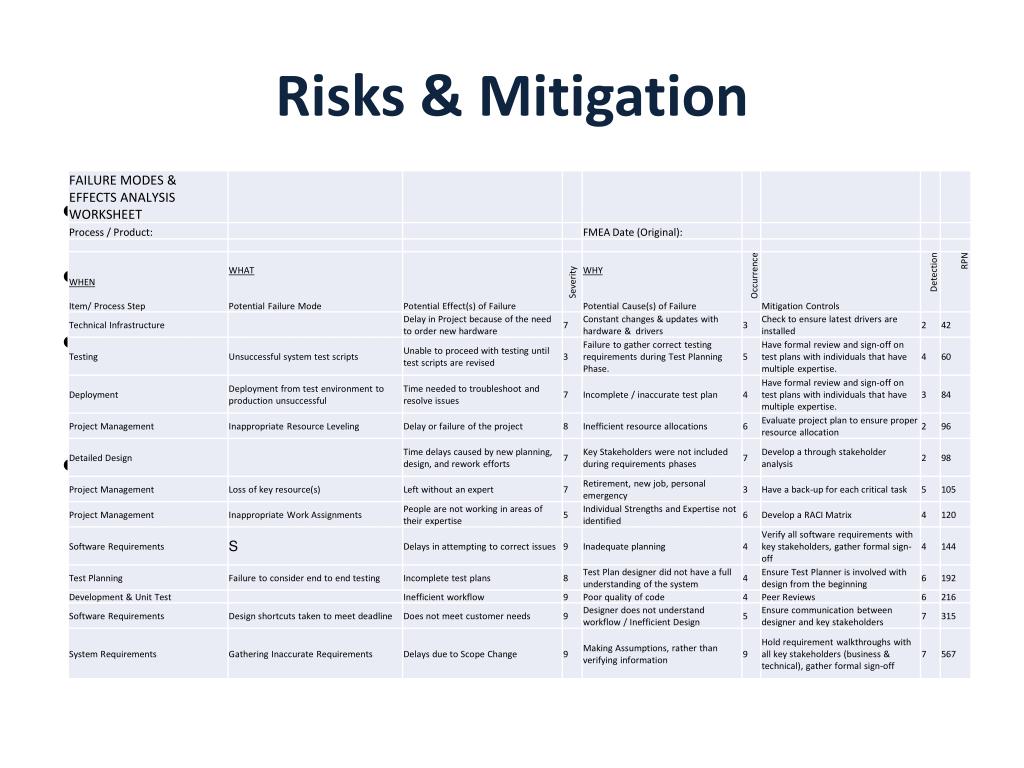

  7. Risks & Mitigation • Hardware Compatibility Issues • Software Compatibility Issues – ERP • Availability of Resources • Scope Creep & Last Minute Changes • Enforce a strict change control process

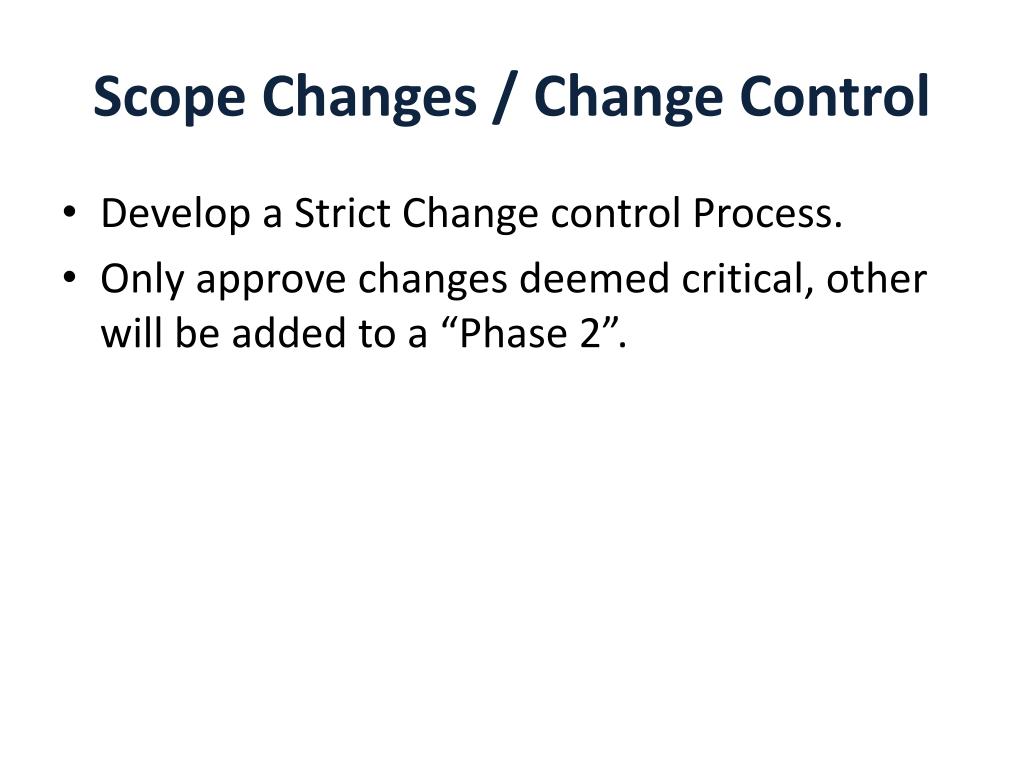

  8. Scope Changes / Change Control • Develop a Strict Change control Process. • Only approve changes deemed critical, other will be added to a “Phase 2”.

  9. Thank you!
