Integrating Smart Grid Systems: Co-Simulation of Power and Communication Networks
700 likes | 821 Views
This work explores the critical interdependencies between power systems and communication technologies within the framework of the Smart Grid. It emphasizes the necessity of co-simulation to effectively model and predict behaviors of this complex cyber-physical system. The study addresses the infrastructure interdependencies that can cause cascading failures, underlines the need for robust communication techniques, and introduces GECO, a co-simulation platform. Supported by NSF grants, the findings aim to enhance resilience and security in smart grid operations.
Integrating Smart Grid Systems: Co-Simulation of Power and Communication Networks
E N D
Presentation Transcript
Smart Grid: Where Computation, Communication and Power Systems Meet Sandeep K. Shukla shukla@vt.edu with Hua Lin, Yi Deng, James Thorp, LamineMili This work was partially supported by NSF grant EFRI-0835879 & an NSF IUCRC - S2ERC Project http://www.hume.ictas.vt.edu
About ACM ACM, the Association for Computing Machinery is the world’s largest educational and scientific computing society, uniting educators, researchers and professionals to inspire dialogue, share resources and address the field’s challenges. ACM strengthens the computing profession’s collective voice through strong leadership, promotion of the highest standards, and recognition of technical excellence. ACM supports the professional growth of its members by providing opportunities for life-long learning, career development, and professional networking. With over 100,000 members from over 100 countries, ACM works to advance computing as a science and a profession. www.acm.org
The Distinguished Speakers Program is made possible by For additional information, please visit http://dsp.acm.org/

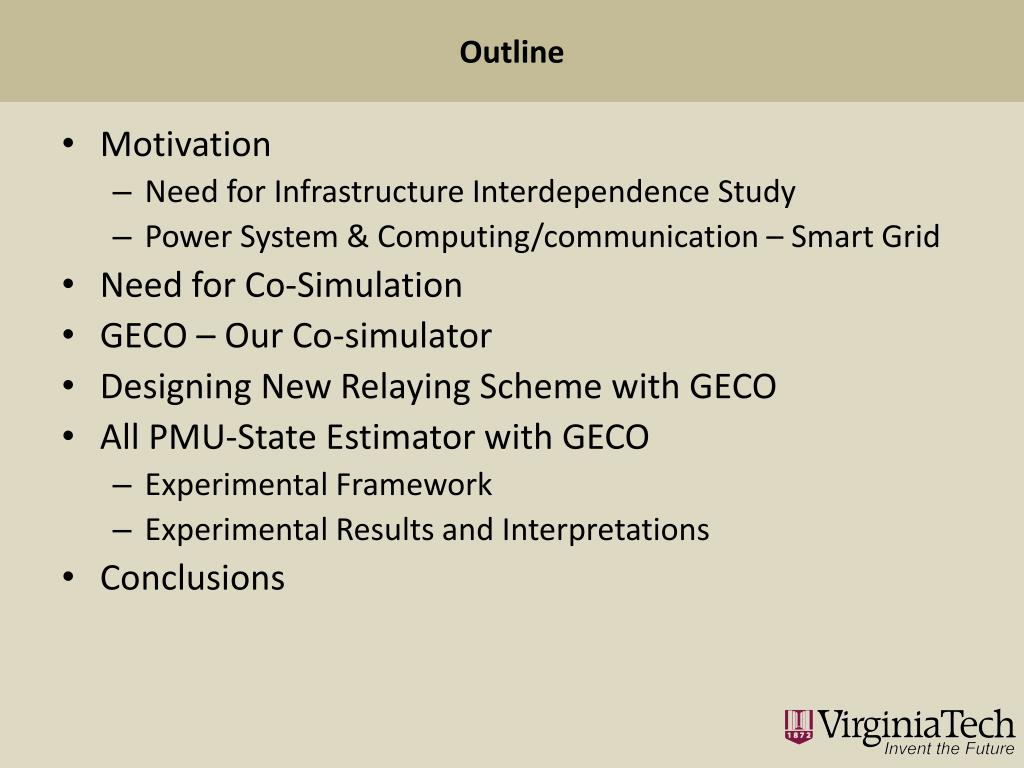

Outline • Motivation • Need for Infrastructure Interdependence Study • Power System & Computing/communication – Smart Grid • Need for Co-Simulation • GECO – Our Co-simulator • Designing New Relaying Scheme with GECO • All PMU-State Estimator with GECO • Experimental Framework • Experimental Results and Interpretations • Conclusions

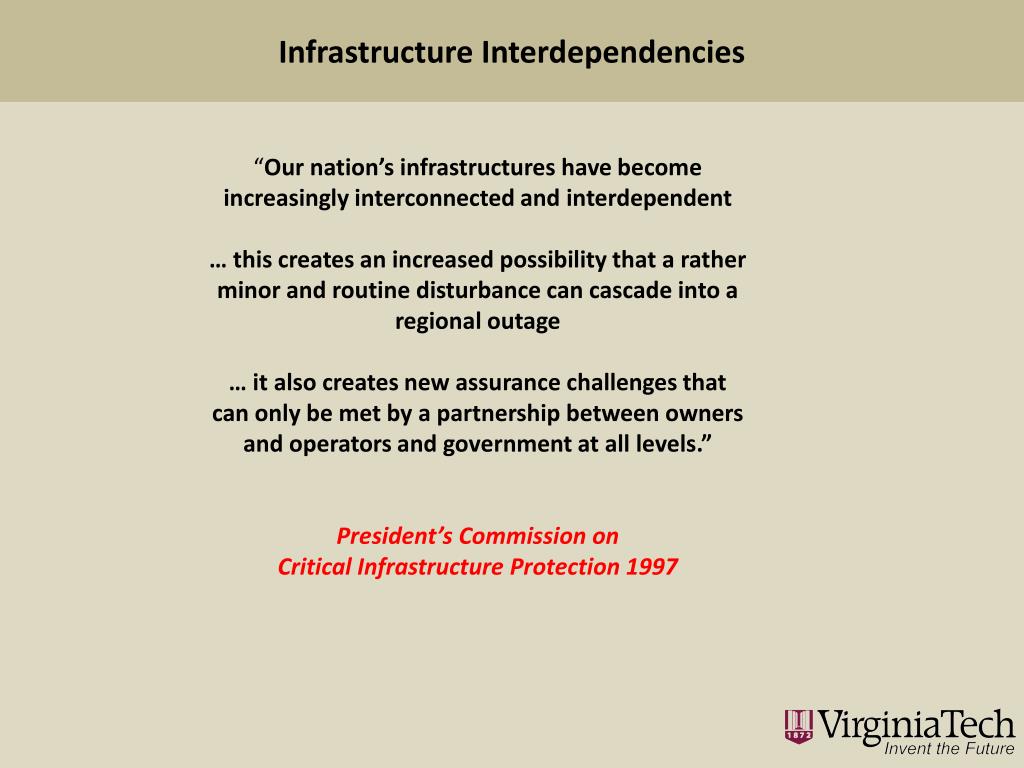

Infrastructure Interdependencies “Our nation’s infrastructures have become increasingly interconnected and interdependent … this creates an increased possibility that a rather minor and routine disturbance can cascade into a regional outage … it also creates new assurance challenges that can only be met by a partnership between owners and operators and government at all levels.” President’s Commission on Critical Infrastructure Protection 1997

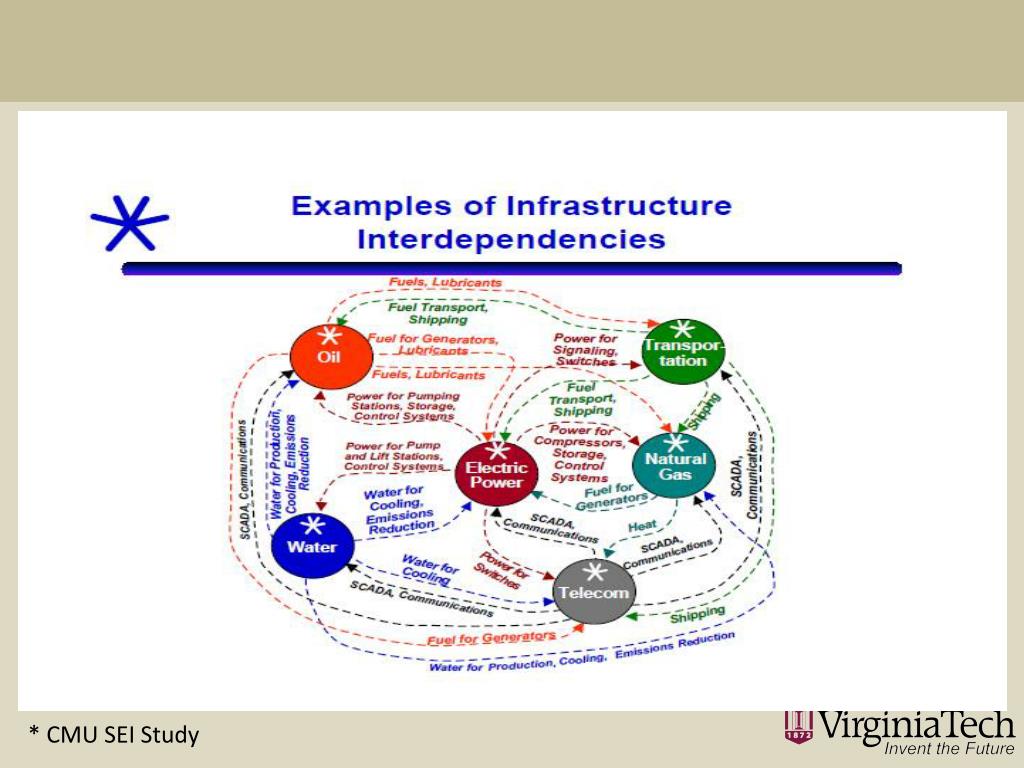

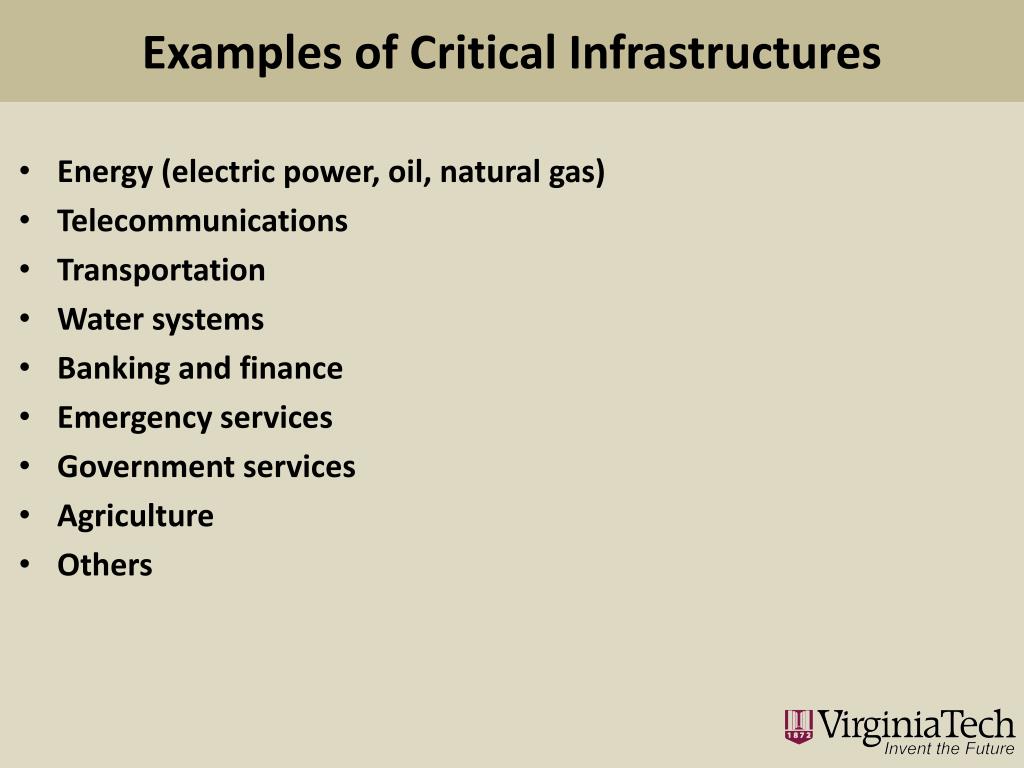

Examples of Critical Infrastructures • Energy (electric power, oil, natural gas) • Telecommunications • Transportation • Water systems • Banking and finance • Emergency services • Government services • Agriculture • Others
Generation renewable coal natural gas nuclear

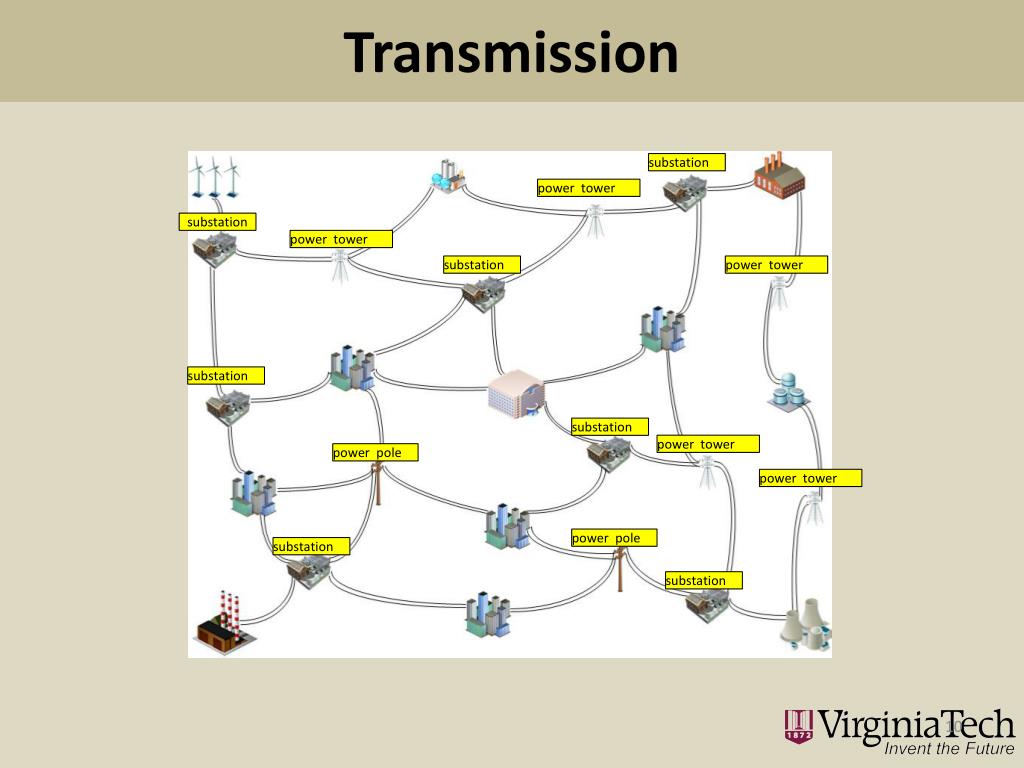

Transmission substation power tower substation power tower substation power tower substation substation power tower power pole power tower power pole substation substation

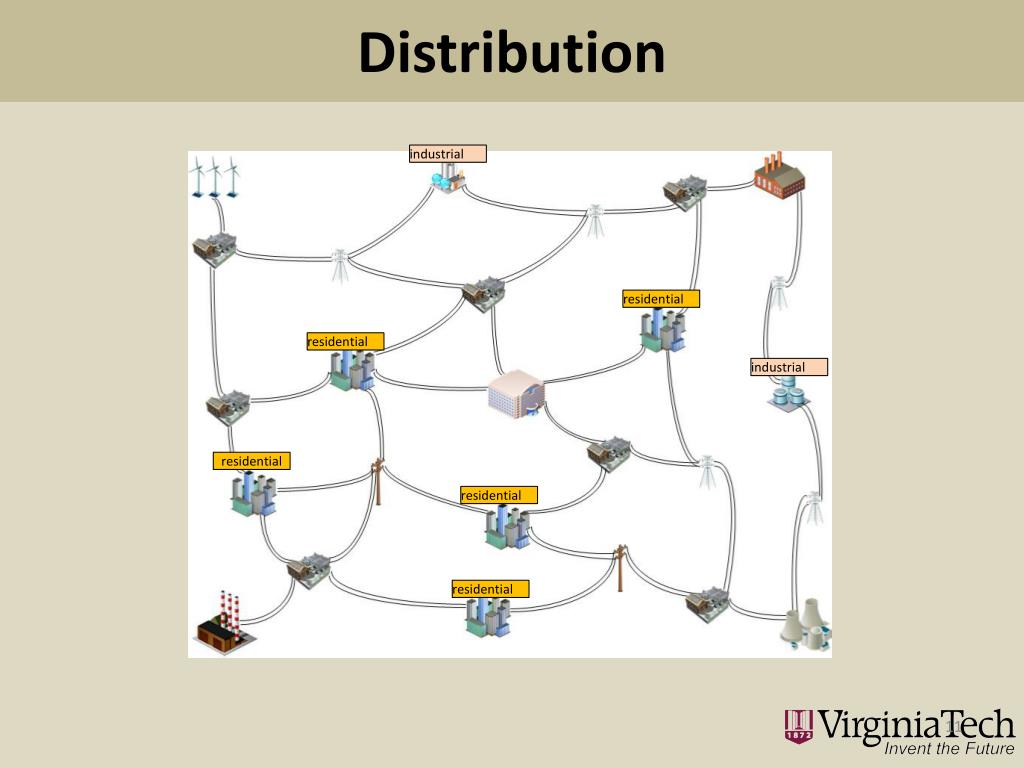

Distribution industrial residential residential industrial residential residential residential

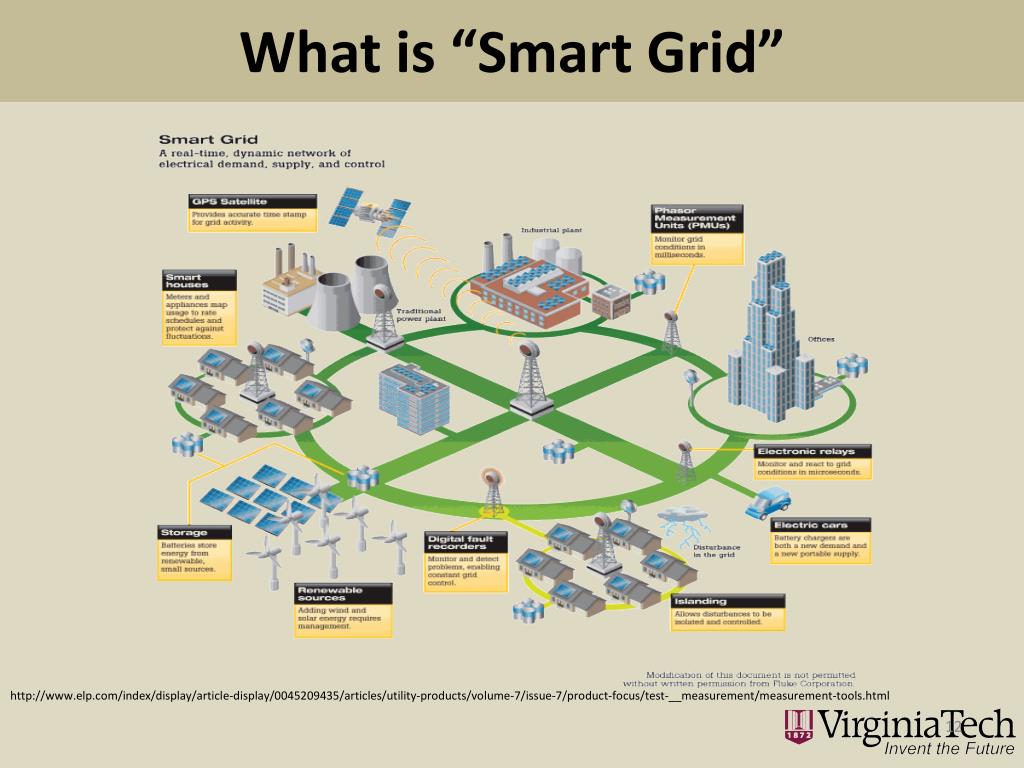

What is “Smart Grid” http://www.elp.com/index/display/article-display/0045209435/articles/utility-products/volume-7/issue-7/product-focus/test-__measurement/measurement-tools.html

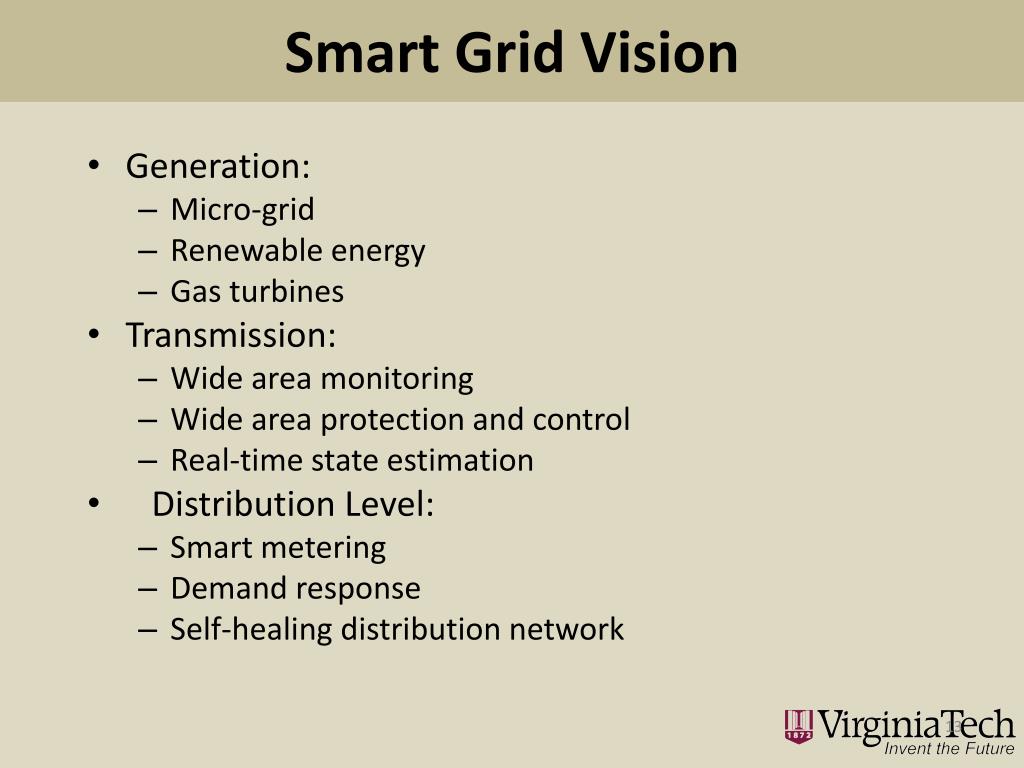

Smart Grid Vision • Generation: • Micro-grid • Renewable energy • Gas turbines • Transmission: • Wide area monitoring • Wide area protection and control • Real-time state estimation • Distribution Level: • Smart metering • Demand response • Self-healing distribution network
Communication Techniques • Communication Link • Telephone • Microwave • Co-axial • Fiber • Power line communication • Communication Network • LAN • WAN • MAN • WLAN
A Wide Area Measurement Scenario Control Center

Motivation • Smarter Grid entails more Cyber components • Wide area measurement and Control • Communication Infrastructure • New Cyber Security Vulnerabilities • Smart Grid is a Extremely Large Scale Cyber Physical System • ELCPS • Physical Dynamics controlled by Cyber Networked Control • Attack on the networked control can lead to disastrous Physical Dynamics • Need to Study ELCPS • Too large for Analytical Study • Scalable but Accurate Co-Simulation is needed • Need for co-simulation tools • Leveraging Existing Scalable Tools • Study Wide Area Control issues but Security is Extremely Important to Study

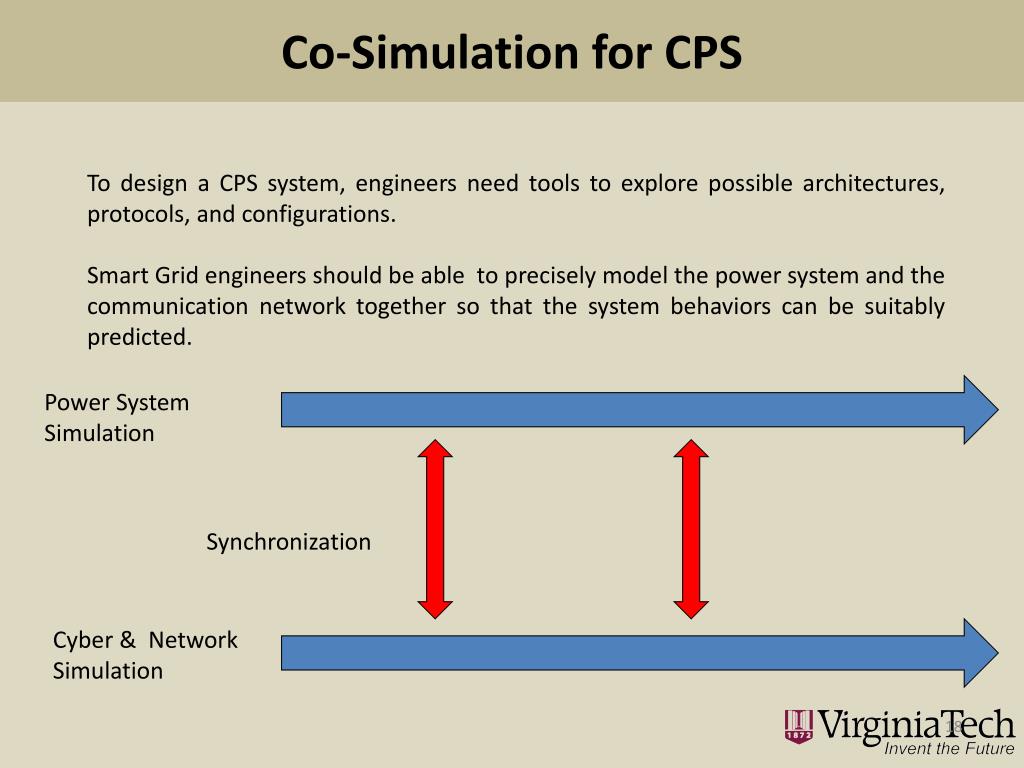

Co-Simulation for CPS To design a CPS system, engineers need tools to explore possible architectures, protocols, and configurations. Smart Grid engineers should be able to precisely model the power system and the communication network together so that the system behaviors can be suitably predicted. Power System Simulation Synchronization Cyber & Network Simulation

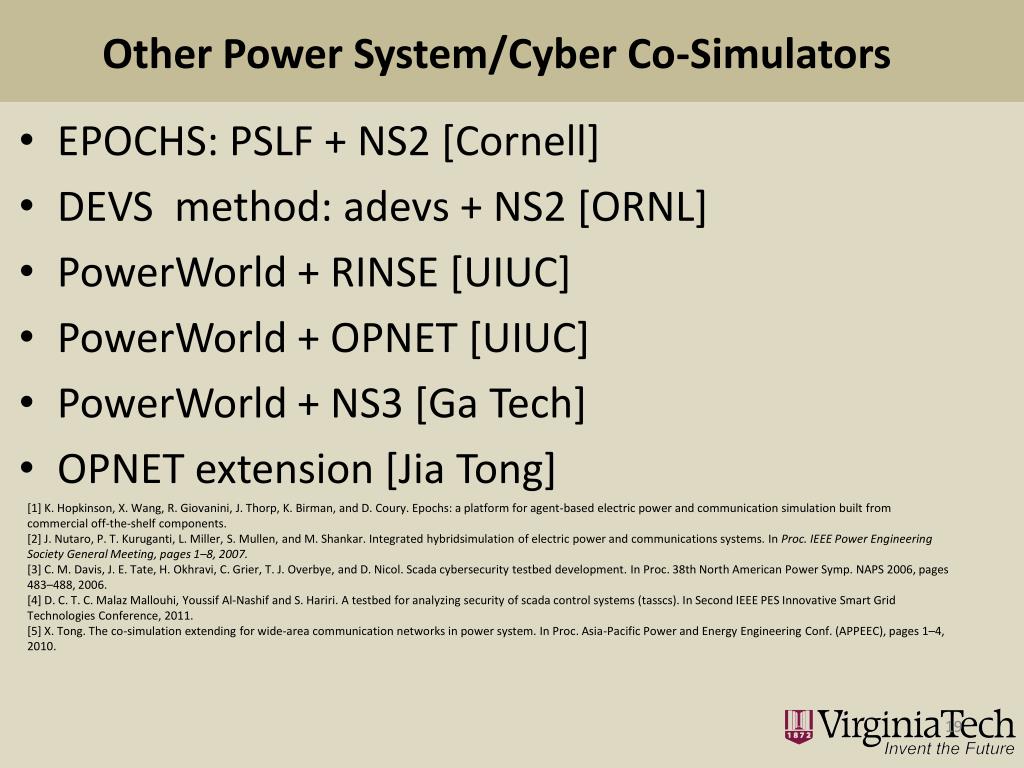

Other Power System/Cyber Co-Simulators • EPOCHS: PSLF + NS2 [Cornell] • DEVS method: adevs + NS2 [ORNL] • PowerWorld + RINSE [UIUC] • PowerWorld + OPNET [UIUC] • PowerWorld + NS3 [Ga Tech] • OPNET extension [JiaTong] [1] K. Hopkinson, X. Wang, R. Giovanini, J. Thorp, K. Birman, and D. Coury. Epochs: a platform for agent-based electric power and communication simulation built from commercial off-the-shelf components. [2] J. Nutaro, P. T. Kuruganti, L. Miller, S. Mullen, and M. Shankar. Integrated hybridsimulation of electric power and communications systems. In Proc. IEEE Power Engineering Society General Meeting, pages 1–8, 2007. [3] C. M. Davis, J. E. Tate, H. Okhravi, C. Grier, T. J. Overbye, and D. Nicol. Scadacybersecuritytestbed development. In Proc. 38th North American Power Symp. NAPS 2006, pages 483–488, 2006. [4] D. C. T. C. MalazMallouhi, Youssif Al-Nashif and S. Hariri. A testbed for analyzing security of scada control systems (tasscs). In Second IEEE PES Innovative Smart Grid Technologies Conference, 2011. [5] X. Tong. The co-simulation extending for wide-area communication networks in power system. In Proc. Asia-Pacific Power and Energy Engineering Conf. (APPEEC), pages 1–4, 2010.

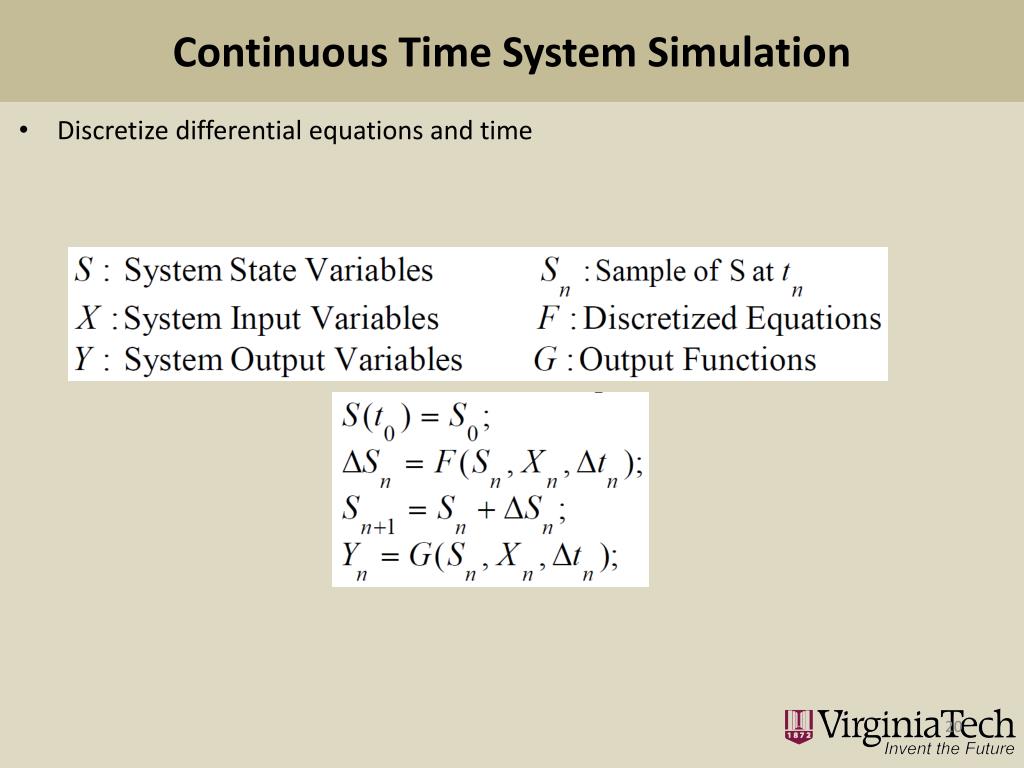

Continuous Time System Simulation • Discretize differential equations and time

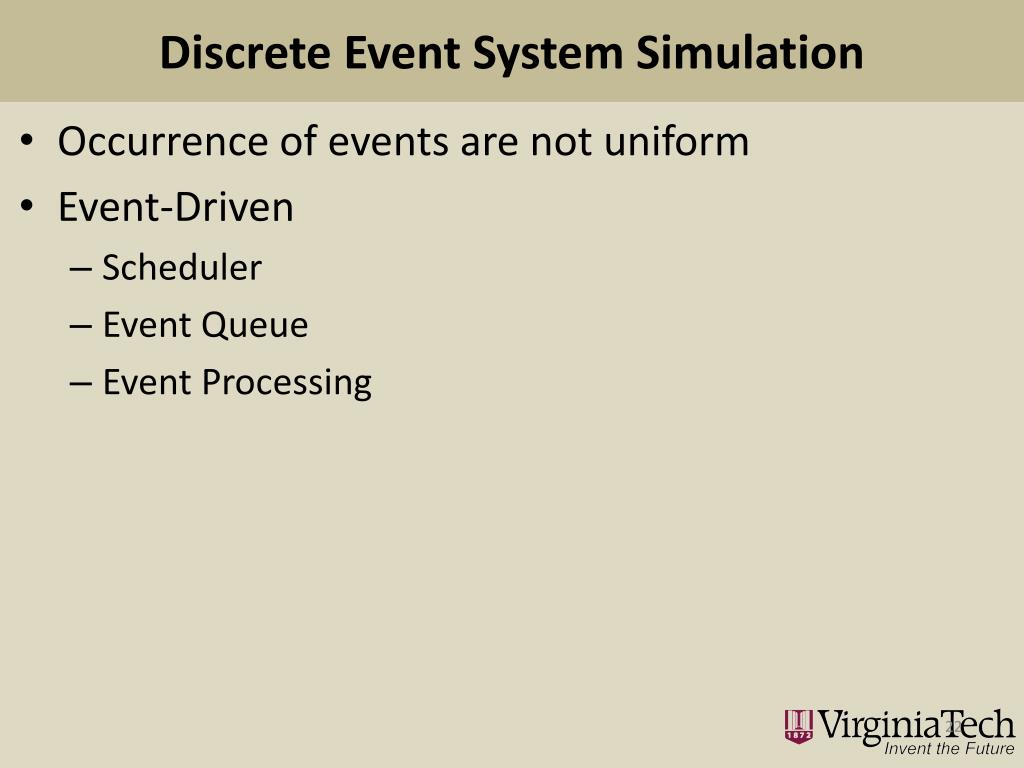

Discrete Event System Simulation • Occurrence of events are not uniform • Event-Driven • Scheduler • Event Queue • Event Processing

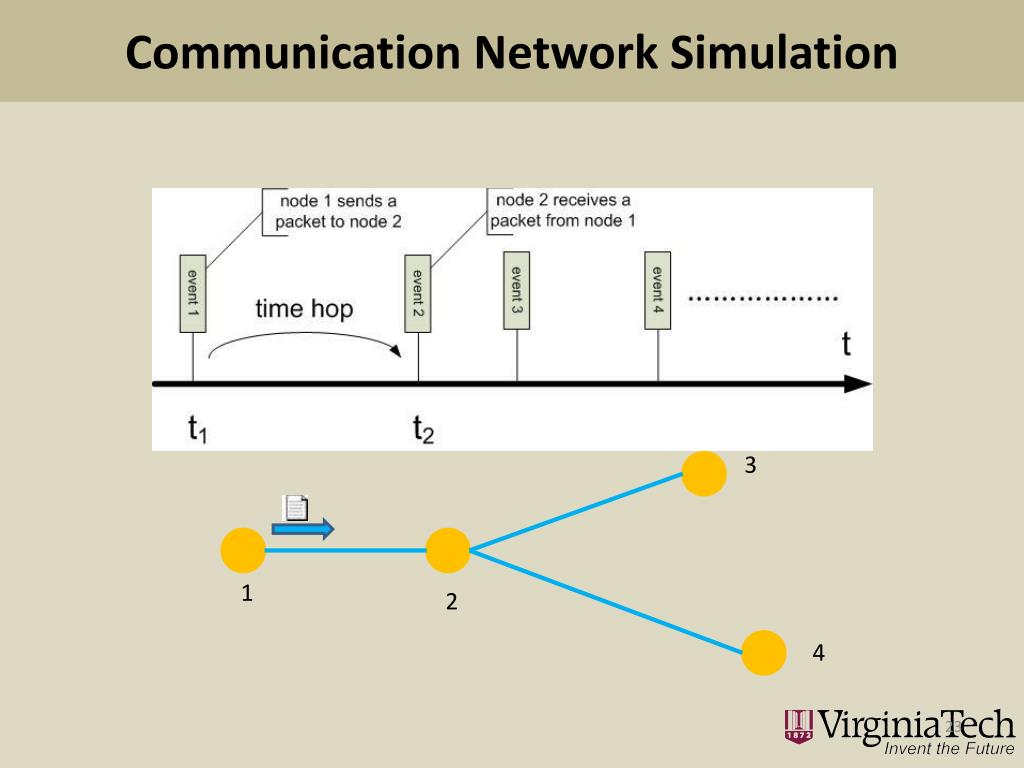

Communication Network Simulation 3 1 2 4

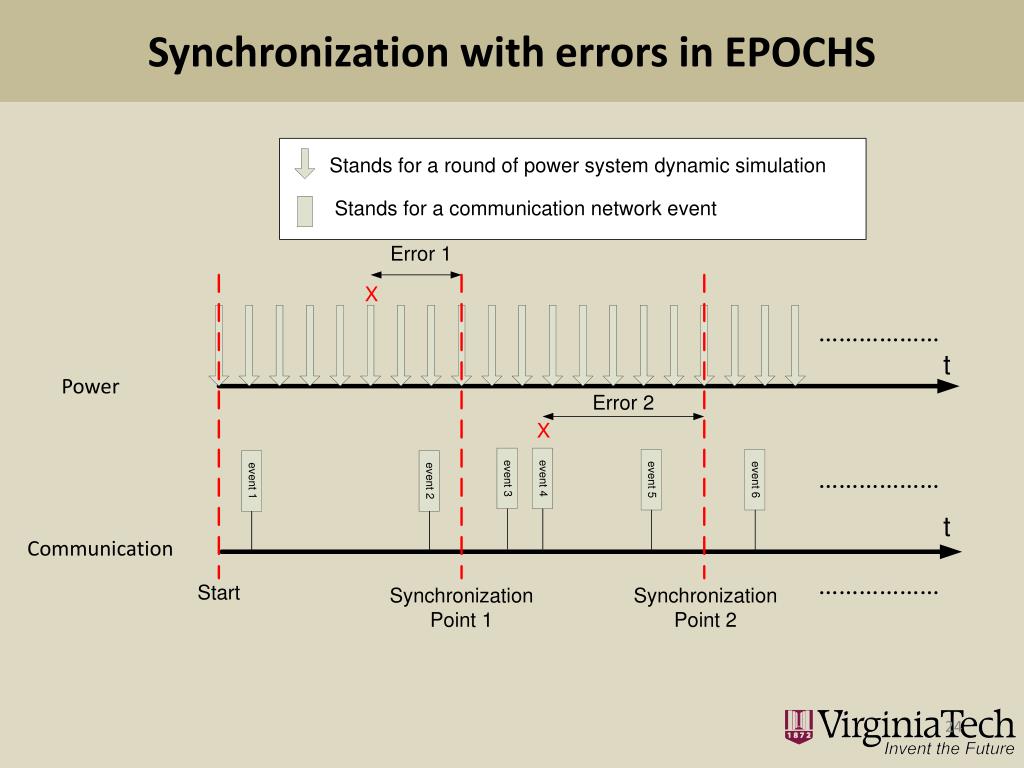

Synchronization with errors in EPOCHS Power Communication

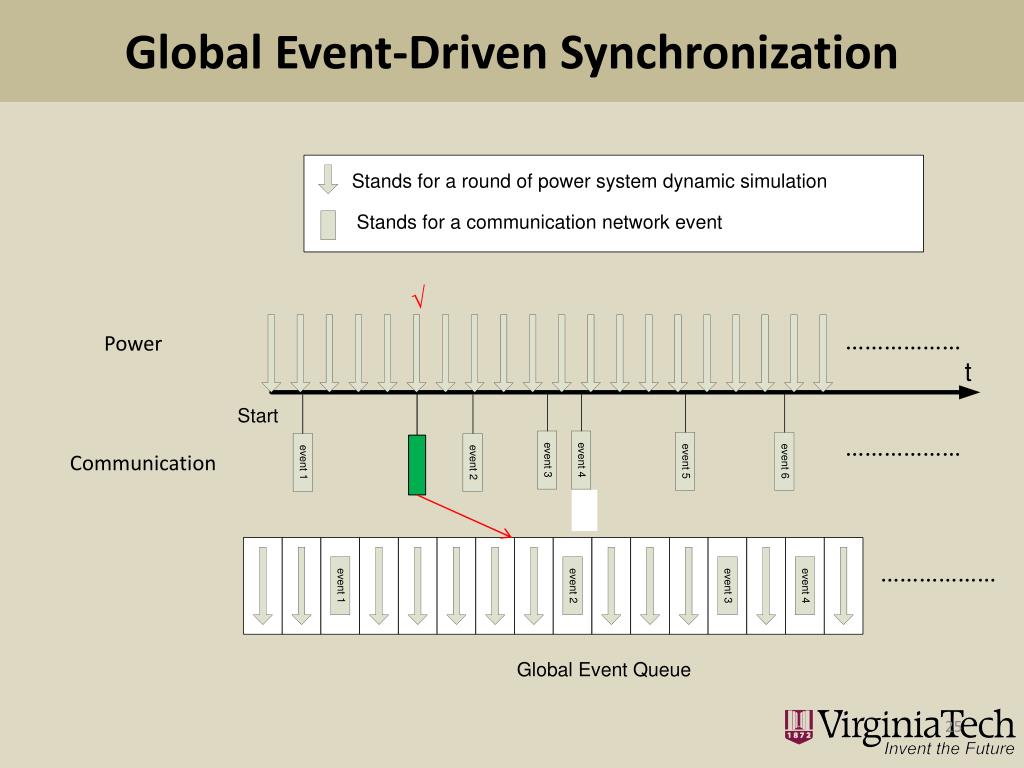

Global Event-Driven Synchronization Power Communication

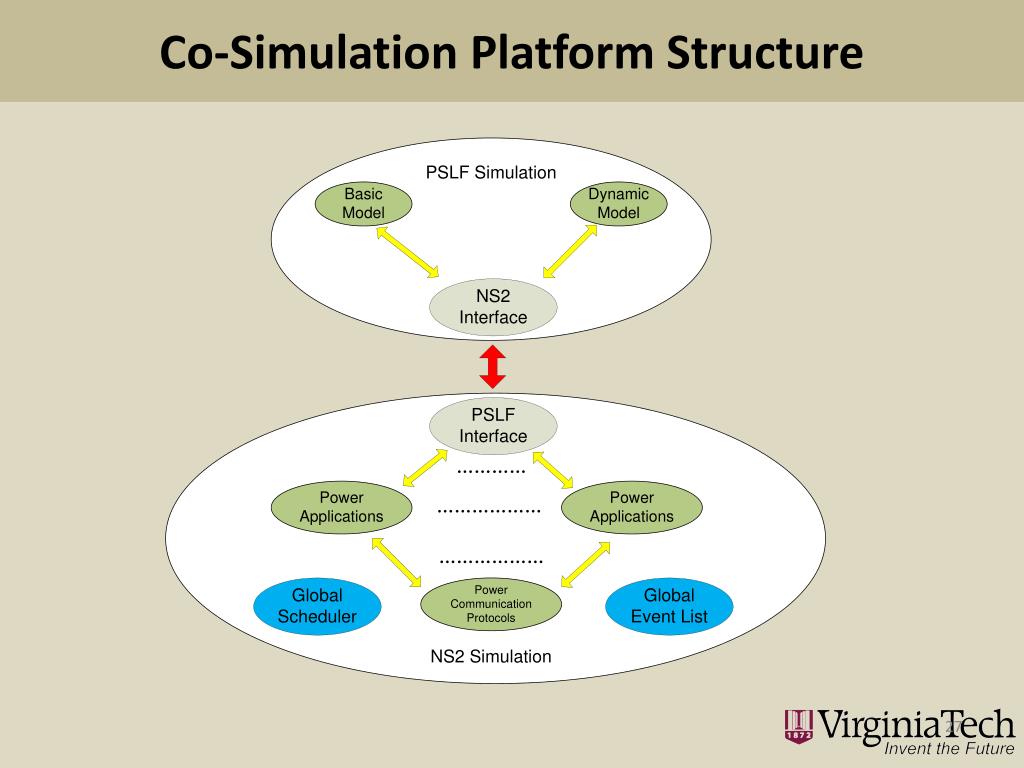

Implementation of the Co-simulation Framework GECO • PSLF • Power system • Written in Java • Script: EPCL • NS2 • Communication network • Written in C++ • Script: OTcl
GECO To Study All PMU linear state estimator • Global Event-driven Co-simulation
Power System Protection • Relays protect power systems when faults happen • Over current • Over voltage • Directional • Distance (Impedance) • Differential • Pilot

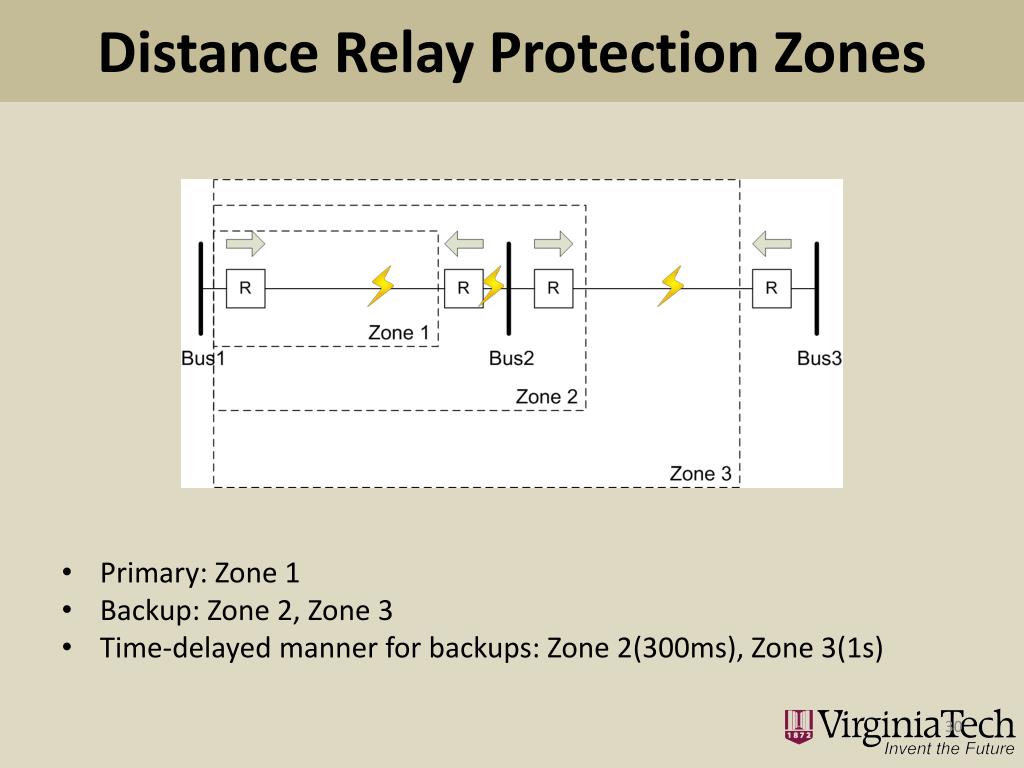

Distance Relay Protection Zones • Primary: Zone 1 • Backup: Zone 2, Zone 3 • Time-delayed manner for backups: Zone 2(300ms), Zone 3(1s)

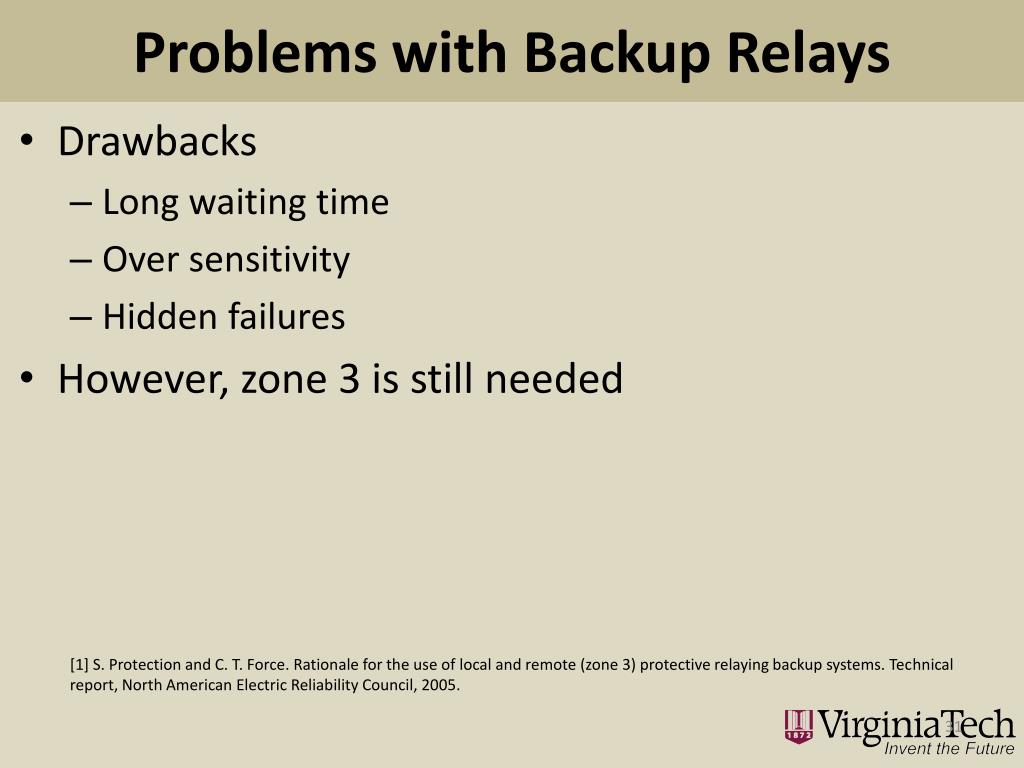

Problems with Backup Relays • Drawbacks • Long waiting time • Over sensitivity • Hidden failures • However, zone 3 is still needed [1] S. Protection and C. T. Force. Rationale for the use of local and remote (zone 3) protective relaying backup systems. Technical report, North American Electric Reliability Council, 2005.

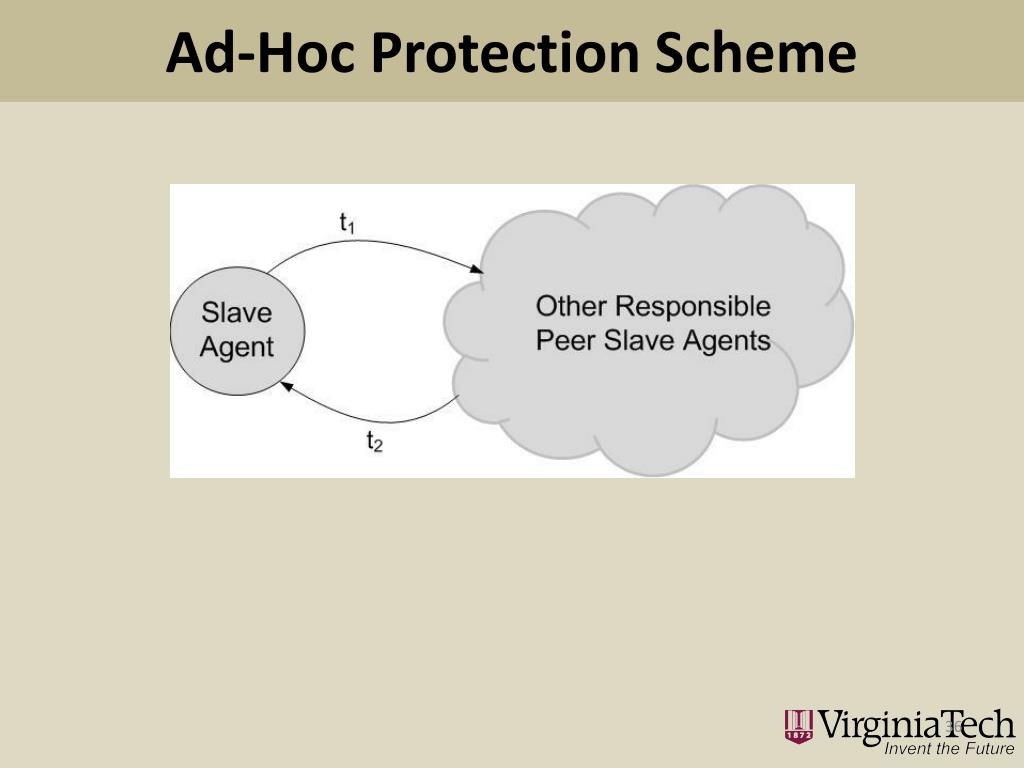

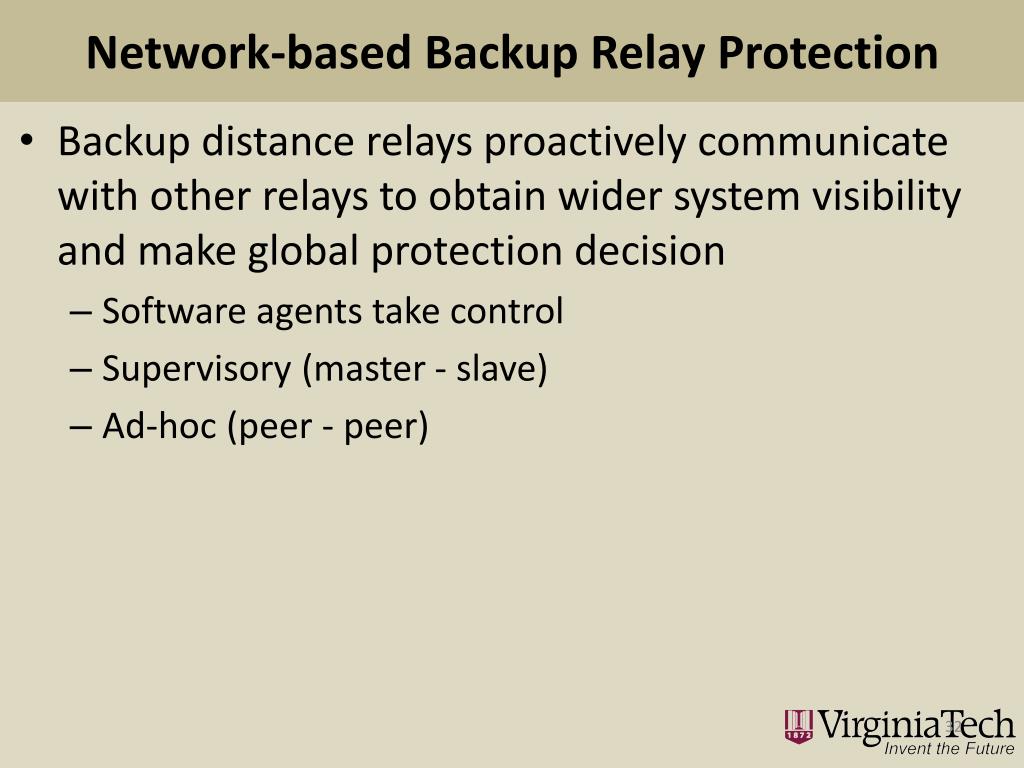

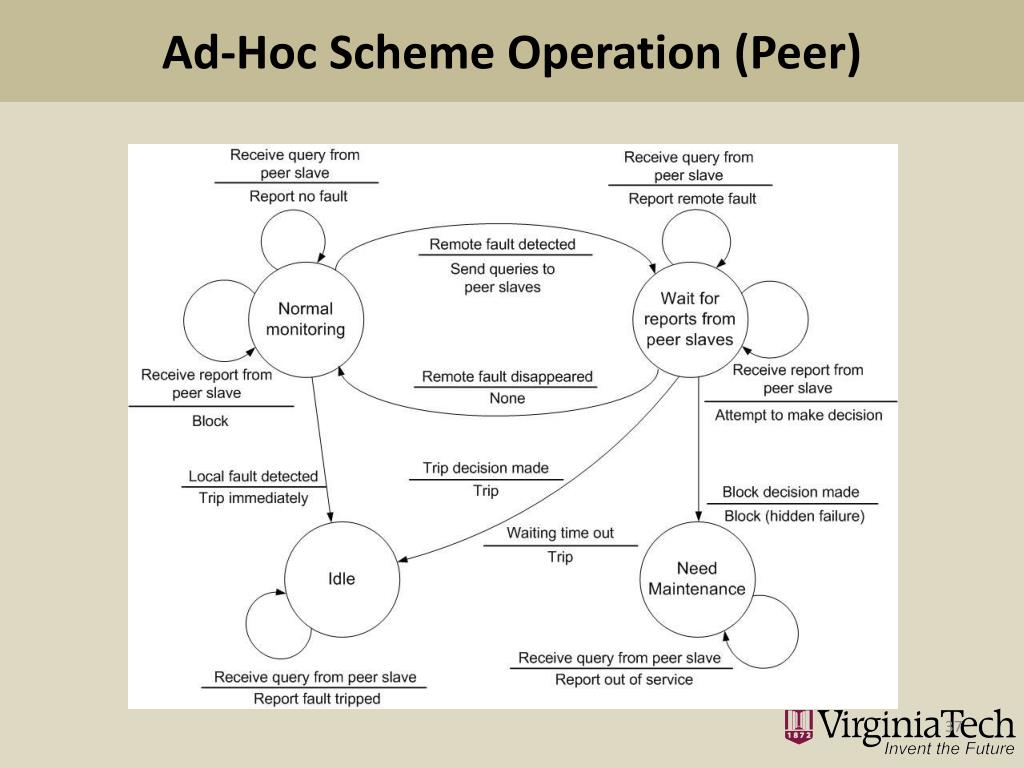

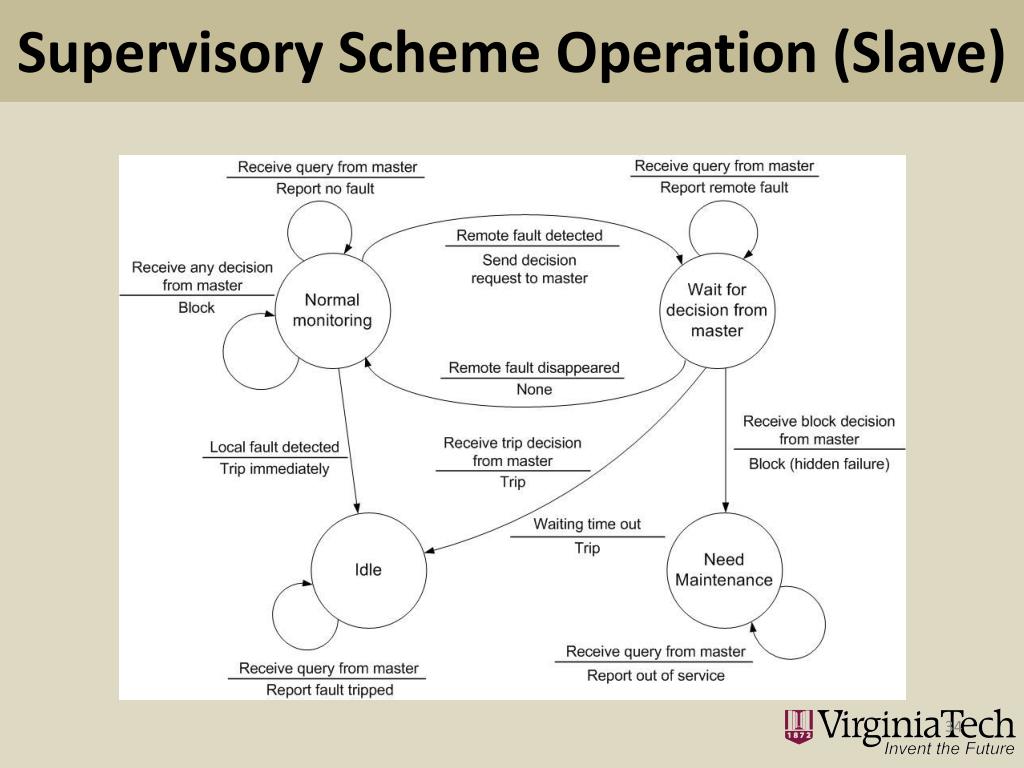

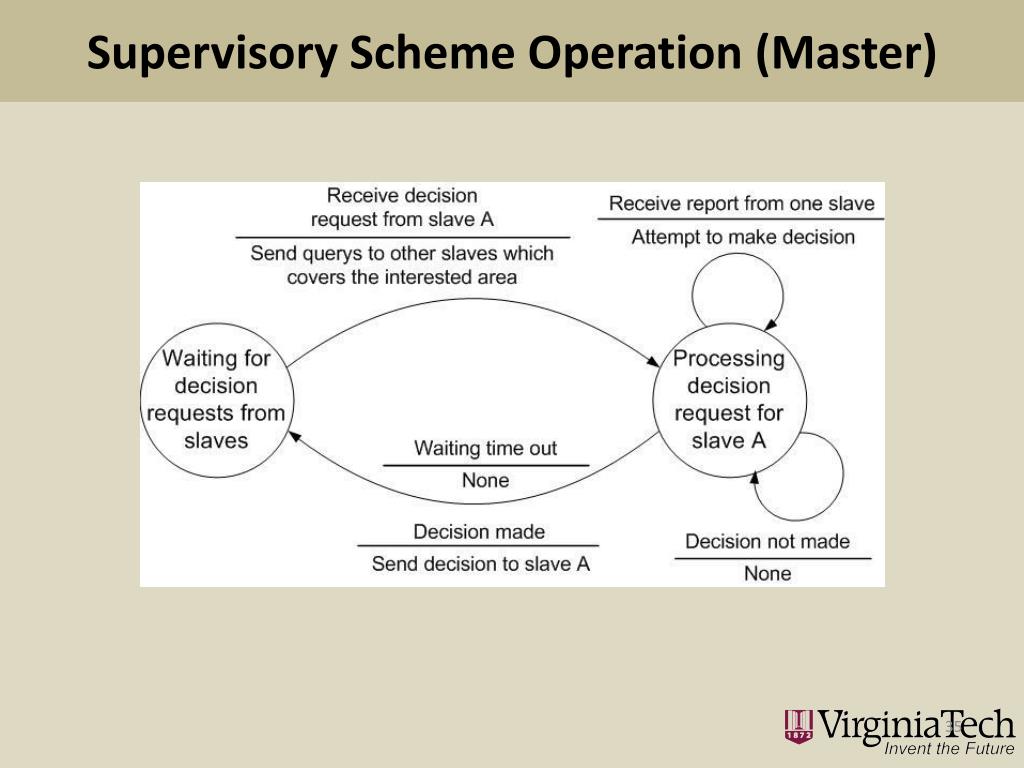

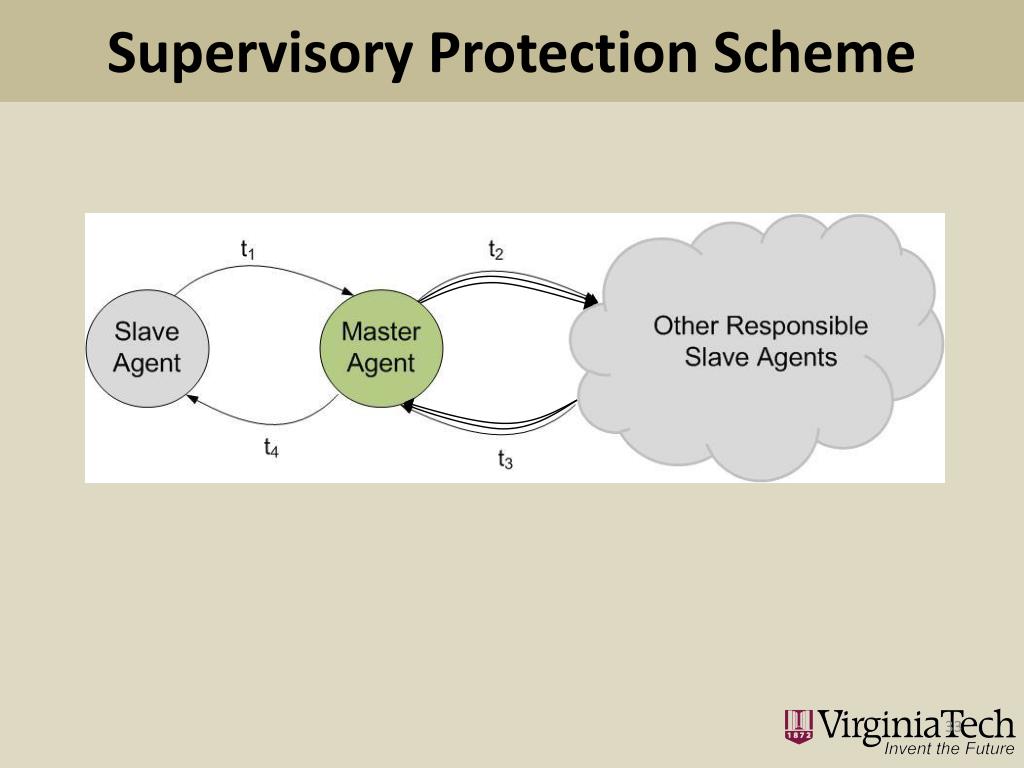

Network-based Backup Relay Protection • Backup distance relays proactively communicate with other relays to obtain wider system visibility and make global protection decision • Software agents take control • Supervisory (master - slave) • Ad-hoc (peer - peer)
Relay Searching • Find the responsible relay group

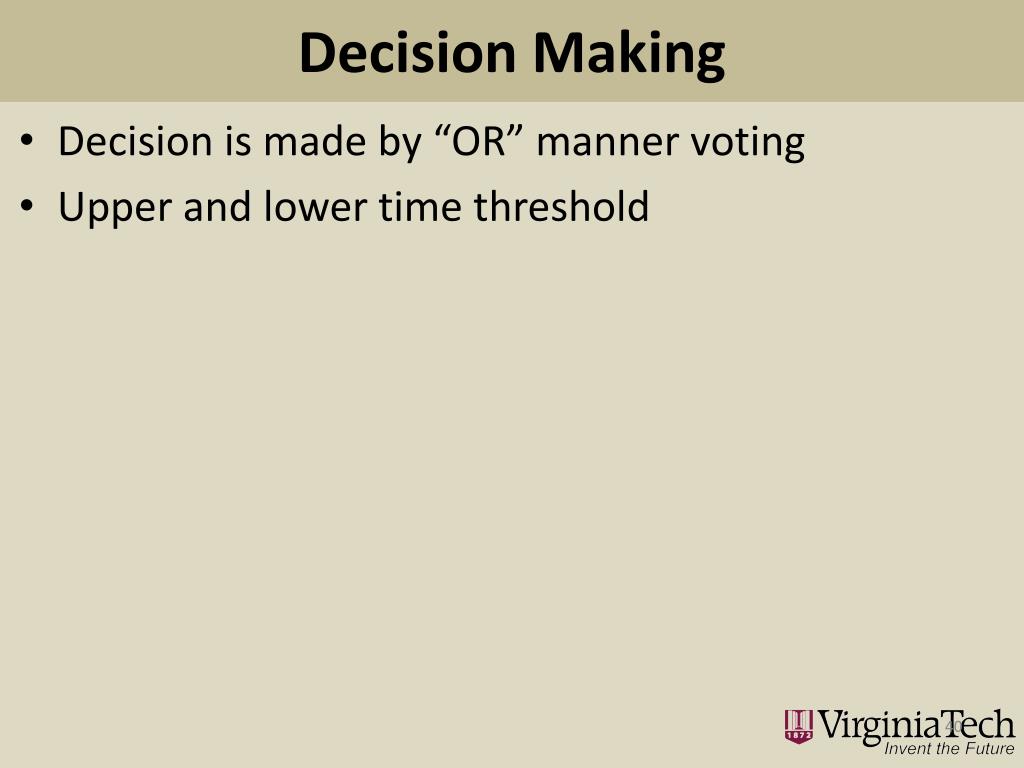

Decision Making • Decision is made by “OR” manner voting • Upper and lower time threshold

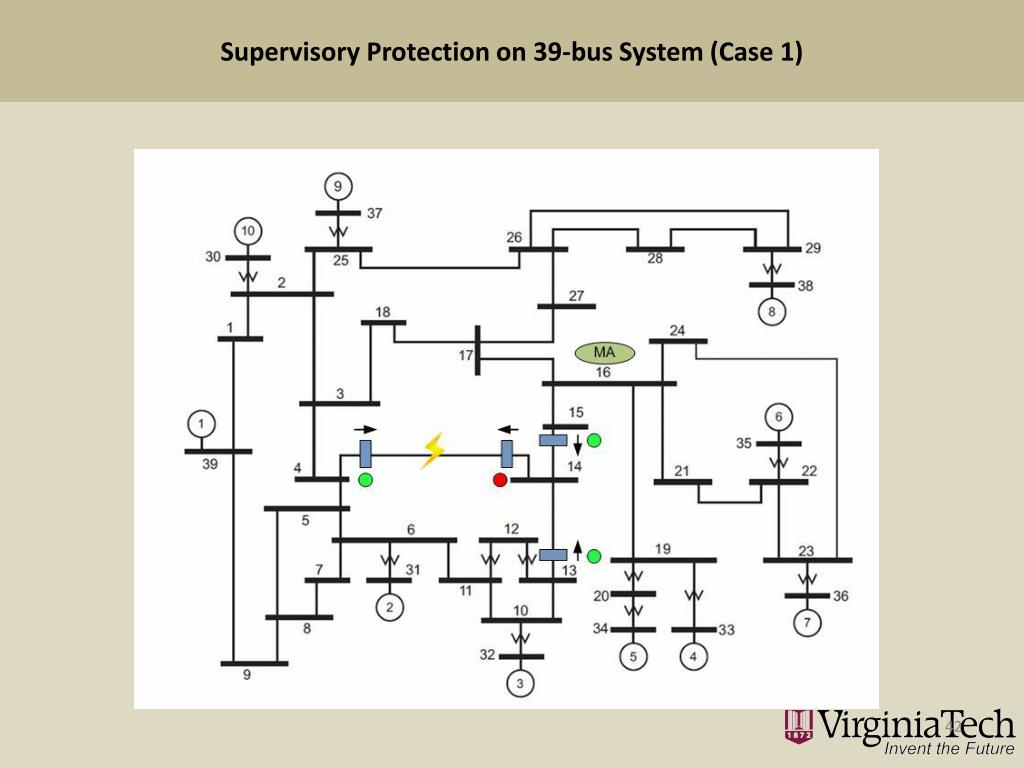

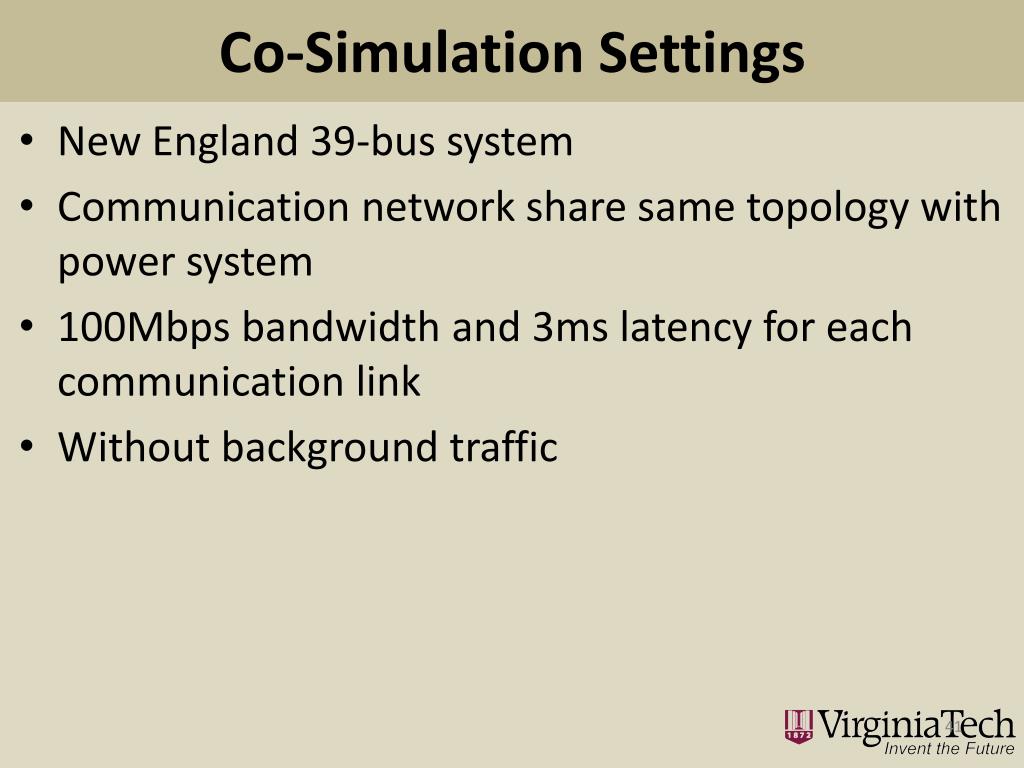

Co-Simulation Settings • New England 39-bus system • Communication network share same topology with power system • 100Mbps bandwidth and 3ms latency for each communication link • Without background traffic

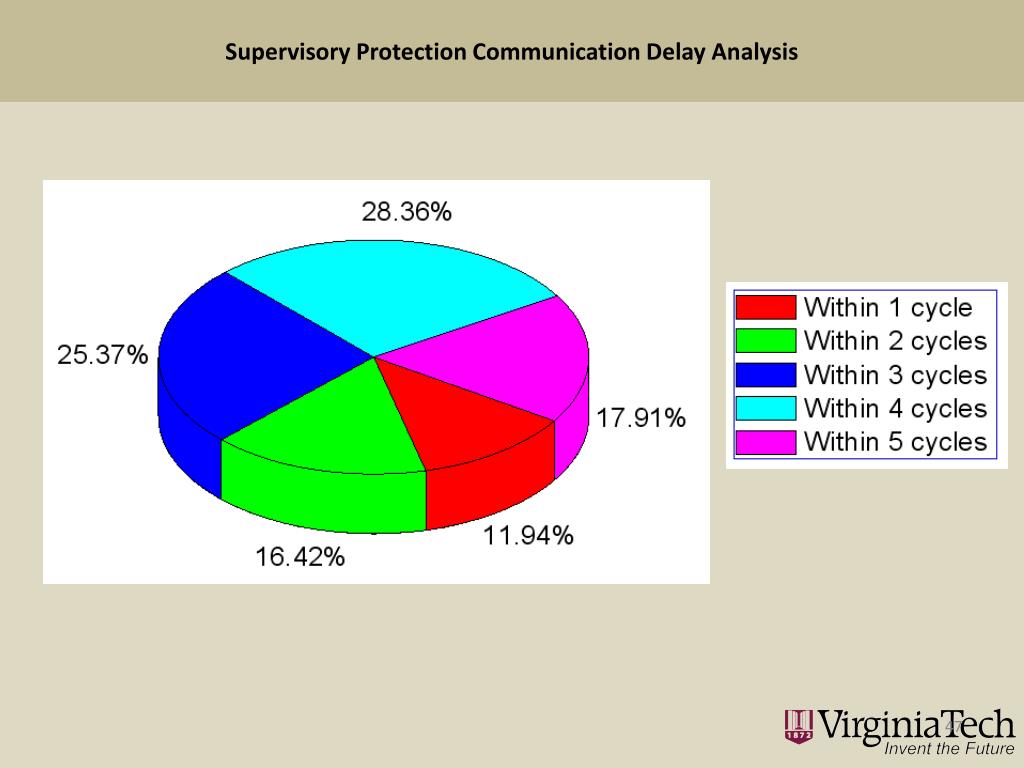

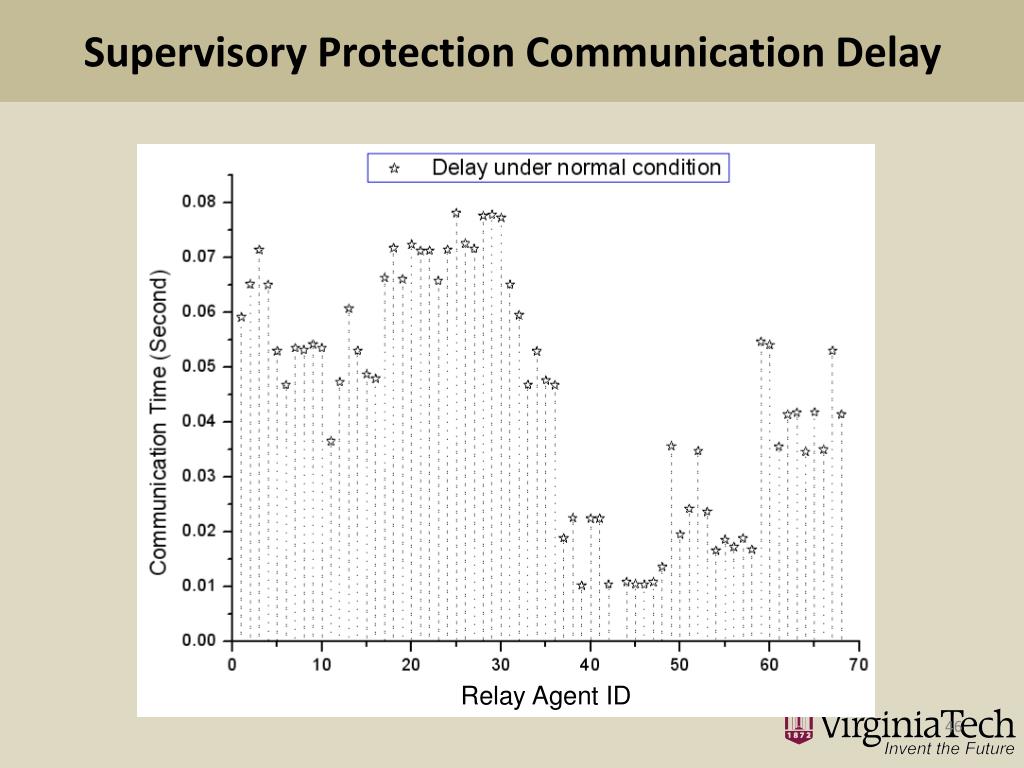

Supervisory Protection Communication Delay Relay Agent ID

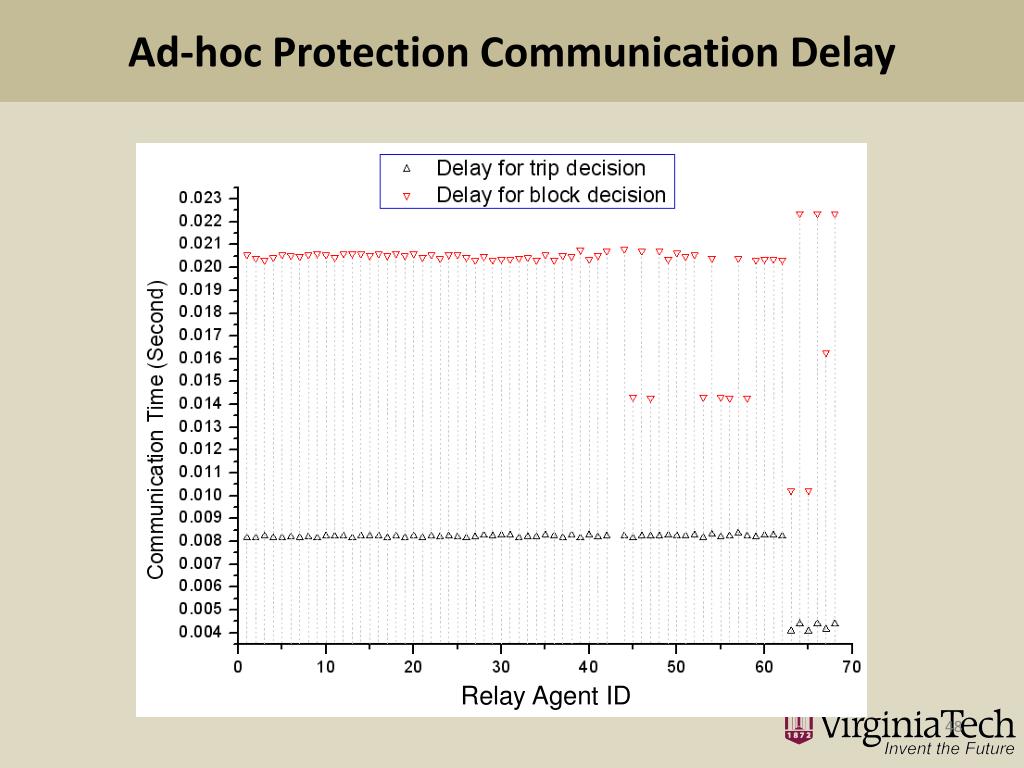

Ad-hoc Protection Communication Delay Relay Agent ID

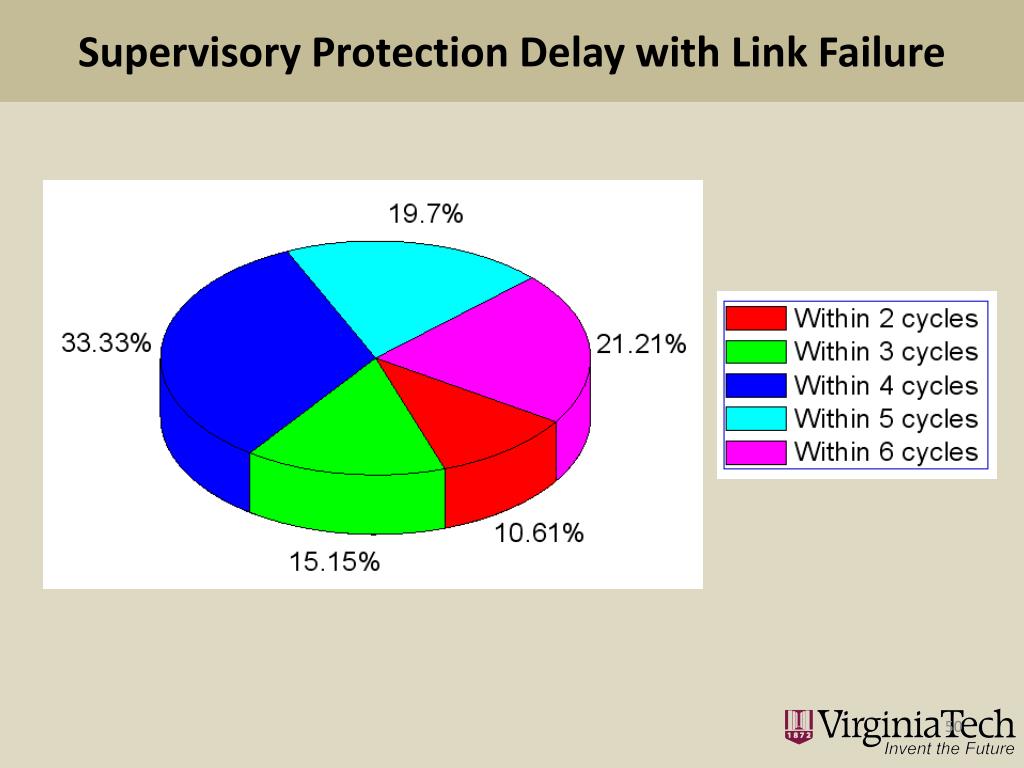

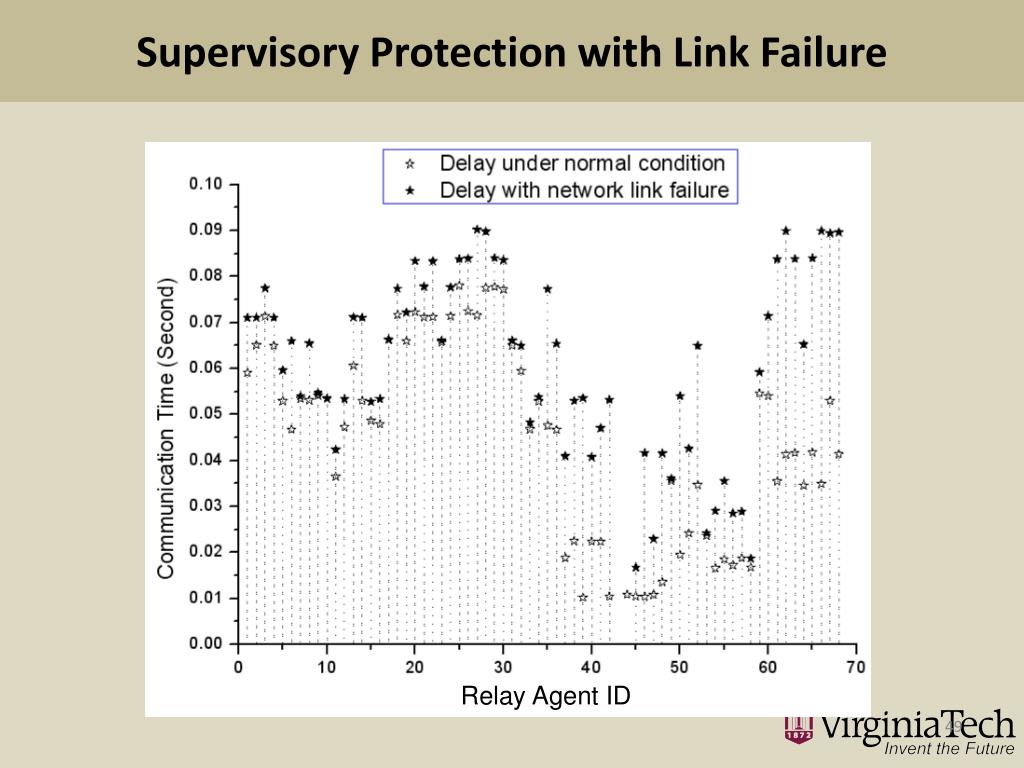

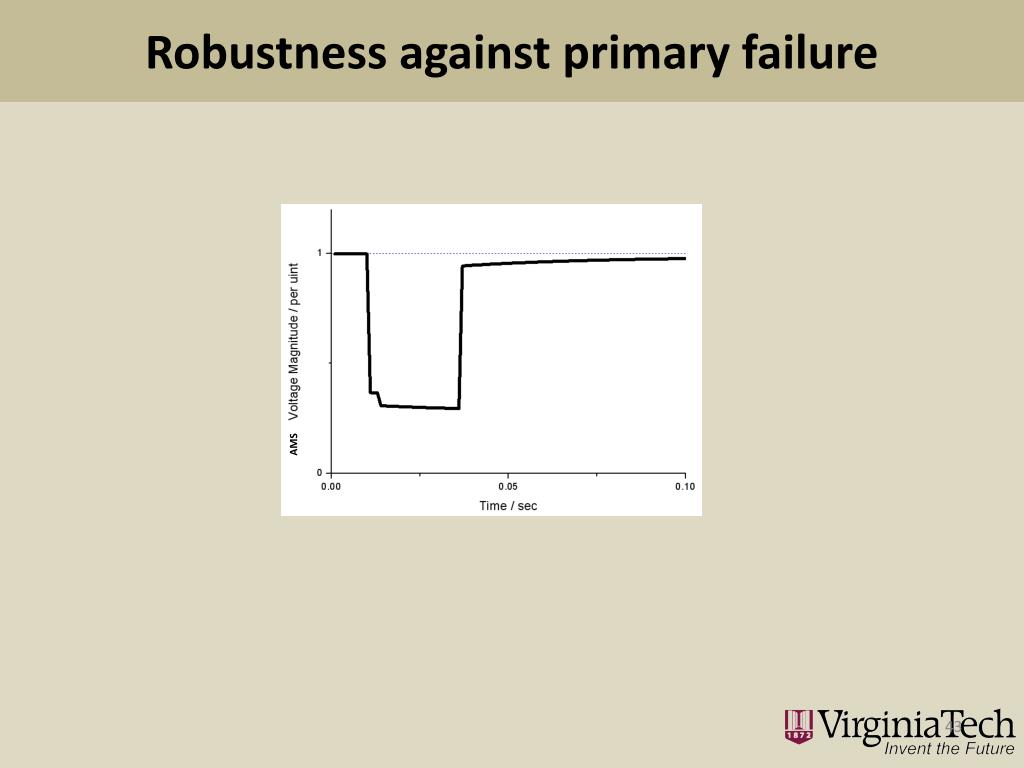

Supervisory Protection with Link Failure Relay Agent ID
