PERT/CPM Technical Issues

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript

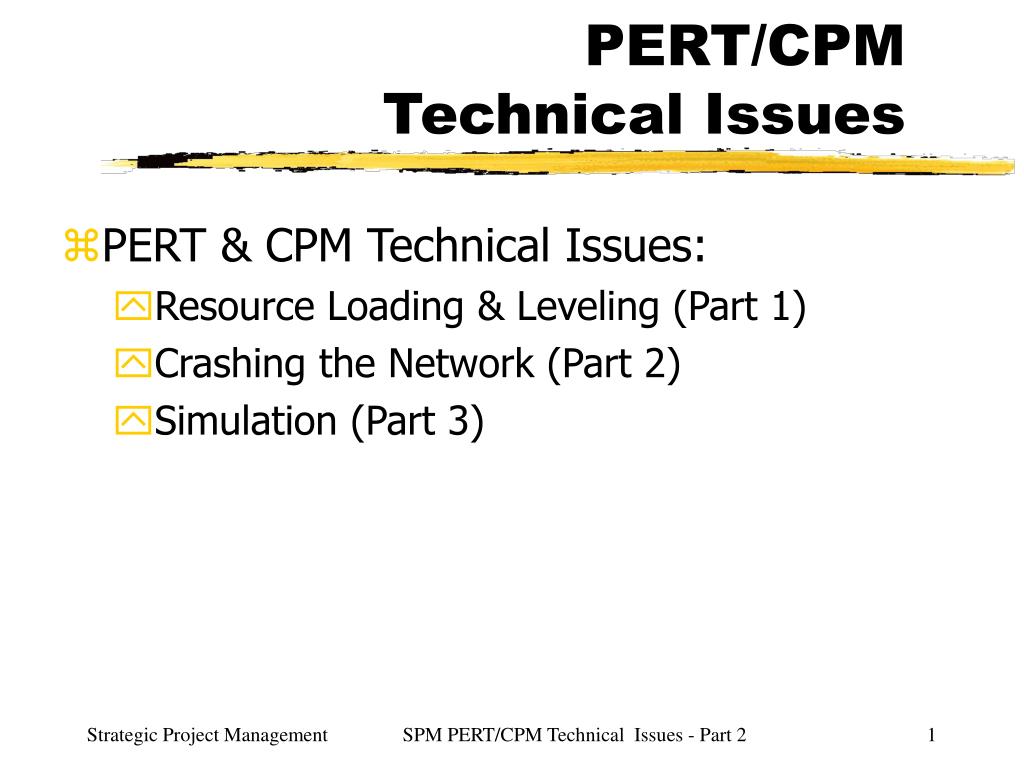

  1. PERT/CPMTechnical Issues • PERT & CPM Technical Issues: • Resource Loading & Leveling (Part 1) • Crashing the Network (Part 2) • Simulation (Part 3) Strategic Project Management SPM PERT/CPM Technical Issues - Part 2 1

  2. Project Costs • The cost aspect of a project can be included by determining the cost-duration relationship for each activity. • This relationship usually includes only the direct costs associated with the activity • labor and material • Indirect costs (overhead) are generally applied (charged) to the project as a whole on a per day (or per time unit) basis. Strategic Project Management SPM PERT/CPM Technical Issues - Part 2 2

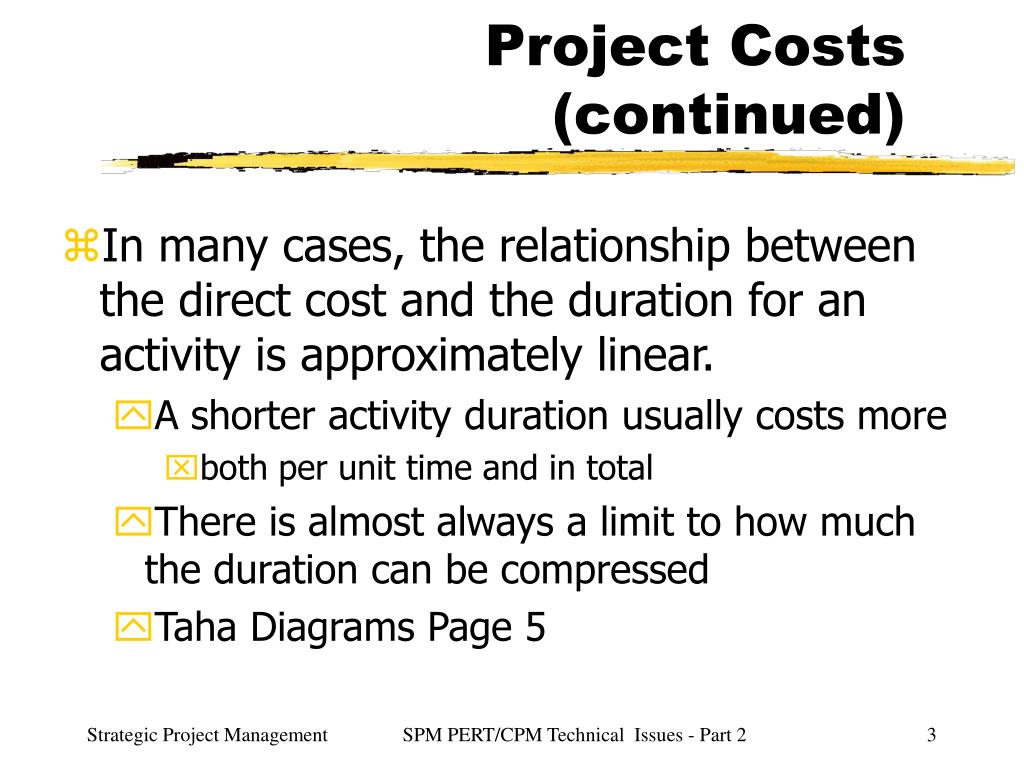

  3. Project Costs(continued) • In many cases, the relationship between the direct cost and the duration for an activity is approximately linear. • A shorter activity duration usually costs more • both per unit time and in total • There is almost always a limit to how much the duration can be compressed • Taha Diagrams Page 5 Strategic Project Management SPM PERT/CPM Technical Issues - Part 2 3

  4. Crashing the Network • After defining the cost-time relationships, the activities are assigned their normal durations. • The critical path is determined and the project cost is calculated. • Next, we consider reducing the duration of the project (crashing). • Taha Diagrams Page 6 and Page 7 Strategic Project Management SPM PERT/CPM Technical Issues - Part 2 4

  5. Crashing the Network(continued) • A project duration reduction can be effected ONLY if the critical path is reduced. • Consider the example on Taha Diagrams Pages 8 and 9 • We will consider crashing only activities on the critical path • Crashing non-critical activities serves only to increase cost! Strategic Project Management SPM PERT/CPM Technical Issues - Part 2 5

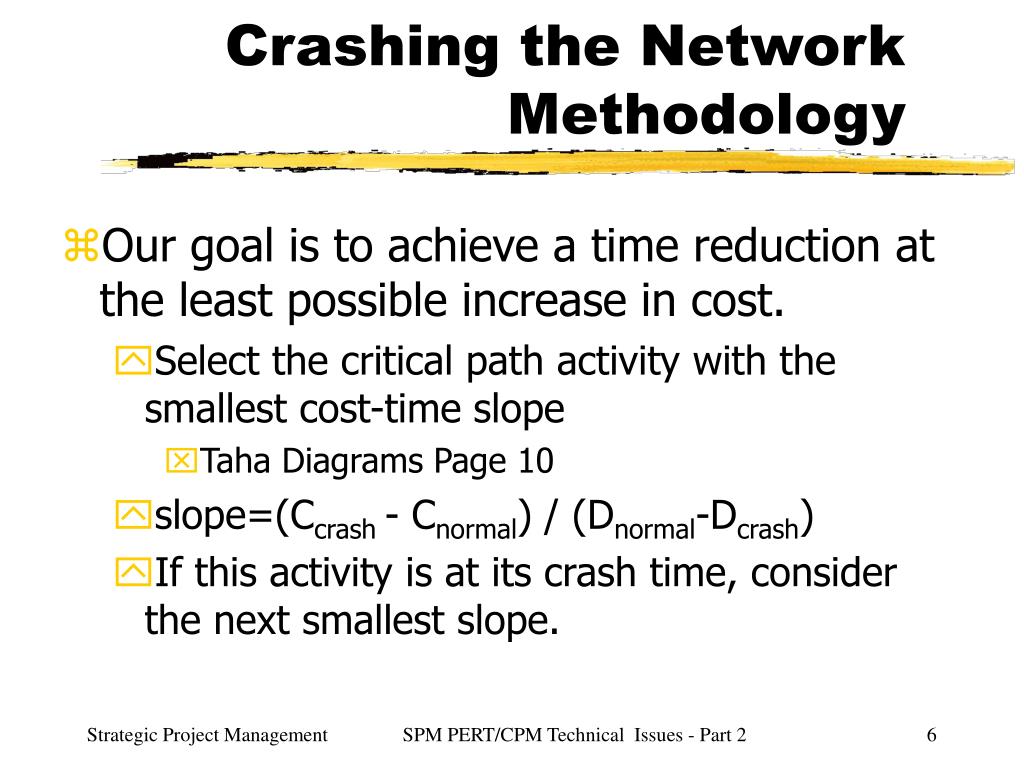

  6. Crashing the NetworkMethodology • Our goal is to achieve a time reduction at the least possible increase in cost. • Select the critical path activity with the smallest cost-time slope • Taha Diagrams Page 10 • slope=(Ccrash - Cnormal) / (Dnormal-Dcrash) • If this activity is at its crash time, consider the next smallest slope. Strategic Project Management SPM PERT/CPM Technical Issues - Part 2 6

  7. Crashing the Network Methodology (continued) • If all activities on a critical path are crashed to their limits, no further reduction is possible. • If parallel critical paths (segments) exist, an activity on each path (segment) must be selected and the sum of the cost-time slopes for the activities must be considered. • Compress (crash) the selected activity(ies) by one time unit. Strategic Project Management SPM PERT/CPM Technical Issues - Part 2 7

  8. Crashing the Network Methodology (continued) • Recalculate the critical path and project cost. • Repeat the this process until further crashing is not possible. • The end result will be a set of time-cost data which can be plotted to show the time-cost relationship for the project. • Taha Diagrams Pages 11 through 14 • Taha Diagrams Page 15 summarizes Strategic Project Management SPM PERT/CPM Technical Issues - Part 2 8

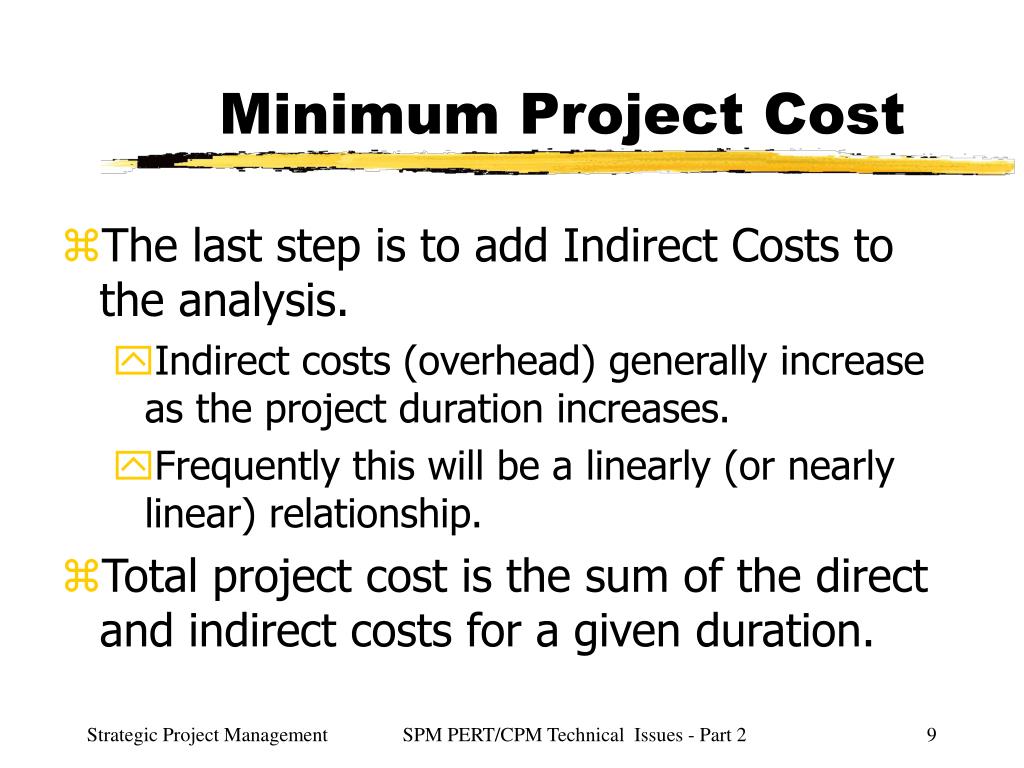

  9. Minimum Project Cost • The last step is to add Indirect Costs to the analysis. • Indirect costs (overhead) generally increase as the project duration increases. • Frequently this will be a linearly (or nearly linear) relationship. • Total project cost is the sum of the direct and indirect costs for a given duration. Strategic Project Management SPM PERT/CPM Technical Issues - Part 2 9

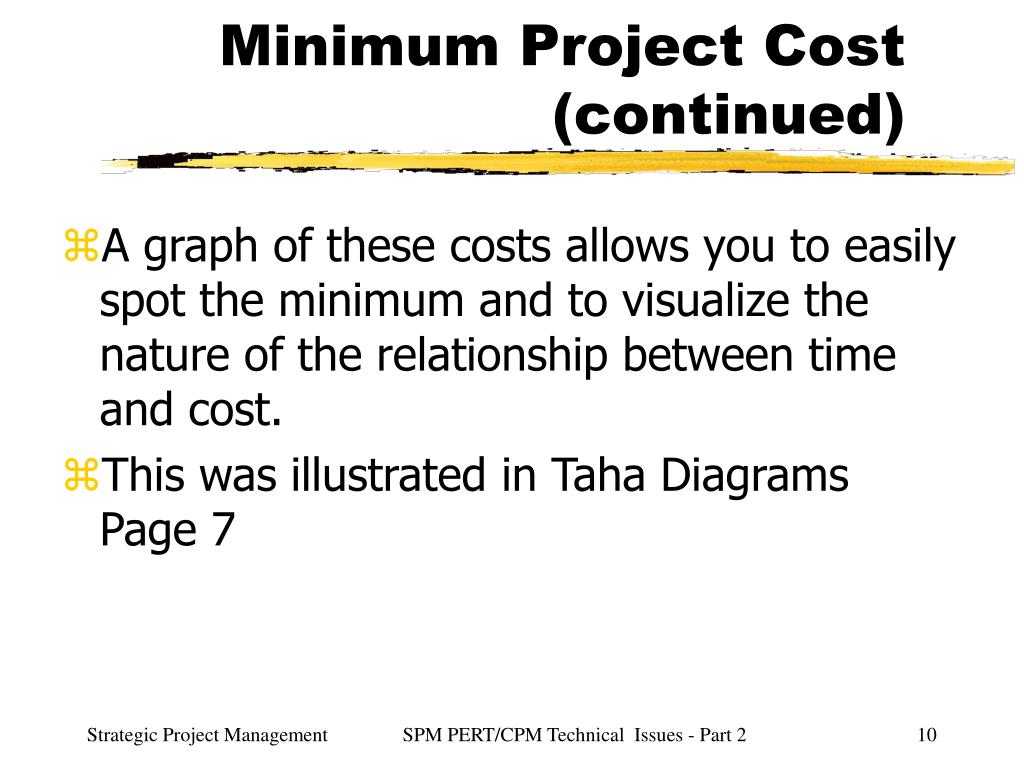

  10. Minimum Project Cost(continued) • A graph of these costs allows you to easily spot the minimum and to visualize the nature of the relationship between time and cost. • This was illustrated in Taha Diagrams Page 7 Strategic Project Management SPM PERT/CPM Technical Issues - Part 2 10
