E-906/SeaQuest Installation

DESCRIPTION

E-906/SeaQuest Installation . Paul E. Reimer 14 December 2009. E906 needs in NM4 in FY09. End of loading dock. KMAG. Areas that needed to be cleaned. Finished this week A good job by John Voirin's crew of PPD technicians. NM4 (KTeV) Hall layout—Winter 2008/9.

1 / 10

Download Presentation

E-906/SeaQuest Installation

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. E-906/SeaQuest Installation Paul E. Reimer 14 December 2009

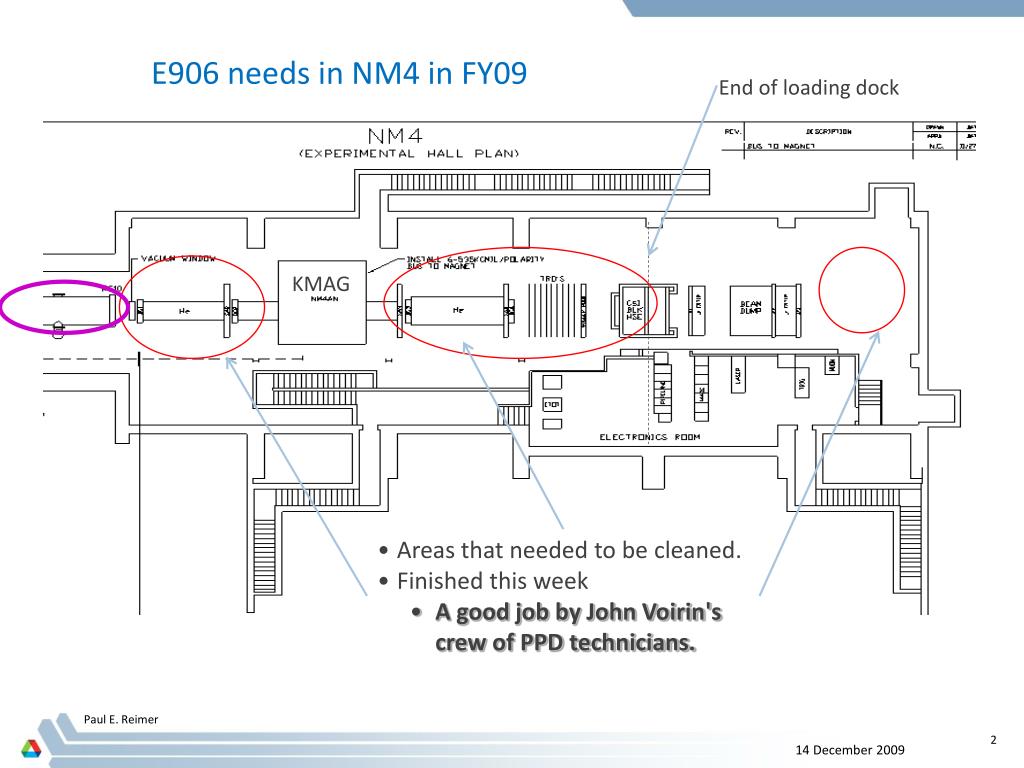

  2. E906 needs in NM4 in FY09 End of loading dock KMAG • Areas that needed to be cleaned. • Finished this week • A good job by John Voirin's crew of PPD technicians. Paul E. Reimer

  3. NM4 (KTeV) Hall layout—Winter 2008/9 Current status of NM4 (KTeV Hall) • Scaffolding/supports everywhere • Left over ruins of a previous grand experiment • Tourists visit it occasionally • Site has been scavenged for valuable material, waste bins to throw the rest away. Paul E. Reimer

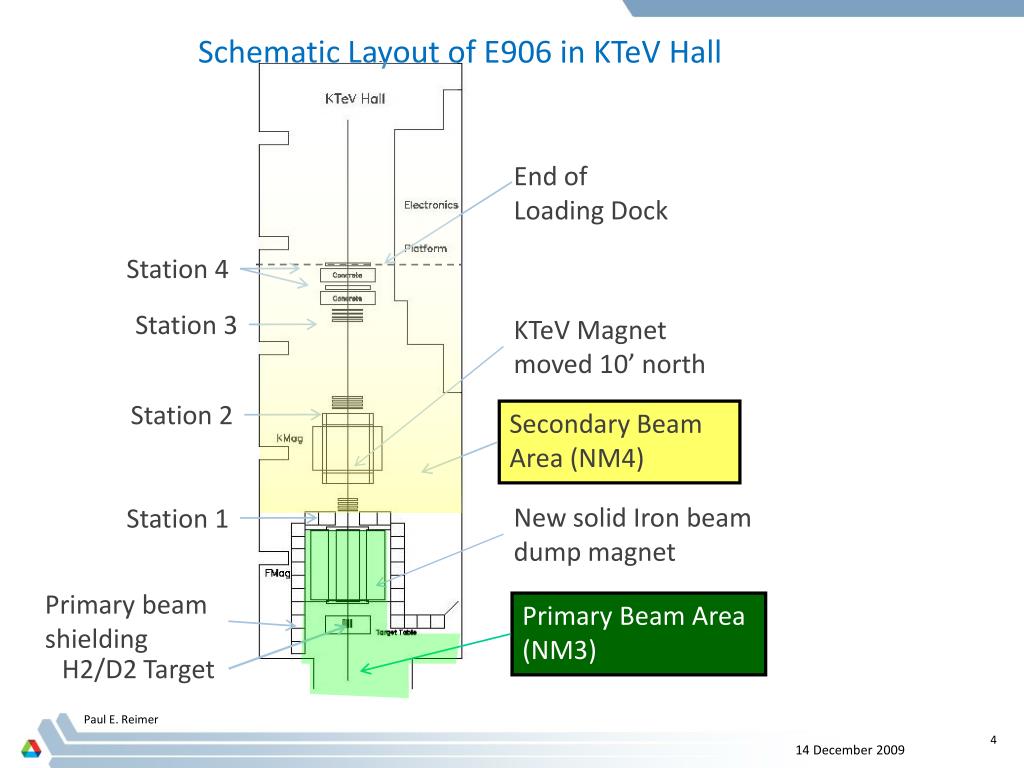

  4. Schematic Layout of E906 in KTeV Hall End of Loading Dock Station 4 Station 3 KTeV Magnet moved 10’ north Station 2 Secondary Beam Area (NM4) New solid Iron beam dump magnet Station 1 Primary beam shielding Primary Beam Area (NM3) H2/D2 Target Paul E. Reimer

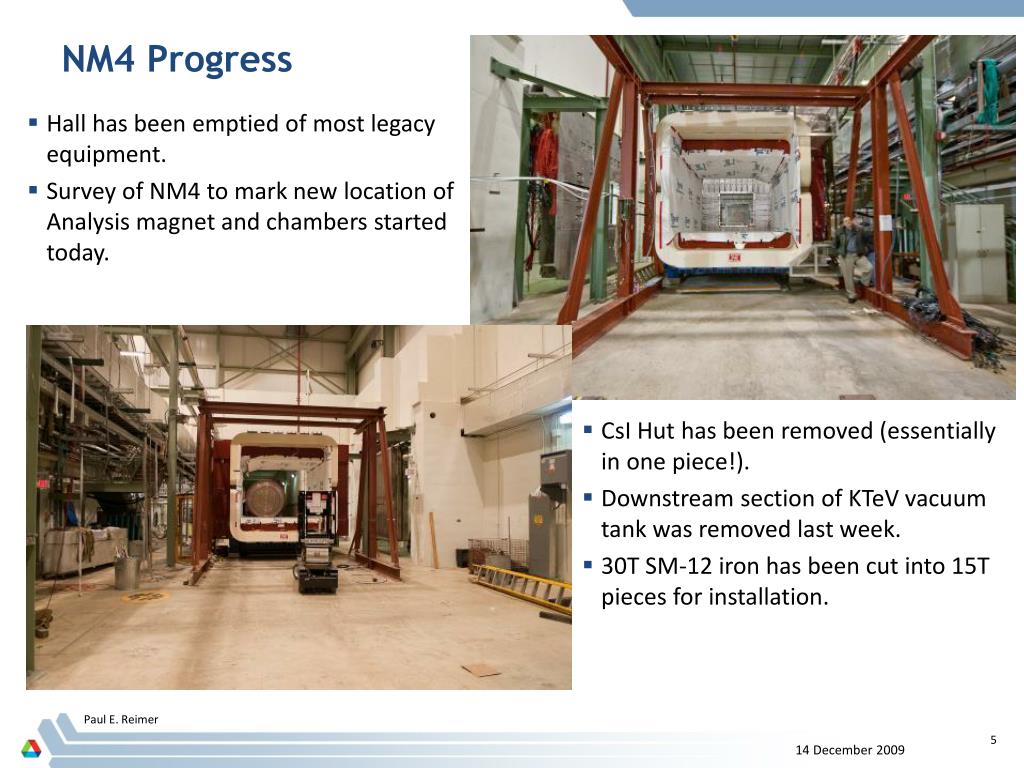

  5. NM4 Progress • Hall has been emptied of most legacy equipment. • Survey of NM4 to mark new location of Analysis magnet and chambers started today. • CsI Hut has been removed (essentially in one piece!). • Downstream section of KTeV vacuum tank was removed last week. • 30T SM-12 iron has been cut into 15T pieces for installation. Paul E. Reimer

  6. Chamber test/installation progress E-866 St. 2, Now E-906 St 3 Bottom • Old Chambers have been moved to NM4 for Leak and HV test • Wire repairs are necessary—We’ll know more once they are opened up in Jan/Feb. E-866 St. 3, Now E-906 St 2 Paul E. Reimer

  7. E-906/SeaQuest Gantt Chart Shutdown Target work—driven by “unknown” test and setup time in NM4. Paul E. Reimer

  8. Gantt Chart--highlights Survey today and tomorrow Want Chamber Repair tent setup on loading dock by this time Paul E. Reimer

  9. Iron for FMag cut into 15T pieces Paul E. Reimer

  10. NM4 Hall layout and space—soon • Transform hall into useable space—Finishes this week • Installation of SeaQuest starts with the moving of the Analysis magnet 10' downstream to it's new location next week. Paul E. Reimer
