Introduction to Spreadsheetsin Project Planning Bent Thomsen
Project Planning • Use SLP methods to identify project tasks • Project diagrams • Activity diagrams • List project tasks • Estimate durations • Estimate resources required. • Use your own judgment.
Project: Operational Reporting System Implementation Consultants Dur’n in Weeks • Tasks • Project Start-up • Team training & briefing • Set up computer system • Define input requirements • Source input requirements • Trial with manual input • Develop interfaces • Trial run thru’ interfaces • Produce draft reports • Business review meeting • Develop documentation • Handover of system • Debrief 0.5 1 4.5 1 1 1 2 1 0.5 0.5 4 0.5 0.5 2 2 1 1 1 1 1 1 1 1 2 2 2 Example

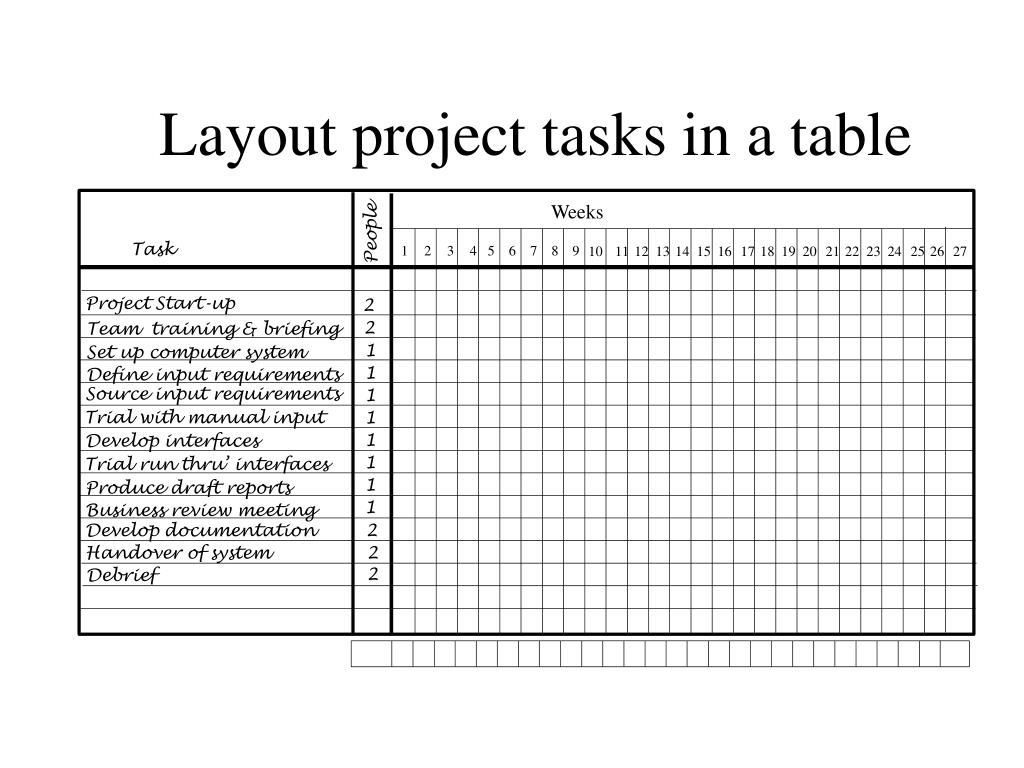

Layout project tasks in a table Weeks People Task 1 2 3 4 5 6 7 8 9 10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 Project Start-up 2 2 Team training & briefing 1 Set up computer system 1 Define input requirements Source input requirements 1 Trial with manual input 1 1 Develop interfaces 1 Trial run thru’ interfaces 1 Produce draft reports 1 Business review meeting Develop documentation 2 Handover of system 2 2 Debrief

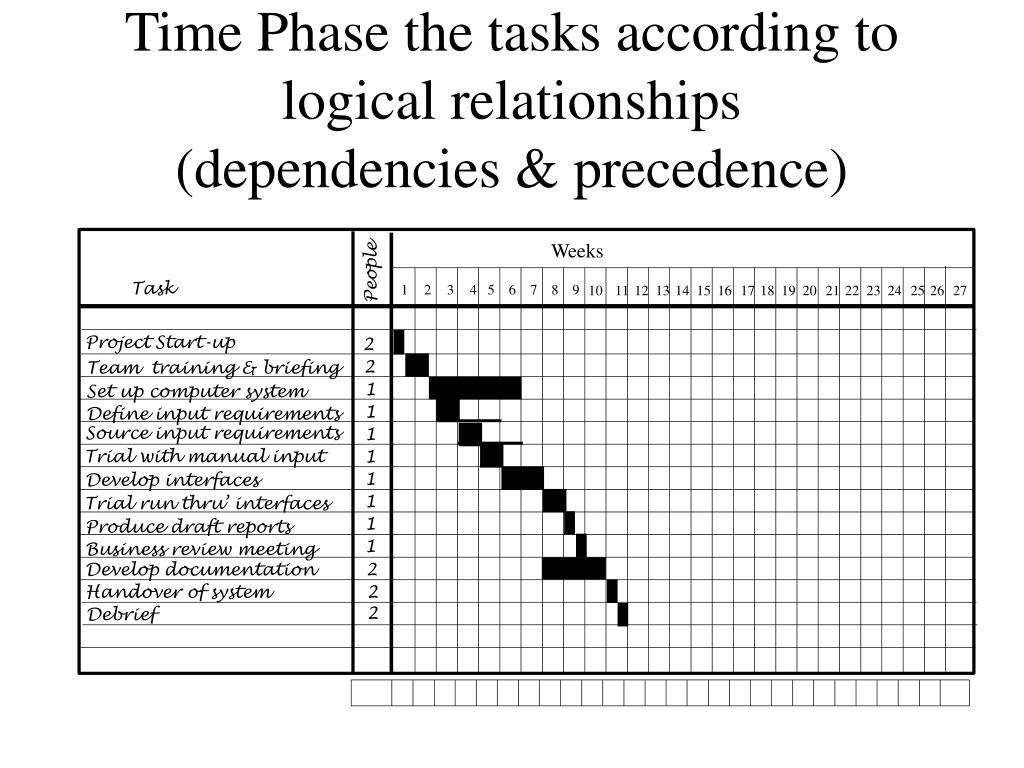

Time Phase the tasks according to logical relationships (dependencies & precedence) Weeks People Task 1 2 3 4 5 6 7 8 9 10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 Project Start-up 2 2 Team training & briefing 1 Set up computer system 1 Define input requirements Source input requirements 1 Trial with manual input 1 1 Develop interfaces 1 Trial run thru’ interfaces 1 Produce draft reports 1 Business review meeting Develop documentation 2 Handover of system 2 2 Debrief
Determine resources required for each planned unit Weeks People Task 1 2 3 4 5 6 7 8 9 10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 Project Start-up 2 2 Team training & briefing 1 Set up computer system 1 Define input requirements Source input requirements 1 Trial with manual input 1 1 Develop interfaces 1 Trial run thru’ interfaces 1 Produce draft reports 1 Business review meeting Develop documentation 2 Handover of system 2 2 Debrief 2 2 2 2 2 2 2 2 3 3 2 2

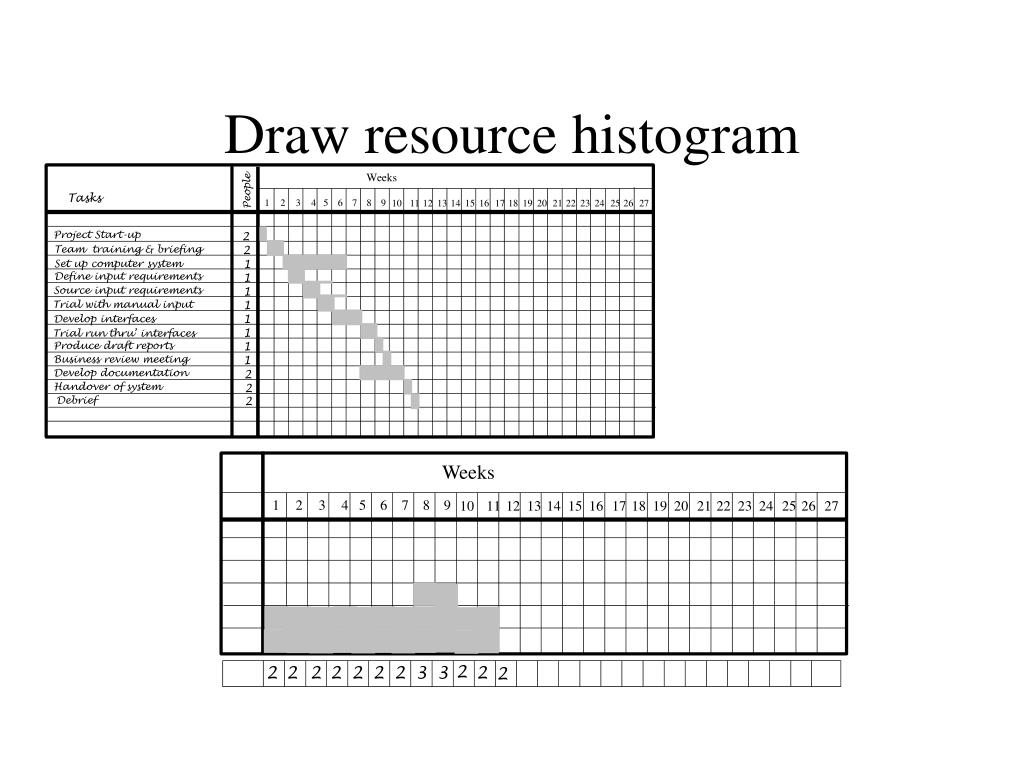

Draw resource histogram Weeks People Tasks 1 2 3 4 5 6 7 8 9 10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 Project Start-up 2 Team training & briefing 2 1 Set up computer system Define input requirements 1 Source input requirements 1 1 Trial with manual input 1 Develop interfaces 1 Trial run thru’ interfaces Produce draft reports 1 Business review meeting 1 Develop documentation 2 Handover of system 2 Debrief 2 Weeks 1 2 3 4 5 6 7 8 9 10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 2 2 2 2 2 2 2 2 3 3 2 2
Planning and control tools • Gantt chart can be set up on Excel spreadsheet; • Draw schedule bars using cell shade function; • Add up columns and using graphing function to plot resource histogram;
Example:Project Gantt Chart & Resource Histogram in Excel Schedule bars are drawn using the cell pattern function Float drawn using the cell borders function.

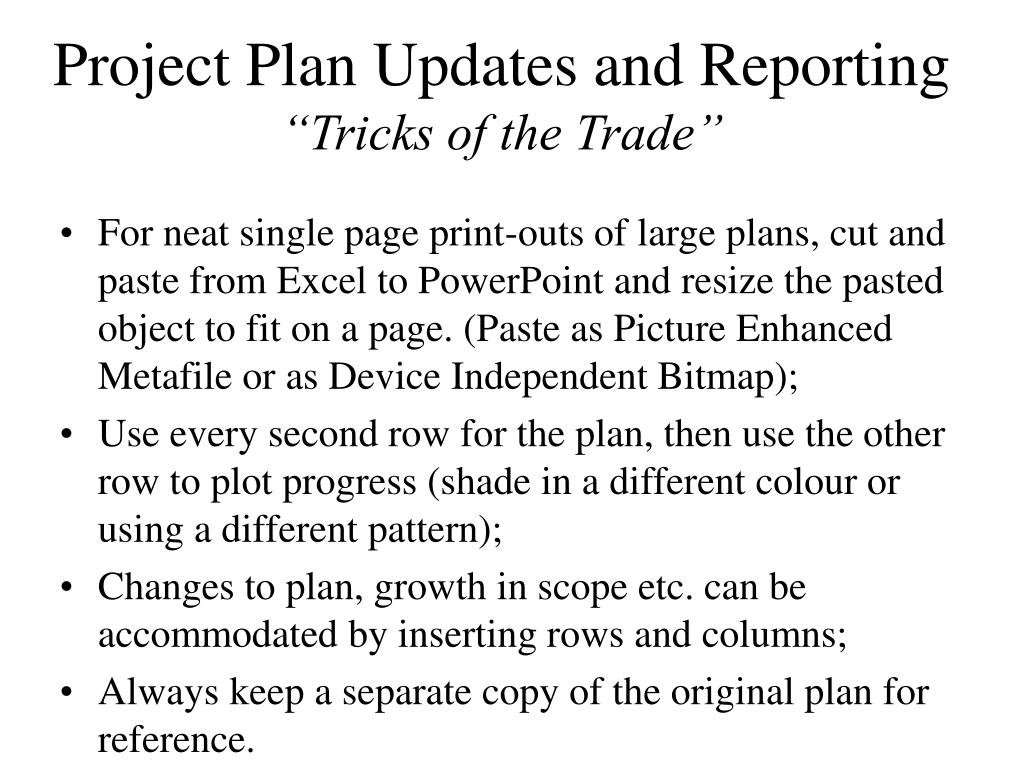

Project Plan Updates and Reporting“Tricks of the Trade” • For neat single page print-outs of large plans, cut and paste from Excel to PowerPoint and resize the pasted object to fit on a page. (Paste as Picture Enhanced Metafile or as Device Independent Bitmap); • Use every second row for the plan, then use the other row to plot progress (shade in a different colour or using a different pattern); • Changes to plan, growth in scope etc. can be accommodated by inserting rows and columns; • Always keep a separate copy of the original plan for reference.
