DOCVIEWER FPP | 10th December 2009 | IKARUPROJECTS
Agenda • Introduction • Project Overview • Architecture and Design • Demo • Process • Planning and Tracking • Reflection Team iGreen
Introductions • Client • Bharat Gorantla • Mentor • Phil Bianco • Team iGreen • Sai Sharan Donthi • Vignesh Murugesan • Vikram Subramanian Team iGreen

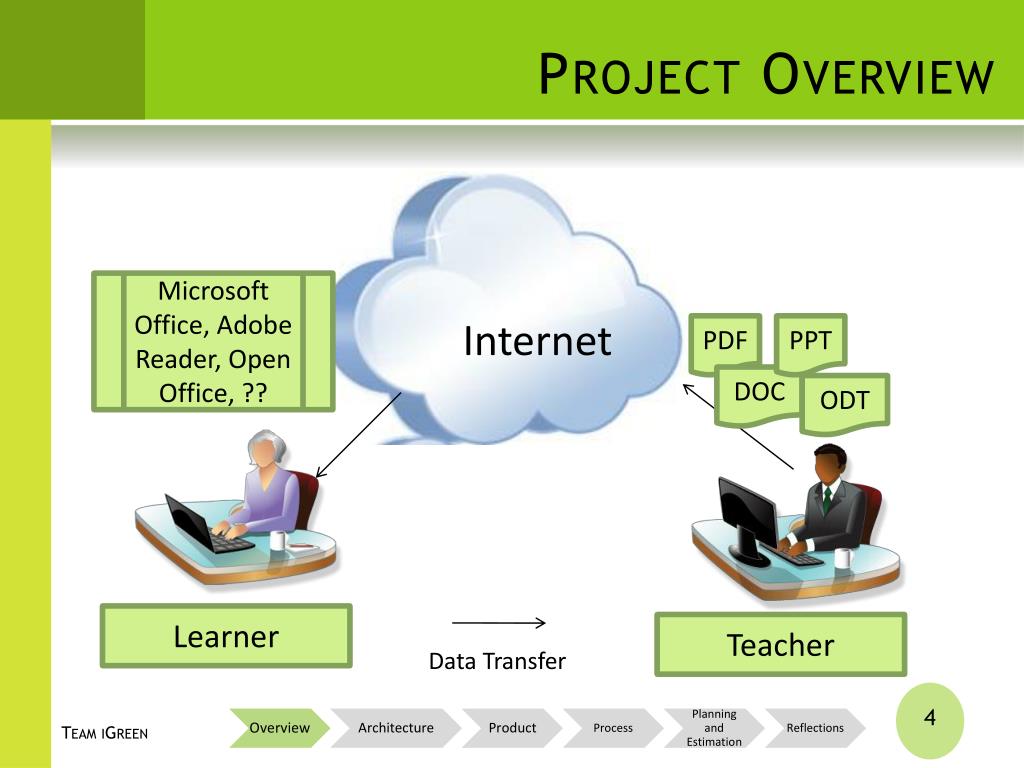

Project Overview Microsoft Office, Adobe Reader, Open Office, ?? Internet PDF PPT DOC ODT Learner Teacher Data Transfer Team iGreen

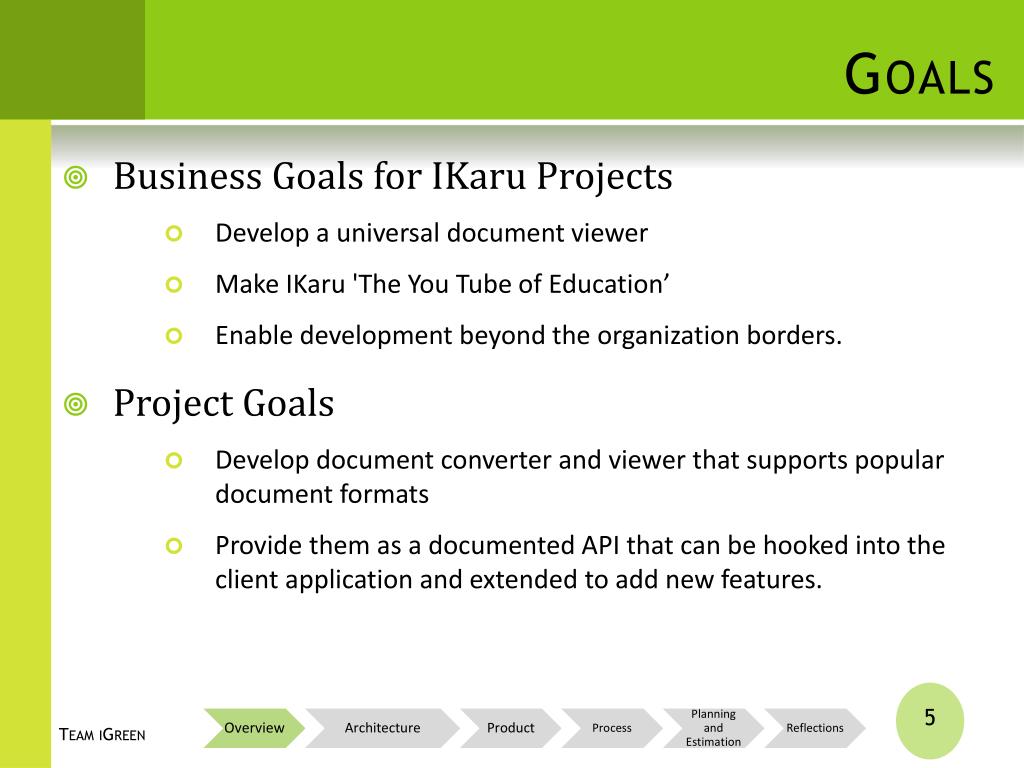

Goals • Business Goals for IKaru Projects • Develop a universal document viewer • Make IKaru 'The You Tube of Education’ • Enable development beyond the organization borders. • Project Goals • Develop document converter and viewer that supports popular document formats • Provide them as a documented API that can be hooked into the client application and extended to add new features. Team iGreen

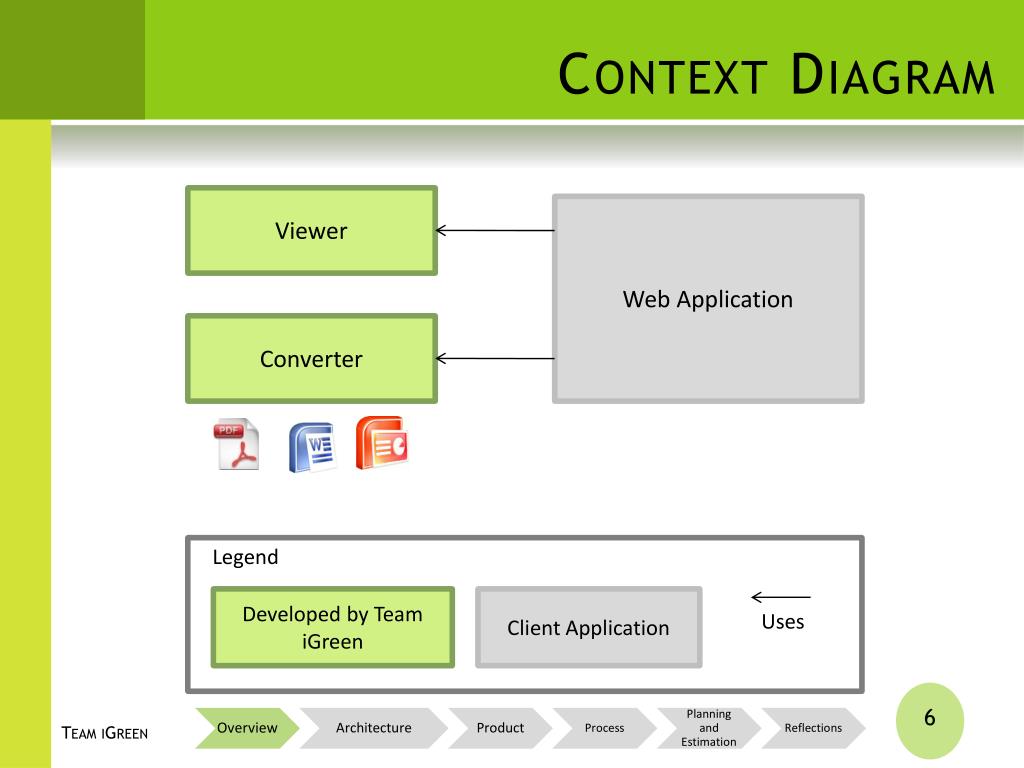

Context Diagram Viewer Web Application Converter Legend Developed by Team iGreen Client Application Uses Team iGreen

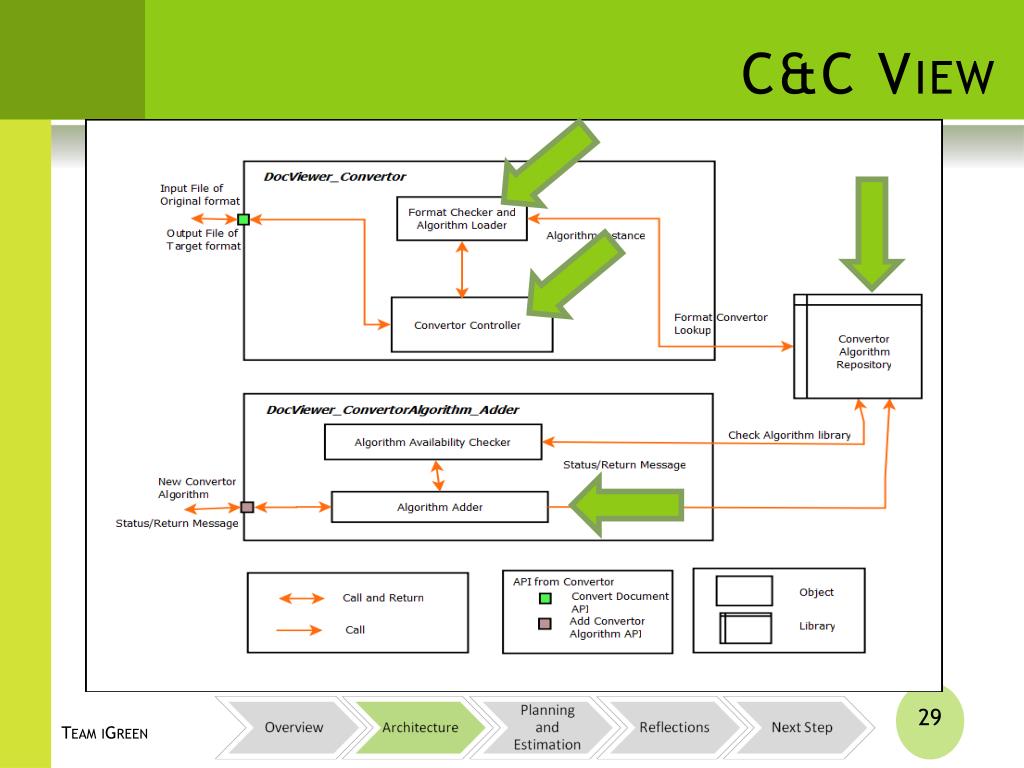

C&C View Team iGreen
Viewer Design Spoke indicates a new screen Team iGreen

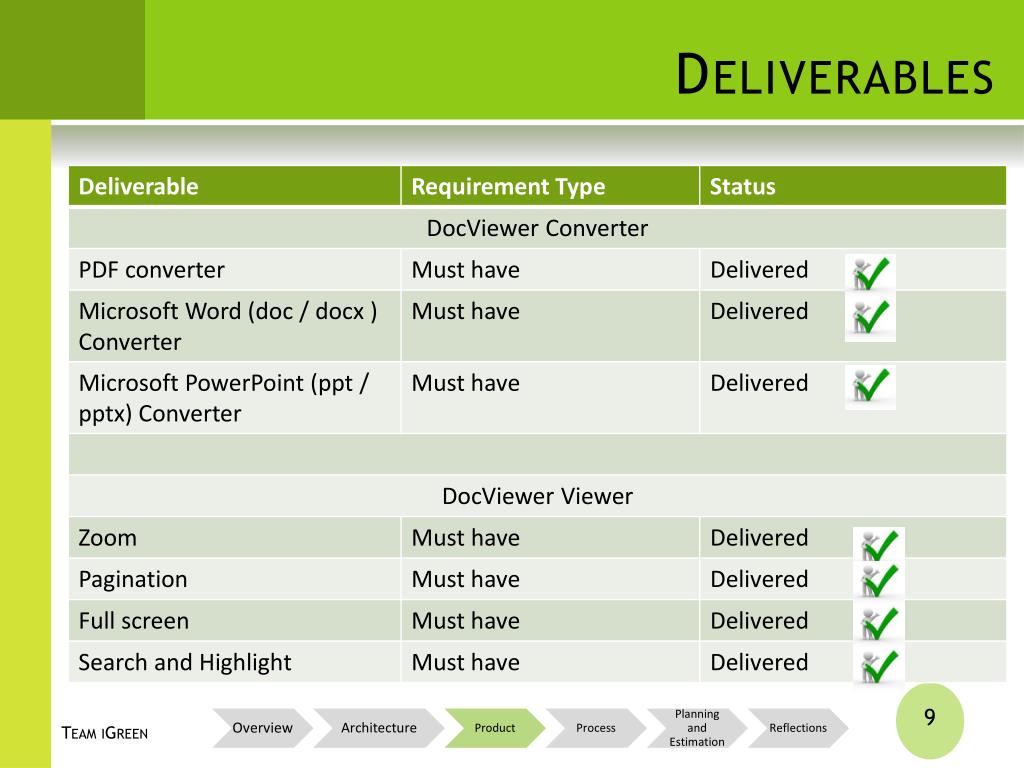

Deliverables Team iGreen
DocViewer - Demo Team iGreen Team iGreen

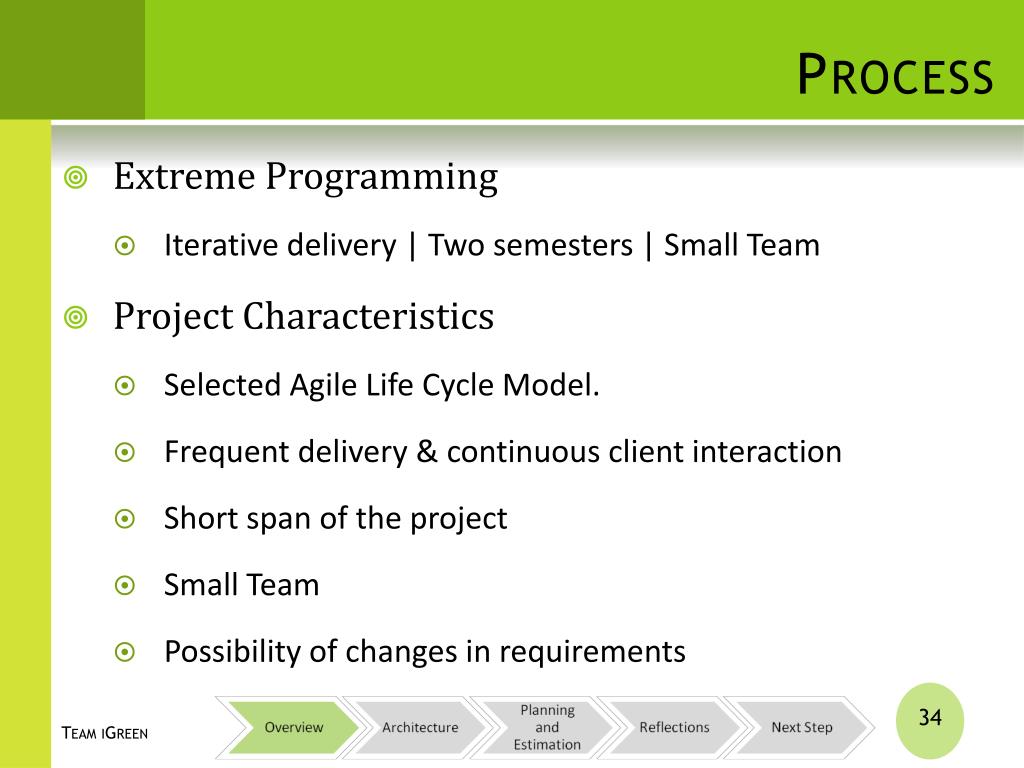

Process • Extreme Programming • Pair Programming • Process for Bug Tracking • Google code repository • Continuous Risk Management | SRE • Risk Identification – At the beginning of Iteration • Risk mitigation strategies | Contingency plans immediately Team iGreen
Planning, Estimation and Tracking Team iGreen

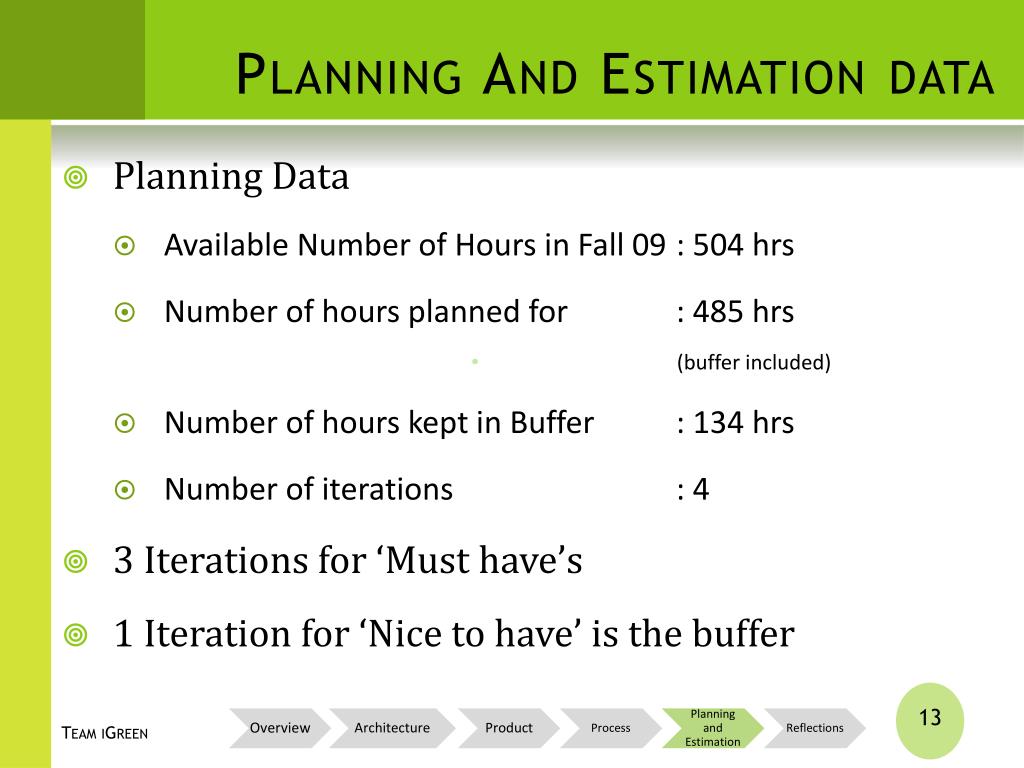

Planning And Estimation data • Planning Data • Available Number of Hours in Fall 09 : 504 hrs • Number of hours planned for : 485 hrs • (buffer included) • Number of hours kept in Buffer : 134 hrs • Number of iterations : 4 • 3 Iterations for ‘Must have’s • 1 Iteration for ‘Nice to have’ is the buffer Team iGreen

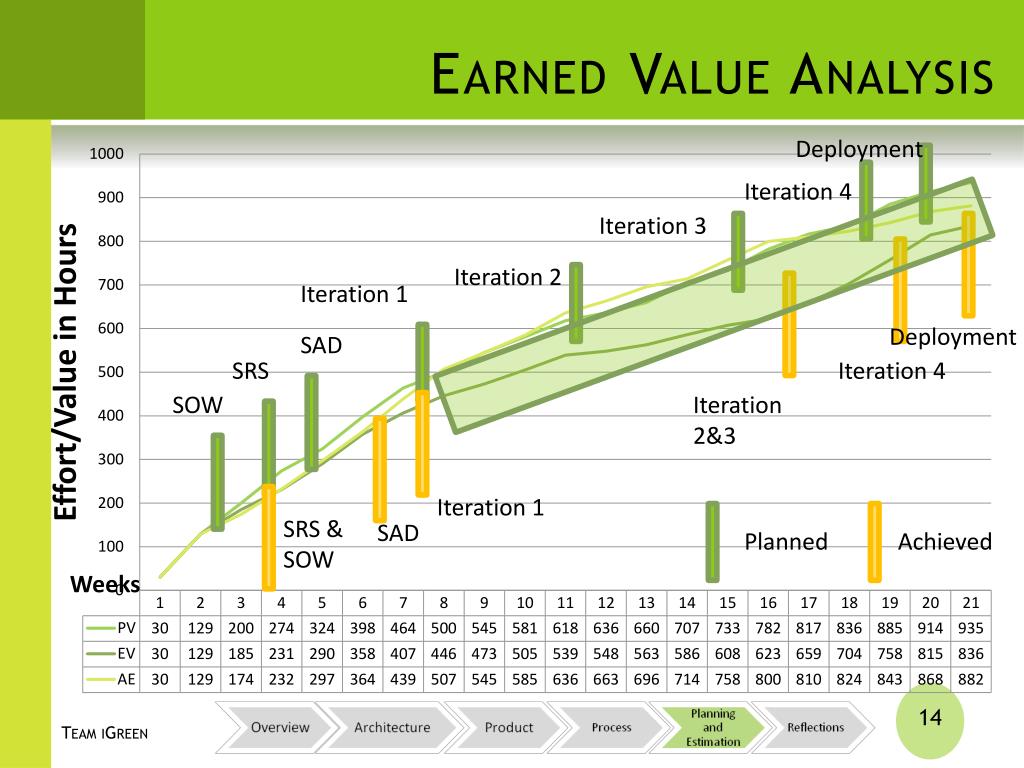

Earned Value Analysis Deployment Iteration 4 Iteration 3 Iteration 2 Iteration 1 Deployment SAD SRS Iteration 4 SOW Iteration 2&3 Iteration 1 SRS & SOW SAD Planned Achieved Weeks Team iGreen

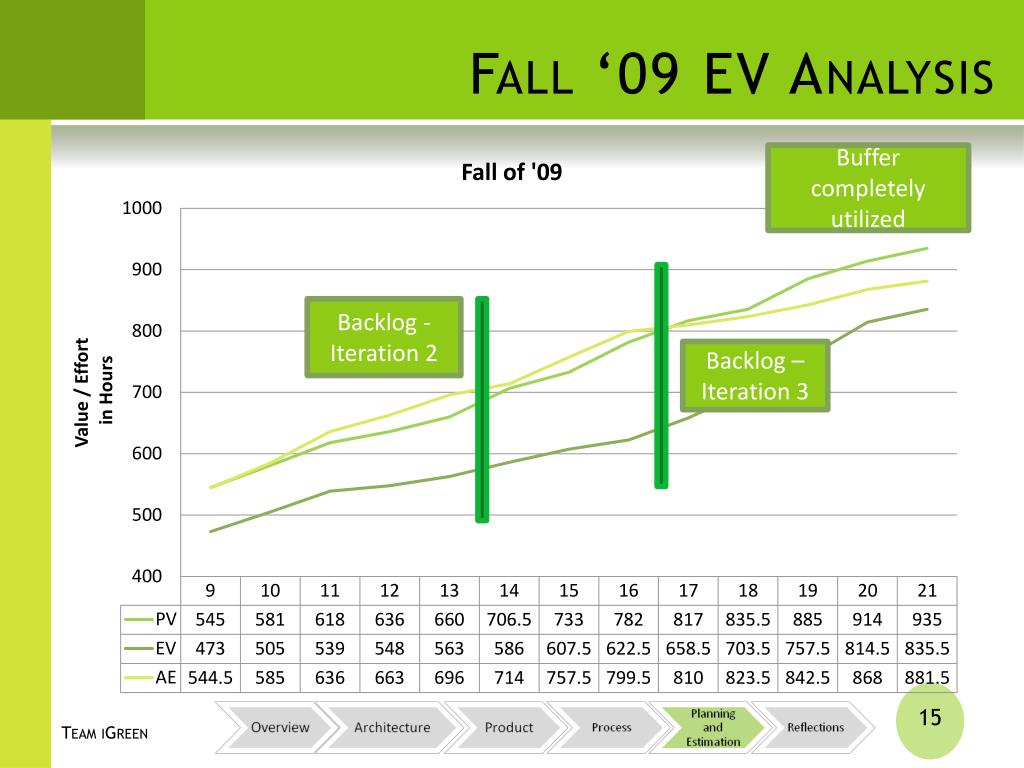

Fall ‘09 EV Analysis Buffer completely utilized Backlog - Iteration 2 Backlog – Iteration 3 Team iGreen

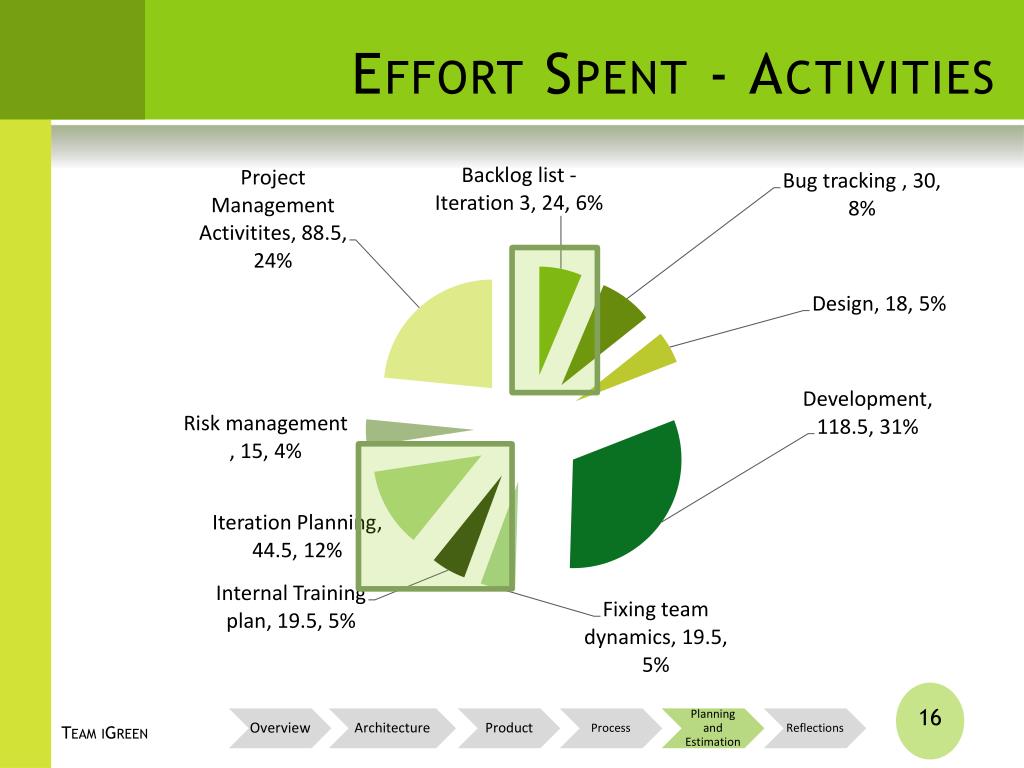

Effort Spent - Activities Team iGreen
Reflections Team iGreen
Reflections • Evaluation parameters of a POC • Flex training plan • Tracking enabled revisions in plan • Negotiation of must have features • Re prioritization of features • Re allocation of resources after second plan revision • QAW helped us on focusing on client priority • - Satisfactory | - Excellent| - Didn’t go well Team iGreen

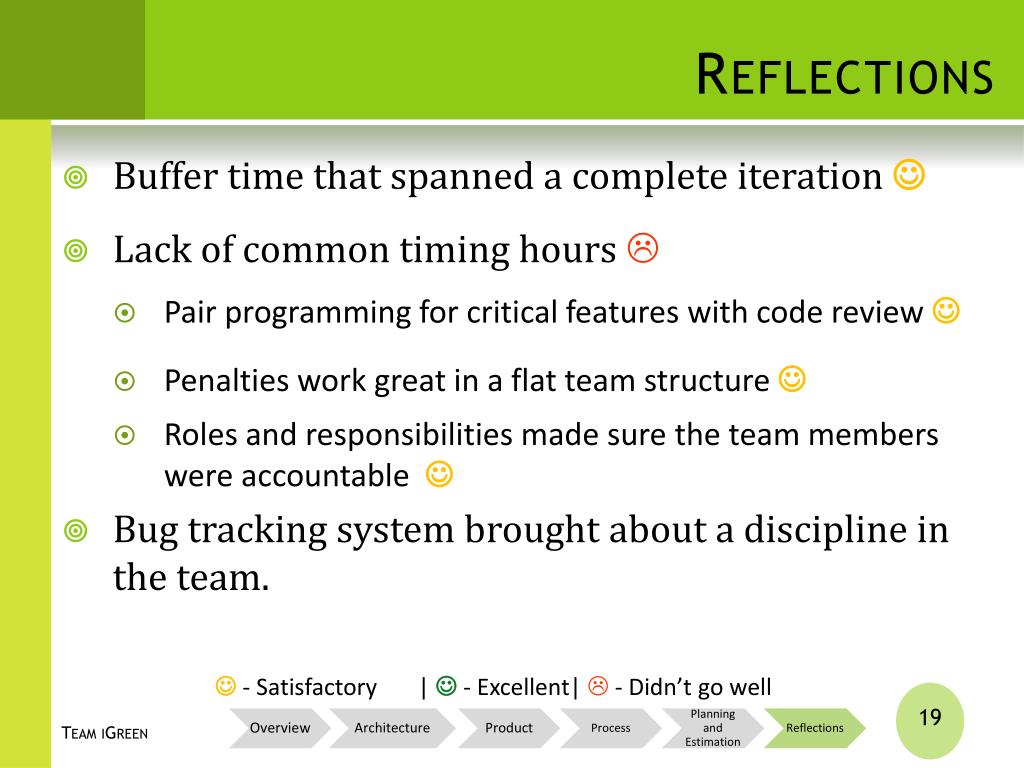

Reflections • Buffer time that spanned a complete iteration • Lack of common timing hours • Pair programming for critical features with code review • Penalties work great in a flat team structure • Roles and responsibilities made sure the team members were accountable • Bug tracking system brought about a discipline in the team. • - Satisfactory | - Excellent| - Didn’t go well Team iGreen
Client Feedback “The iGreen team did a good job in delivering an application that met our needs. The project posed a number of challenges, but the team overcame them with great enthusiasm and delivered it when it mattered. Overall, Sai, Vignesh and Vikram should be proud of the effort that they have put forward, and I have enjoyed working with them during these last 8 months. “ 1- Can Improve 2-Matched Expectations 3-Exceeded Expectations Team iGreen
Thank You & Questions Acknowledgements: • Design and implementation inputs by Phil Bianco • Estimation and Tracking inputs - Eduaro Miranda • Risk Management inputs - Gil Taran • FPP guidance by Mel and Linda Pesante Bharat Gorantla for his excellent support Team iGreen
Back Up Slides Back Up Slides Team iGreen
Architecture Team iGreen
Document Formats • Adobe PDF • Microsoft Word – doc & docx • Microsoft Powerpoint – ppt & pptx • Open Office Text Document - .odt & .sxw • Open Office Presentation - .odp & .sxi • Adobe Postscript • Microsoft Excel • Open Office Spreadsheet • Plain Text • Rich Text Format Team iGreen
Module & Package View Team iGreen
Allocation View Team iGreen

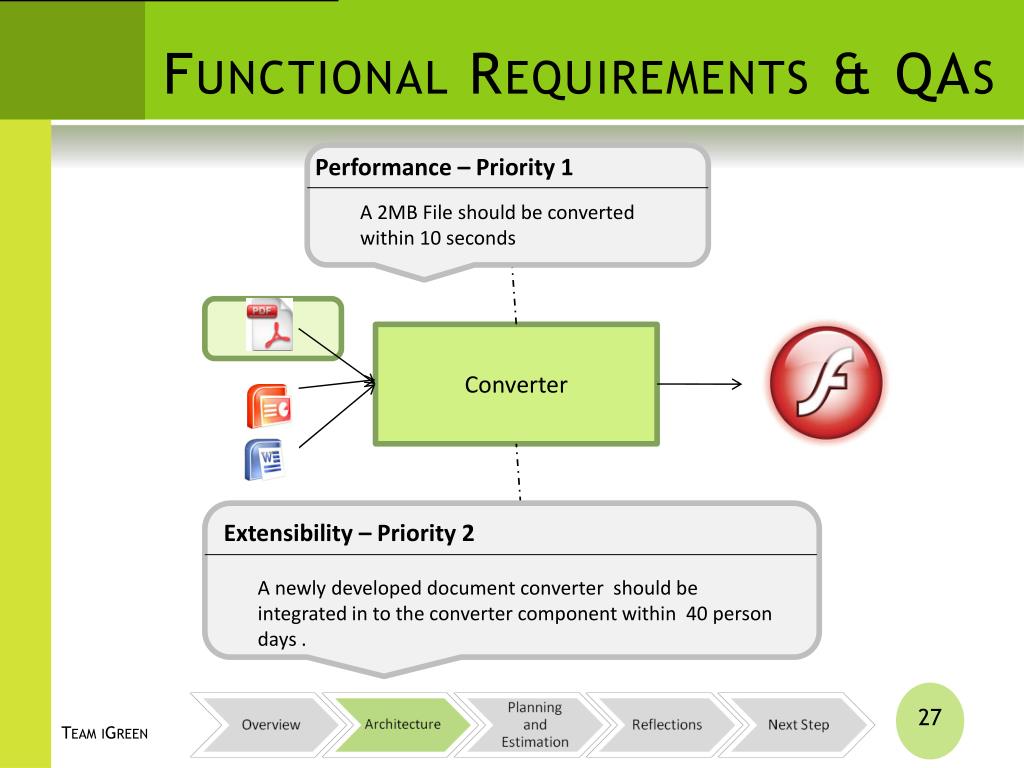

Functional Requirements & QAs Performance – Priority 1 A 2MB File should be converted within 10 seconds Converter Extensibility – Priority 2 A newly developed document converter should be integrated in to the converter component within 40 person days . Team iGreen

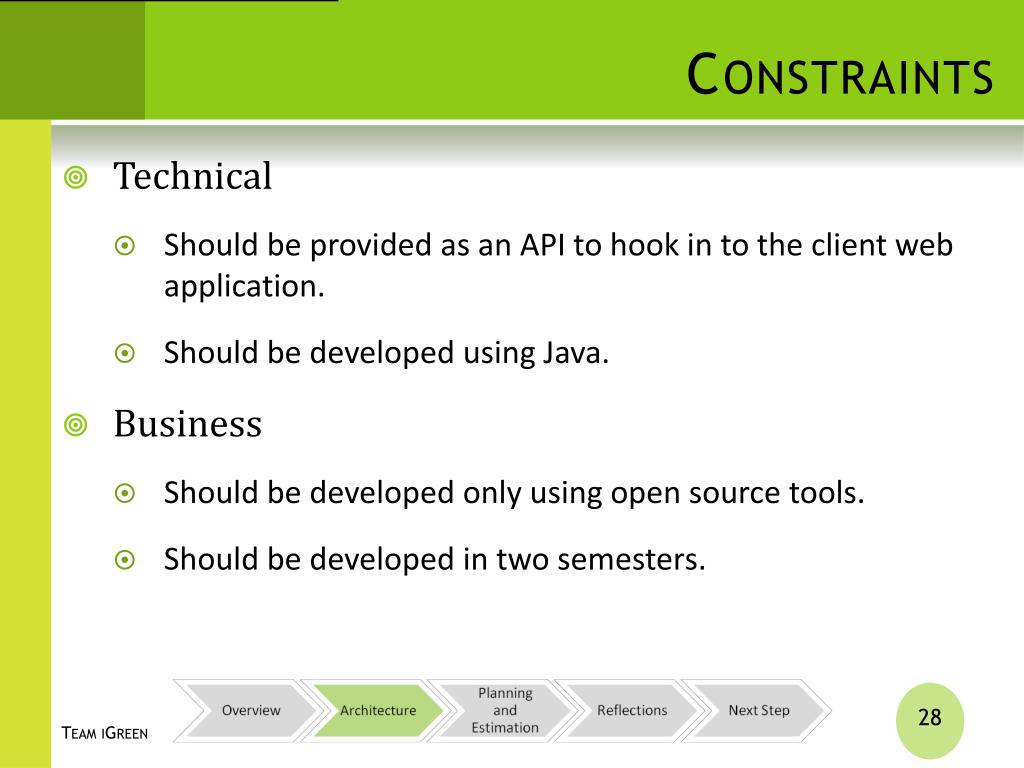

Constraints • Technical • Should be provided as an API to hook in to the client web application. • Should be developed using Java. • Business • Should be developed only using open source tools. • Should be developed in two semesters. Team iGreen

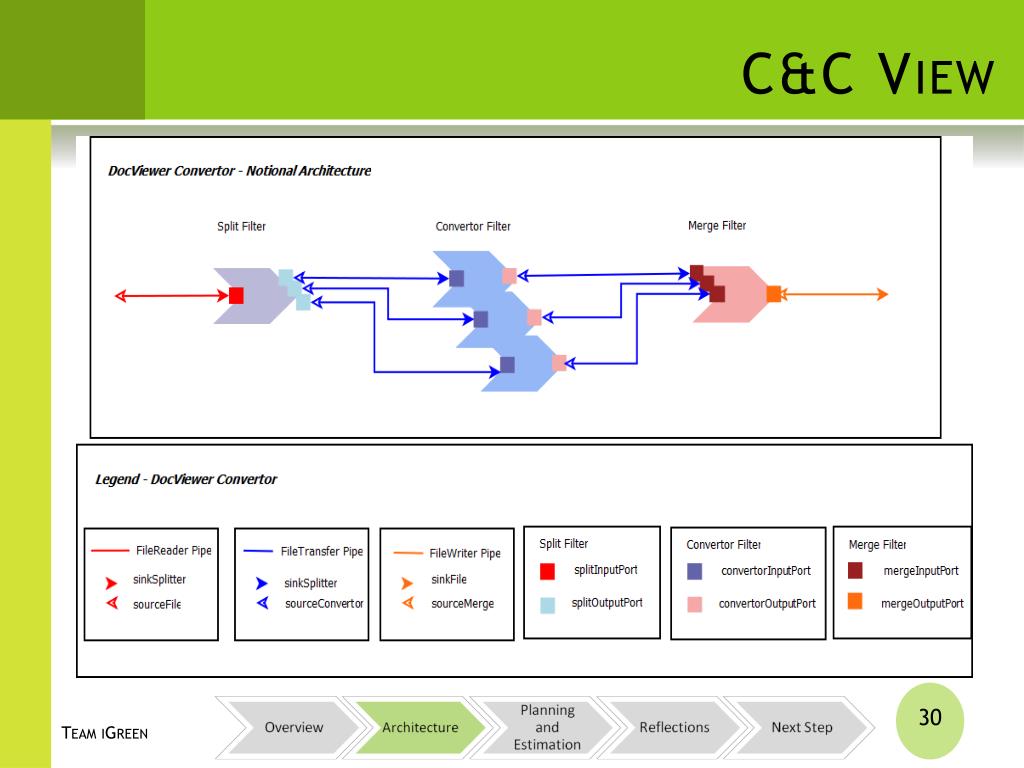

C&C View Team iGreen
C&C View Team iGreen
Requirements Team iGreen
Requirements Team iGreen

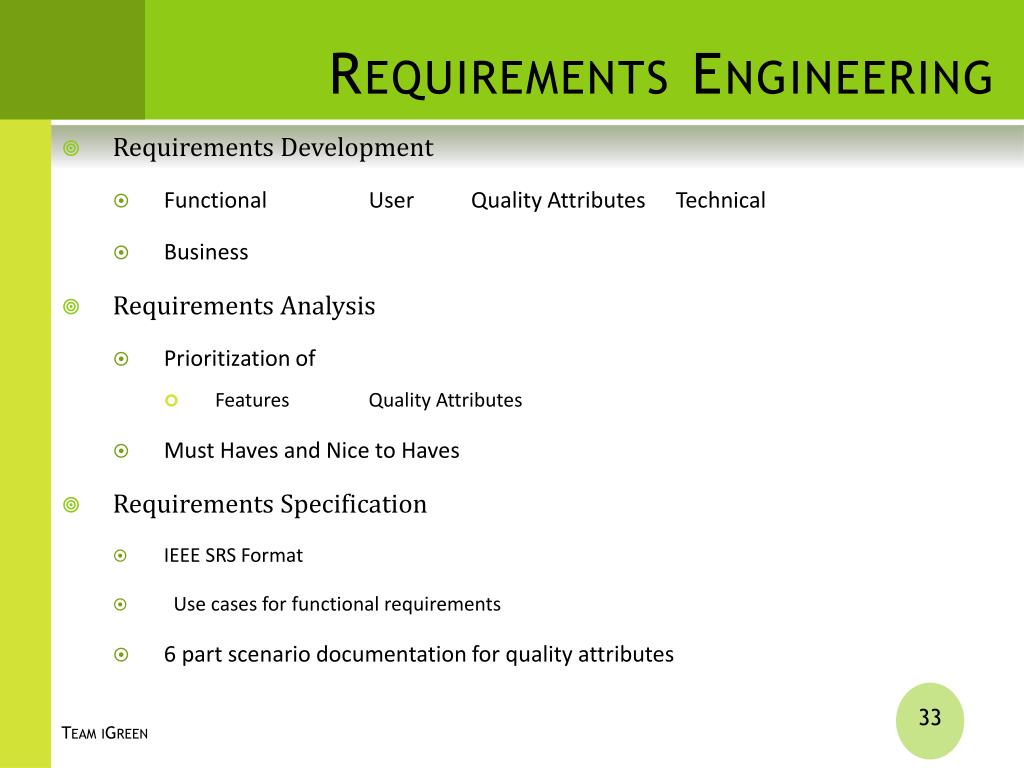

Requirements Engineering • Requirements Development • Functional User Quality Attributes Technical • Business • Requirements Analysis • Prioritization of • Features Quality Attributes • Must Haves and Nice to Haves • Requirements Specification • IEEE SRS Format • Use cases for functional requirements • 6 part scenario documentation for quality attributes Team iGreen
Process • Extreme Programming • Iterative delivery | Two semesters | Small Team • Project Characteristics • Selected Agile Life Cycle Model. • Frequent delivery & continuous client interaction • Short span of the project • Small Team • Possibility of changes in requirements Team iGreen
Planning and Tracking Beware! So much of numbers Team iGreen

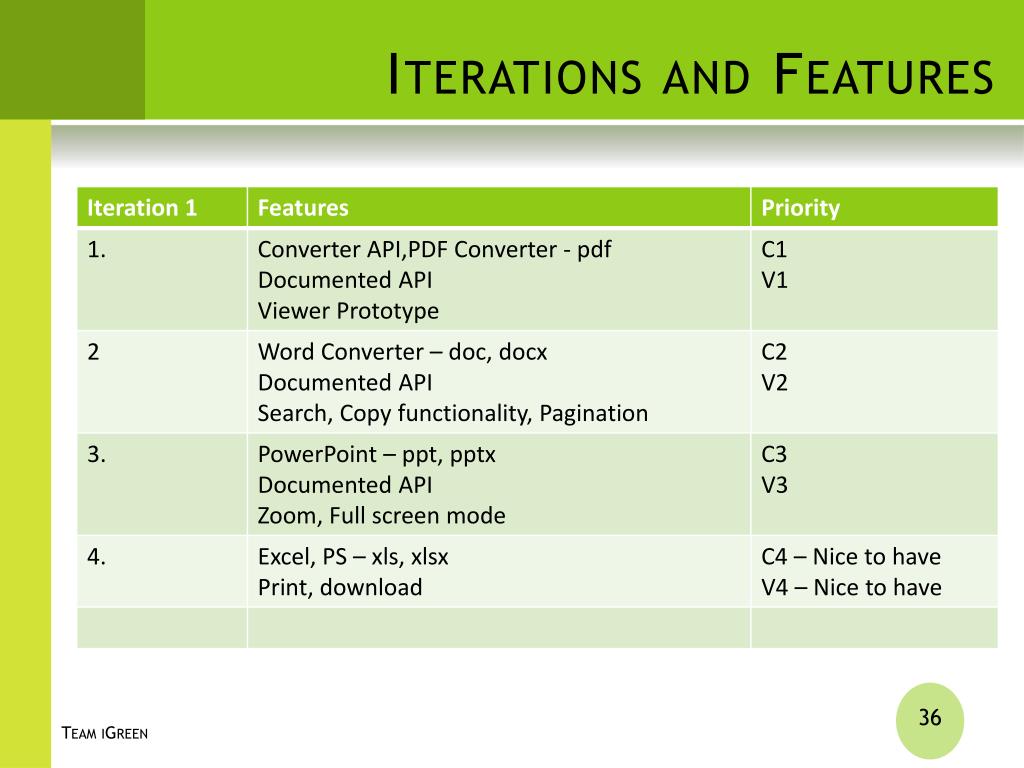

Iterations and Features Team iGreen
Tracking Process • Earned Value Tracking • Granularized Tasks | Effort | Value • Planned Value Baseline • Effort Available | Features | Iterations • Weekly Tracking and Backlog list • Planned Value Baseline | Earned Value for 2 weeks • Example : Once upon a time…in the next slide • Tracking helped us! • Backlog List | Allocation | Time box Team iGreen

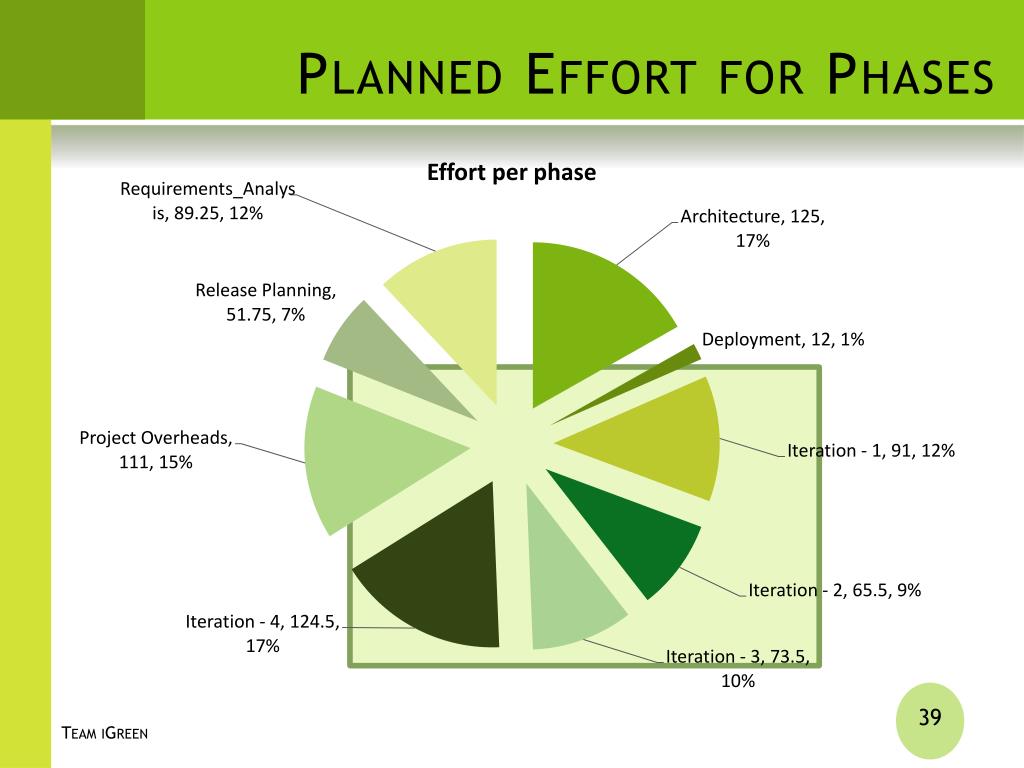

Estimated Effort Split-up Team iGreen
Planned Effort for Phases Team iGreen

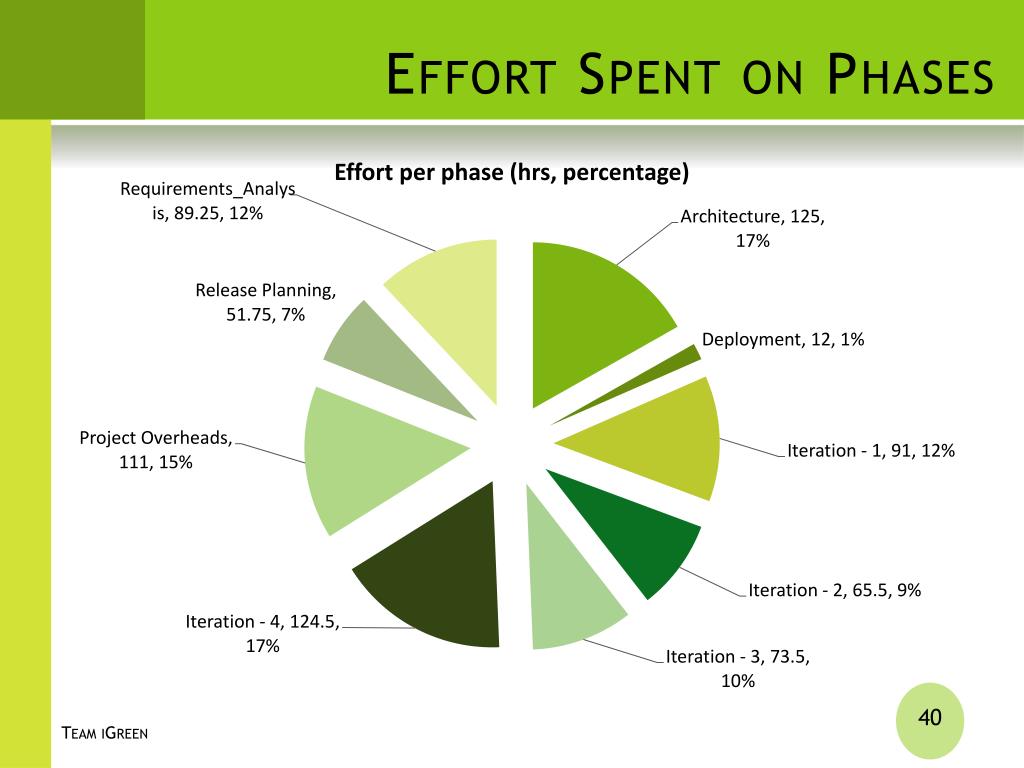

Effort Spent on Phases Team iGreen

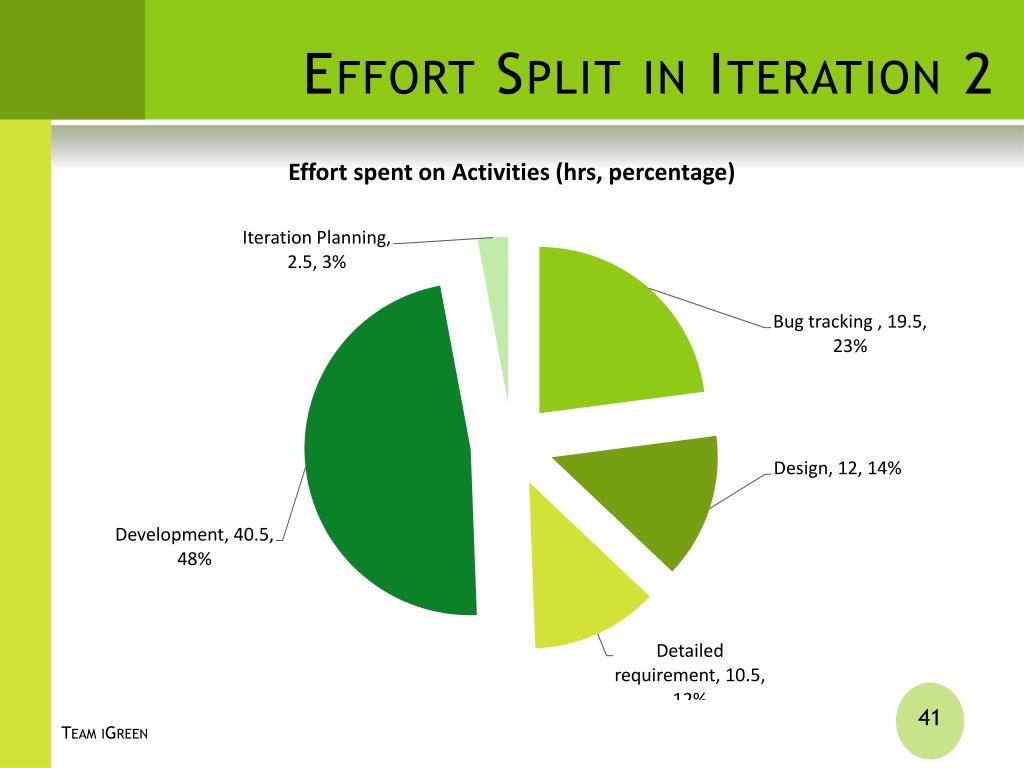

Effort Split in Iteration 2 Team iGreen

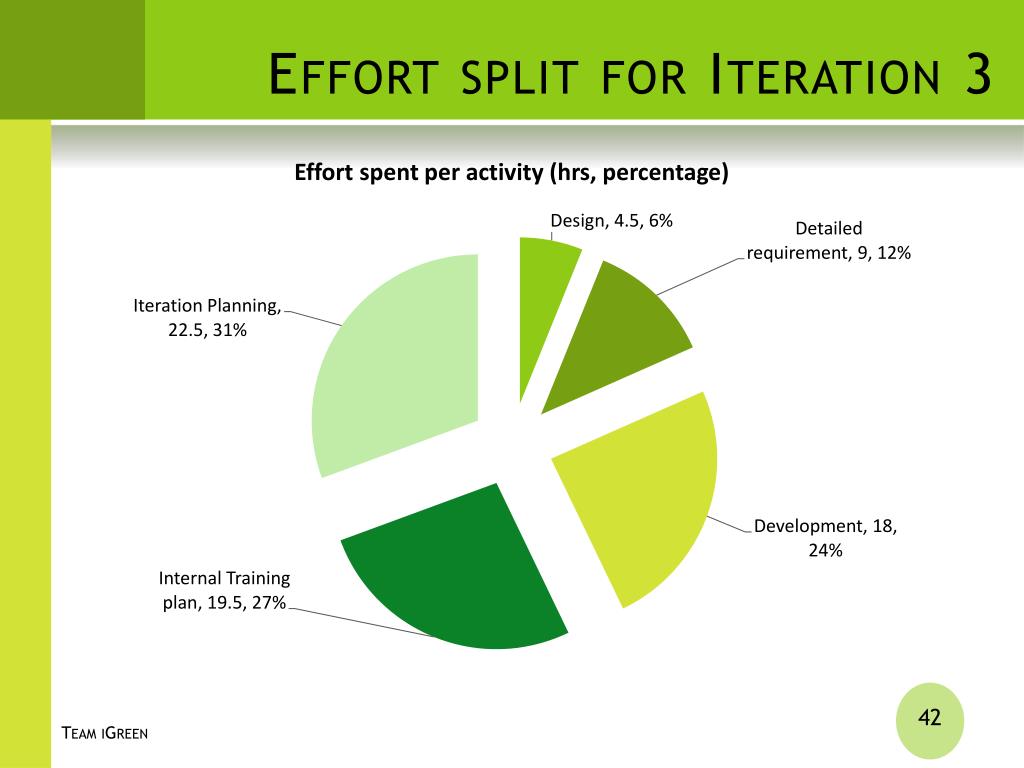

Effort split for Iteration 3 Team iGreen
Effort Spent Split – Iteration 4 Team iGreen

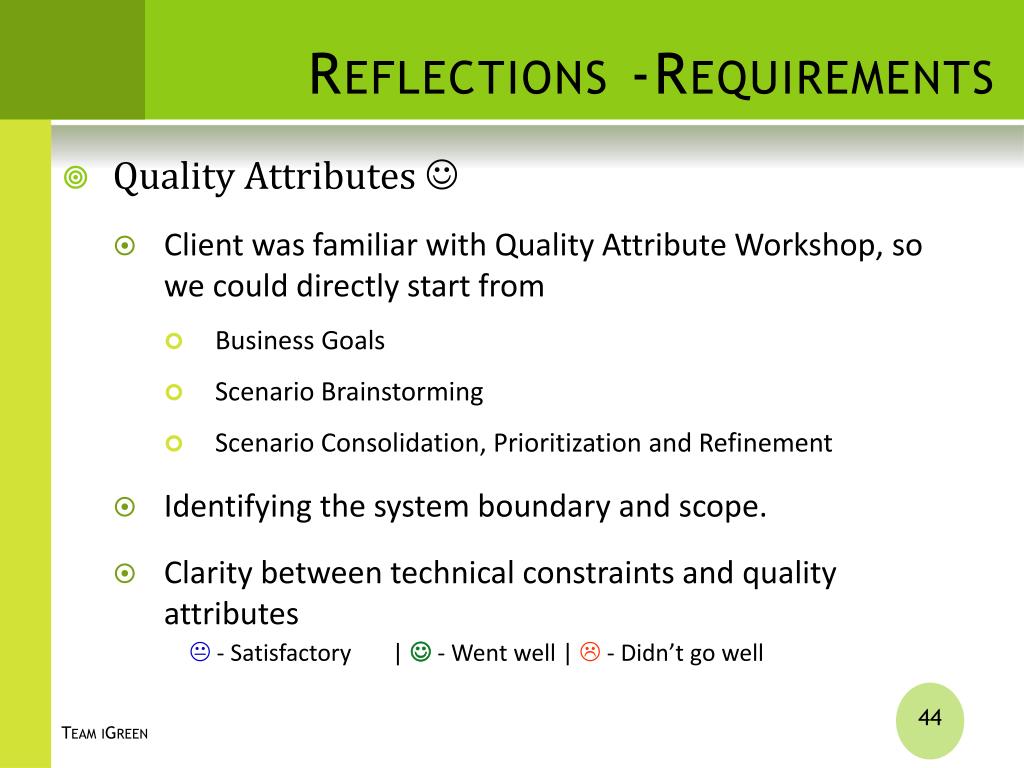

Reflections -Requirements • Quality Attributes • Client was familiar with Quality Attribute Workshop, so we could directly start from • Business Goals • Scenario Brainstorming • Scenario Consolidation, Prioritization and Refinement • Identifying the system boundary and scope. • Clarity between technical constraints and quality attributes • - Satisfactory | - Went well | - Didn’t go well Team iGreen

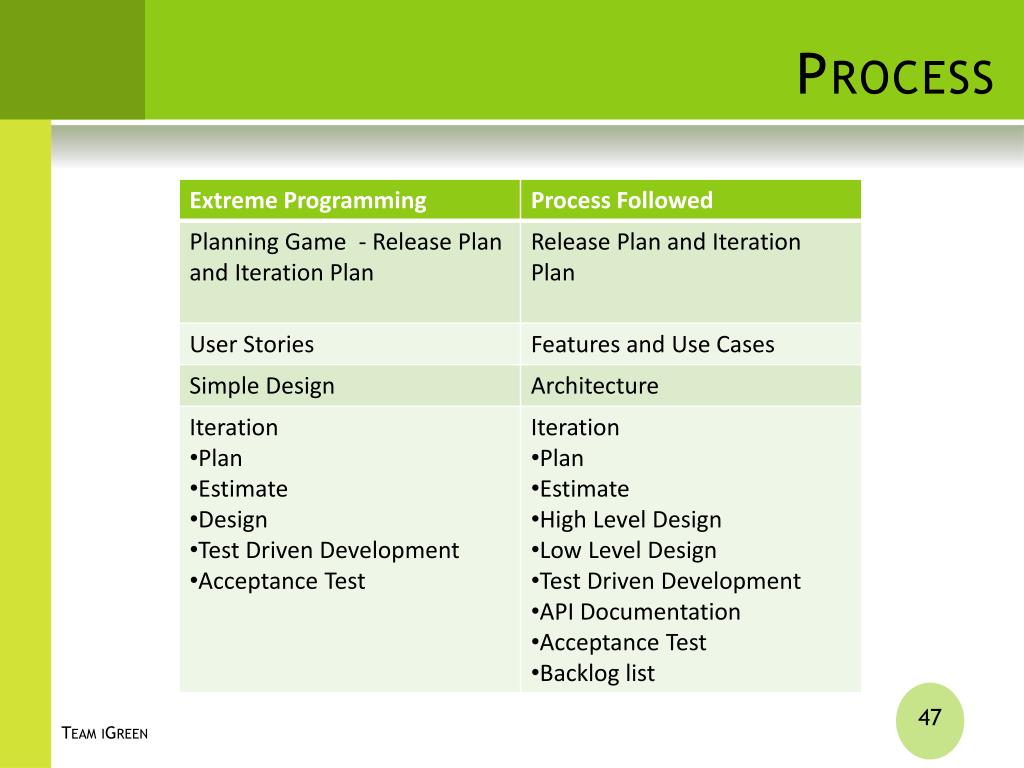

Process Team iGreen
Process Matrix Team iGreen
Process Team iGreen
Architecture Design Process Gather Architectural Drivers Identify Notional Architecture Apply ADD and Refine Architecture Develop Run-Time, Static and Allocation views Review Architecture Legend Activities Control Flow Team iGreen

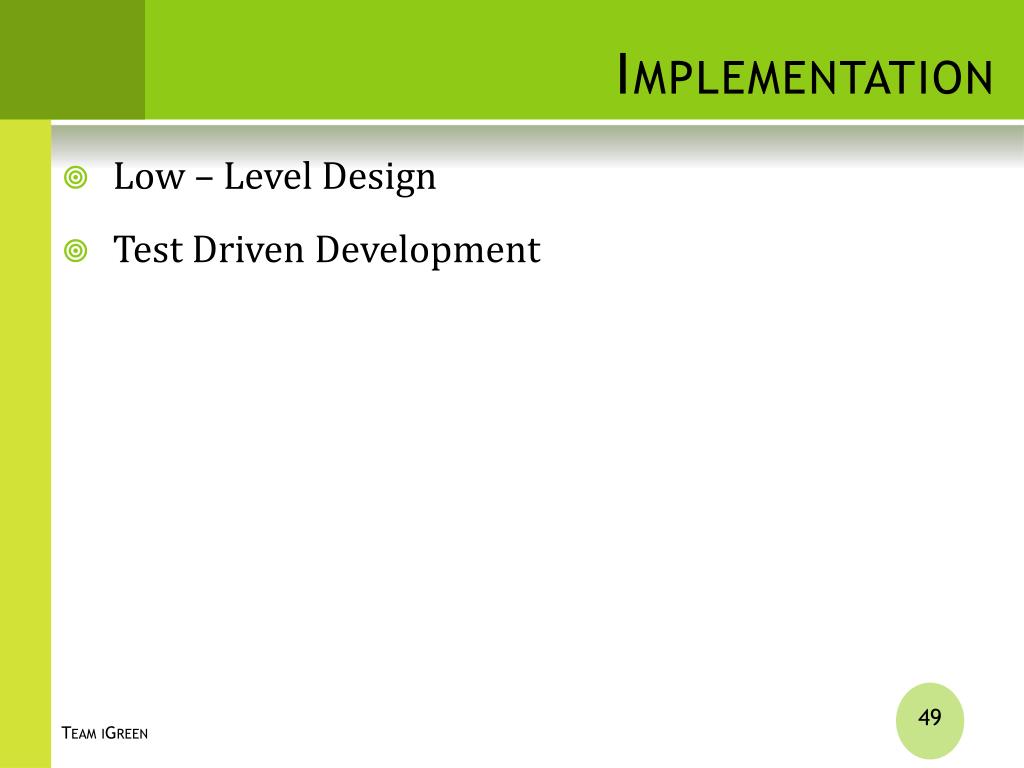

Implementation • Low – Level Design • Test Driven Development Team iGreen
Project Management • People • Project Plan • Tracking and Revising Plan • Risk Management • Reflections Team iGreen
