Spending Plans and Schedule Jae Yu July 26, 2002
Introduction • We (UTA) were successful in persuading DØ collaboration to adopt DØ Regional Analysis Center scheme • A proposal completed • Collaboration had a chance to look at it • World-wide finance committee has well accepted the scheme and enthusiastic about the proposal • Significant amount computing research necessary to implement and employ Grid into DØ • The MRI gave a significant head-start toward UTA becoming an ATLAS Tier II site • Will generate even more significant research for full scale ATLAS Grid implementation Jae Yu: MRI 2002 Meeting

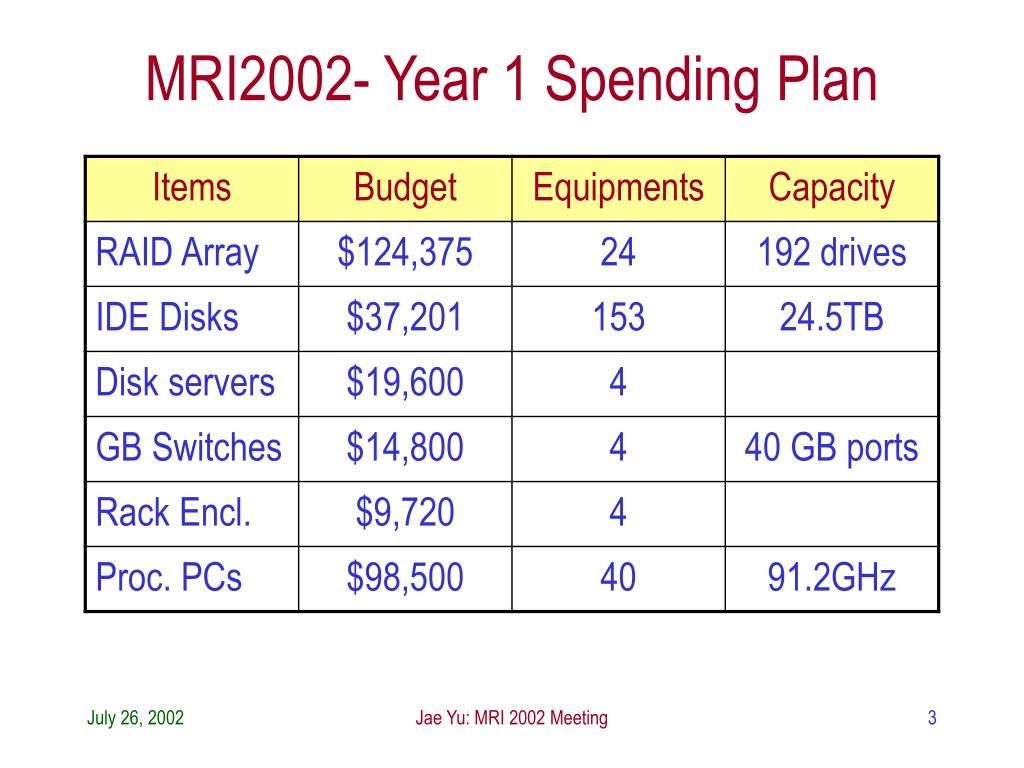

MRI2002- Year 1 Spending Plan Jae Yu: MRI 2002 Meeting

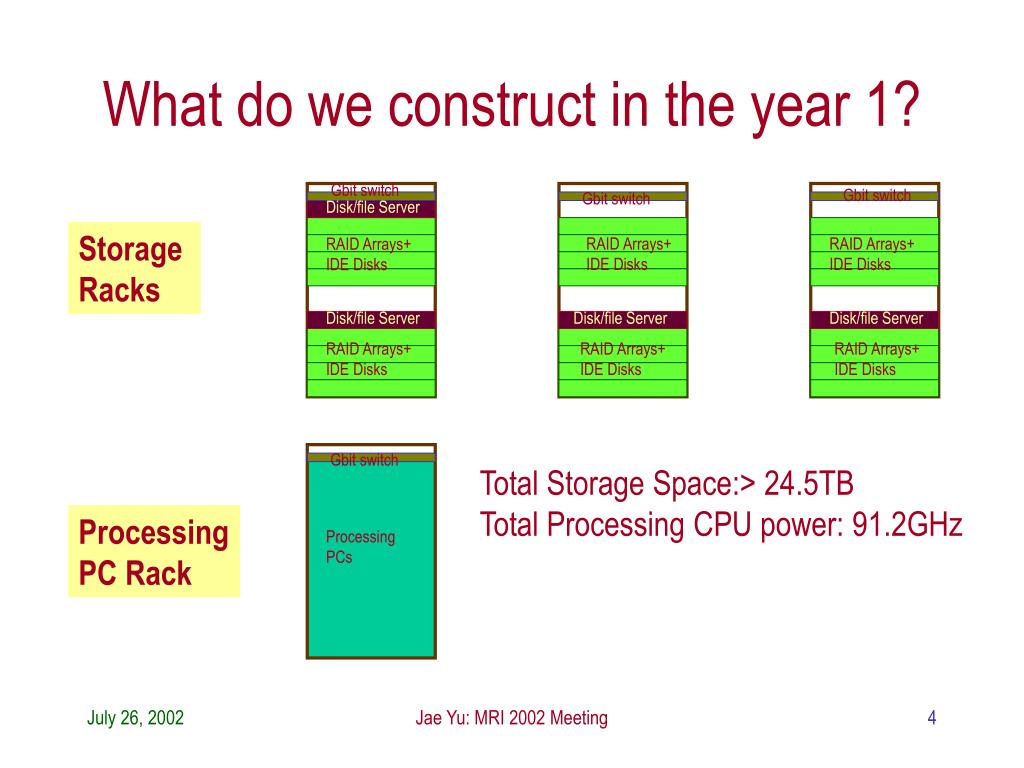

What do we construct in the year 1? Gbit switch Gbit switch Gbit switch Disk/file Server Storage Racks RAID Arrays+ IDE Disks RAID Arrays+ IDE Disks RAID Arrays+ IDE Disks Disk/file Server Disk/file Server Disk/file Server RAID Arrays+ IDE Disks RAID Arrays+ IDE Disks RAID Arrays+ IDE Disks Gbit switch Total Storage Space:> 24.5TB Total Processing CPU power: 91.2GHz Processing PC Rack Processing PCs Jae Yu: MRI 2002 Meeting

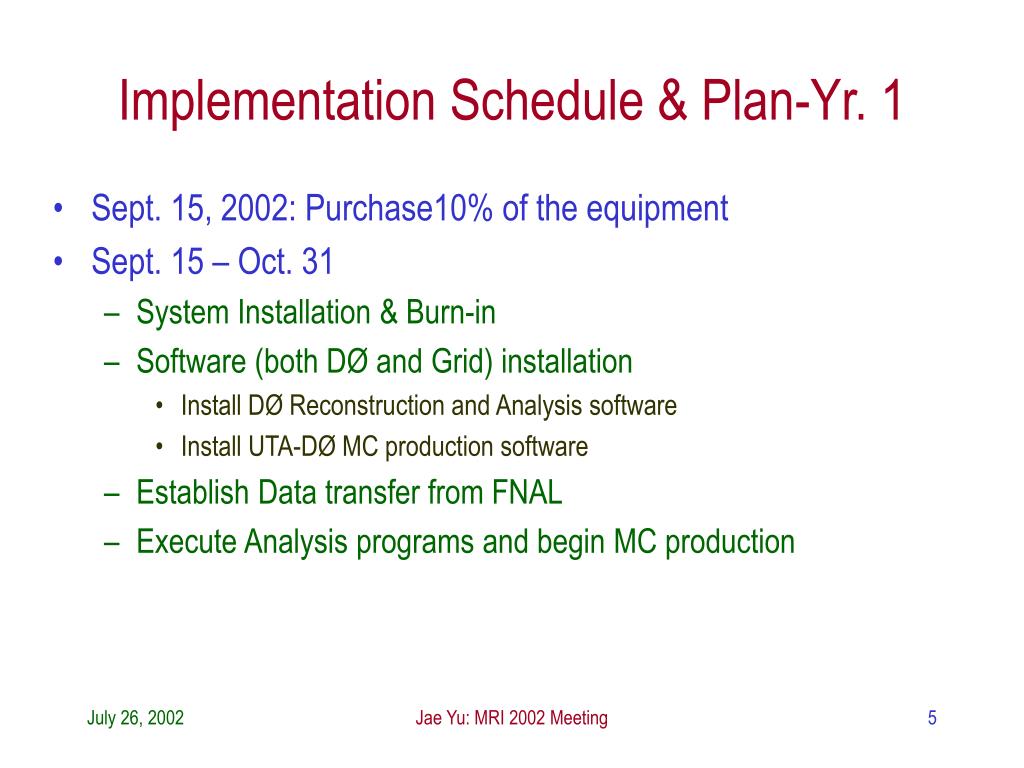

Implementation Schedule & Plan-Yr. 1 • Sept. 15, 2002: Purchase10% of the equipment • Sept. 15 – Oct. 31 • System Installation & Burn-in • Software (both DØ and Grid) installation • Install DØ Reconstruction and Analysis software • Install UTA-DØ MC production software • Establish Data transfer from FNAL • Execute Analysis programs and begin MC production Jae Yu: MRI 2002 Meeting
Yr. 1 Implementation-cont’d • Oct. 31, 2002: Complete purchasing the Remainder • Oct. 31 – Dec. 31, 2002: • System Installation and Burn-in • Software (both DØ and Grid) installation • Constant transfer and fill disks with DØ Data • Establish and implement Grid enabled batch control system • Establish user pool to become a DØRAC • Start DØ Reconstruction • Jan. 2003: DØRAC workshop Jae Yu: MRI 2002 Meeting
Necessary Venders • Fiber channel IDE RAID array venders • IDE DISK venders • Processing farm PC and disk/file server venders • Gbit switch venders • RACK enclosure venders Jae Yu: MRI 2002 Meeting
Where do we want to be in the year 2005? • A proposal to the DØ collaboration has been written and submitted to establish DØ Regional Analysis Centers • We want to become a DØ RAC w/ the following minimum capacity • Disk Storage Capacity: >110TB (Need additional 85.5TB) • Total Processing CPU power: >400 GHz (Need additional 310GHz) • Network: Minimum 1GBit/sec outside connection • Person power: 2 system support (Need one more) • Tape storage: >70TB (Don’t have this yet) • Ultimately become an ATLAS Tier II site, building upon this infrastructure Jae Yu: MRI 2002 Meeting

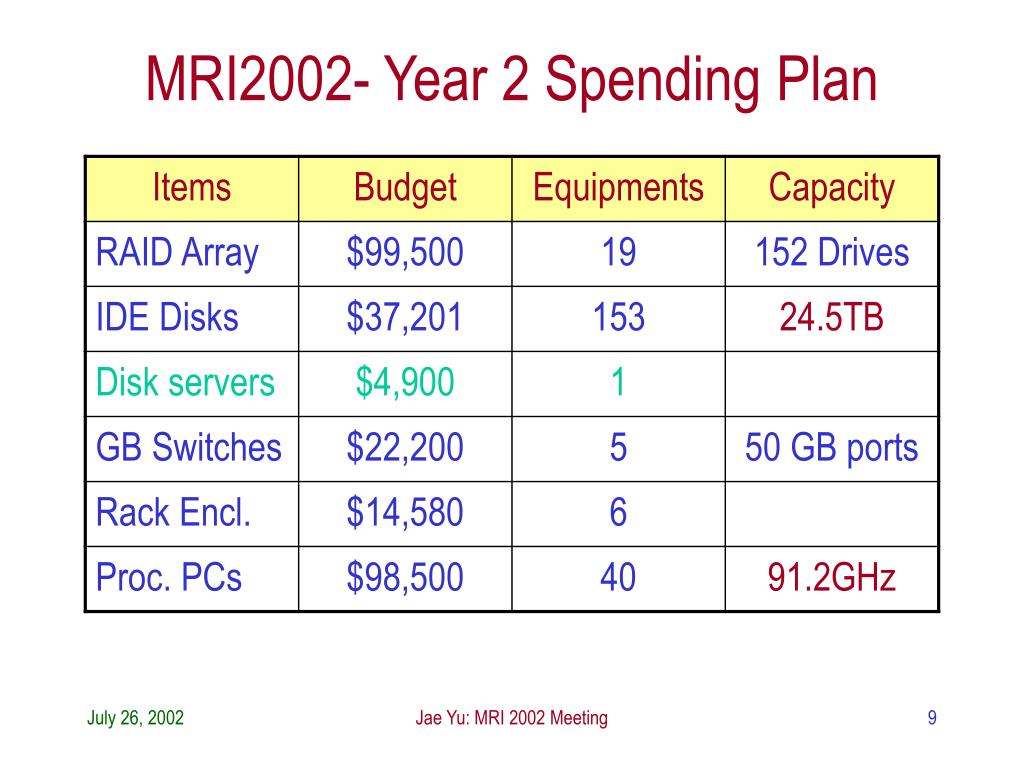

MRI2002- Year 2 Spending Plan Jae Yu: MRI 2002 Meeting
MRI2002- Year 3 Spending Plan Jae Yu: MRI 2002 Meeting
