1 / 13

Oracle APS and GOP – Getting To Automated Sales Order Scheduling

Oracle APS and GOP – Getting To Automated Sales Order Scheduling. Mark Hopkins, Xilinx, Inc. 1/17/06. Topics. Goals of Our GOP Implementation Where We Are Today How We Did It Lessons Learned. Project Goals. Schedule new sales orders accurately Hit our first commitment

agalia
Download Presentation

Oracle APS and GOP – Getting To Automated Sales Order Scheduling

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. Oracle APS and GOP – Getting To Automated Sales Order Scheduling Mark Hopkins, Xilinx, Inc. 1/17/06 Xilinx Confidential

  2. Topics • Goals of Our GOP Implementation • Where We Are Today • How We Did It • Lessons Learned Xilinx Confidential

  3. Project Goals • Schedule new sales orders accurately • Hit our first commitment • Minimize reschedules • Preserve excellent on time delivery performance • Manage exceptions, and let the rest happen automatically • Reduce planner workload and allow them to focus on model maintenance Xilinx Confidential

  4. Results: Auto Release And On Time Delivery ~13k Line Items per month. Xilinx Confidential

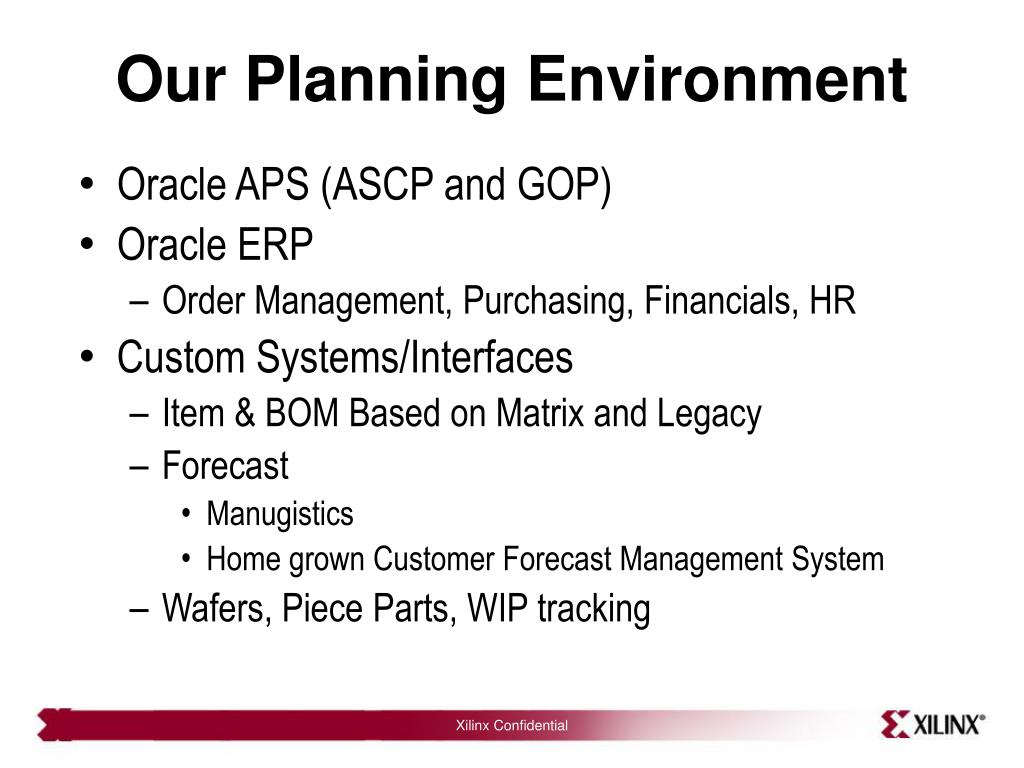

  5. Our Planning Environment • Oracle APS (ASCP and GOP) • Oracle ERP • Order Management, Purchasing, Financials, HR • Custom Systems/Interfaces • Item & BOM Based on Matrix and Legacy • Forecast • Manugistics • Home grown Customer Forecast Management System • Wafers, Piece Parts, WIP tracking Xilinx Confidential

  6. What’s In Production:ASCP and GOP • Monthly / Weekly APS Plan for Wafers and Piece Parts (since April ‘03) • EDD • Unconstrained Plan • Wafer Plan, Piece Parts, Assy, Test, Sort, Bump Capacity • Daily Plan for Assembly Releases (since August ‘04) • ECC • Output is used for all products assembly starts planning • Daily Plan for GOP (since August ‘04) • ECC • Almost 100% of incoming sales orders get schedule dates recommended from GOP Xilinx Confidential

  7. Our Model(example from our ATP Plan) Plan Type: Cost Based Optimized Plan - HP 64bit Exe Enforce Material Constrained Plan Holistic Manufacturing Plan with Project Planning Time Buckets: 35 days, 10 Weeks Inputs: Orgs: 56 Items: 22k Demands: 19k BOM's: 17K Outputs: Demands: 64k Supplies: 56k Pegging: 78k Res Reqmts: 200k Xilinx Confidential

  8. Terms • GOP / ATP – Global Order Promising / Available To Promise • CFD – Current Factory Date (equivalent to Schedule Ship Date in Oracle) • OFD – Original Factory Date (the first commit on the sales order) • ATP Override – The ability to change the date that GOP was recommending prior to committing to the customer • Auto Release – A sales order that books, gets scheduled, and committed to the customer with zero planner intervention Xilinx Confidential

  9. Standard Oracle GOP Process Xilinx Confidential

  10. Xilinx Gates in GOP Process • Is part/whs set up as “auto release?” • Yes: does schedule ship date meet auto release criteria • No: Does planner agree with Schedule Ship Date? • Is calendar date blocked? • Is order on hold? • Is order unusually large? • Do we want to force a particular schedule date to happen (ATP Override?) Xilinx Confidential

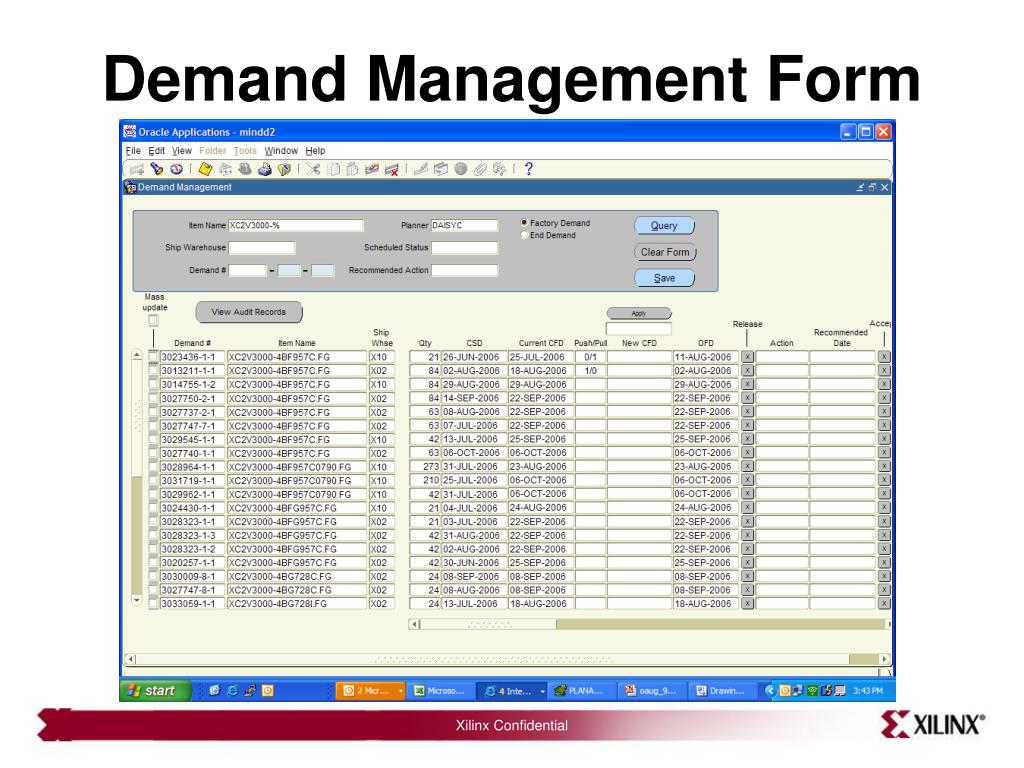

  11. Demand Management Form Xilinx Confidential

  12. Getting to 100% Auto Release • Oracle • Need to consider alternate boms, substitute components in ATP/GOP algorithm. Lack of this functionality causes overly conservative commitments. In semiconductor mfg, this is needed to recognize bin downgrades, alternate mask sets. • ATP Algorithm needs to recognize that an order due 3 months from now can be satisfied with a wafer start. Allow finished goods to show as available for any new orders. • Xilinx • Data Maintenance. Specifically sourcing rules, and BOMs. • Our current BOM structure does not handle some new products / military scenarios. We are working on a new item/bom management system that will give us this. • Lot specific yields for new products. Xilinx Confidential

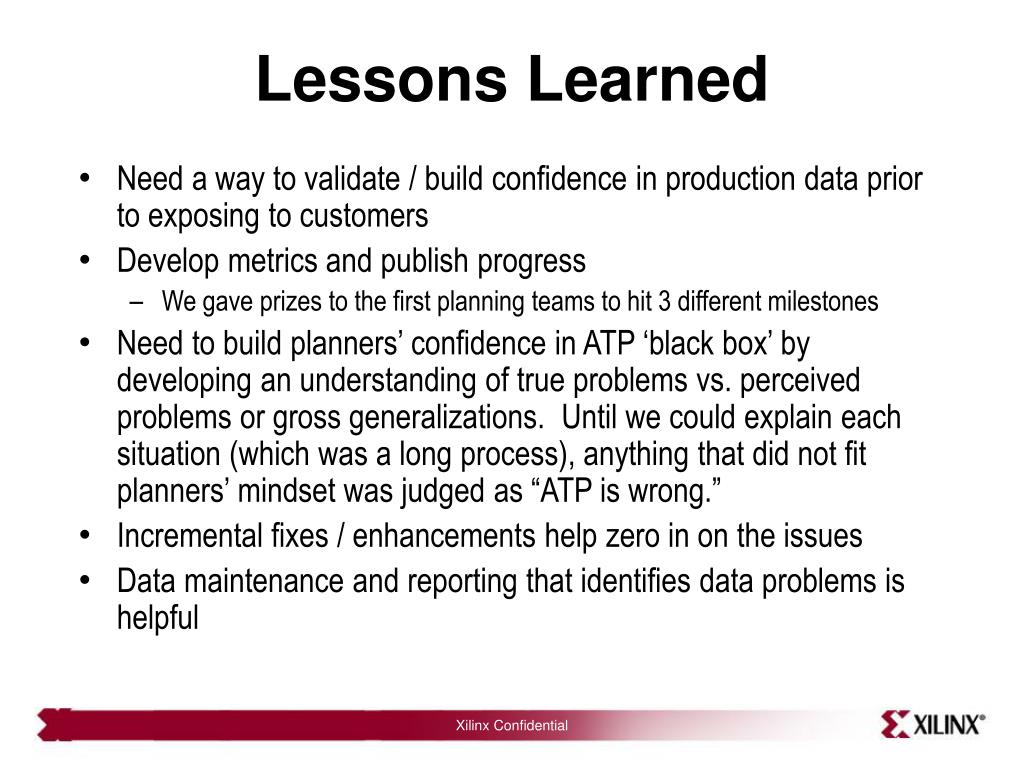

  13. Lessons Learned • Need a way to validate / build confidence in production data prior to exposing to customers • Develop metrics and publish progress • We gave prizes to the first planning teams to hit 3 different milestones • Need to build planners’ confidence in ATP ‘black box’ by developing an understanding of true problems vs. perceived problems or gross generalizations. Until we could explain each situation (which was a long process), anything that did not fit planners’ mindset was judged as “ATP is wrong.” • Incremental fixes / enhancements help zero in on the issues • Data maintenance and reporting that identifies data problems is helpful Xilinx Confidential

More Related
