The Northstar Project update from December 12, 2007, outlines funding sources and project milestones. The total project budget stands at $320 million, with a Federal Transit Administration (FTA) budget of $317.4 million. Key expenditures and known values are documented, alongside a full funding grant schedule and ongoing activities such as bridge support for the LRT, station excavation, and building constructions. This report serves as a comprehensive review of the project’s financial and operational progress towards Northstar's objectives.
E N D
Northstar Project Update MetropolitanCouncilDecember 12, 2007

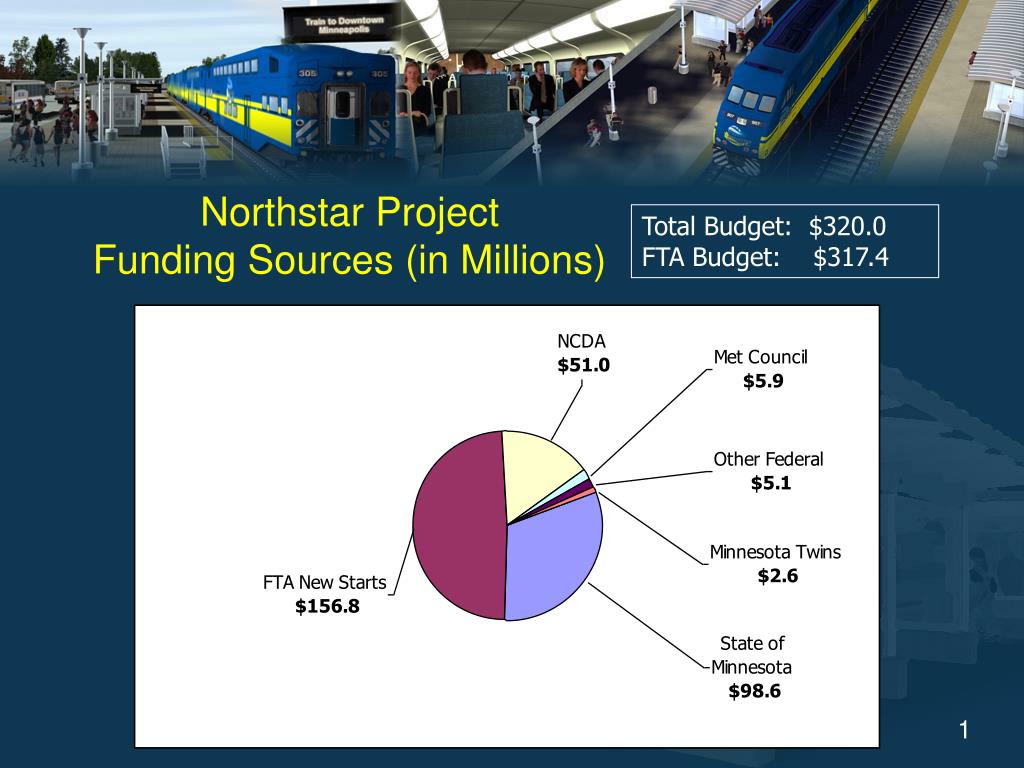

Northstar Project Funding Sources (in Millions) Total Budget: $320.0 FTA Budget: $317.4 Total Budget: $320.0 Total FTA Budget: $317.4 1

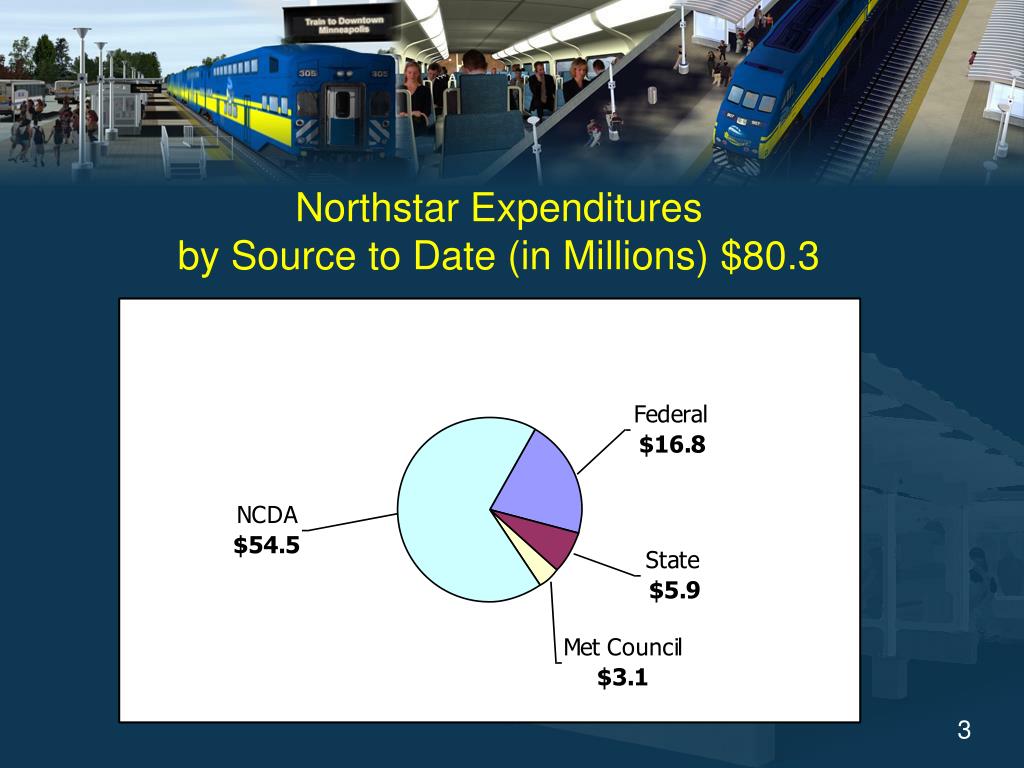

Northstar Expenditures by Source to Date (in Millions) $80.3 3

Minneapolis Station Excavation Removal of rock wall taken from 3rd St bridge looking toward Washington Ave 10

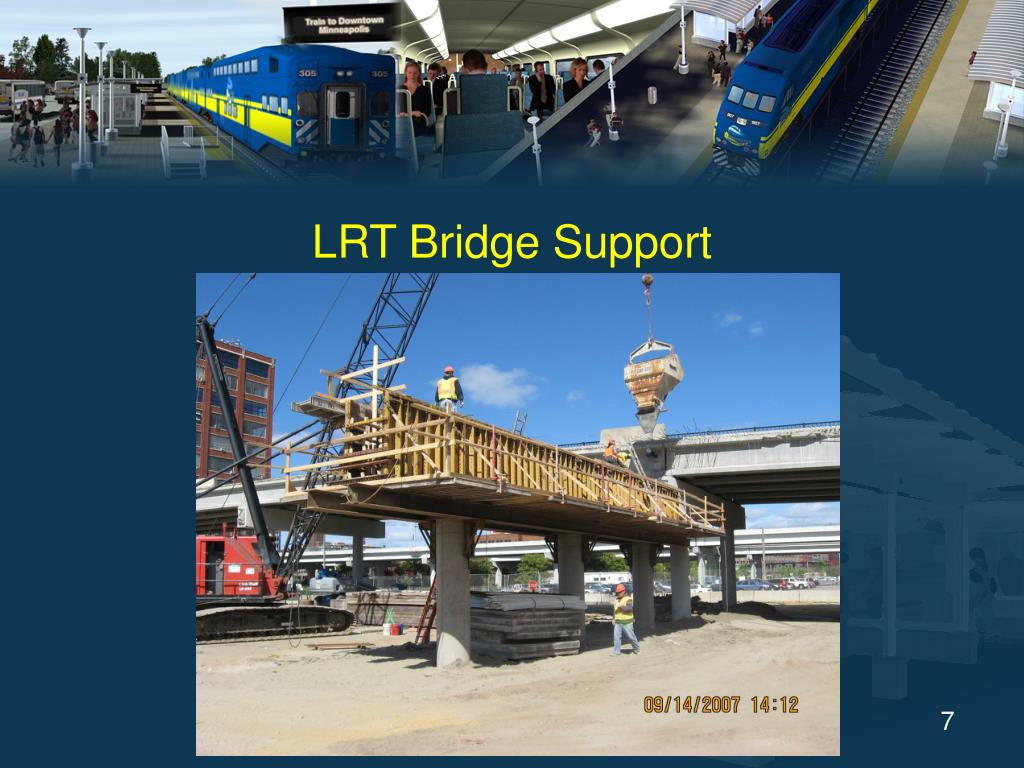

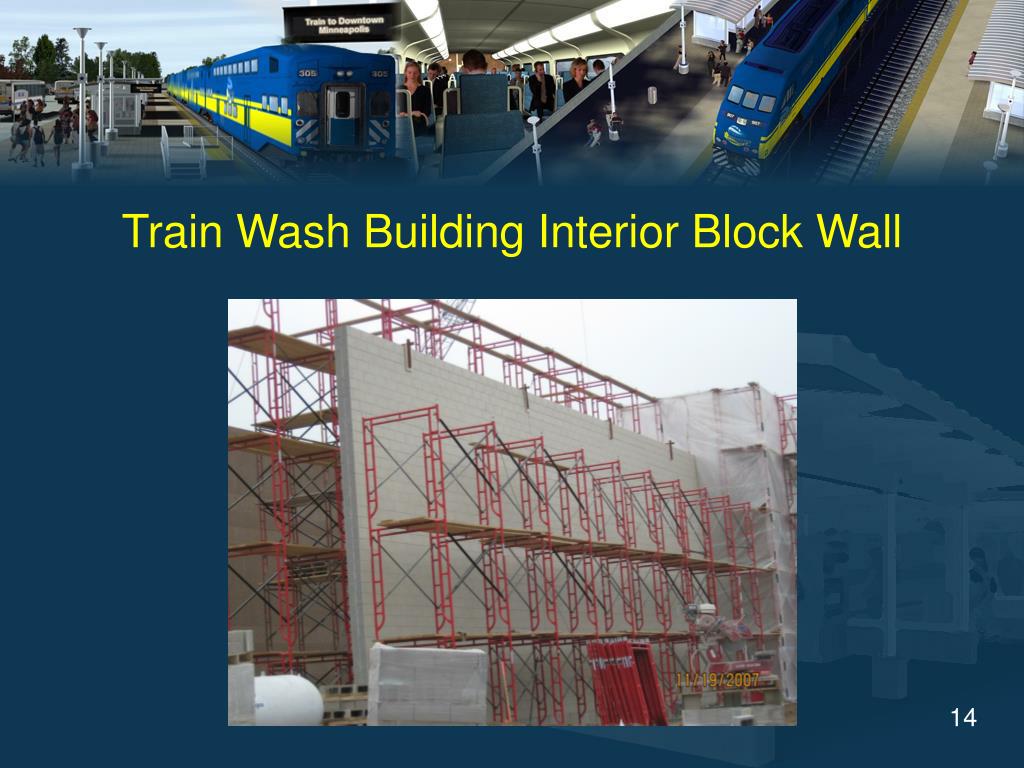

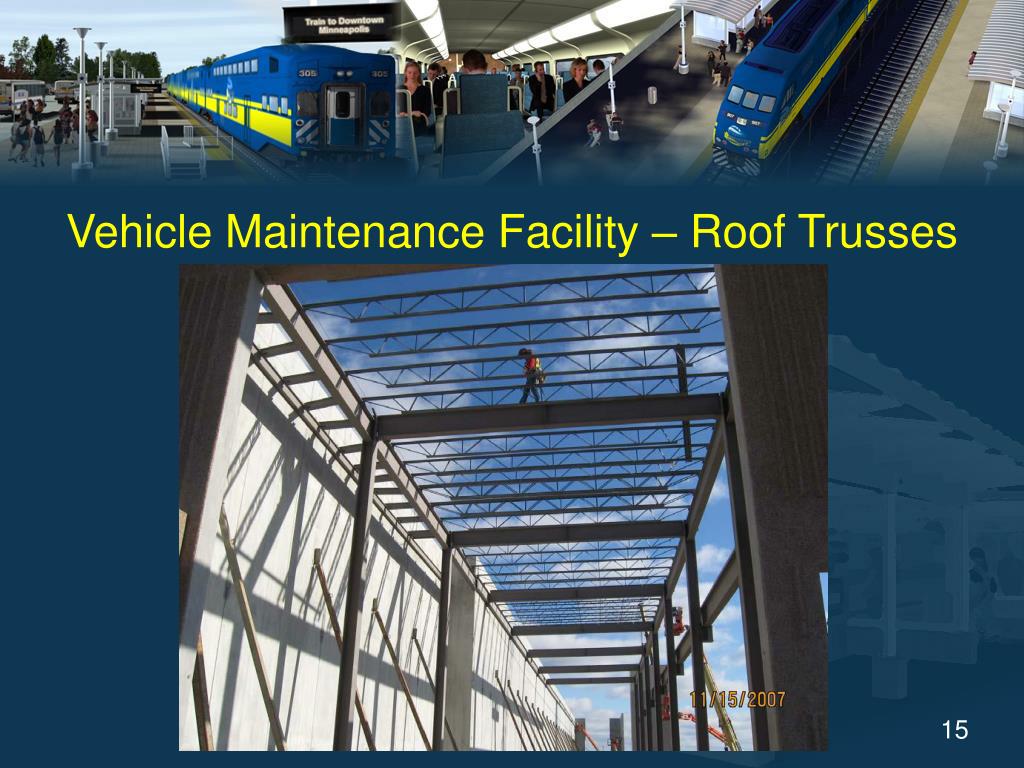

Vehicle Maintenance FacilityNorthstar-City Sanitary Sewer Connection 11

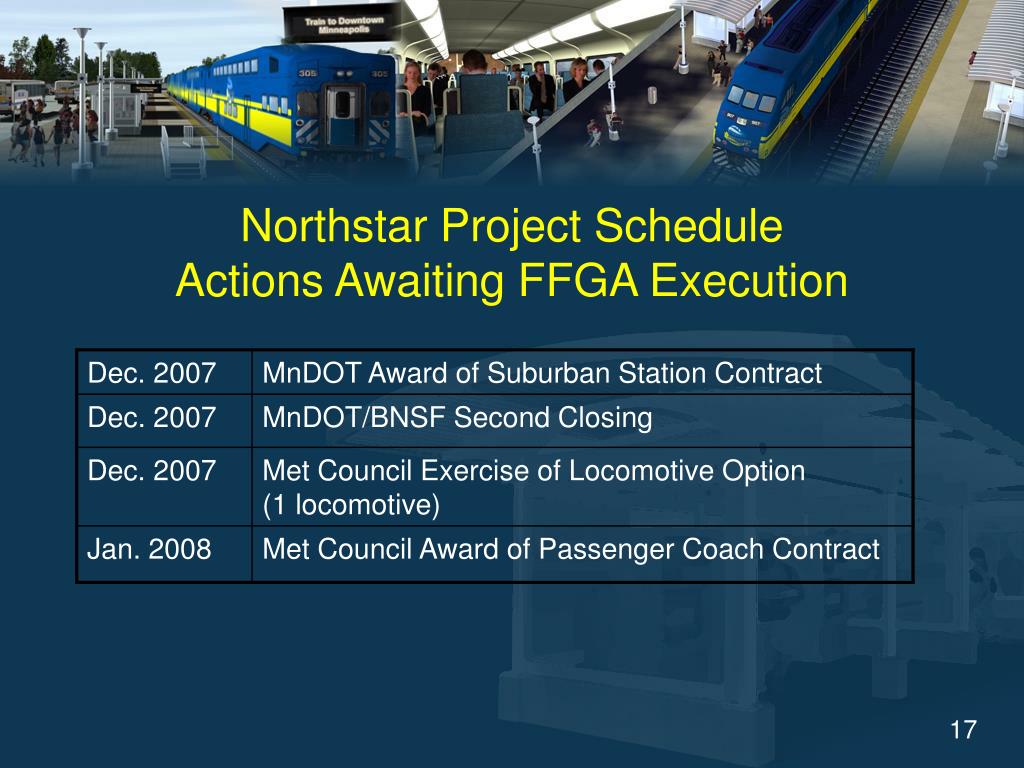

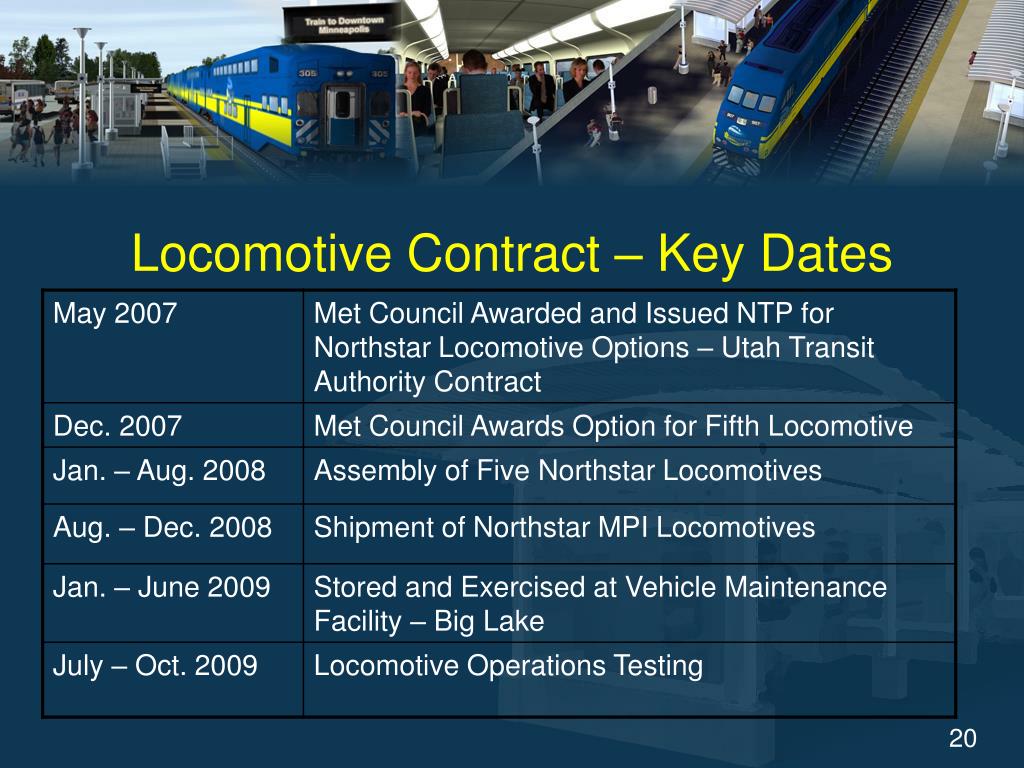

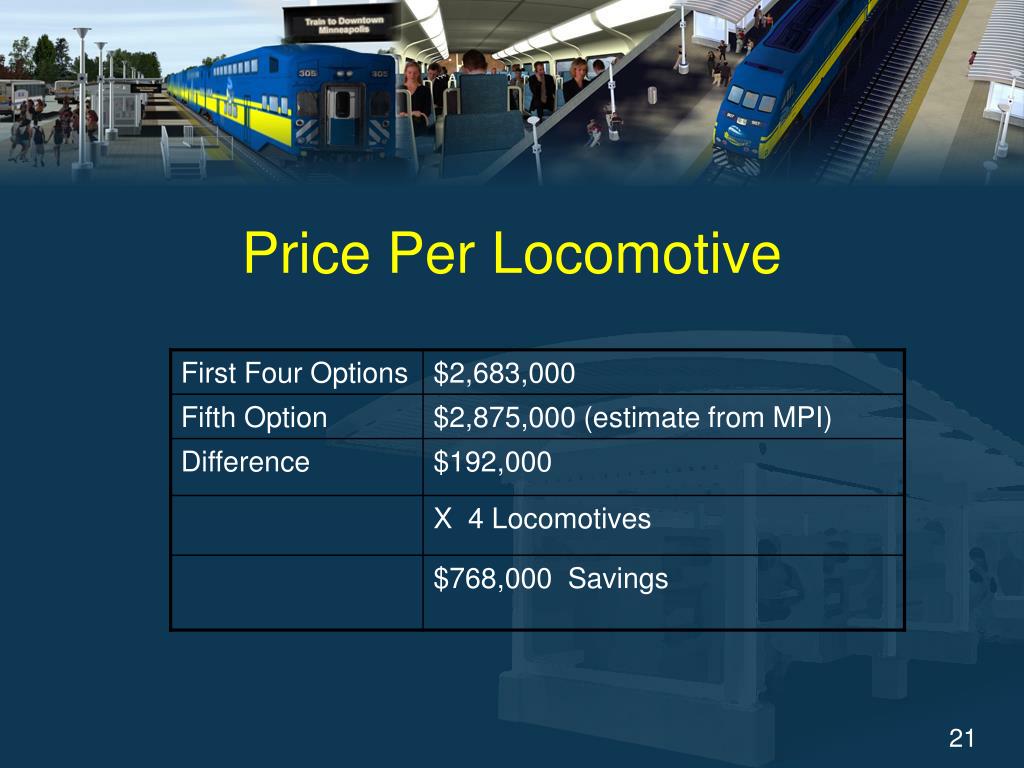

Northstar Project ScheduleActions Awaiting FFGA Execution 17
