slide1

Federal Aviation

Administration

Office of Commercial Space Transportation

Experimental Permit

Program Report

Presented to: COMSTAC RLV Working Group

By: Michelle Murray, AST-300, Experimental Permit Program Lead

Date: May 15, 2008

outline
Outline
  • Introduction To Experimental Permits
    • What Is A Permit?
    • How Was It Created?
    • How Long Does It Take To Get A Permit?
    • What Is The Permit Safety Strategy?
    • What Other Regulations Apply?
  • Maximum Probable Loss Determinations
  • Experimental Permits Issued
  • Permitted Launches
  • Challenges
what is an experimental permit
What Is An Experimental Permit?
  • Authorization issued by the FAA to allow an experimental reusable suborbital rocket to launch or reenter
  • Alternative to licensing
  • Valid for one year renewable term
  • Permits are only issued for:
    • Research and development
    • Showing compliance with requirements to obtain a license, or
    • Crew training
how was the experimental permit created
How Was The Experimental Permit Created?
  • The Commercial Space Launch Amendments Act of 2004 established an experimental permit regime
  • The FAA published experimental permit regulations in April 2007
  • Statutory Differences Between A License And An Experimental Permit
how long does it take to get an experimental permit
How Long Does It Take To Get An Experimental Permit?
  • The FAA review period for an experimental permit is 120 days
  • Complying with financial responsibility regulations takes an additional 30 days
  • Applicants should submit a complete enough application 150 days before their first launch
what is the experimental permit safety strategy
What Is The Experimental Permit Safety Strategy?

The safety strategy for permits consists of three elements:

  • A Hazard Analysis
  • Operating Area Containment
  • Abiding by Operating Requirements
what is a hazard analysis
What Is A Hazard Analysis?
  • A hazard analysis is an integral part of a system safety engineering process to:
    • Identify and eliminate hazards
    • Reduce the associated risk to the public
  • Typical elements of a hazard analysis include:
      • Identifying and describing hazards
      • Assessing risk using qualitative severity and likelihood levels
      • Identifying and describing risk elimination and mitigation measures to reduce the risk to acceptable levels
      • Demonstrating that the risk elimination and mitigation measures are correct, complete, and achieve an acceptable reduction in risk through validation and verification
what is operating area containment
What Is Operating Area Containment?
  • Operating Area
    • An operating area is an FAA approved three-dimensional region proposed by a permit applicant where permitted flights can take place
  • Operating Area Containment
    • A permittee must operate its vehicle such that its instantaneous impact point (IIP) remains within an operating area and outside any exclusion areas
    • The FAA requires an applicant to demonstrate, at a minimum, either that
      • there are physical limits on the ability of the reusable suborbital rocket to leave the operating area
      • the operator will use abort procedures and other safety measures to contain the IIP
what are operating requirements
Follow rest rules

Establish safety clear zones

Implement safety requirements derived from the hazard analysis

Maintain hazard analysis validity

Contain vehicle within the operating area

Conduct all key flight-safety events in appropriate areas

Use appropriately sized and cleared landing locations

Comply with agreements

Perform collision avoidance analyses above 150km

Provide real time tracking of position and velocity

Maintain communications with Air Traffic Control

Record any communications affecting safety of the flight

Implement launch commit criteria

Abort the launch if it would endanger the public

Prevent careless or reckless operations

Record and report anomalies

Report, respond to, and investigate any mishaps

Abide by any additional requirement the FAA believes is necessary to protect public safety

What Are Operating Requirements?

The operating requirements with which a permittee must comply while conducting permitted activities are outlined below:

what other regulations apply

National Environmental Policy Act (NEPA)

  • Part 437:
  • Subpart A – General Information
  • Subpart B – Requirements to
  • Obtain an Experimental Permit
  • Subpart C – Safety Requirements
  • Subpart D – Terms and Conditions of an Experimental Permit

Part 413 Application Procedures

Part 440 Financial Responsibility

Part 460 Human Spaceflight

What Other Regulations Apply?

Other regulations may apply to permitted operations, including:

  • Application Procedures
  • Environmental
  • Financial Responsibility
  • Human Space Flight
what is maximum probable loss

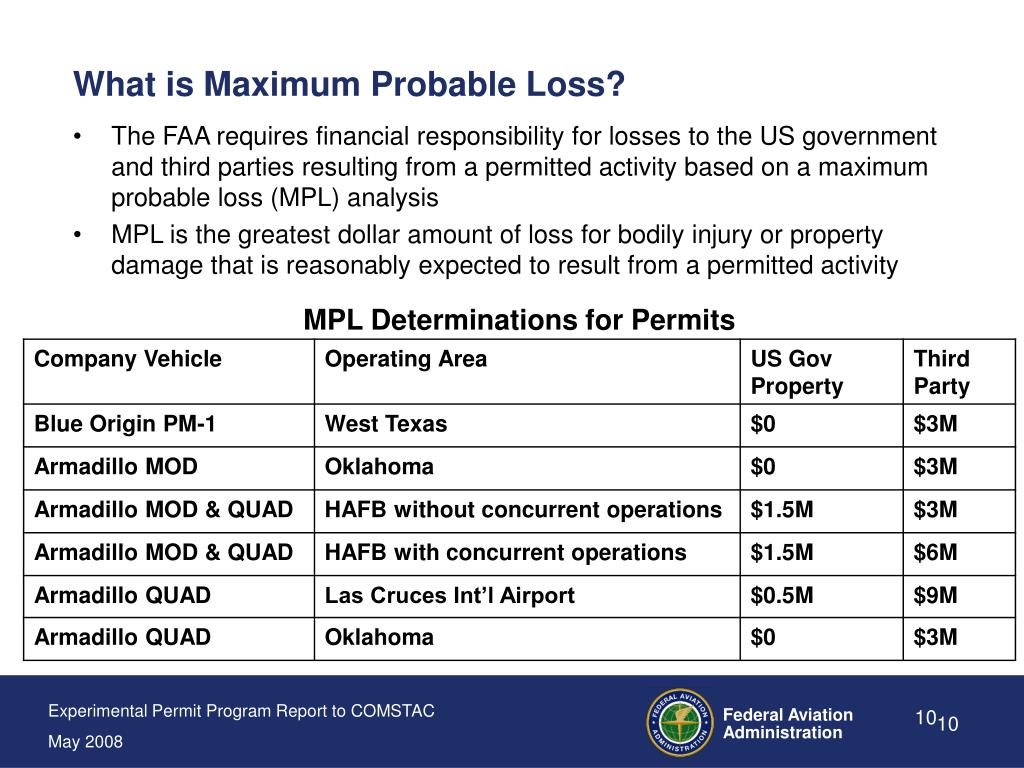

What is Maximum Probable Loss?
  • The FAA requires financial responsibility for losses to the US government and third parties resulting from a permitted activity based on a maximum probable loss (MPL) analysis
  • MPL is the greatest dollar amount of loss for bodily injury or property damage that is reasonably expected to result from a permitted activity

MPL Determinations for Permits

what experimental permits have been issued

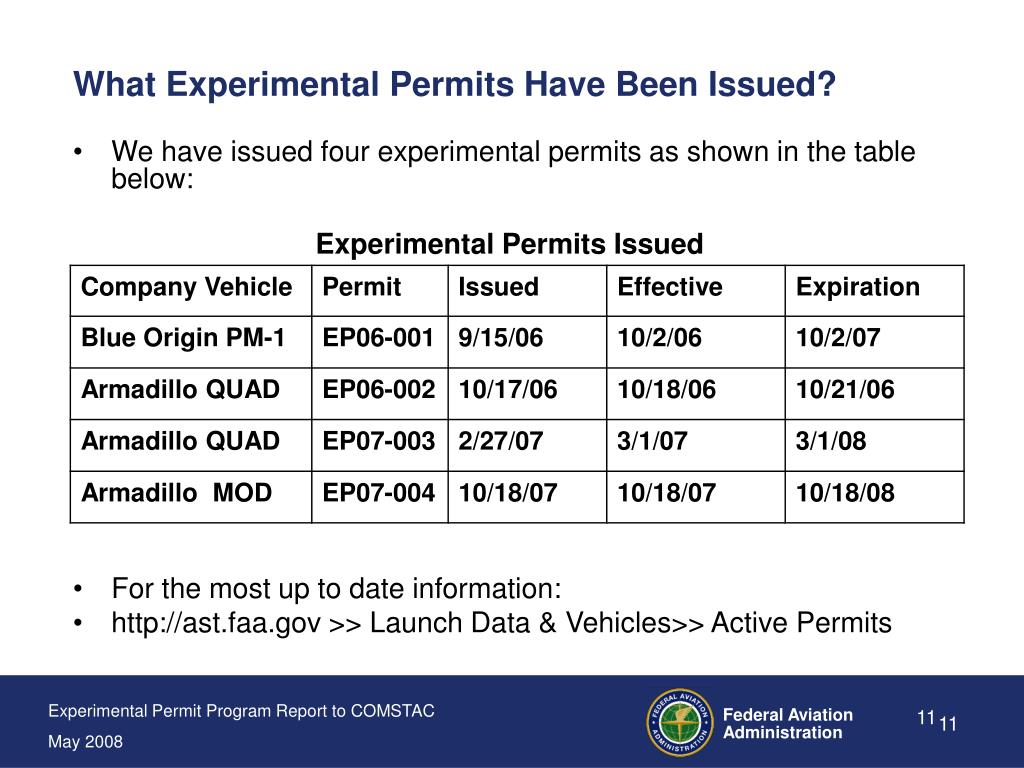

What Experimental Permits Have Been Issued?
  • We have issued four experimental permits as shown in the table below:
  • For the most up to date information:
  • http://ast.faa.gov >> Launch Data & Vehicles>> Active Permits

Experimental Permits Issued

how many permitted launches have there been
How Many Permitted Launches Have There Been?

http://ast.faa.gov >> Launch Data & Vehicles >> Recently Completed & Historical Launch Data

challenges

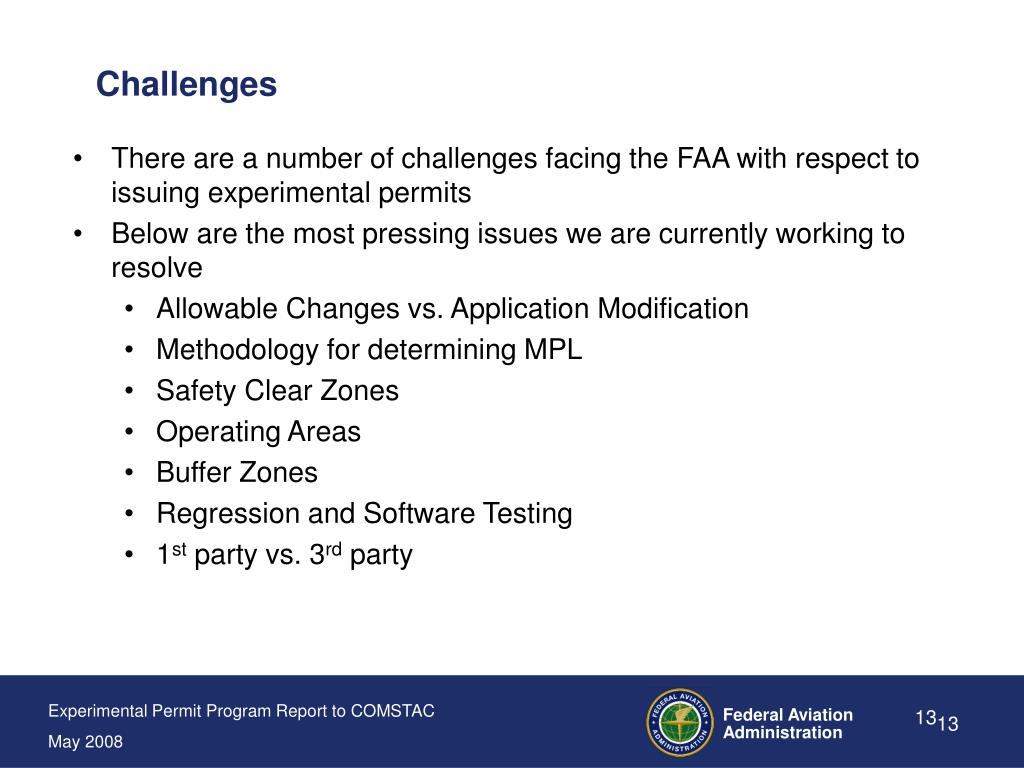

Challenges
  • There are a number of challenges facing the FAA with respect to issuing experimental permits
  • Below are the most pressing issues we are currently working to resolve
    • Allowable Changes vs. Application Modification
    • Methodology for determining MPL
    • Safety Clear Zones
    • Operating Areas
    • Buffer Zones
    • Regression and Software Testing
    • 1st party vs. 3rd party
for more information
For More Information

Michelle Murray

Experimental Permit Program Lead

Michelle.Murray@faa.gov

http://ast.faa.gov >> Licenses & Permits >> Experimental Permits

experimental permits report to comstac
Experimental Permits Report to COMSTAC
  • Eight Maximum Probable Loss Determinations
    • Third Party Ranged from $3-9M
    • Government Ranged from $0-1.5M
  • Four Experimental Permits Issued
  • Fifteen Permitted Launches
  • Challenges
    • Allowable Changes vs. Application Modification
    • Methodology for determining MPL
    • Safety Clear Zones
    • Operating Areas
    • Buffer Zones
    • Regression and Software Testing
    • 1st party vs. 3rd party
