Industrial Engineering | GATE Previous Year Questions | GATE 2021

GATE ME Industrial Engineering's Production Planning and Control, Inventory Control, Queuing, Transportation, Forecasting, Pert and Cpm, Scheduling<br>

TGA
Download Presentation

Industrial Engineering | GATE Previous Year Questions | GATE 2021

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript

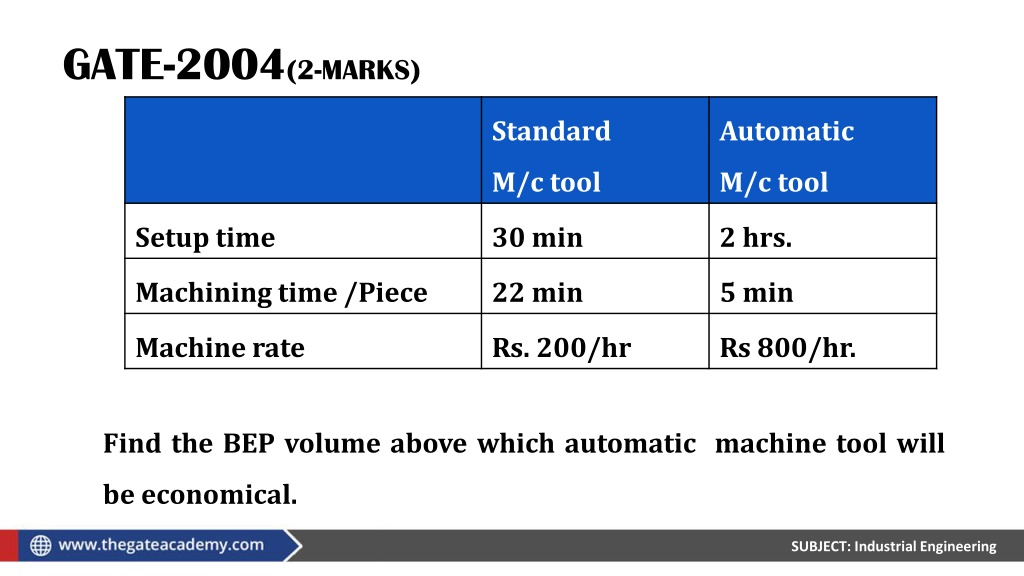

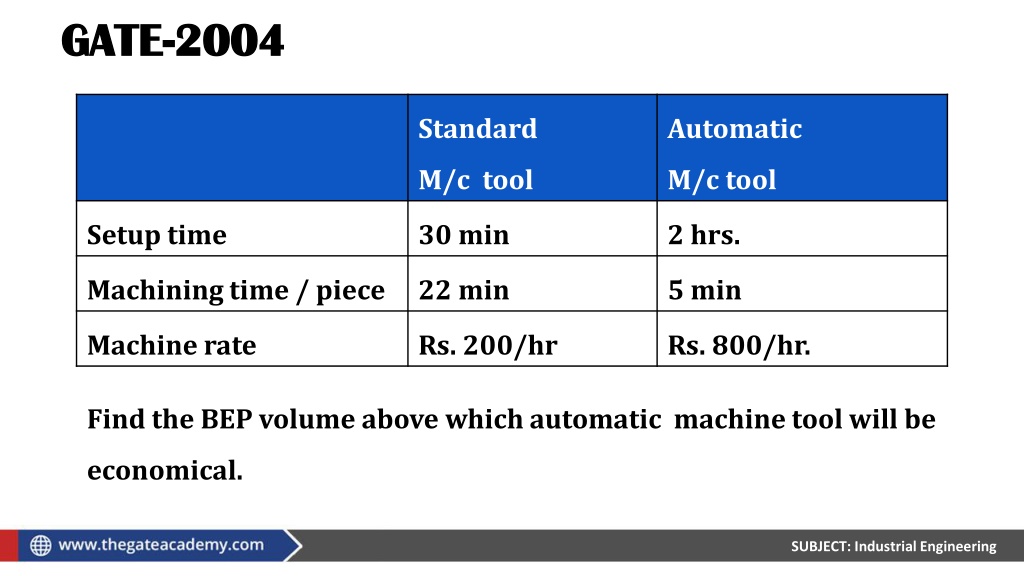

  1. GATE-2004 Find the BEP volume above which automatic machine tool will be economical.

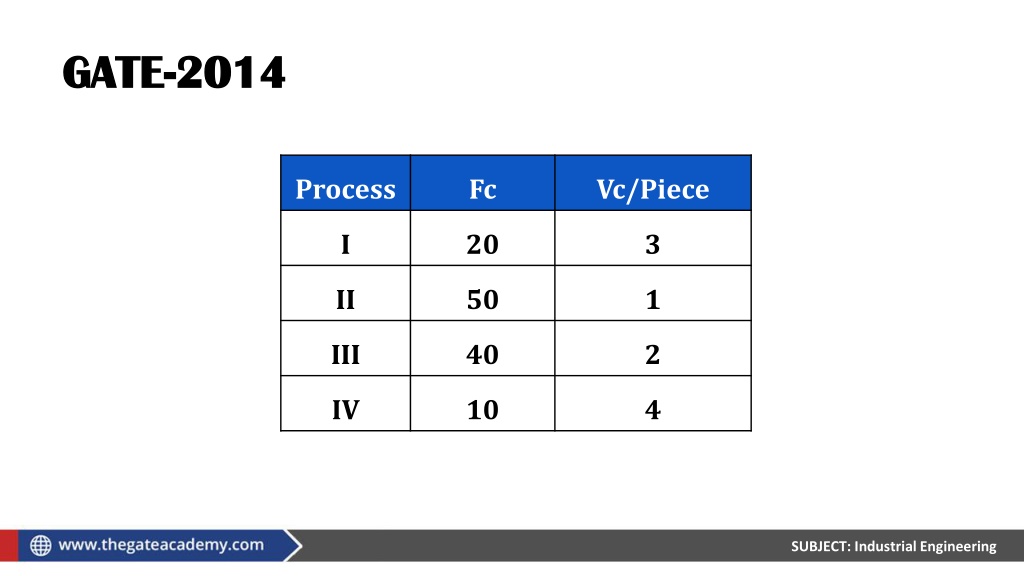

  2. GATE-2014

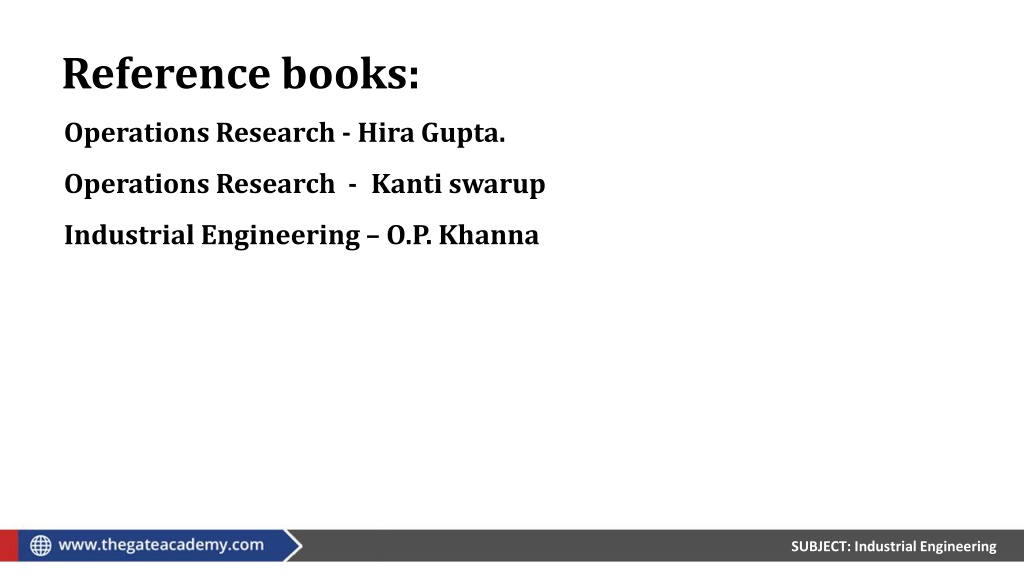

  3. Reference books: Operations Research - Hira Gupta. Operations Research - Kanti swarup Industrial Engineering – O.P. Khanna

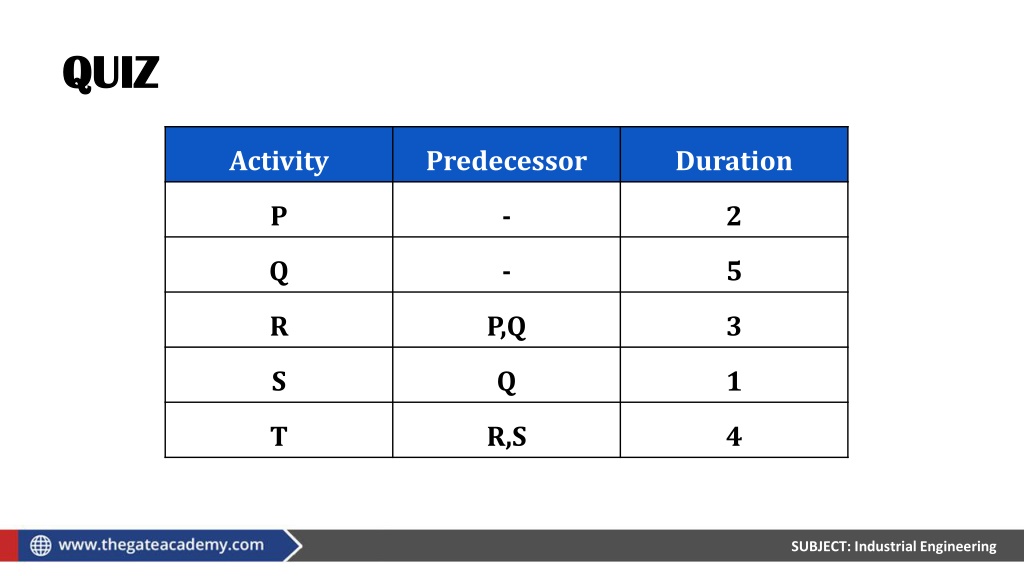

  4. QUIZ

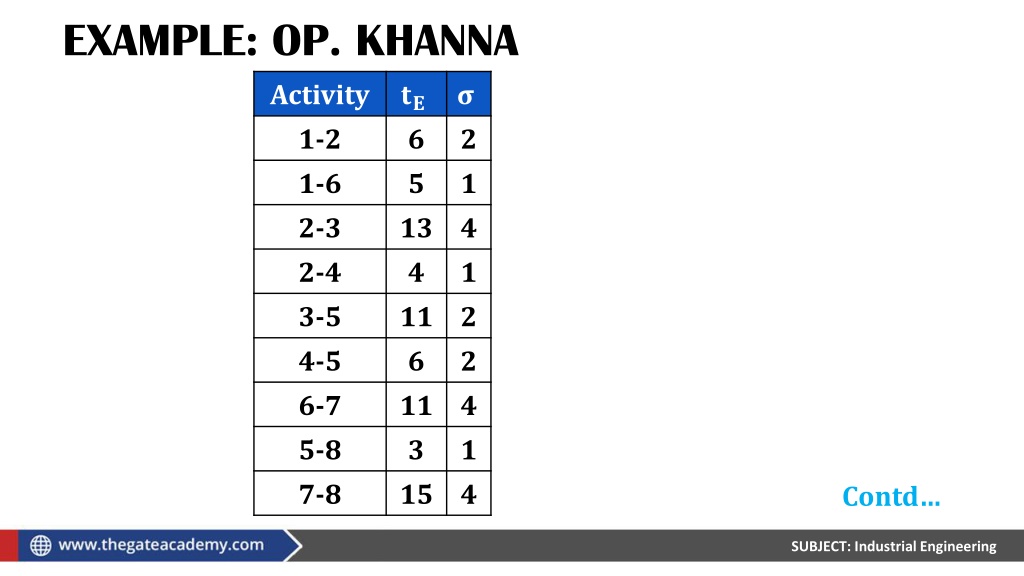

  5. EXAMPLE: OP. KHANNA Contd…

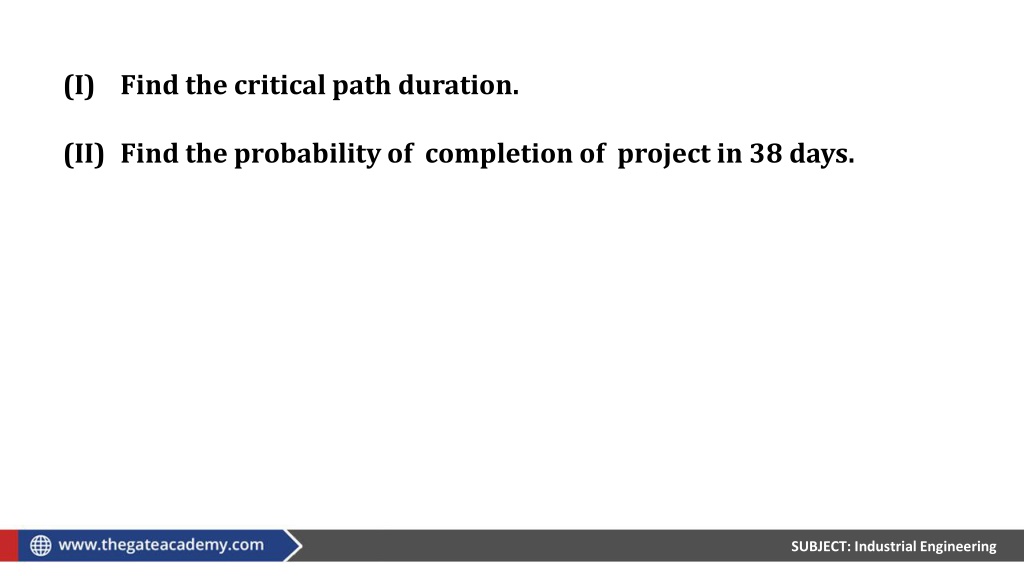

  6. Find the critical path duration. Find the probability of completion of project in 38 days.

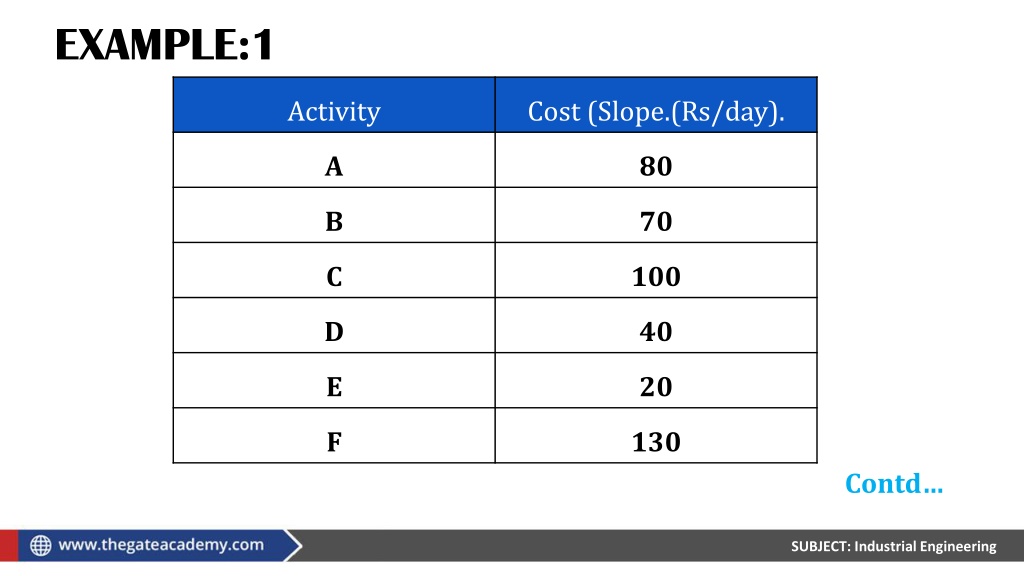

  7. EXAMPLE:1 Contd…

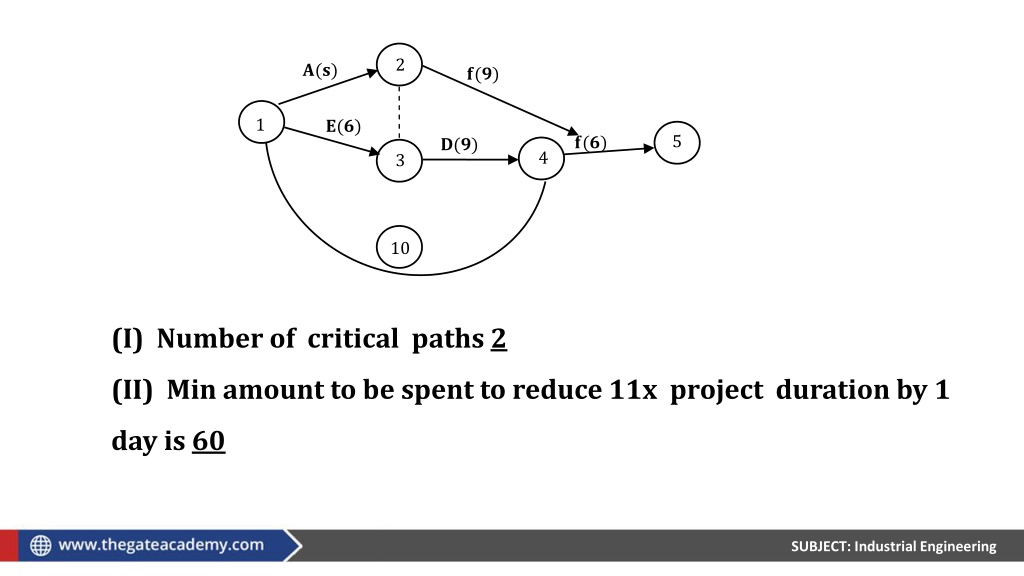

  8. (I) Number of critical paths 2 (II) Min amount to be spent to reduce 11x project duration by 1 day is 60

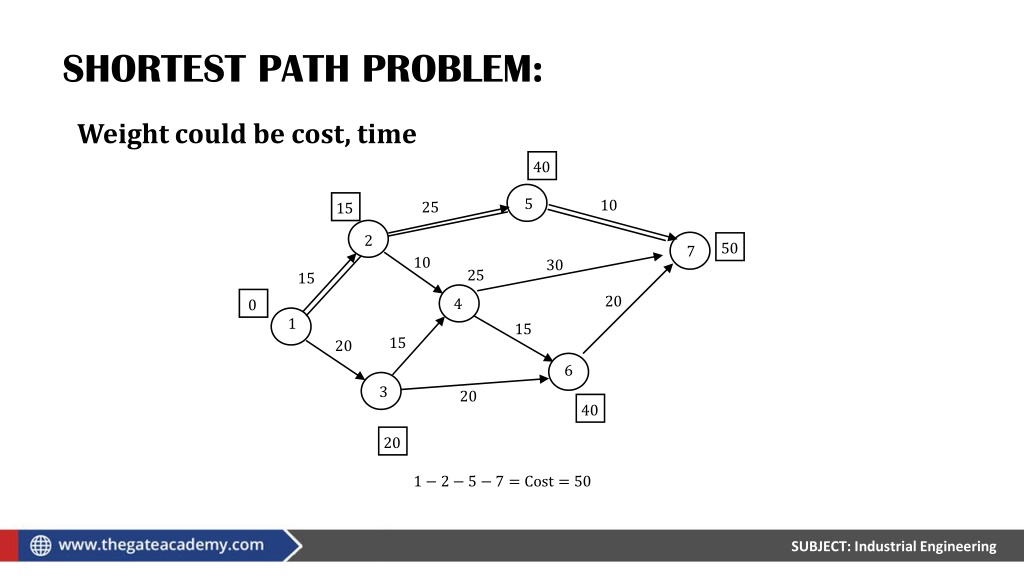

  9. SHORTEST PATH PROBLEM: Weight could be cost, time

  10. S:

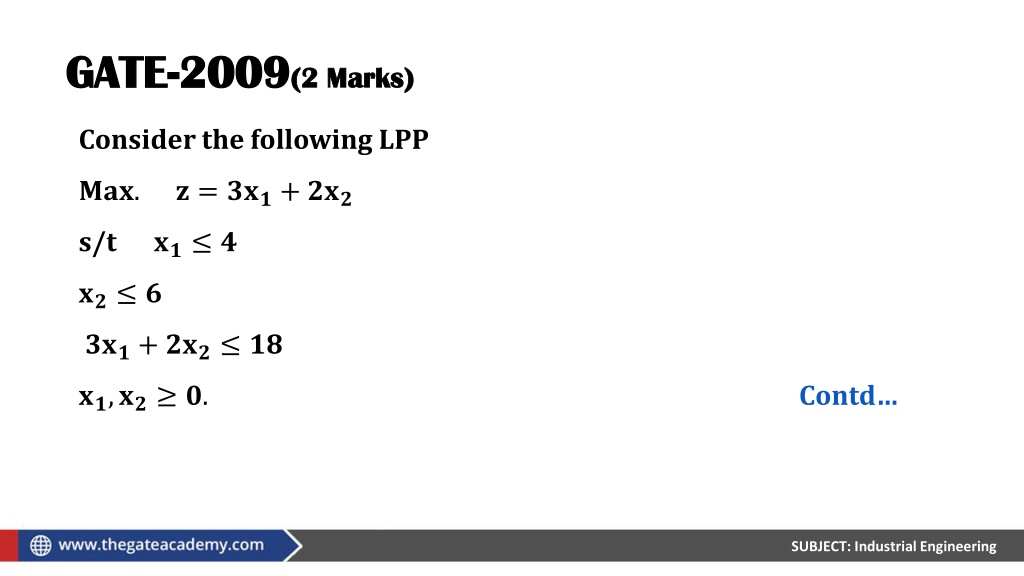

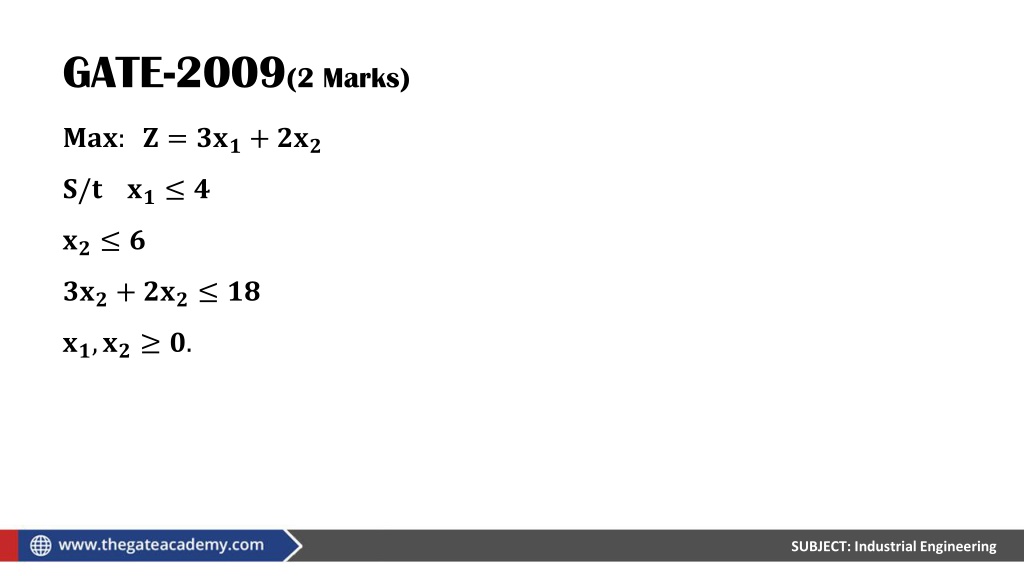

  11. GATE-2009(2 Marks) Consider the following LPP s/t Contd…

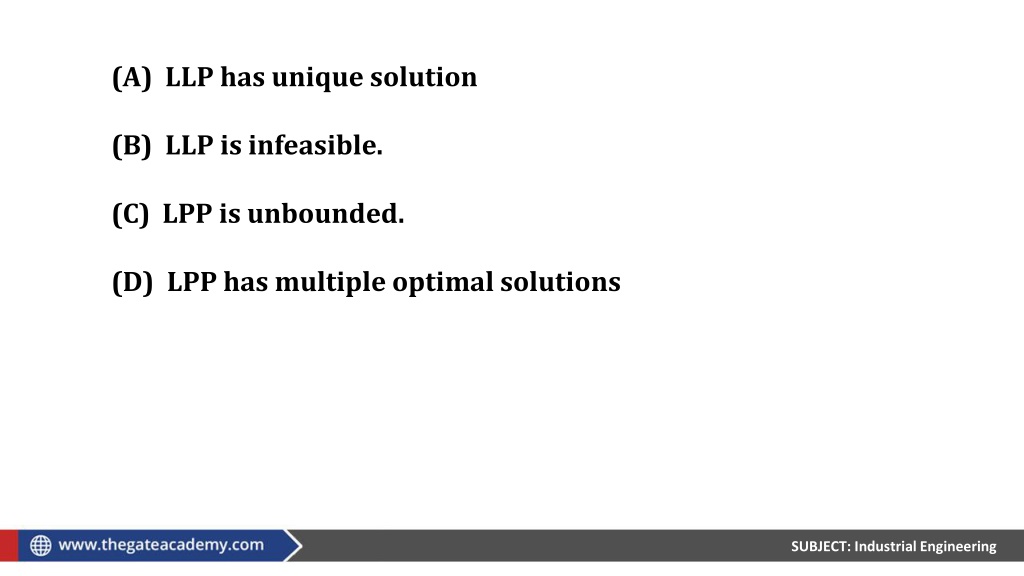

  12. (A) LLP has unique solution (B) LLP is infeasible. LPP is unbounded. (D) LPP has multiple optimal solutions

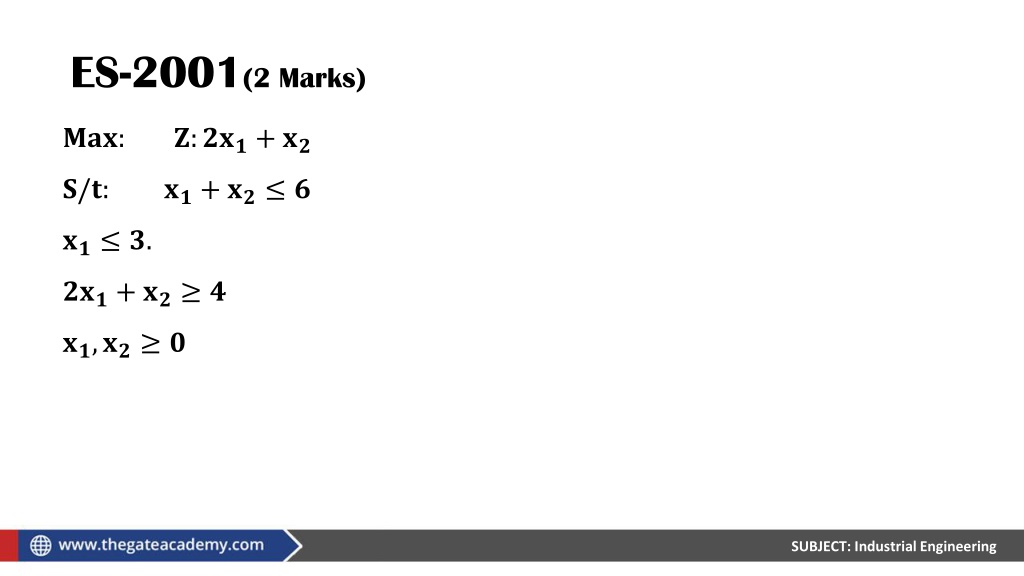

  13. ES-2001(2 Marks) • S

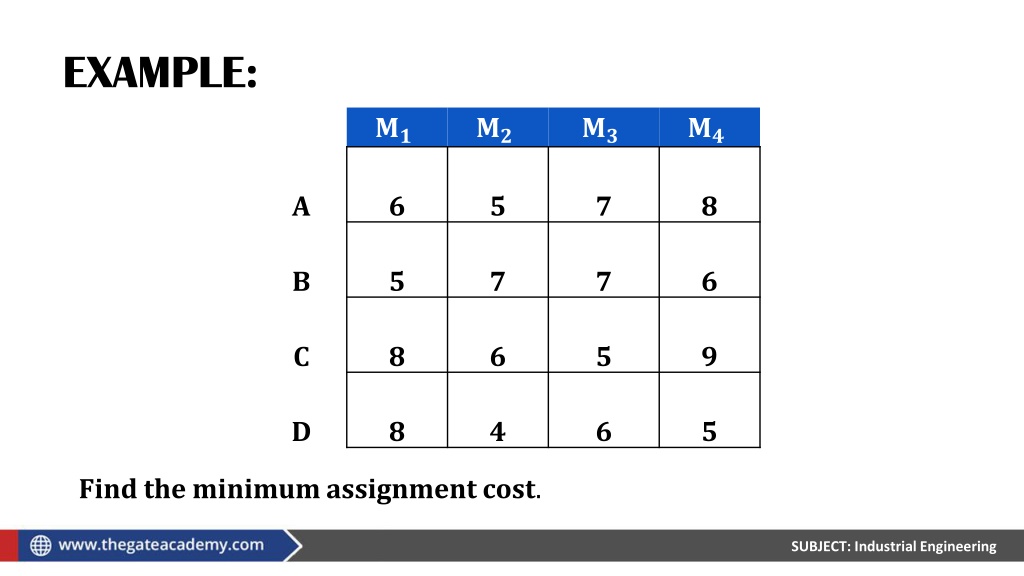

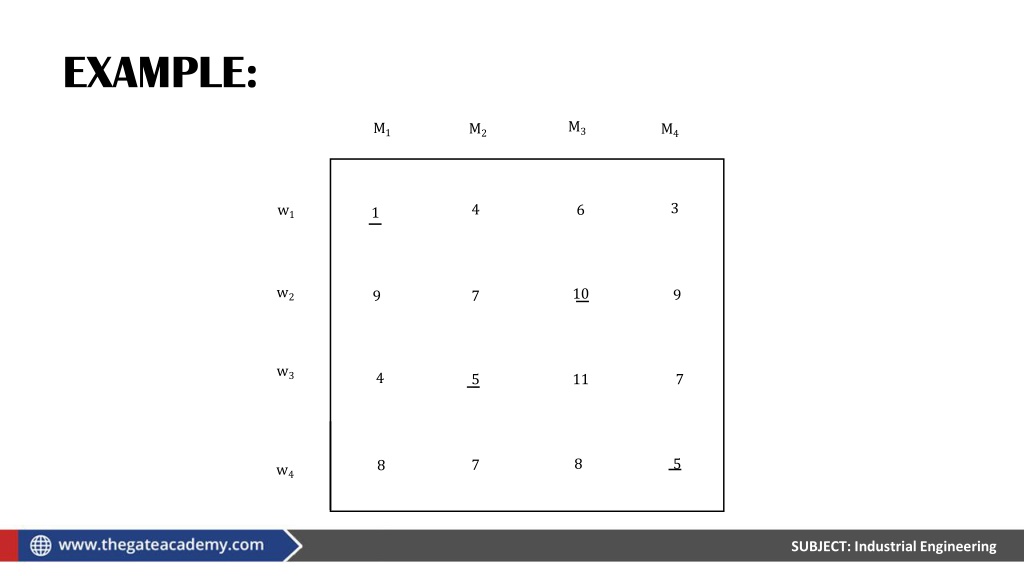

  14. S

  15. GATE-2009(2 Marks)

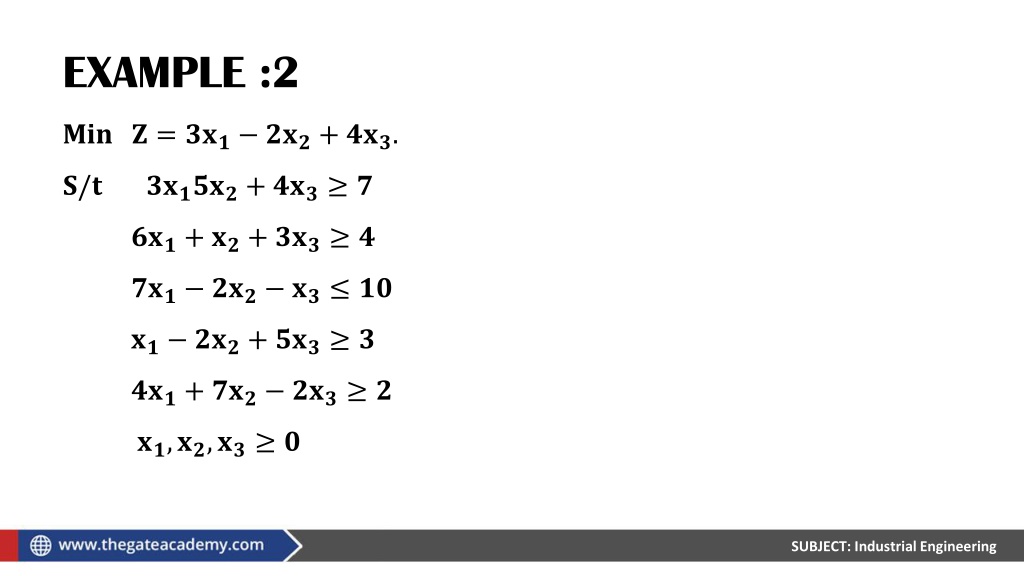

  16. EXAMPLE :2 • Min

  17. IES-2014

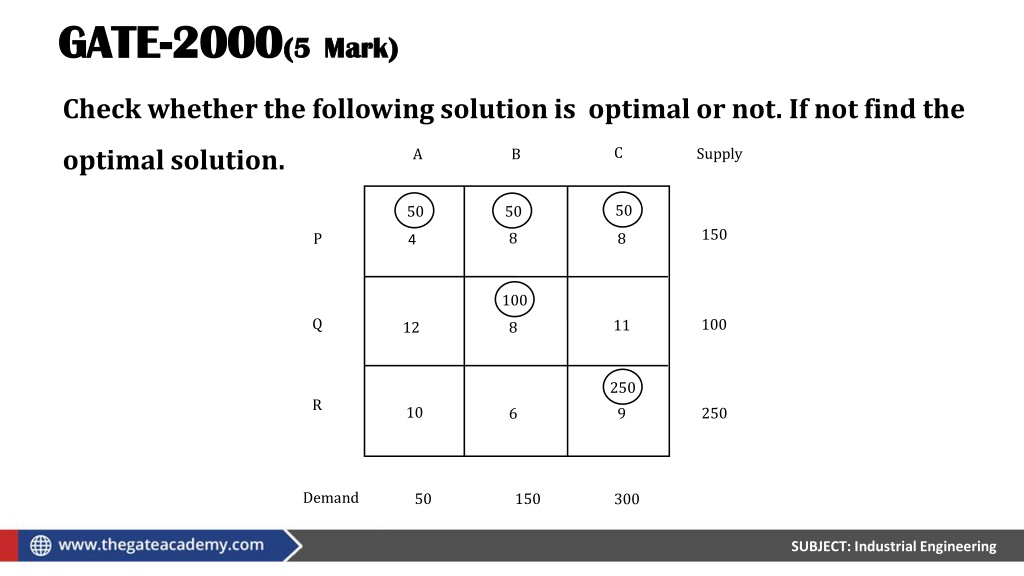

  18. GATE-2000(5Mark) • Check whether the following solution is optimal or not. If not find the optimal solution.

  19. EXAMPLE:

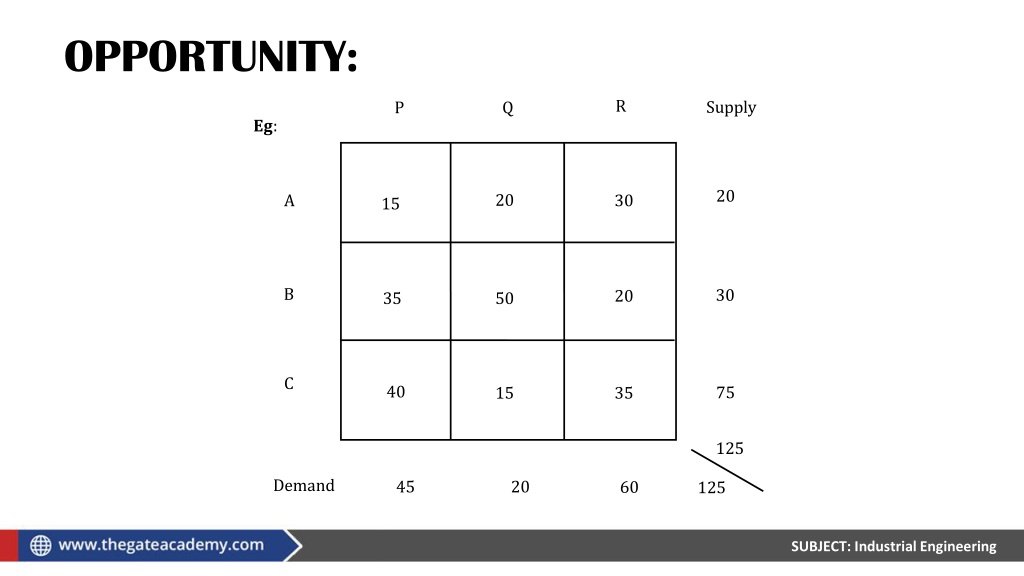

  20. OPPORTUNITY:

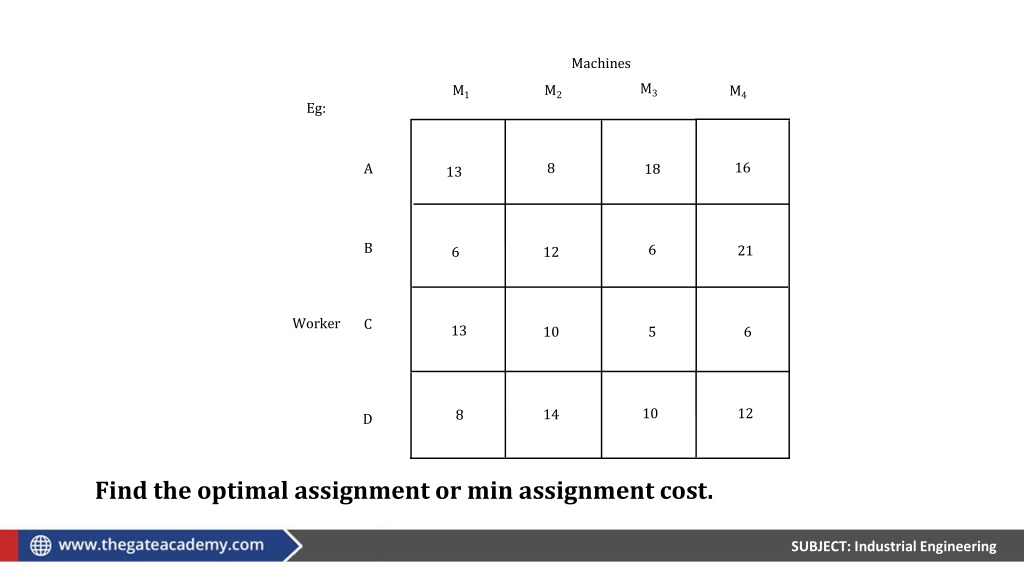

  21. Find the optimal assignment or min assignment cost.

  22. EXAMPLE: Find the minimum assignment cost.

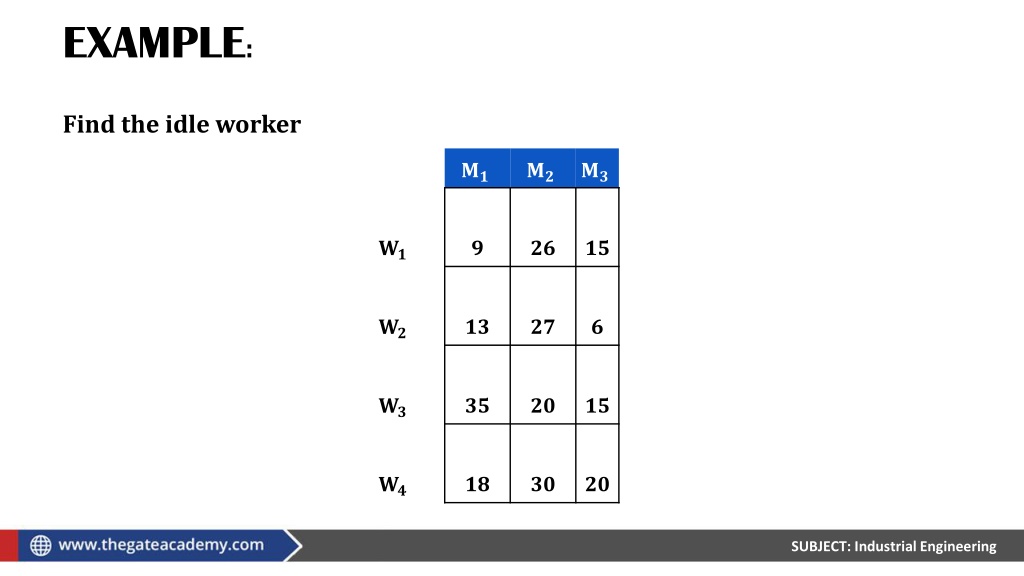

  23. EXAMPLE: Find the idle worker

  24. EXAMPLE:

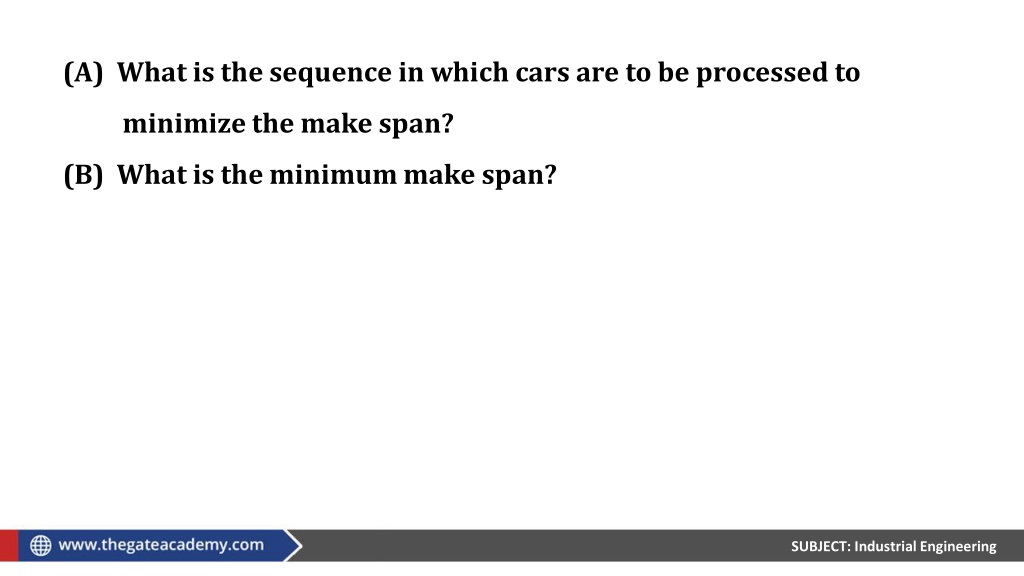

  25. GATE-1995 • Six cars waiting to be repaired at a car repair shop each car has first to be dented and then painted. The estimated time for each car given below. Assuming only one denter and one painter

  26. (A) What is the sequence in which cars are to be processed to minimize the make span? (B) What is the minimum make span?

  27. ES-2001(5-MARKS) • Solution:

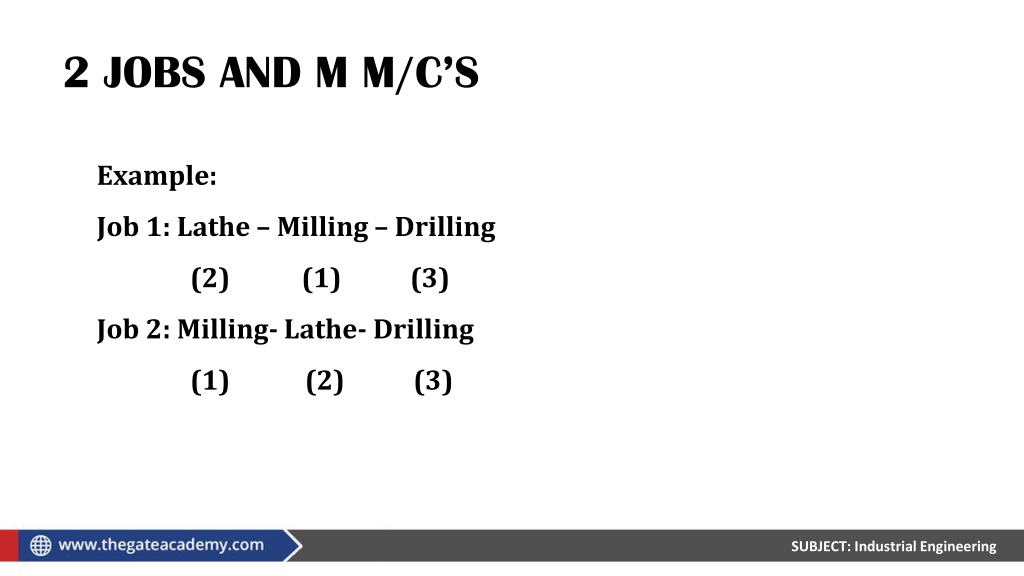

  28. 2 JOBS AND M M/C’S • Example: • Job 1: Lathe – Milling – Drilling • (2) (1) (3) • Job 2: Milling- Lathe- Drilling • (1) (2) (3)

  29. ES-2004 Find forecast for 7th month using 3-month if wait . MA

  30. GATE-2004(2-MARKS) Find the BEP volume above which automatic machine tool will be economical.
