Welcome to the Jurisdiction . of Unit-1. R.S.R.D.C. Ltd., Ajmer. ORGANISATION CHART OF RSRDC UNIT-1, AJMER. RE Rakesh Kr. Jain. AAO Sh. Shiv Kr. Sharma. ARE Sh. Brijesh Kr. Mathur. ARE. Sh. Avinash Kumar. ARE Sh. N.K. Tak. ARE Sh. J.P. Kansal. ARE Sh. Harsh Rai. J.En. (Elect.)

loader
I am the owner, or an agent authorized to act on behalf of the owner, of the copyrighted work described.
capcha
Download Presentation

PowerPoint Slideshow about 'Welcome to the Jurisdiction' - MikeCarlo


An Image/Link below is provided (as is) to download presentation

Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author.While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server.


- - - - - - - - - - - - - - - - - - - - - - - - - - E N D - - - - - - - - - - - - - - - - - - - - - - - - - -
Presentation Transcript
slide1

Welcome to the Jurisdiction

of Unit-1

R.S.R.D.C. Ltd., Ajmer

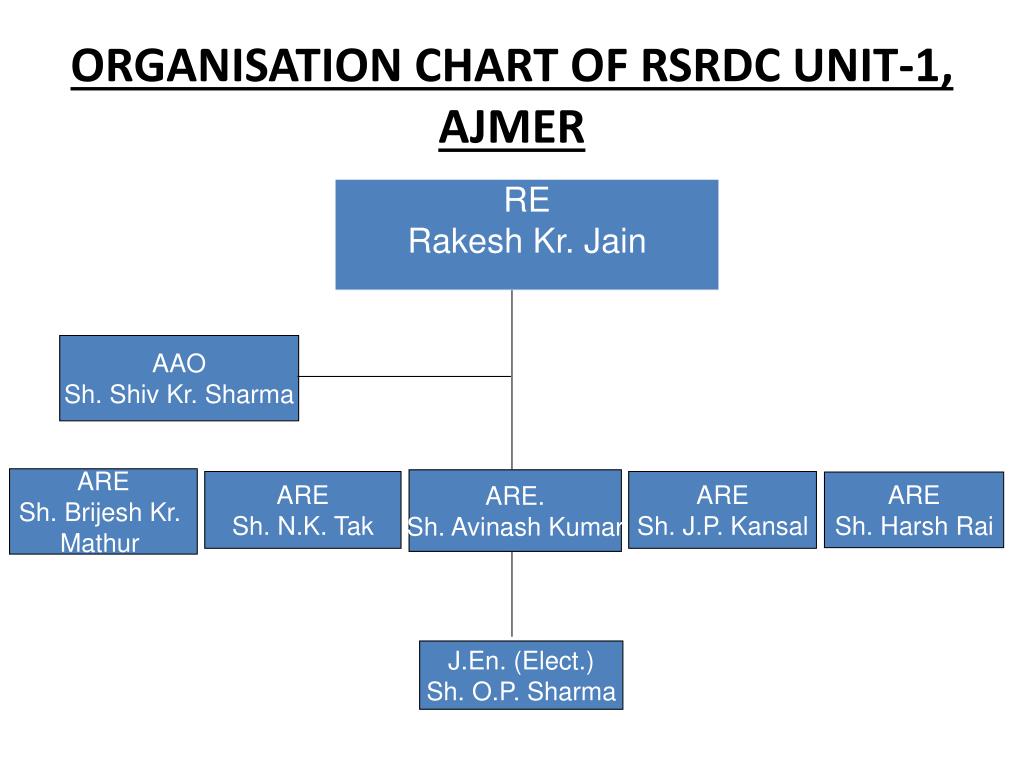

organisation chart of rsrdc unit 1 ajmer
ORGANISATION CHART OF RSRDC UNIT-1, AJMER

RE

Rakesh Kr. Jain

AAO

Sh. Shiv Kr. Sharma

ARE

Sh. Brijesh Kr.

Mathur

ARE.

Sh. Avinash Kumar

ARE

Sh. N.K. Tak

ARE

Sh. J.P. Kansal

ARE

Sh. Harsh Rai

J.En. (Elect.)

Sh. O.P. Sharma

slide10

Important Works Completed during last 5 years

Bharat Vidhya Adhayan Sankul at M.D.S.U., Ajmer

Completion Cost – Rs. 1.10 Crs.

Foundation Stone laid by Hon’ble Minister for Higher Education Rajasthan State Sh. Ghanshyam Tiwari in March, 07

Inaugurated by Prof. Sukhdev Thorat Chairman UGC on 12.10.09

slide11

Important Works Completed during last 5 years

Boy’s Hostel at M.D.S.U., Ajmer

Completion Cost – Rs. 1.65 Crs.

Foundation Stone laid by Hon’ble Minister for Higher Education Rajasthan State Sh. Ghanshyam Tiwari in March, 07

slide12

Important Works Completed during last 5 years

Girls Hostel at M.D.S.U., Ajmer

Completion Cost – Rs. 1.40 Crs.

Completion Cost – Rs. 1.65 Crs.

Foundation Stone laid by Hon’ble Minister for Higher Education & PWD Rajasthan State Sh. Lalit Kishor Chaturvedi on 24.09.1998

Inaugurated by Honble Mininster for Higher Education Rajasthan State Govt. Sh. Ghanshyam Tiwari on 21.08.2006

slide13

Important Works Completed during last 5 years

Social Science Block at M.D.S.U., Ajmer

Completion Cost – Rs. 3.05 Crs.

Foundation Stone laid by Hon’ble Minister for Mahilla Bal Vikas & JanJati Kashetrya Vikas, Rajasthan State Sh. Kankmal Kataraon 01.06.2005.

Inaugurated by Honble Mininster for Higher Education Rajasthan State Govt. Sh. Ghanshyam Tiwari on 10.08.2006.

slide14

Important Works Completed during last 5 years

Yoga Centre at M.D.S.U., Ajmer

Completion Cost – Rs. 0.63 Crs.

Foundation Stone laid by Hon’ble Minister for Higher Education & PWD Rajasthan State Sh. Lalit Kishor Chaturvedion 24.09.1998

Inaugurated by Honble Mininster for Higher Education Rajasthan State Govt. Sh. Ghanshyam Tiwari on 29.06.2007.

slide15

Important Works Completed during last 5 years

Women Engineering College at Ajmer

Completion Cost – Rs. 2.57 Crs.

Foundation Stone laid by Hon’ble Chief Minister Govt. of Rajasthan Smt. Vasundhra Raje on 30.04.07

Handed Over in November, 2009

slide16

Important Works Completed during last 5 years

Women Engineering College at Ajmer

Completion Cost – Rs. 2.57 Crs.

Foundation Stone laid by Hon’ble Chief Minister Govt. of Rajasthan Smt. Vasundhra Raje on 30.04.07

Handed Over in November, 2009

slide17

Important Works Completed during last 5 years

Management Block at M.D.S.U., Ajmer

Completion Cost – Rs. 1.97 Crs.

Inaugurated by Honble Mininster for Industries Rajasthan State Govt. Sh. Rajendra Pareek on 17.09.09.

slide18

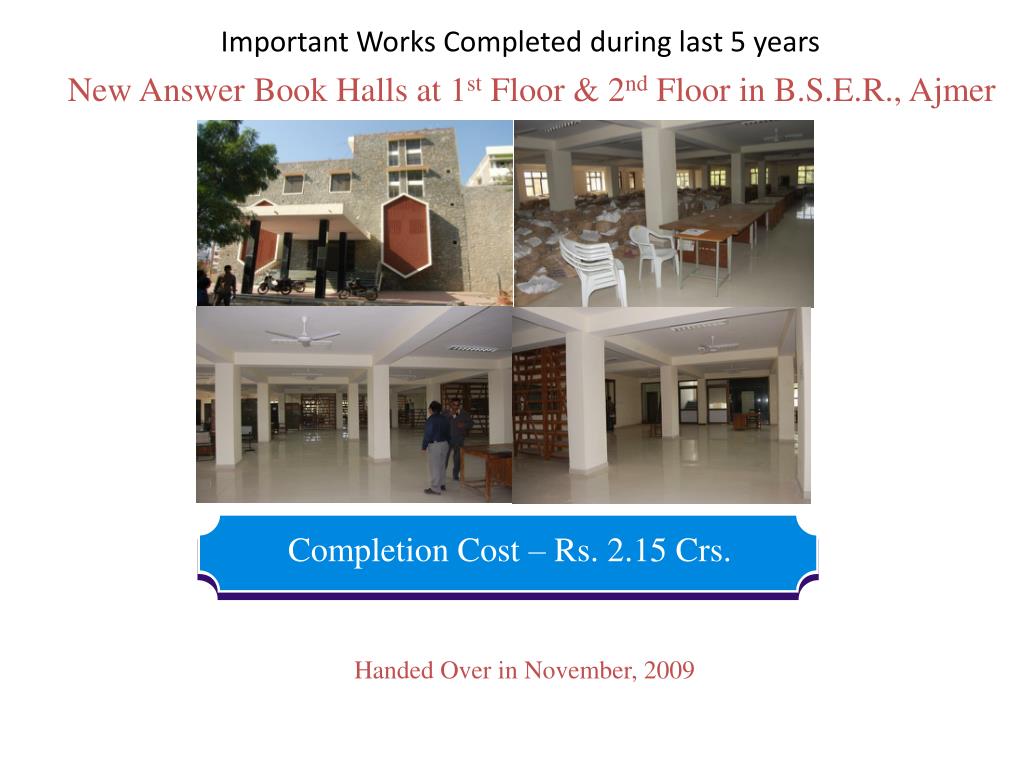

Important Works Completed during last 5 years

New Answer Book Halls at 1st Floor & 2nd Floor in B.S.E.R., Ajmer

Completion Cost – Rs. 2.15 Crs.

Handed Over in November, 2009

slide19

Important Works Completed during last 5 years

Engineering College, Ajmer

Completion Cost – Rs. 5.40 Crs.

Inaugurated by Honble Chief Mininster Govt. of Rajasthan Smt.Vasundhra Raje on 25.01.08.

slide20

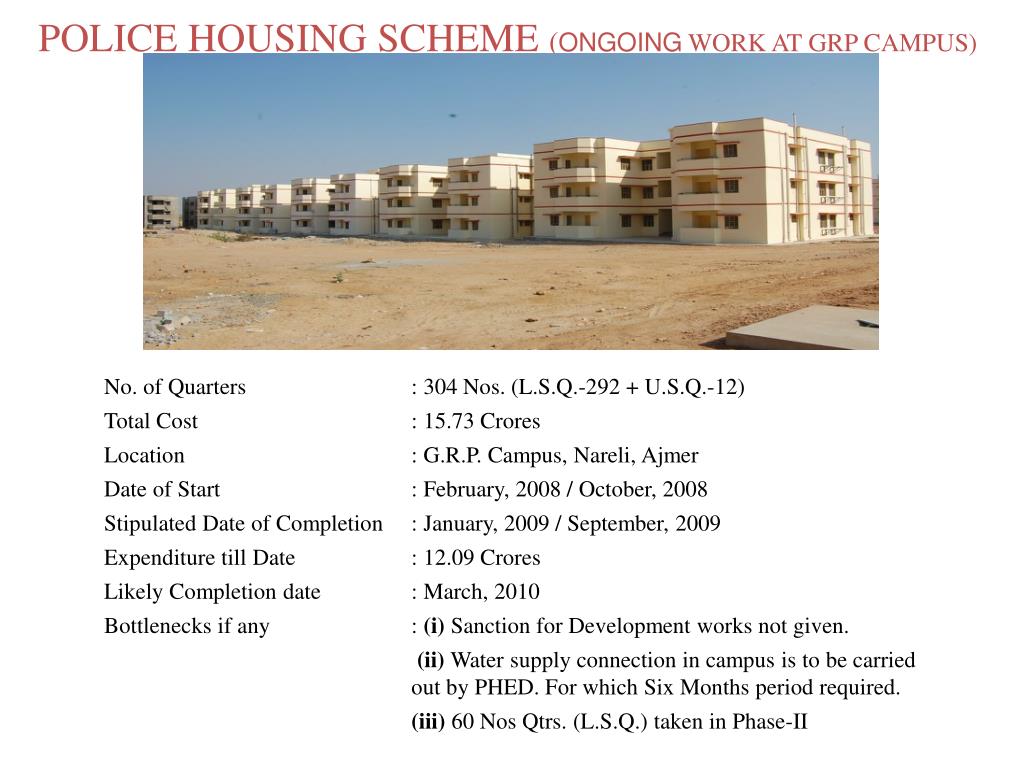

POLICE HOUSING SCHEME (ONGOING WORK AT GRP CAMPUS)

No. of Quarters : 304 Nos. (L.S.Q.-292 + U.S.Q.-12)

Total Cost : 15.73 Crores

Location : G.R.P. Campus, Nareli, Ajmer

Date of Start : February, 2008 / October, 2008

Stipulated Date of Completion : January, 2009 / September, 2009

Expenditure till Date : 12.09 Crores

Likely Completion date : March, 2010

Bottlenecks if any : (i) Sanction for Development works not given.

(ii) Water supply connection in campus is to be carried out by PHED. For which Six Months period required.

(iii) 60 Nos Qtrs. (L.S.Q.) taken in Phase-II

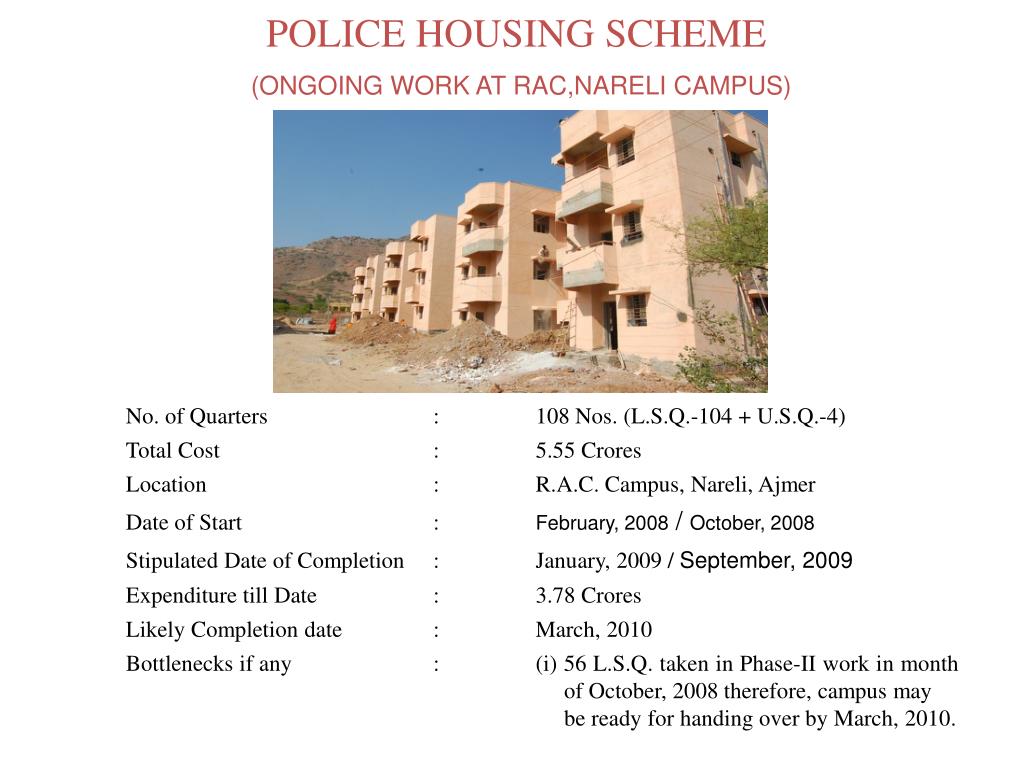

slide22

POLICE HOUSING SCHEME

(ONGOING WORK AT RAC,NARELI CAMPUS)

No. of Quarters : 108 Nos. (L.S.Q.-104 + U.S.Q.-4)

Total Cost : 5.55 Crores

Location : R.A.C. Campus, Nareli, Ajmer

Date of Start : February, 2008 / October, 2008

Stipulated Date of Completion : January, 2009 / September, 2009

Expenditure till Date : 3.78 Crores

Likely Completion date : March, 2010

Bottlenecks if any : (i) 56 L.S.Q. taken in Phase-II work in month of October, 2008 therefore, campus may be ready for handing over by March, 2010.

slide23

Name of Work:- Various Works in M.D.S. University, Ajmer

Construction of First Floor at Computer Centre

  • Total Cost : 0.54/0.79 Crore
  • Location : M.D.S. University, Campus
  • Date of Start : September, 2008
  • Stipulated Date of Completion : April, 2009
  • Expenditure till Date : 0.53 Crore
  • Likely Completion date : March, 2010
  • Bottlenecks if any : Revised Sanction for additional work received in June, 2009 and delay in payment from client.
slide24

Name of Work:- Various Works in M.D.S. University, Ajmer

Construction of Women Hostel

Foundation Stone Lead by Hon’ble State Minister for Information Technology & Communication Govt. of India

Sh. Sachin Piolet on 15th September, 2009

  • Total Cost : 1.81 Crores
  • Location : M.D.S. University, Campus
  • Date of Start : September, 2009
  • Stipulated Date of Completion : June, 2010
  • Expenditure till Date : 0.08 Crore
  • Likely Completion date : June, 2010
  • Bottlenecks if any : Work started in October, 2009 due to foundation stone ceremony in September, 2009.
slide25

Name of Work:- Various Works in M.D.S. University, Ajmer

Construction of Academic Staff College (Guest House)

  • Total Cost : 0.75 Crore
  • Location : M.D.S. University, Campus
  • Date of Start : August, 2009
  • Stipulated Date of Completion : December, 2009
  • Expenditure till Date : 0.11 Crore
  • Likely Completion date : March, 2010
  • Bottlenecks if any : Funds not released by client timely.
slide26

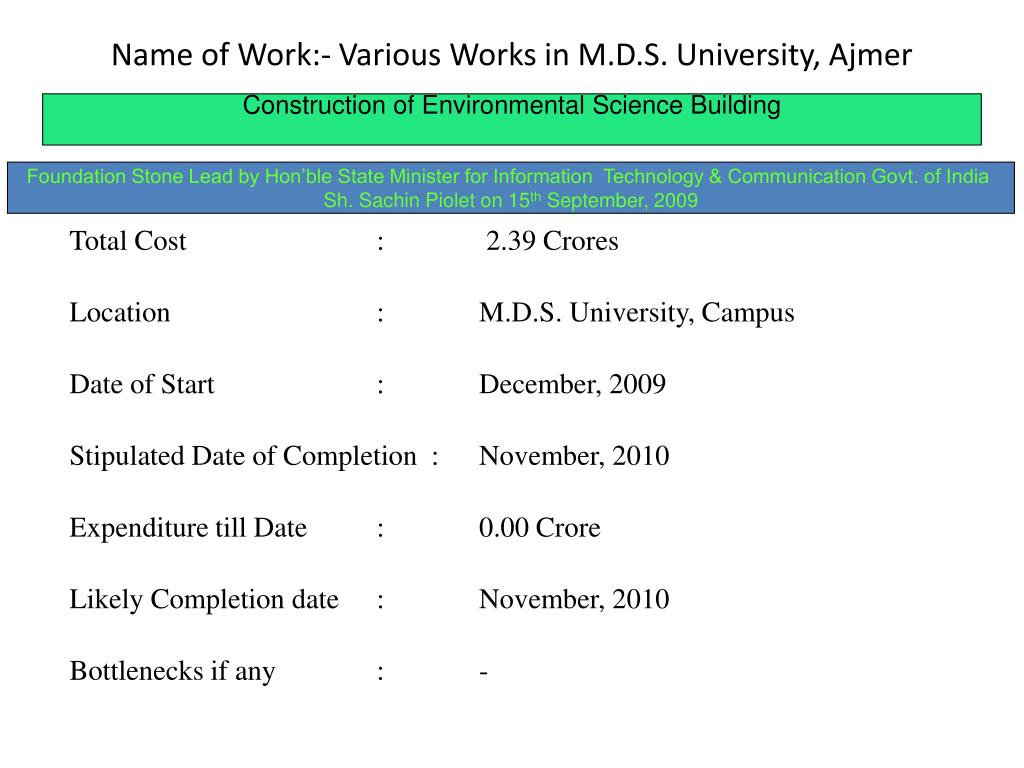

Name of Work:- Various Works in M.D.S. University, Ajmer

Construction of Environmental Science Building

Foundation Stone Lead by Hon’ble State Minister for Information Technology & Communication Govt. of India

Sh. Sachin Piolet on 15th September, 2009

  • Total Cost : 2.39 Crores
  • Location : M.D.S. University, Campus
  • Date of Start : December, 2009
  • Stipulated Date of Completion : November, 2010
  • Expenditure till Date : 0.00 Crore
  • Likely Completion date : November, 2010
  • Bottlenecks if any : -
slide27

Name of Work:- Various Works in Board of Sec. Edu., Rajasthan, Ajmer

Construction of Parking, Office, Chamber & Auditorium

  • Total Cost : 14.00 Crores
  • Location : B.S.E.R. Campus
  • Date of Start : September, 2008
  • Stipulated Date of Completion : August, 2011
  • Expenditure till Date : 2.89 Crores
  • Likely Completion date : August, 2011
  • Bottlenecks if any : Work stopped on account of decision not given by client for Construction of Auditorium hence, Construction of 2rd Floor held up for Two Months.
slide28

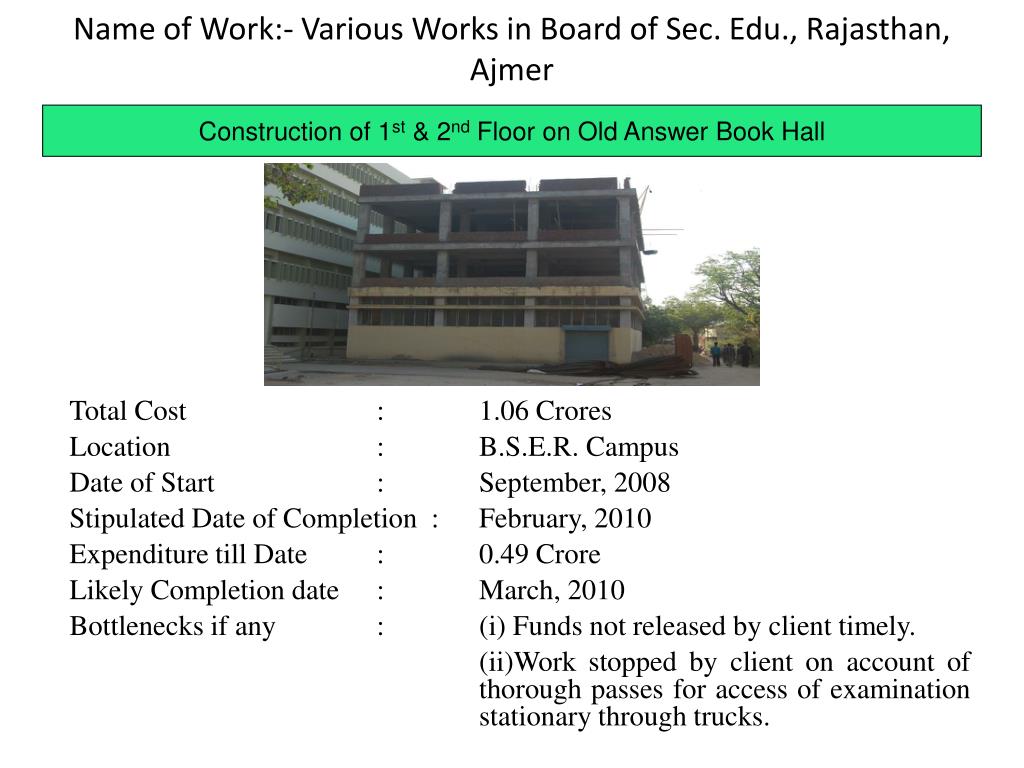

Name of Work:- Various Works in Board of Sec. Edu., Rajasthan, Ajmer

Construction of 1st & 2nd Floor on Old Answer Book Hall

  • Total Cost : 1.06 Crores
  • Location : B.S.E.R. Campus
  • Date of Start : September, 2008
  • Stipulated Date of Completion : February, 2010
  • Expenditure till Date : 0.49 Crore
  • Likely Completion date : March, 2010
  • Bottlenecks if any : (i) Funds not released by client timely.
  • (ii)Work stopped by client on account of thorough passes for access of examination stationary through trucks.
slide29

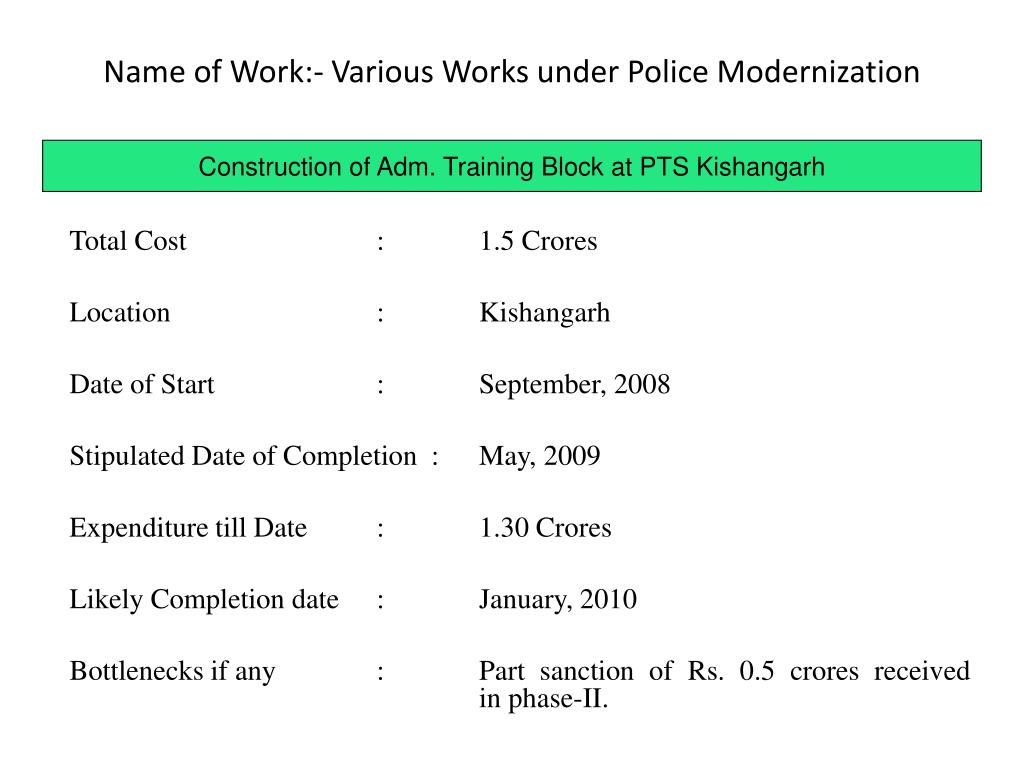

Name of Work:- Various Works under Police Modernization

Construction of Adm. Training Block at PTS Kishangarh

  • Total Cost : 1.5 Crores
  • Location : Kishangarh
  • Date of Start : September, 2008
  • Stipulated Date of Completion : May, 2009
  • Expenditure till Date : 1.30 Crores
  • Likely Completion date : January, 2010
  • Bottlenecks if any : Part sanction of Rs. 0.5 crores received in phase-II.
slide30

Name of Work:- Various Works under Police Modernization

Construction of Hostel Building of Trainee at PTS Kishangarh

Total Cost : 1.00 Crore

Location : Kishangarh

Date of Start : September, 2008

Stipulated Date of Completion : May, 2009

Expenditure till Date : 0.55 Crore

Likely Completion date : January, 2010

Bottlenecks if any : Part sanction of Rs. 0.2 crores received in phase-II.

slide31

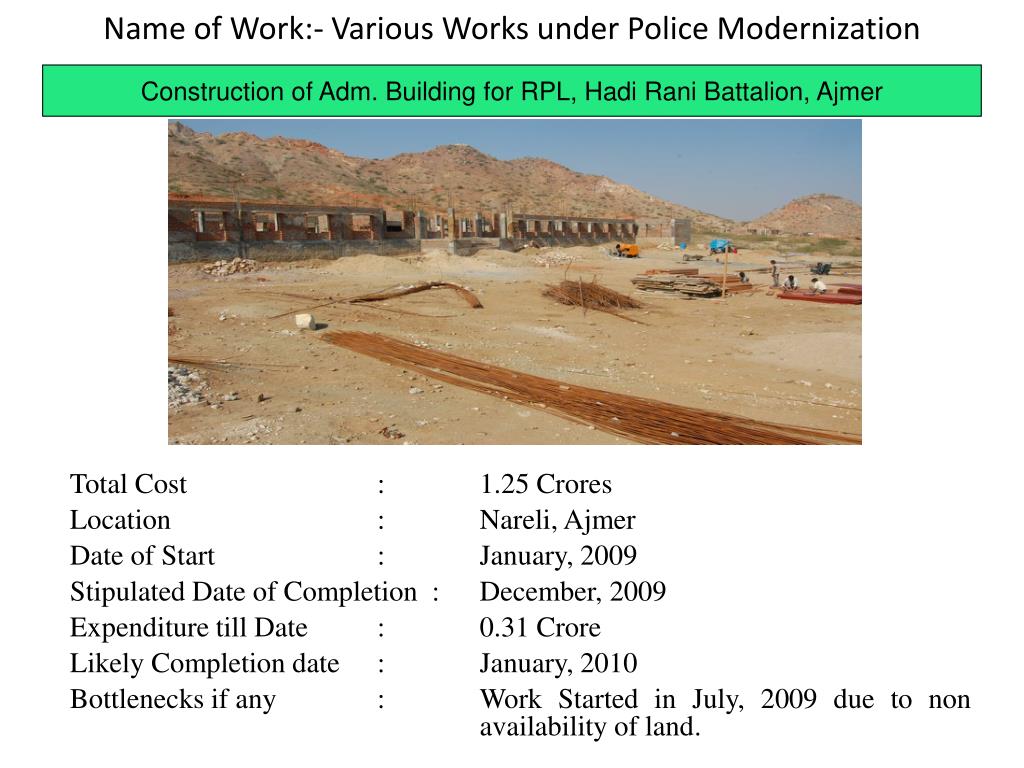

Name of Work:- Various Works under Police Modernization

Construction of Adm. Building for RPL, Hadi Rani Battalion, Ajmer

  • Total Cost : 1.25 Crores
  • Location : Nareli, Ajmer
  • Date of Start : January, 2009
  • Stipulated Date of Completion : December, 2009
  • Expenditure till Date : 0.31 Crore
  • Likely Completion date : January, 2010
  • Bottlenecks if any : Work Started in July, 2009 due to non availability of land.
slide32

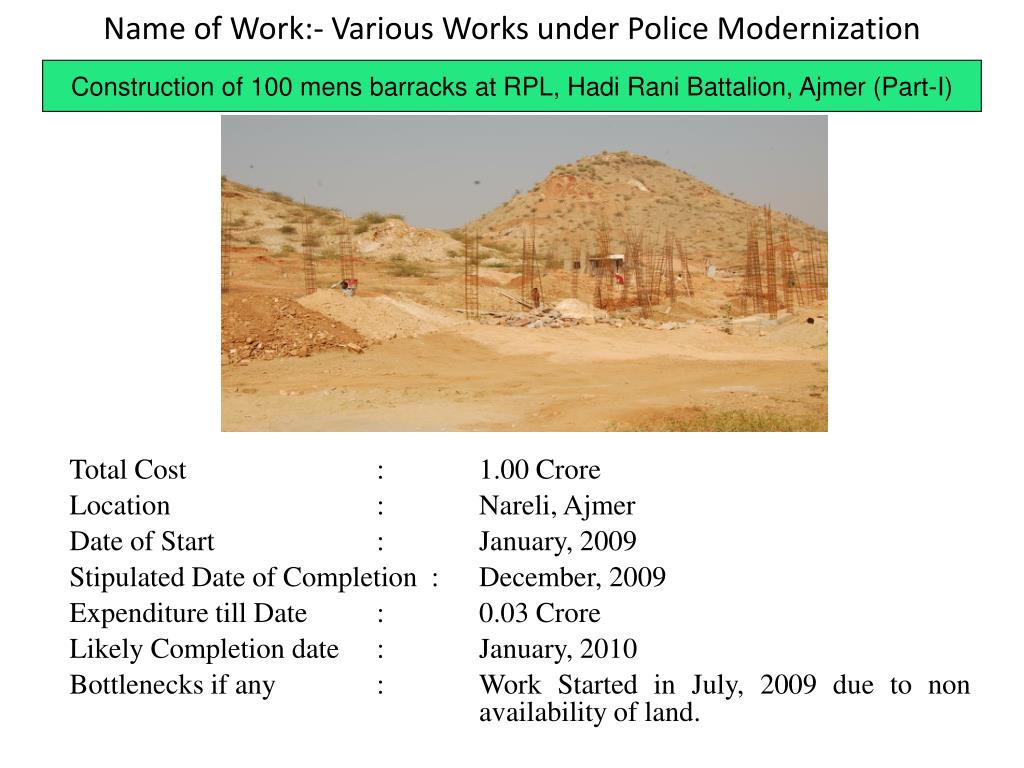

Name of Work:- Various Works under Police Modernization

Construction of 100 mens barracks at RPL, Hadi Rani Battalion, Ajmer (Part-I)

  • Total Cost : 1.00 Crore
  • Location : Nareli, Ajmer
  • Date of Start : January, 2009
  • Stipulated Date of Completion : December, 2009
  • Expenditure till Date : 0.03 Crore
  • Likely Completion date : January, 2010
  • Bottlenecks if any : Work Started in July, 2009 due to non availability of land.
slide33

Name of Work:- Various Works under Police Modernization

Construction of 100 mens barracks at RPL, Hadi Rani Battalion, Ajmer (Part-II)

  • Total Cost : 1.00 Crore
  • Location : Nareli, Ajmer
  • Date of Start : January, 2009
  • Stipulated Date of Completion : December, 2009
  • Expenditure till Date : 0.006 Crore
  • Likely Completion date : January, 2010
  • Bottlenecks if any : Work Started in July, 2009 due to non availability of land.
slide34

Name of Work:- Various other works in Unit-I, Ajmer

Construction of Canteen cum Guest House at Engineering College, Ajmer

  • Total Cost : 0.42 Crore
  • Location : Ajmer
  • Date of Start : December, 2007
  • Stipulated Date of Completion : July, 2008
  • Expenditure till Date : 0.26 Crore
  • Likely Completion date : March, 2010
  • Bottlenecks if any : -
slide35

Name of Work:- Various other works in Unit-I, Ajmer

Construction of Urban Hatt at Ajmer

  • Total Cost : 1.60 / 1.90 Crores
  • Location : Ajmer
  • Date of Start : June, 2007
  • Stipulated Date of Completion : May, 2008
  • Expenditure till Date : 1.14 Crores
  • Likely Completion date : March, 2010
  • Bottlenecks if any : Work Stopped since October, 2008 due to funds not released by client
