project closeout module 14

Project CloseoutModule #14

Prepared by

Dr. Randy R. Rapp

July 2005

acceptance of the work
Acceptance of the Work
  • Begins with contractor request for final inspection
  • Punch list
  • Final payment, minus disputed amounts
  • Retainage released after lien filing period and punch list corrections (surety must approve!)
  • Correction of work usually guaranteed one year; warranted indefinitely or until statute of limitations expires.

2005, Randy R. Rapp

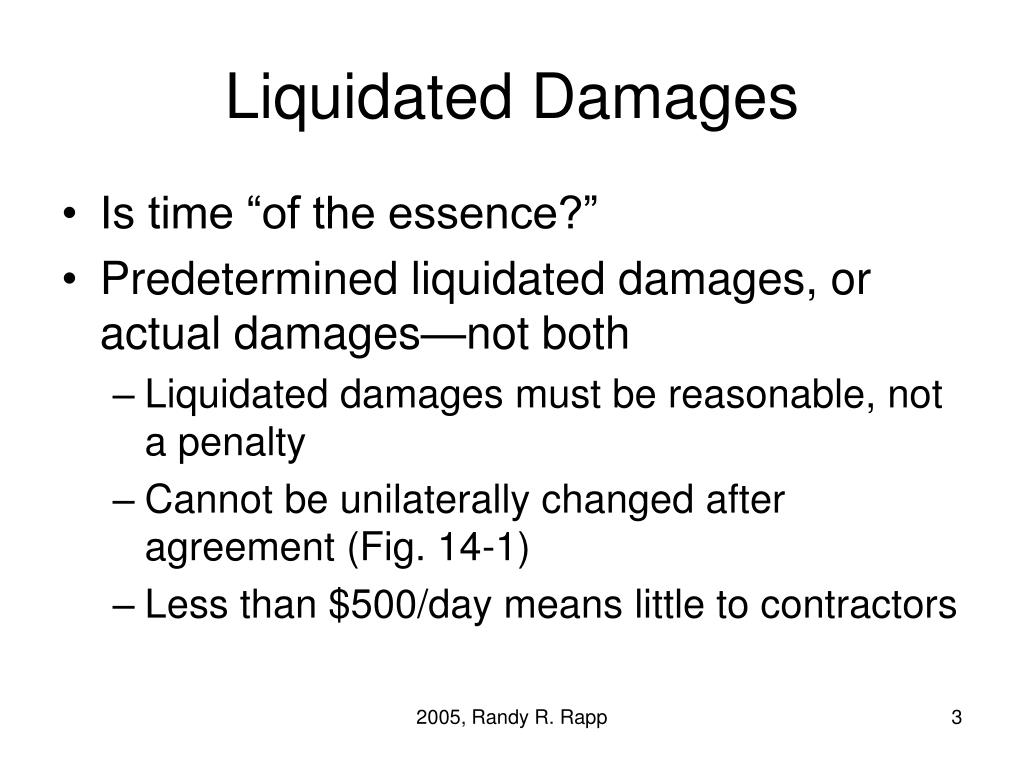

liquidated damages
Liquidated Damages
  • Is time “of the essence?”
  • Predetermined liquidated damages, or actual damages—not both
    • Liquidated damages must be reasonable, not a penalty
    • Cannot be unilaterally changed after agreement (Fig. 14-1)
    • Less than $500/day means little to contractors

2005, Randy R. Rapp

final cleanup
Final Cleanup
  • Full demobilization
  • No final acceptance until cleanup complete
  • Done at contractor’s expense

2005, Randy R. Rapp

punch list obligations
Punch List Obligations
  • Contractor
    • Subtrade work should be carefully checked during construction: “correct as you go”
    • No subtrade leaves until its work is acceptable to the contractor
  • Engineer
    • Noted deficiencies promptly corrected?
    • Prefinal inspection when contractor notifies
    • Sign and date numerical list
    • Continue numerical list if additional faults discovered

2005, Randy R. Rapp

minor deficiencies
Minor Deficiencies
  • “Failure to correct minor deficiencies in a substantially completed project is not a default; it is a constructive, deductive change.”
    • Cannot be a contractual default
    • Hold 1.5 to 2 times the estimated cost of uncorrected items from any payments

2005, Randy R. Rapp

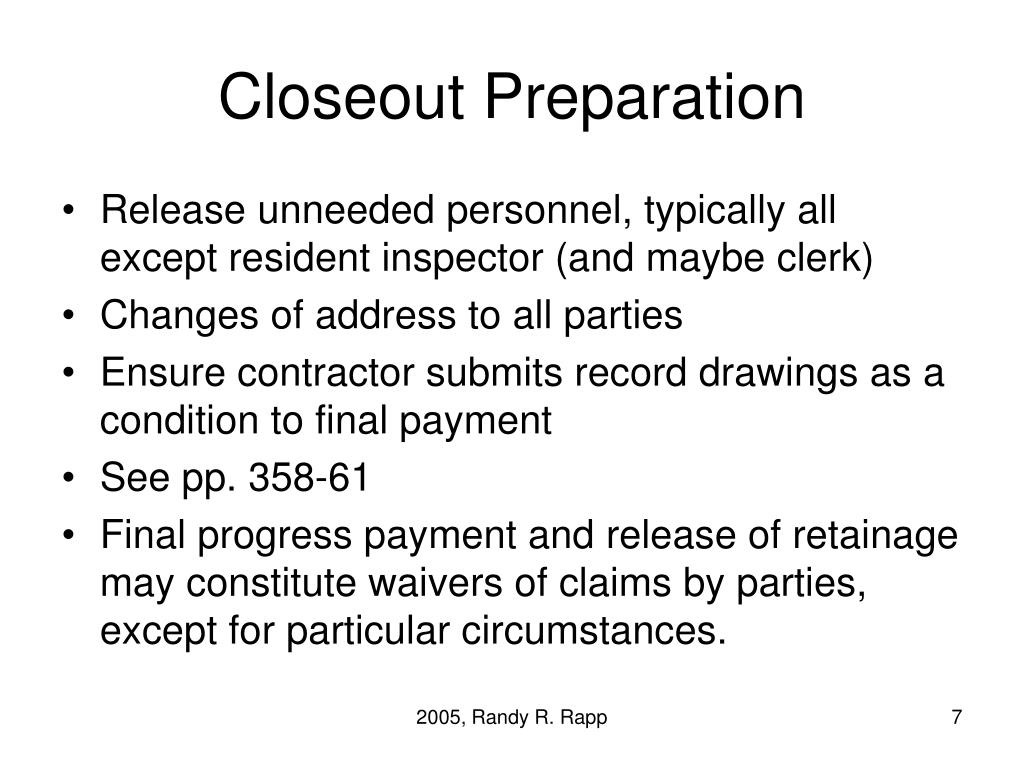

closeout preparation
Closeout Preparation
  • Release unneeded personnel, typically all except resident inspector (and maybe clerk)
  • Changes of address to all parties
  • Ensure contractor submits record drawings as a condition to final payment
  • See pp. 358-61
  • Final progress payment and release of retainage may constitute waivers of claims by parties, except for particular circumstances.

2005, Randy R. Rapp

completion vs substantial completion
CompletionVs. Substantial Completion
  • Black’s Law Dictionary:
    • Completion: no essential element lacking.
    • Substantial performance: no willful departure from the terms of the contract; only minor omissions or defects
  • What is minor? Can owner use work for purpose intended?
  • Some confusion in AIA documents: not really two stages of completion

2005, Randy R. Rapp

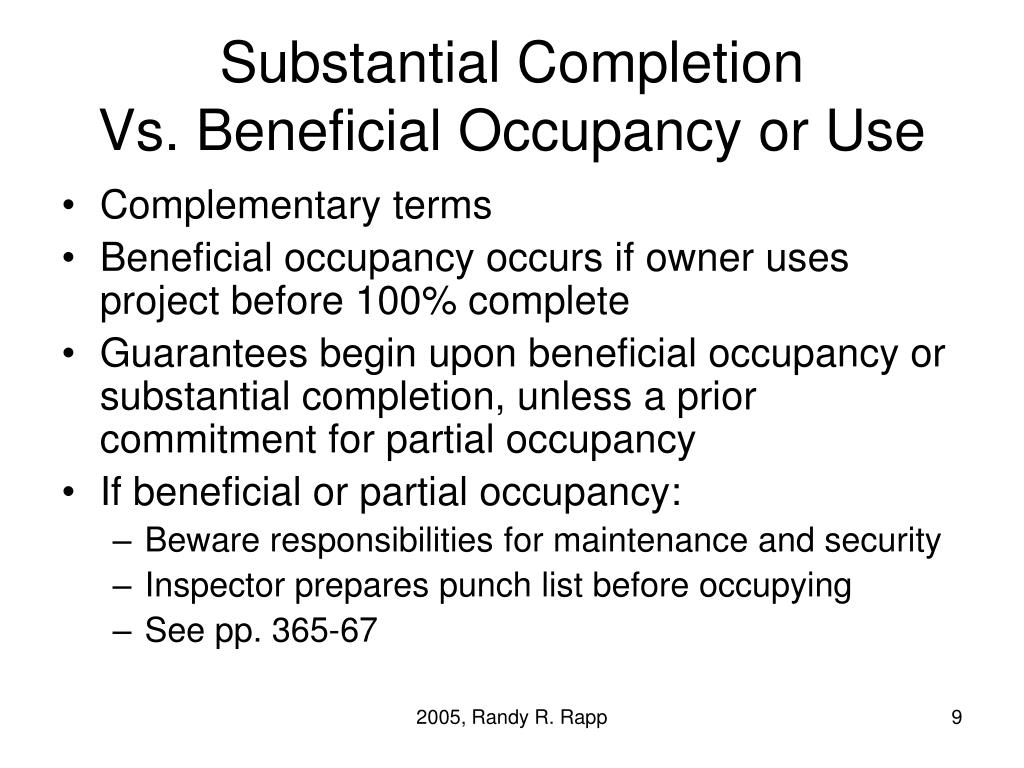

substantial completion vs beneficial occupancy or use
Substantial CompletionVs. Beneficial Occupancy or Use
  • Complementary terms
  • Beneficial occupancy occurs if owner uses project before 100% complete
  • Guarantees begin upon beneficial occupancy or substantial completion, unless a prior commitment for partial occupancy
  • If beneficial or partial occupancy:
    • Beware responsibilities for maintenance and security
    • Inspector prepares punch list before occupying
    • See pp. 365-67

2005, Randy R. Rapp

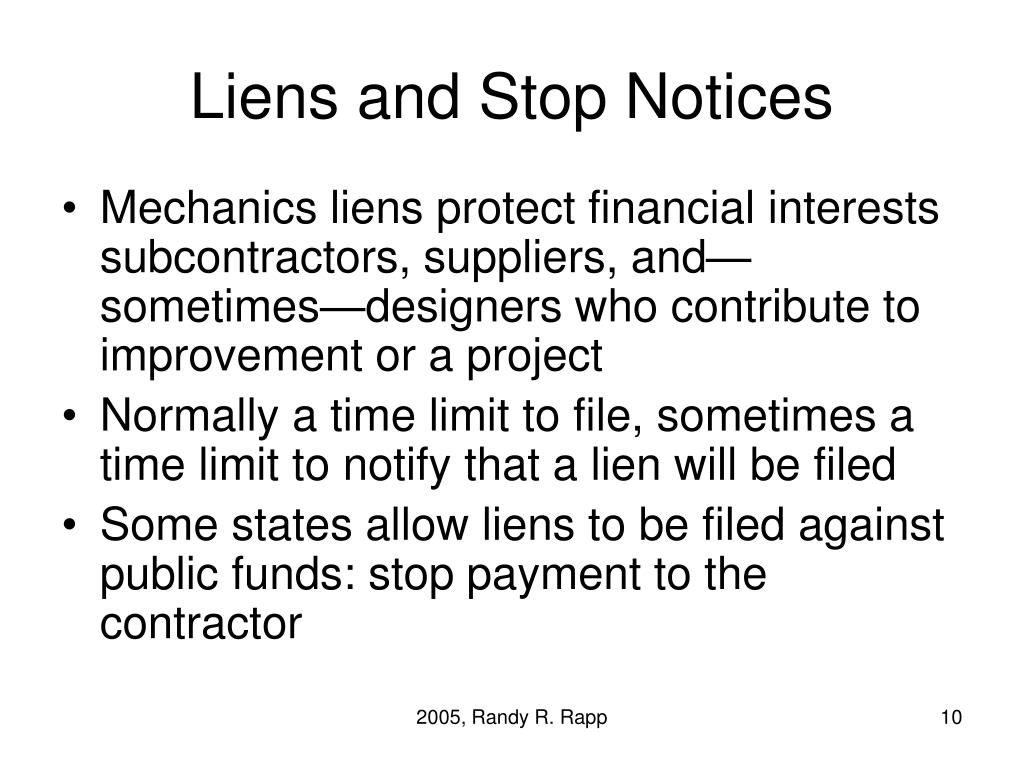

liens and stop notices
Liens and Stop Notices
  • Mechanics liens protect financial interests subcontractors, suppliers, and—sometimes—designers who contribute to improvement or a project
  • Normally a time limit to file, sometimes a time limit to notify that a lien will be filed
  • Some states allow liens to be filed against public funds: stop payment to the contractor

2005, Randy R. Rapp

lien waivers
Lien Waivers
  • Two versions:
    • Conditional waiver and release upon partial or final payment
    • Unconditional waiver and release upon partial or final payment (owner should expect only when concurrently issuing payment check)
  • Subcontractors paid after contractor, so unfair to expect waivers from them until they are paid for their work
    • Contractor affidavit swearing that all subs and suppliers have been paid
    • Contractor signs indemnification to reimburse owner in full, if a sub or supplier later files lien
    • Stop notice or lien release bond: owner released from lien obligation, but surety pays

2005, Randy R. Rapp

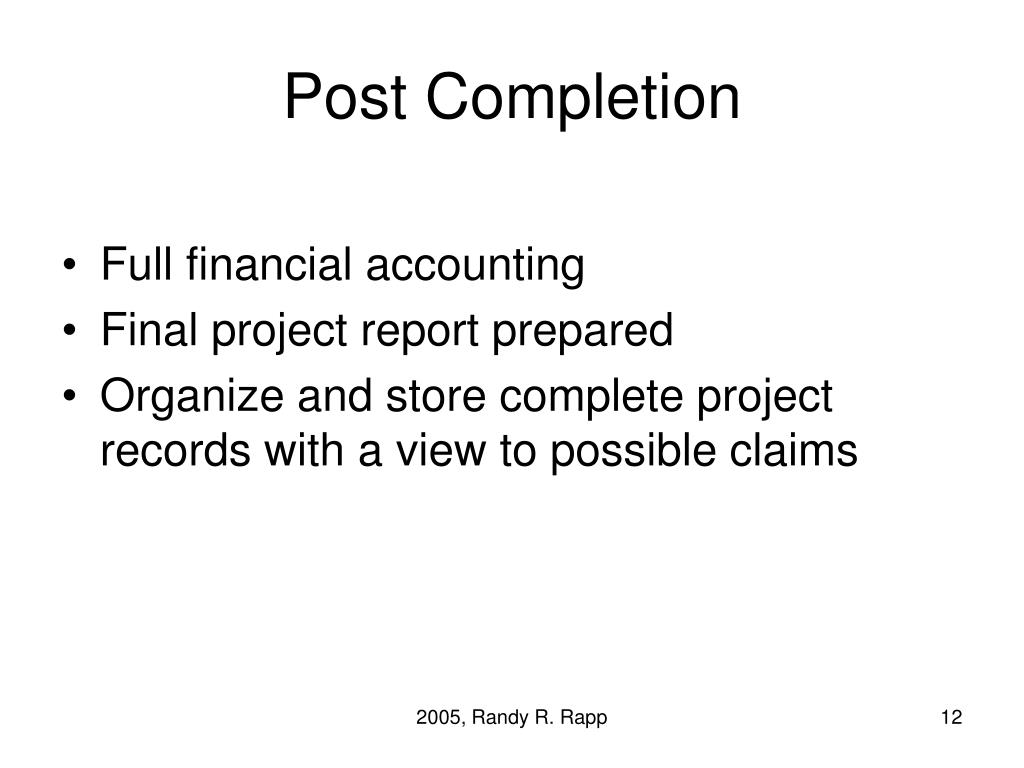

post completion
Post Completion
  • Full financial accounting
  • Final project report prepared
  • Organize and store complete project records with a view to possible claims

2005, Randy R. Rapp
