sarasota memorial health care system management council february 10 2010
Download
Skip this Video
Download Presentation
Sarasota Memorial Health Care System Management Council February 10, 2010

Loading in 2 Seconds...

play fullscreen
1 / 10

Sarasota Memorial Health Care System Management Council February 10, 2010 - PowerPoint PPT Presentation


  • 223 Views
  • Uploaded on

Sarasota Memorial Health Care System Management Council February 10, 2010. Construction Milestone Schedule. Project Milestones – Surgery Vertical Expansion:. Preparation for Structural Steel Close Arlington Street Capture Site Set up Crane for Structural Steel Open Arlington Street.

loader
I am the owner, or an agent authorized to act on behalf of the owner, of the copyrighted work described.
capcha
Download Presentation

PowerPoint Slideshow about 'Sarasota Memorial Health Care System Management Council February 10, 2010' - EllenMixel


An Image/Link below is provided (as is) to download presentation

Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author.While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server.


- - - - - - - - - - - - - - - - - - - - - - - - - - E N D - - - - - - - - - - - - - - - - - - - - - - - - - -
Presentation Transcript
project milestones surgery vertical expansion
Project Milestones – Surgery Vertical Expansion:
  • Preparation for Structural Steel
  • Close Arlington Street

Capture Site

Set up Crane for Structural Steel

  • Open Arlington Street

Target Start – 2/22/10

Target Start – 4/12/10

Target Start - 12/31/10

site phasing diagram surgery vertical expansion
Site Phasing Diagram – Surgery Vertical Expansion

Ambulance Access to be Maintained at All Times

Construction Zone for Crane, Material Deliveries, etc.

project milestones new bed tower

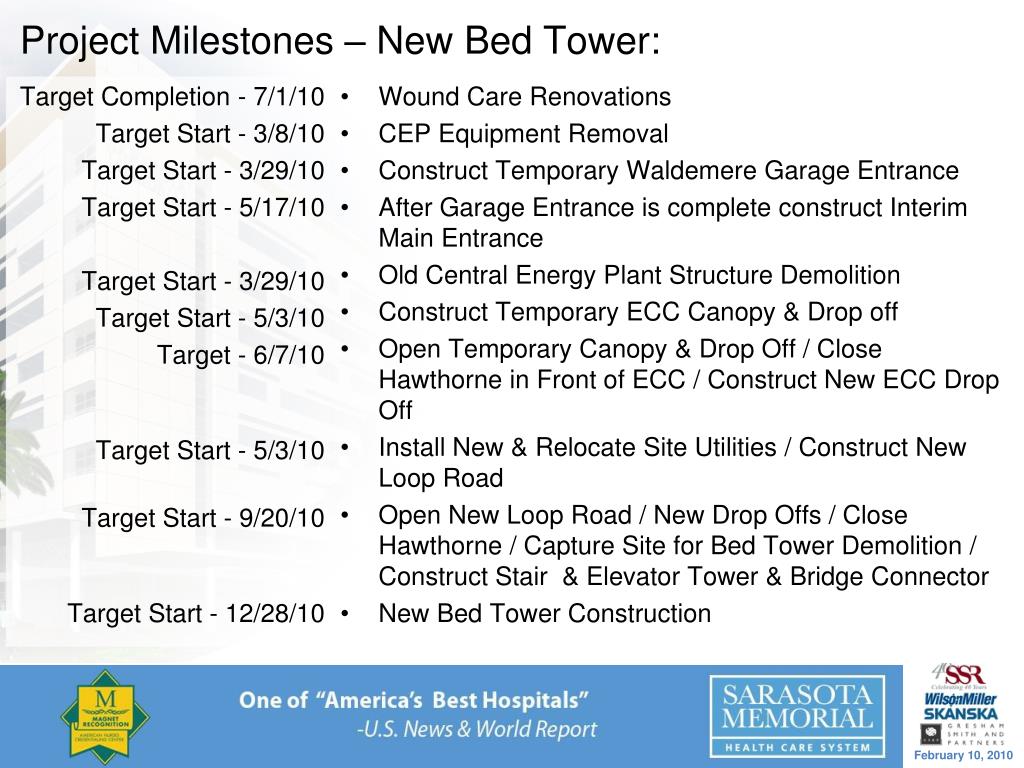

Project Milestones – New Bed Tower:
  • Wound Care Renovations
  • CEP Equipment Removal
  • Construct Temporary Waldemere Garage Entrance
  • After Garage Entrance is complete construct Interim Main Entrance
  • Old Central Energy Plant Structure Demolition
  • Construct Temporary ECC Canopy & Drop off
  • Open Temporary Canopy & Drop Off / Close Hawthorne in Front of ECC / Construct New ECC Drop Off
  • Install New & Relocate Site Utilities / Construct New Loop Road
  • Open New Loop Road / New Drop Offs / Close Hawthorne / Capture Site for Bed Tower Demolition / Construct Stair & Elevator Tower & Bridge Connector
  • New Bed Tower Construction

Target Completion - 7/1/10

Target Start - 3/8/10

Target Start - 3/29/10

Target Start - 5/17/10

Target Start - 3/29/10

Target Start - 5/3/10

Target - 6/7/10

Target Start - 5/3/10

Target Start - 9/20/10

Target Start - 12/28/10

site phasing diagram 1

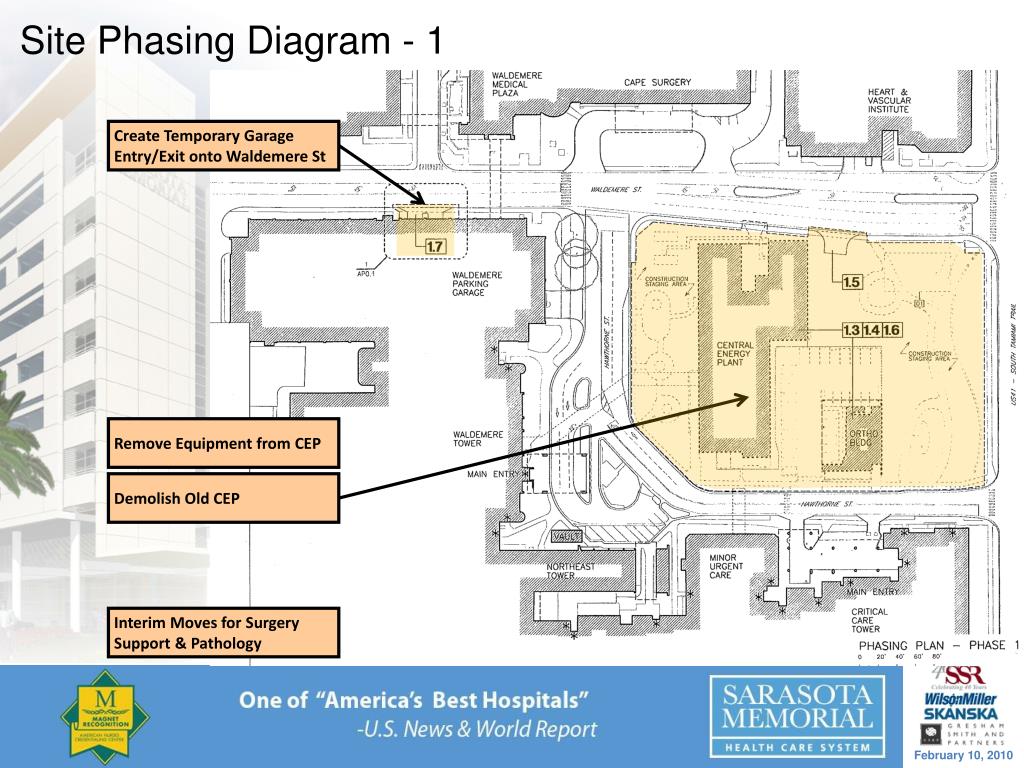

Site Phasing Diagram - 1

Create Temporary Garage Entry/Exit onto Waldemere St

Remove Equipment from CEP

Demolish Old CEP

Interim Moves for Surgery Support & Pathology

site phasing diagram 2
Site Phasing Diagram - 2

Create Temporary ECC Entry Drop-Off

Temporary ECC Entry Canopy

site phasing diagram 3
Site Phasing Diagram - 3

Open New Entry/Exit at Waldemere Garage

Build Temp Main Entrance Canopy, Drop-off & Vestibule

Construct New Loop Road and Associated Utilities

Close Hawthorne Street

Open Temporary ECC Entry Canopy & Drop-off

Construct New ECC Vestibule, Canopy & Drop-off

Temporary Route to ECC

site phasing diagram 4
Site Phasing Diagram - 4

Open New Loop Road

Open Temporary Main Entry Canopy & Drop-off

Open ECC Vestibule, Canopy & Drop-off

Demolish Existing Main Entry Canopy

Demolish Portion of Critical Care Tower for New Bridge

Demolish Northeast Tower

site phasing diagram 5
Site Phasing Diagram - 5

Construct New Bed Tower and Bridge
