Mis 518 term project om decisions and software projects
This presentation is the property of its rightful owner.
Sponsored Links
1 / 93

MIS 518 – Term Project OM Decisions and Software Projects PowerPoint PPT Presentation


  • 82 Views
  • Uploaded on
  • Presentation posted in: General

MIS 518 – Term Project OM Decisions and Software Projects. Turhan Atar Alp Eren Aydın Mehmet Nuri Can. 10 OM Decisions. Design of goods and services Managing quality Process and capacity design Location strategy Layout strategy Human resources and job design Supply chain management

Download Presentation

MIS 518 – Term Project OM Decisions and Software Projects

An Image/Link below is provided (as is) to download presentation

Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author.While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server.


- - - - - - - - - - - - - - - - - - - - - - - - - - E N D - - - - - - - - - - - - - - - - - - - - - - - - - -

Presentation Transcript


Mis 518 term project om decisions and software projects

MIS 518 – Term Project OM Decisions and Software Projects

Turhan Atar

Alp Eren Aydın

Mehmet Nuri Can


10 om decisions

10 OM Decisions

  • Design of goods and services

  • Managing quality

  • Process and capacity design

  • Location strategy

  • Layout strategy

  • Human resources and job design

  • Supply chain management

  • Inventory management

  • Scheduling

  • Maintenance


Mis 518 term project om decisions and software projects

MANAGING PROCESS QUALITY


Mis 518 term project om decisions and software projects

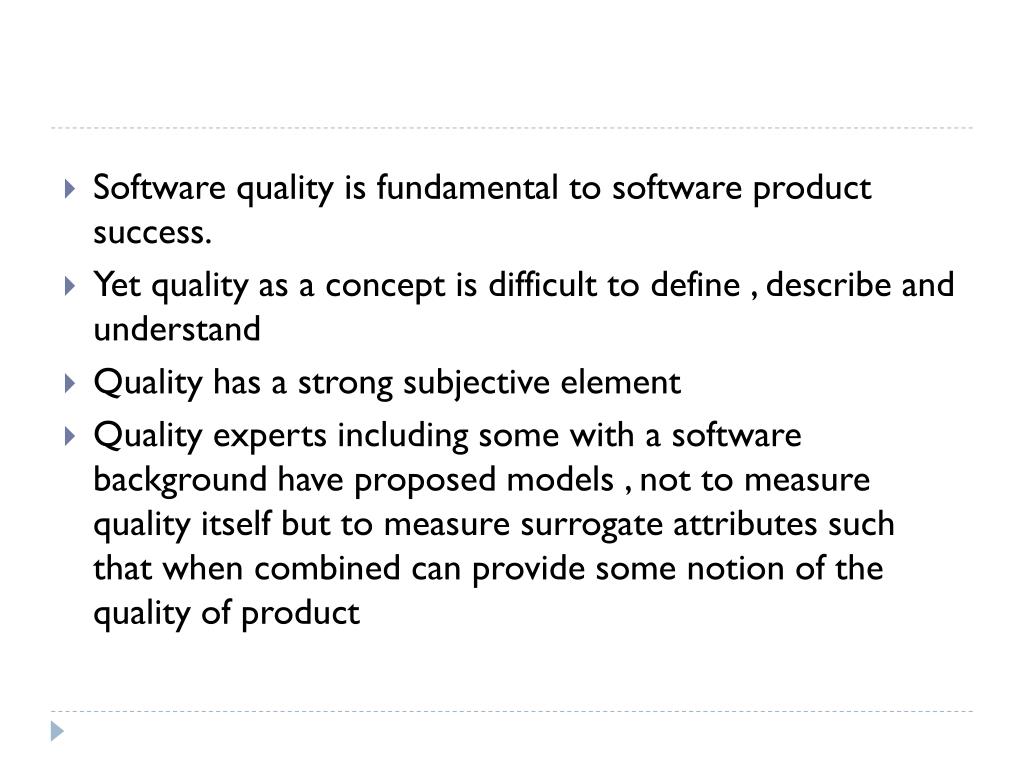

  • Software quality is fundamental to software product success.

  • Yet quality as a concept is difficult to define , describe and understand

  • Quality has a strong subjective element

  • Quality experts including some with a software background have proposed models , not to measure quality itself but to measure surrogate attributes such that when combined can provide some notion of the quality of product


Standart types

STANDART TYPES

  • ISO/IEC 9126

  • CMM


Iso iec 9126

ISO/IEC 9126

  • ISO and International Electrical Technical Commision have developed ISO/IEC 9126 for Software Engineering

  • It is focusing on end product quality more than software process quality

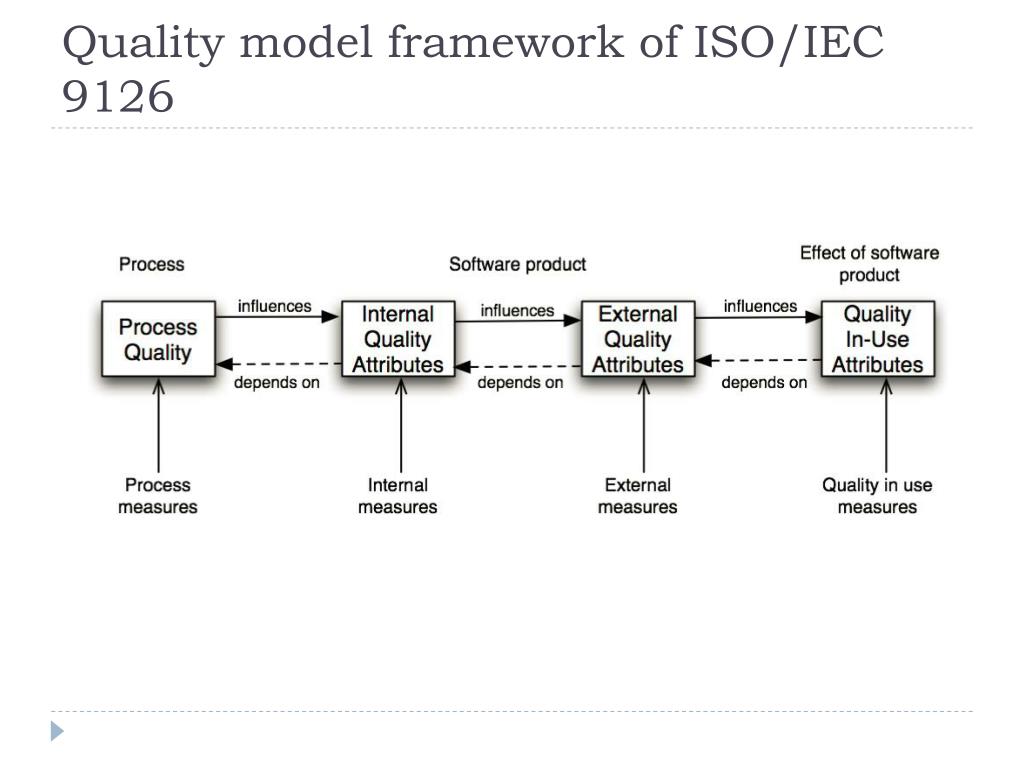

Quality model framework of iso iec 9126

Quality model framework of ISO/IEC 9126


Mis 518 term project om decisions and software projects

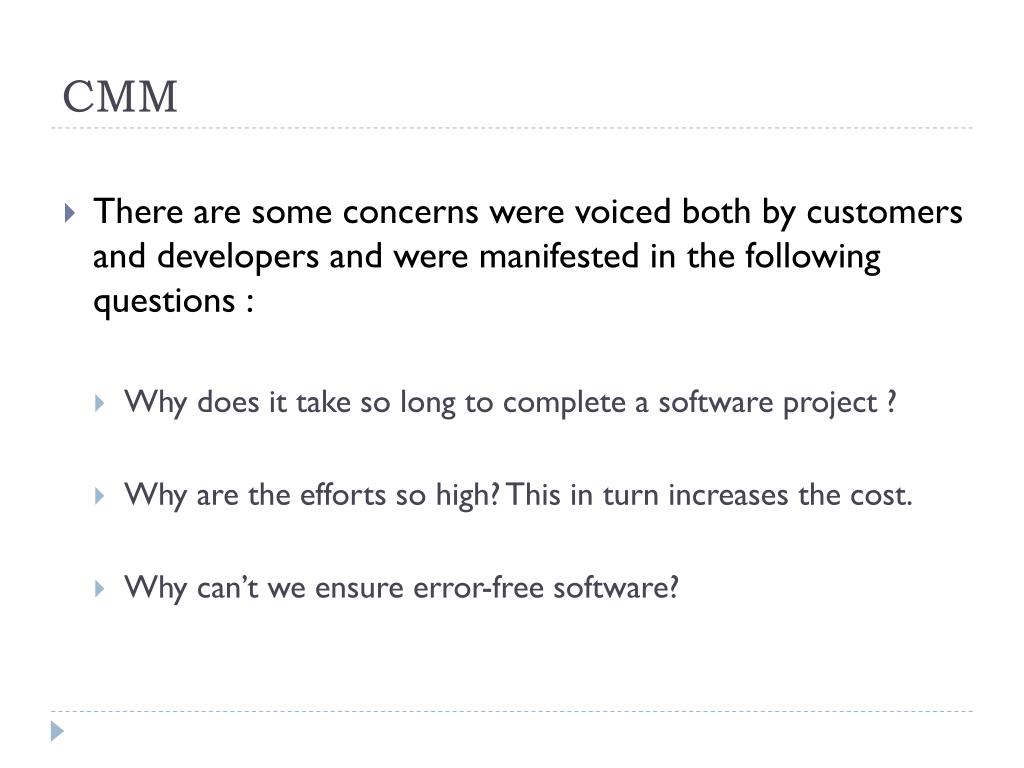

CMM

  • There are some concerns were voiced both by customers and developers and were manifested in the following questions :

    • Why does it take so long to complete a software project ?

    • Why are the efforts so high? This in turn increases the cost.

    • Why can’t we ensure error-free software?


Mis 518 term project om decisions and software projects

  • There was a need for a more disciplined effort in developing software.

  • The software engineering practices provided a framework for building high quality software.

  • Software Engineering Institute (SEI) developed a Capability Maturity Model (CMM) , which defined key performance areas from an initial level of maturity to a level of optimisation.


Software process quality factor

Software Process Quality Factor


Mis 518 term project om decisions and software projects

  • Some of the organizations didn’t following any standards during software development and had problem with quality aspects of the software.


Mis 518 term project om decisions and software projects

  • The software products need further improvement after released and unsatisfied customer with the quality or performance of the products.


Mis 518 term project om decisions and software projects

  • The development of software certification model is beneficial not only to the users but also to the vendor and stakeholders as well.


Mis 518 term project om decisions and software projects

  • Software certification can be implemented in three different approaches : product , process and people

  • Benefits :

    • Provides useful information that can prevent users that buying software that has doubtful quality level

    • A mechanism that can generate a form of confidence to customers


Mis 518 term project om decisions and software projects

  • Can enforce discipline by encouraging the use of good software engineering practices and standards during development

  • An alternative approach for continuous software quality improvement

  • Enhancing and improving the quality and productivity of software development process


Mis 518 term project om decisions and software projects

  • Most of the existing software certification models are directly focused on assessing and certifying software through its product quality approach.

  • Quality of software products should be evaluated separately from the software development process.


Mis 518 term project om decisions and software projects

  • Many researchers believe product-based approach can give confidence to consumers about the quality of software.

  • Product based approach is hard to practice especially for the new software which just ready to be marketed or delivered.


Mis 518 term project om decisions and software projects

  • Deming’s premise that

    «The quality of the product is largely governed

    by the quality of process used to develop it.»

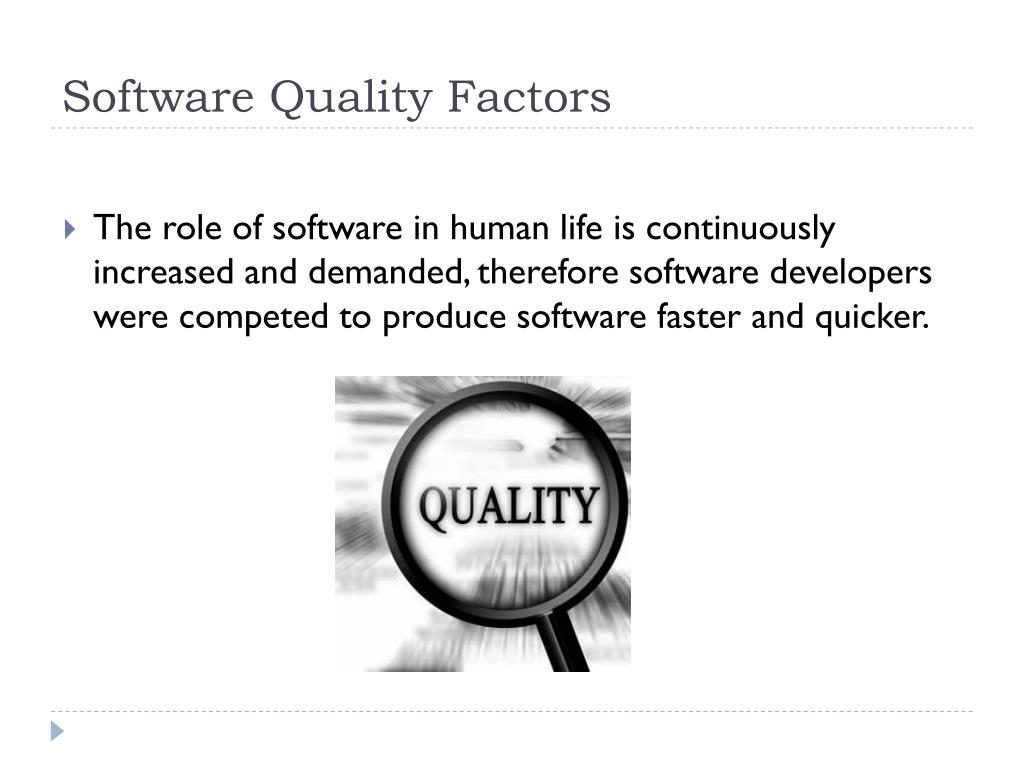

Software quality factors

Software Quality Factors

  • The role of software in human life is continuously increased and demanded, therefore software developers were competed to produce software faster and quicker.


Mis 518 term project om decisions and software projects

  • A software project is considered failed if these factors exist


Mis 518 term project om decisions and software projects

Software development methodology is important because it is to ensure the successful of development of products quality , increase productivity and ensure that the software had been developed in a cost effective manner.


Mis 518 term project om decisions and software projects

  • Apart from technology and environmental factors, it is also necessity to focus on the quality of developers.

  • They are designing , developing, changing the system

  • Skills and creativity of the developers can give an impact on software process effectiveness.


Mis 518 term project om decisions and software projects

  • The quality of developer can be measured in terms of skills, training and motivation.

  • Factors for determining the effectiveness of software processes were identified by four main factors

  • Human, Management, Economics , Technology


Mis 518 term project om decisions and software projects

  • Key practices influencing the successful software development process


Mis 518 term project om decisions and software projects

  • The factors identified through the state of theory and practice.


Mis 518 term project om decisions and software projects

  • As we have seen factors were derived into several sub factors in order to easily defined the quality attributes or metrics and measures for each of them.

  • And for each sub factor , measurement goals, metrics and measure have been defined by applying the Goal-Question-Metric method.


Mis 518 term project om decisions and software projects

  • Each goal contains one or several questions.

  • The question represents how each goal can be measured.

  • For each question , the metrics to be measured are defined and at least one measure is derived for each metrics.

  • The measure is used to determine appropriate quality achievement of each metrics.


Measurement metric

Measurement Metric


Mis 518 term project om decisions and software projects

  • Number of standards based on software process quality will increase


Mis 518 term project om decisions and software projects

Staffing & Scheduling


Failures

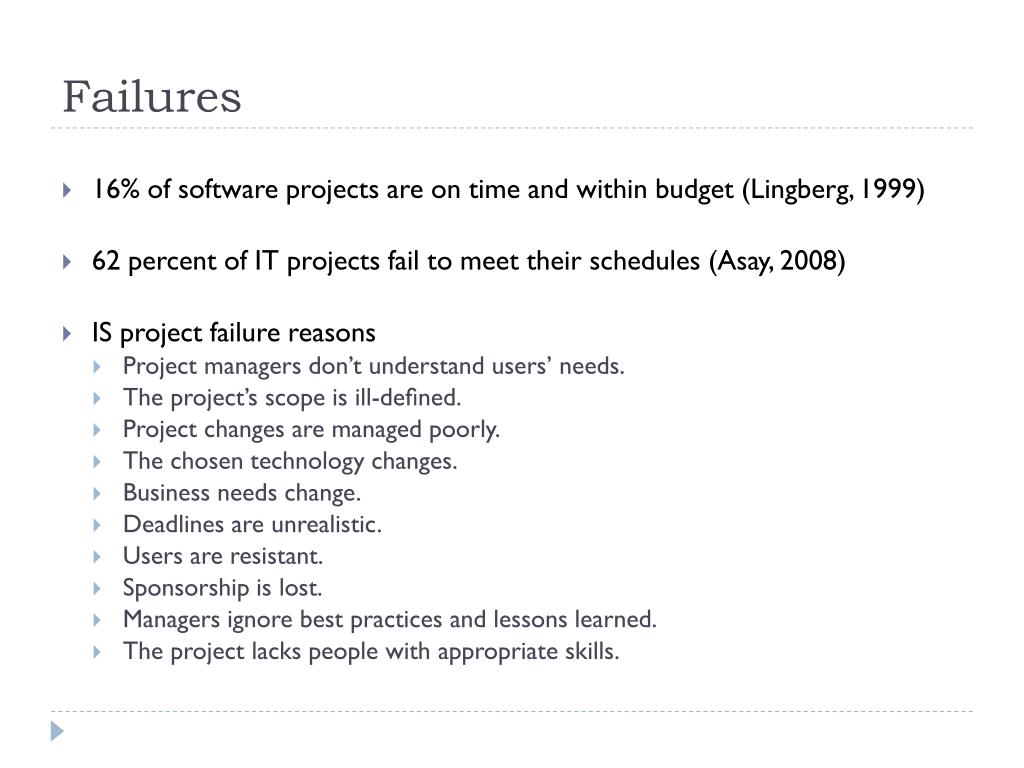

Failures

  • 16% of software projects are on time and within budget (Lingberg, 1999)

  • 62 percent of IT projects fail to meet their schedules (Asay, 2008)

  • IS project failure reasons

    • Project managers don’t understand users’ needs.

    • The project’s scope is ill-defined.

    • Project changes are managed poorly.

    • The chosen technology changes.

    • Business needs change.

    • Deadlines are unrealistic.

    • Users are resistant.

    • Sponsorship is lost.

    • Managers ignore best practices and lessons learned.

    • The project lacks people with appropriate skills.

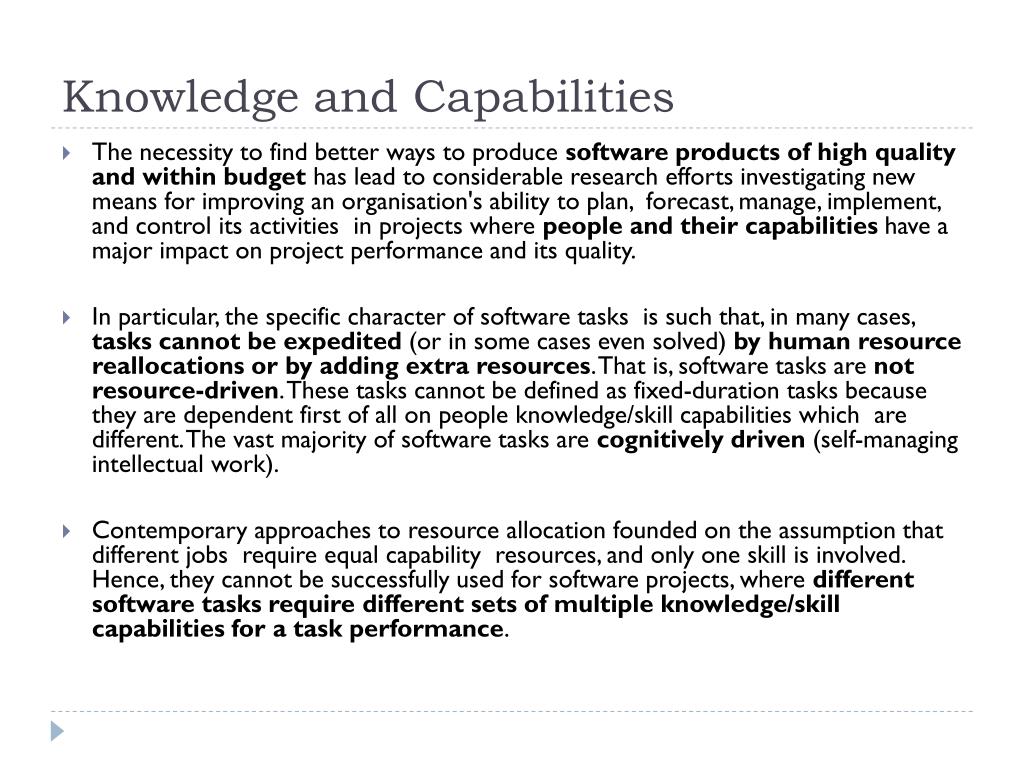

Knowledge and capabilities

Knowledge and Capabilities

  • The necessity to find better ways to produce software products of high quality and within budget has lead to considerable research efforts investigating new means for improving an organisation's ability to plan, forecast, manage, implement, and control its activities in projects where people and their capabilities have a major impact on project performance and its quality.

  • In particular, the specific character of software tasks is such that, in many cases, tasks cannot be expedited (or in some cases even solved) by human resource reallocations or by adding extra resources. That is, software tasks are not resource-driven. These tasks cannot be defined as fixed-duration tasks because they are dependent first of all on people knowledge/skill capabilities which are different. The vast majority of software tasks are cognitively driven (self-managing intellectual work).

  • Contemporary approaches to resource allocation founded on the assumption that different jobs require equal capability resources, and only one skill is involved. Hence, they cannot be successfully used for software projects, where different software tasks require different sets of multiple knowledge/skill capabilities for a task performance.


Staffing decision

Staffing Decision

  • One of the most critical factors driving the success of software projects: the staffing decision

  • As projects slipped behind schedule, managers would attempt to increase the staff at fairly late stages in order to speed up the project. However, employing more people would result in higher communication and training overheads, thereby affecting adversely the productivity of the existing staff, and setting the project back even further.

  • To assign right person to the right project is a complicated decision. Major contributors to the outcome of software projects are personnel assignment decisions


Staffing decision1

Staffing Decision

  • Managing software personnel remains a very complicated endeavor. A major contributor to this complexity is the increased demand for specialized individual skills in the workforce, which results from high turnover rates and the fast pace at which new technologies and techniques are being developed. As a result of higher demands, candidates with exact required skills to work tasks are usually not available. Due to the lack of proper methods to assess personnel capabilities, decision makers are forced to assign resources to tasks based on subjective measures only. This results in excess training times that significantly affect the schedule of projects.

  • Because a resource allocation methodology in software projects is not common and well-determined, most managers make allocation decisions in a highly subjective manner. Software managers typically make assignments based on ‘‘their experience, heuristic knowledge, subjective perception, and instinct"


Contemporary project management models

Contemporary Project Management Models

  • Duggan, Byrne, & Lyons (2004) developed a multi-objective optimization model for software task allocation based on genetic algorithms.

  • Tsai, Moskowitz & Lee (2003) proposed selecting resources using the CRD method and the Taguchi’s parameter design approach.

  • Another methodology used to evaluate staffing alternatives is the Analytical Hierarchy Process (AHP).


Contemporary project management models1

Contemporary Project Management Models

  • Antoniol, Cimitile, Lucca, & Penta (2004) used queuing theory and stochastic simulation to study staffing needs for software maintenance problems.

  • Shaikh (1998) presented a model for project staff reallocation. The objective of the model was to increase the probability of projects finishing on time by avoiding delays caused by lack of needed work-force at scheduled start dates. The model, based on the Lead Time concept from Inventory Theory

  • Abdel-Hamid (1989) proposed a model to study the dynamic implications of staffing policies to the cost and schedule of projects.


Lack of contemporary project management models

Lack of Contemporary Project Management Models

  • Contemporary project management scheduling approaches cannot be sufficiently used for software projects.

  • They are concerned with resource availability and utilisation, and do not provide study, analysis and management of resource capabilities and compatibilities.

  • For the moment there is no widely accepted methodology for scheduling and staffing software projects. Nevertheless there are some models which have been desinged in the last years.

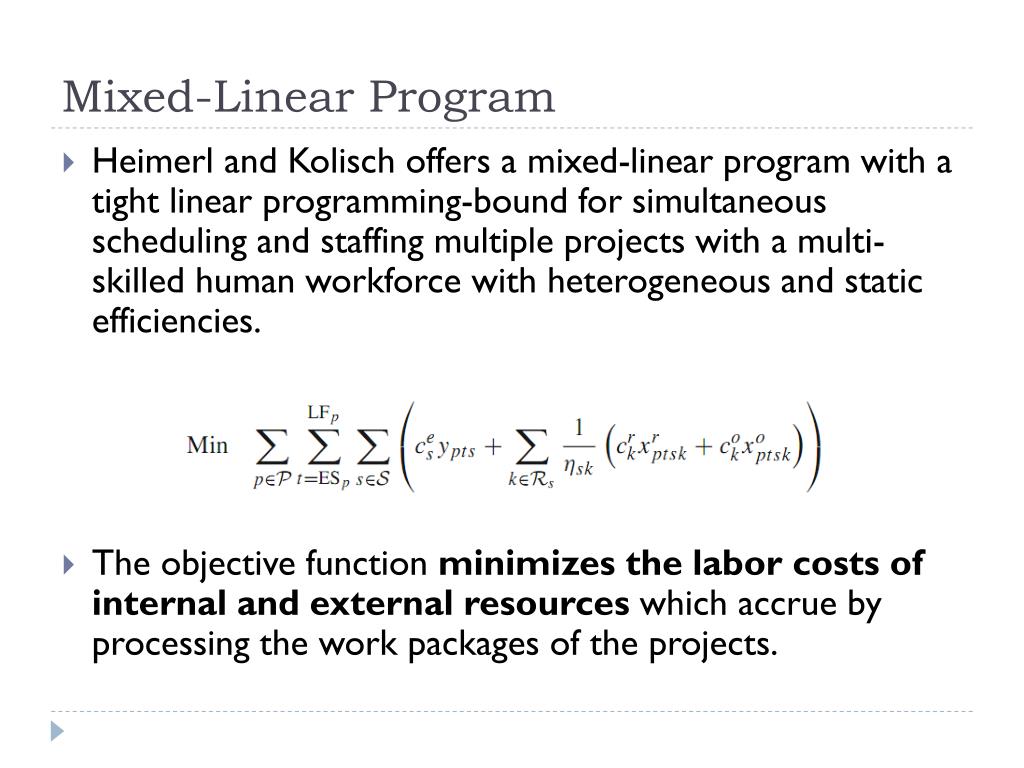

Mixed linear p rogram

Mixed-Linear Program

  • Heimerl and Kolisch offers a mixed-linear program with a tight linear programming-bound for simultaneous scheduling and staffing multiple projects with a multi-skilled human workforce with heterogeneous and static efficiencies.

  • The objective function minimizes the labor costs of internal and external resources which accrue by processing the work packages of the projects.


Padberg s model

Padberg’s Model

  • Padberg F. presents a generic model for software projects which explicitly takes a scheduling strategy as input.

  • No process modelling language is used in that model, just standard mathematical notations with a probabilistic approach.

  • When the scheduling strategy is fixed, the model outputs a probability distribution for the project completion time and a completion time estimate.

  • The model describes the software process at a high level of abstraction : teams work on, software components.

  • The intention is to keep the model as lean as possible for the time being and classical process phases such as coding or testing are not used in that model.


Best fitted resource bfr

Best – Fitted Resource (BFR)

  • BFR methodolgy defines many inputs and allocate the resources to the projects by using linear programming.

  • There are 5 steps to describe those inputs and to find outputs;

    • Task Required Skills(TRS) – TRS Table

    • Skill Relationships(SR) – SR Table

    • Resources’ Skill Set(RSS) – RSS Table

    • Best-Fitted Resource(BFR) – BFR Table

    • Resource Allocation to Multiple Tasks (RA)


Mis 518 term project om decisions and software projects

BFR

  • H: set of all skills

  • H(t): set of required skills for task t

  • ejt : expected use of skill j on task t. Assigned values range from 0 to 1

    • 1 = highly used

    • 0 = not used

  • cjt: complexity of skill j on task t. Assigned values range from 0 to 1

    • 1 = high level of complexity on the task for this skill

    • 0 = no complexity

  • sjt: significance of skill j on task t = cjp ejp. Calculated values range from 0 to 1

    • 1 = critically important

    • 0 = not important


Mis 518 term project om decisions and software projects

BFR

  • rjk: relationship between the level of knowledge of known skill j and the level of knowledge for required skill k. Assigned values range from 0 to 1

    • 1 = strong relationship

    • 0 = no relationship

    • if j = k and the level of knowledge of both j and k are equal, then rjj =1

  • lyj: level of knowledge of resource y for skill j. Assigned values range from 0 to 1

    • 1 = expert

    • 0 = no knowledge

  • byj: relationship between resource y and its known skills and skill j calculated values range from 0 to 1

    • 1 = strong relationship; resource y is an expert in the skill or a highly related skill

    • 0 = no knowledge in the skill or in a related skill

  • Fyt: fit of resource y to task t. Calculated values range from 0 to 1

    • 1 = strong fit

    • 0 = resource is a bad fit for the task

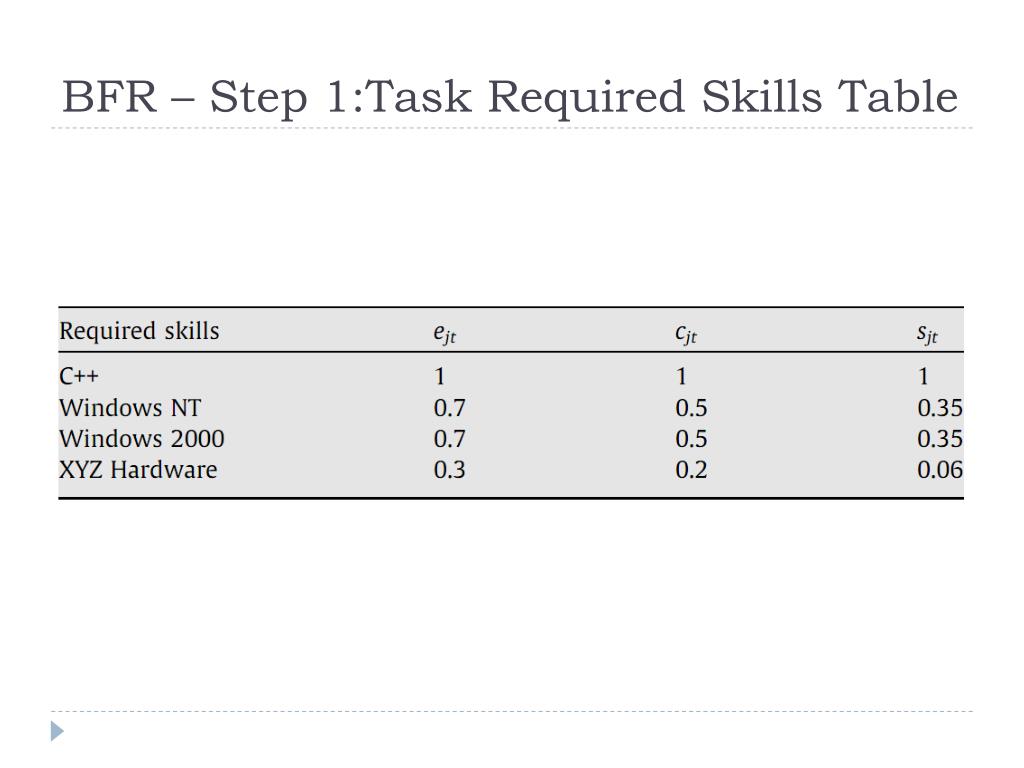

Bfr step 1 task required skills table

BFR – Step 1:Task Required Skills Table

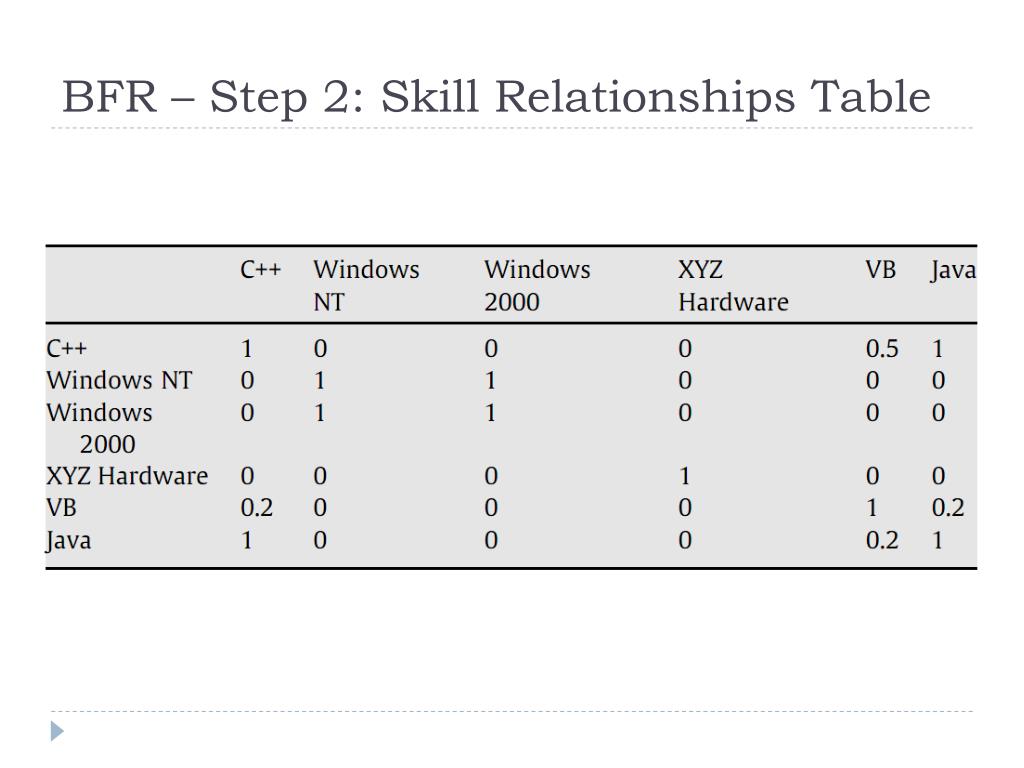

Bfr step 2 skill relationships table

BFR – Step 2: Skill Relationships Table


Bfr step 2 skill relationships table1

BFR – Step 2: Skill Relationships Table


Bfr step 3 resources skill set table

BFR – Step 3: Resources’ Skill Set Table


Bfr step 3 resources skill set table 2

BFR – Step 3: Resources’ Skill Set Table 2


Bfr step 4 best fitted resource bfr table

BFR – Step 4: Best-Fitted Resource(BFR) Table


Mis 518 term project om decisions and software projects

Human Resources Management & Job Design


Outline

Outline

  • Definition

  • Components of HRM

  • Planning

  • Attracting

  • Developing; Recruitment(Internal or external) and selection

  • Evaluating

  • Motivating and Rewarding Employees

  • Maintaining High Performance

  • Motivation Theories

  • Conflict Management

  • Job analysis; Job description and Job specification


Human resources management is

Human Resources Management is

  • A series of integrated decisions that form the employment relationship; their quality contribures to the ability organisation and employees to achieve their objectives

    - Milkovich and Boundreau


Human resources management is1

Human Resources Management is

  • The planning, organising, directing and controlling of procurement, development, compensation, integration, maintenance and seperation of human resources to the end that individual, organisational and social objectives are accomplished

    Edwin B. Flippo


Main components of hrm

Main Components of HRM

  • Planning

  • Attracting

  • Placing, Developing and Evaluating

  • Motivating and Rewarding Employees

  • Maintaining High Performance


Planning

Planning

  • Human Resource Planning is the process of forecasting a firm’s future demand for, and supply of the right type of people in the right number. It includes how many qualified people necesssary to carry out assigned activities. Human resources planning translates the organisations objectives and plans into number and quality of workers needed to meet those objectives.


Human resources plan shoud include

Human Resources Plan Shoud Include

  • Roles and Responsibilities; Role, Authority, Responsibility and Competency

  • Responsibility Assignment Matrix and Organization Chart

  • Staffing Management Plan; Staffing acquisition, Resource Calenders, training needs, recognition and rewards

  • Enterprise Environmental Factors; Organisational Culture, Personnel, infrustructure


Responsibility assignment matrix

Responsibility Assignment Matrix


Hierarchical chart

Hierarchical Chart

Responsibility Assisment Matrix and Hierarchical Chart

should be in allignment with each other in terms of authority.


Attracting

Attracting

  • Identify Job Openings

  • Review Job descriptions; Job title, location, job summary, duties, machine tools, working conditions

  • Review job specifications; Education, experience, training, responsibilities, emotional characteristics.

  • Determine your recruitment method; School, college, university visits, advertisement, use of government agencies, contact with professional labour associations, company website.


Developing recruitment internal or external and selection

Developing; Recruitment(Internal or external) and selection

  • Sources of Recruitment(External and Internal)

  • Recruiting Yield Pyramid

  • Internal vs External Recruitment(advantages disadvantages)

  • Process of Selection

  • Factors affecting selection


External internal recruitment

External, Internal Recruitment


Recruiting yield pyramid

Recruiting Yield Pyramid


Internal recruitment

Internal Recruitment

Advantages

It is less costly

Candidates are already oriented towards organization

Organization has better knowledge of candidates

Enhancement of Employee Morale and motivation

Disadvantages

It abets raiding(make a person provide something)

Candidate’s current work may be affected

Politics play great role

Morale problems for those not promoted


External recruitment

External Recruitment

Advantages

Benefits of new skill, new talent and experiences to the organization

Scope of resentment, jeaulosies and heartburn are avoided

Disadvantages

Better Morale and motivation associated with Internal recruiting is denied to the organisation

it is costly


Process of selection

Process of Selection

  • Selection is the process of differentiating between applicants in order to identify those with greater likelihood of success in a specific job. Right Combination of education, work experience, attitute and creativity should be met.


Selection criterias

Selection Criterias

  • Experience

  • Background

  • Attitude

  • Reliability

  • References; Former work supervisors are most useful, Letters from friends are useless for predicting future success


Factors affecting selection

Factors affecting Selection

External Environment

  • Supply and demand of specific skill

  • Unemployment rate

  • Company’s image

  • Legal and Political consideration

    Internal Environment

  • Human Resources Plan

  • Cost of Hiring


Factors affecting it human resources selection

Factors Affecting IT Human Resources Selection

  • Technical Specialties, knowledge skills; languages known(C, C++, COBOL), Data Management, Structured programming

  • Technology Management knowledge/skills; Ability to leran new technology, ability to understand technological trends

  • Business Function knowledge/skills;ability to learn business functions,ability to understand business environment


Factors affecting it human resources selection1

Factors Affecting IT Human Resources Selection

  • Interpersonel and management knowledge/skills; Ability to plan executive work in a colloborative environment, ability to teach others, ability to accomplish assignments

  • Previous project performances


Process of selection1

Process of selection


Evaluating

Evaluating

  • Evaluation maintains motivation of the organisation and strengthen the companies’ culture. It helps the employees to increase their performance and organisation to provide rewards for the ones with outstanding performance.

  • Evaluation is done according to previously defined task for specific job.


Motivating and rewarding employees

Motivating and Rewarding Employees

  • In this part, the results of evaluating phase plays an important role. Evaluation basically determines the performance of each individual with success or completion of given or expected tasks. The ones with poor performance will be retrained and warned about their previous performence. The ones with outperformance will be rewarded with Incentives such as compensation, promotion and etc. Those incentives in the organization motivates people to adjust themselves expected performance


Maintaining high performance

Maintaining High Performance

The Organization is expected to work with high performance in order to do that we need to maintain high motivation among team members, The incentives below positively reinforces high Performance;

  • Organization Culture; Fair with standard rules to everyone

  • Career path within the organization

  • Respect of others within organization

  • Accaptance and belonging of the organization.

  • Sense of connection with the organisation


Motivation theories

Motivation Theories

  • Mcgrager’s X and Y theory

  • Davis Mcclelland’s Theory

  • Herzbergs Theory


Mcgrager s x and y theory

Mcgrager’s X and Y theory


Davis mcclelland s theory

Davis Mcclelland’s Theory


Herzbergs theory

Herzbergs Theory


Conflict management

Conflict Management

  • Conflicts could be an oppourtunity for improvement

  • Conflicts are inevitable consequences organisational interactions.

    Reasons of Conflicts

  • Schedules

  • Project prioritization

  • Resources

  • Technical opinions


Problem solving steps

Problem solving steps

  • Define the couse of the problem; Is it emotionally based or performance based?

  • Analyze the problem

  • Identify solution

  • Get approval of the stakeholders of the problem

  • Implement a decision

  • Review the decision and confirm the problem is solved


Facts about conflicts

Facts about conflicts

  • If the conflicts are not resolved completely, they just return again and again

  • Coflict is best resolved by those involved in the conflict

  • The focus should be on the problem not on the personality or attitudes of the ones involved.

  • It is recommended to document suggested changes or commitments by the ones whom are involved in conflict for future use.


Job analysis

Job Analysis

  • Job analysis is the process of studying, positioning,collecting information relating to operations and responsibilities of specific job.

  • The result of job analysis produces job specification and job description.


Steps of job analysis

Steps of Job Analysis

  • Collecting and recording job information

  • Checking the job information for accuracy

  • Writing job description based on information

  • Using the information, determine skills, abilities and knowledge

  • Updating information time to time with new requirements


Job description

Job Description

  • Job title

  • Location

  • Job Summary

  • Duties

  • Working condition

  • Hazards

  • Supervision

  • Material knowledge


Job specification

Job Specification

  • Education

  • Experience

  • Training

  • Initiative

  • Physical effort

  • Responsibilities

  • Communication skills

  • Emotional Chatacteristics


Job analysis1

Job Analysis

  • After we conpleted the job description and the job specification, We could continue with recruiting and selection,after selection, the success and expected criterias will be explained to the employee, that is followed by Career path design. According to the performance of employee, the rewards or extra training, based upon success rate, are applied. Wage and salary determined according to the required tasks from the employer and the wages of people in the organization. If the employee does the expected duties accordingly, Training will be provided according the needs of his/her career path.


It job analysis

IT job Analysis

  • IT jobs requires more specification compared to business analysis.

  • It is hard to analyze IT jobs because there are many items that are due to change every year, programming trends, Job analysis should be dependent on observable behaviours, If work behavior(s) are not observable, the job analysis should identify and analyze those aspects of the behavior(s) that can be observed and the observed work products


It job analysis1

IT Job Analysis

  • In IT projects job Analysis should include;

  • Expected technical and managerial skills of the job

  • The companies software structure

  • Companies Infrustructure

  • Company’s Culture; how are the things done

  • Daily basis and project basis routines

  • Companies IS direction


  • Login
